What is a Change Request Form?
A change request form is a one-page document used to propose a change to an approved project, record what it would affect, and capture the decision to accept or reject it. It sits at the front of the change control process, before anything is rebaselined or re-approved.
The change request form exists to stop informal changes. A verbal agreement in a meeting leaves no record of who asked, what it cost, or who authorized it. A written request creates that record, and gives the change control board or project sponsor something specific to decide on rather than a conversation to recall.
What's Included in This Change Request Form Template
A change request form captures what is changing, why, what it affects, and who approved it. This template covers all four on one page.
The six impact fields are the substance of the form. A request that describes the change without assessing its effect is a suggestion, and it puts the approver in the position of doing the analysis themselves.
Change Request Form Example

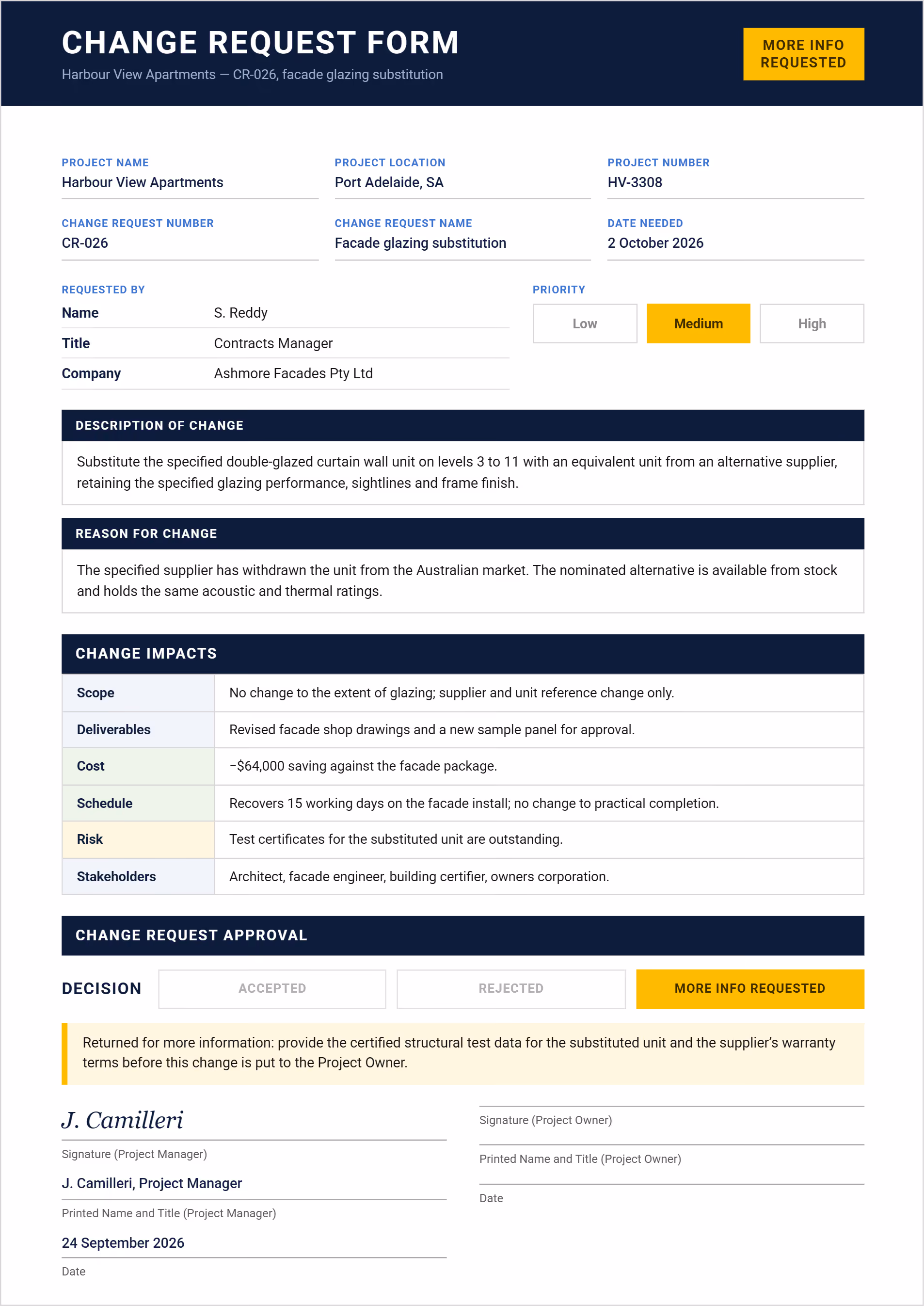

Here is a change request form example completed for a facade glazing substitution on an apartment project. It shows a request returned as more information requested, which is the outcome most examples skip.

The impacts are what make this request assessable. Cost shows a $64,000 saving and schedule recovers 15 working days, yet the form still came back unapproved because test certificates for the substituted unit were outstanding.
The project manager set out exactly what was missing before the change goes to the project owner, and only one signature block is filled. A saving is not automatically an approval when the risk field is still open.
How to Use This Change Request Form Template
Fill in one form per change and number it sequentially. Raise it before the work starts, not after, since a request submitted retrospectively is a notification rather than a request.
- Enter the project details, the change request number and the date the decision is needed by
- Set the priority as low, medium or high, based on what happens if the decision is delayed
- Name who raised it, including their organization, so the origin is on the face of the document
- Describe the change itself, stating what is being proposed rather than why
- Give the reason separately, since that is the part the approver weighs
- Complete all six impact fields, writing nil where there is genuinely no effect rather than leaving a blank
- Route it to the approvers named in your change control process
- Record the decision as accepted, rejected or more information requested, then sign and date both signature blocks
An accepted form changes nothing on its own. The cost and schedule impacts still have to reach the budget and the program, and on capital projects that is where project cost management software picks it up.
Leaving impact fields blank is the most common reason a request comes back as more information requested. A blank reads as unassessed rather than as no impact.
Change Request Form in Word or Excel: What Should You Use?
Use Word for the form itself and Excel when you need to track several requests at once.
Whichever you use, keep every request on one numbered list. A folder of individual forms tells you what was asked but not what is still waiting on a decision, and change requests sitting unanswered are where scope creep starts.
Why Use a Template for a Change Request Form?
Using a standardized template for change requests brings structure, consistency, and efficiency to the change management process. Templates ensure that every change request captures the same essential information, reducing the risk of missing critical details that could impact project outcomes.
Key benefits of using a change request template:
- Consistency Across All Requests: Every change follows the same format, making it easier for approvers to review and compare different requests.
- Complete Information Capture: Templates include all necessary fields, preventing incomplete submissions that cause delays and back-and-forth communication.
- Faster Processing Times: Standardized formats allow reviewers to quickly locate key information like cost impacts, schedule effects, and technical details.
- Improved Cost Control: Built-in sections for cost analysis ensure financial impacts are always considered and documented.
- Better Schedule Management: Dedicated fields for timeline impacts help project managers assess and plan for schedule changes.
- Enhanced Communication: All stakeholders speak the same "language" when discussing changes, reducing misunderstandings.
Templates also support regulatory compliance by maintaining consistent documentation (e.g., AIA in the US, JCT in the UK, AS 4000 in Australia), ensuring that all required documentation standards are consistently met.
Common Problems with Generic Change Request Templates in Word or Excel
Generic templates can provide a quick starting point, but they often fall short for complex construction projects. These static documents lack flexibility and can create inefficiencies when multiple stakeholders are involved.
Common challenges include:
⚠️ Limited Customization: A change request form template in Word may lack fields for costs, risks, or contract details, requiring manual edits.
⚠️ Formatting Issues: Change request templates in Excel can become cluttered with extra columns, while Word versions often appear inconsistent across users.
⚠️ Version Control: Sharing a change request form template in Word by email creates duplicate or outdated files, making approvals harder to track.
⚠️ Data Silos: A change request template in Excel stored locally keeps critical information isolated from project systems.
⚠️ Slow Approvals: Even with a free downloadable change request template, manual signatures or printouts can still delay approvals.
While free downloads are convenient, relying on static Word or Excel templates for major projects can increase risks of miscommunication and delay. Teams benefit most from templates that are consistent, adaptable, and connected to a central project system.
