Construction project management meeting agenda template with meeting details, attendees and agenda minutes table.
Project Management Meeting Agenda Template

Enter your email below to download the file.

By downloading, you agree to receive marketing emails from Mastt. Unsubscribe anytime.

Oops! Something went wrong while submitting the form.
Free Template

Project Management Meeting Agenda Template

Free project management meeting agenda template in Word format. The agenda becomes the minutes, and every action carries forward with a traceable reference.

Templates
Word Template
Excel Template
Powerpoint Template
Project Management Meeting Agenda Template
Template by
Doug Vincent
Published:
May 13, 2022
Updated:
January 8, 2026

What is a Project Management Meeting Agenda?

A project management meeting agenda is a document issued before a meeting that lists what will be discussed, in what order and by whom. It sets the scope of the conversation, and in most delivery teams it becomes the minutes as well, with decisions recorded against each item as they are made.

Its real job is to force decisions rather than updates. On a delivery project, the standing items are progress against schedule, cost and payment, open RFIs and change orders, quality and punch list items, risks and delay events, permits, and what the trades need cleared before next week. Without a fixed agenda those become a round-table where everyone reports and nothing gets resolved.

What to Include in a Project Management Meeting Agenda

A project management meeting agenda needs five things: the meeting details, who attended, what the last meeting left open, the items themselves with decisions and actions recorded against each, and who issued it.

Section What it holds
The meeting Project, meeting number, date, time, place, who chaired, who minuted, next meeting and the full distribution list.
Who was there Name, organization, role and attendance marked as present, apologies or distribution only.
The last meeting Acceptance of the previous minutes, then every open action carried forward with its reference, owner, due date, status and where it stands now.
The agenda and its minutes Ten numbered standing items, each with what to cover, what was discussed and decided, and the action arising.
Issued by Chair, minute taker and date issued.

Project Management Meeting Agenda Example

Here is an example of a completed project meeting agenda, showing the ten standing items minuted for week 14 of a school building project.

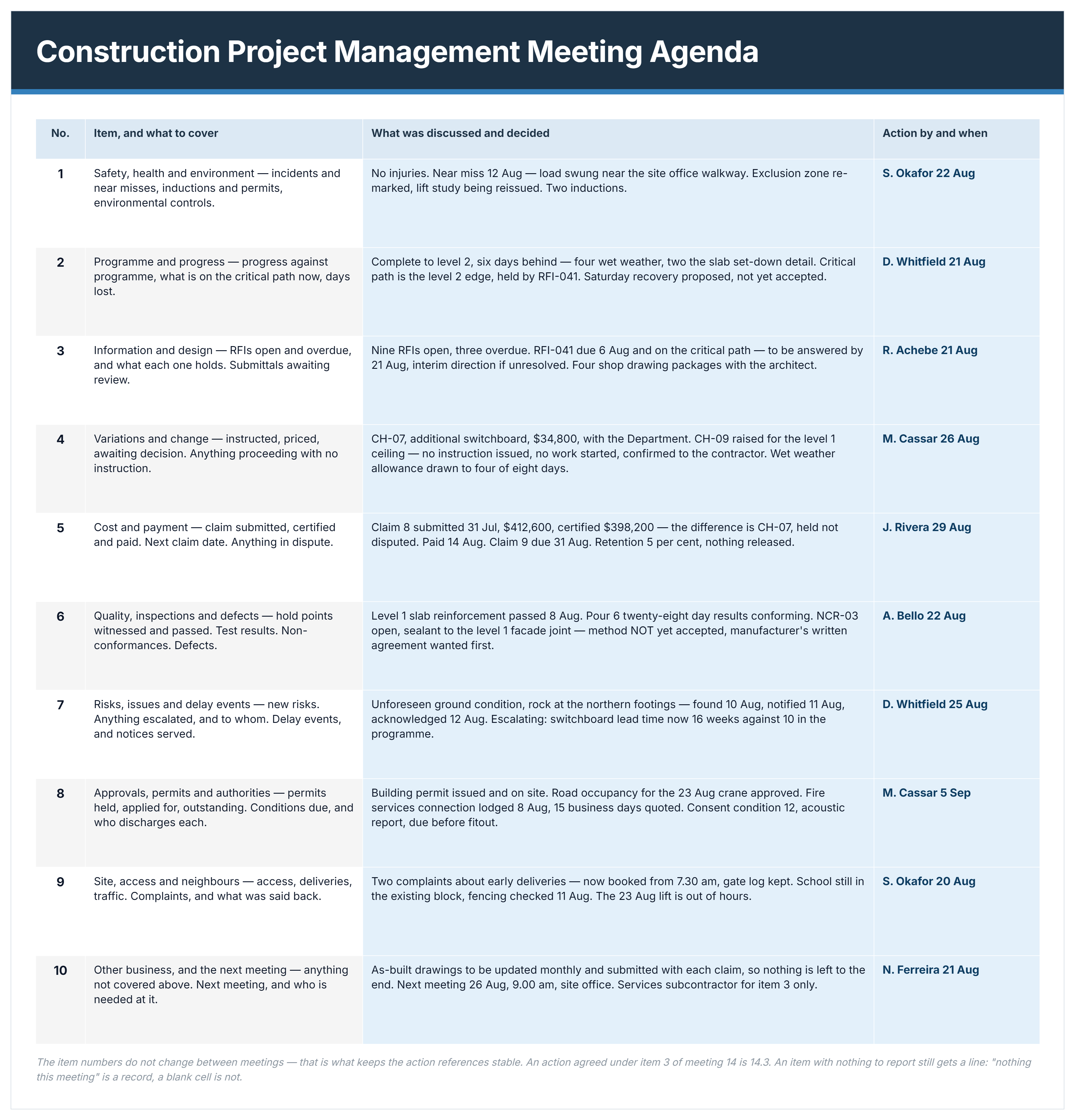

Project management meeting agenda example with ten standing items, minutes of discussion and actions by owner and date.
Project management meeting agenda example showing ten standing items with decisions and actions.

Note what a good minute looks like in the middle column. Not "schedule discussed" but six days behind, four weather days and two the slab set-down detail, with the critical path named and the RFI holding it identified. Each one ends with an owner and a date.

How to Write a Project Management Meeting Agenda Using This Template

Keep one form per meeting, numbered in sequence, and copy the open actions forward rather than retyping them. The agenda you issue beforehand is the same document you minute into during the meeting.

  1. Fill in the meeting details, including the number, the next meeting date and everyone the minutes go to.
  2. Mark each attendee present, apologies or distribution only, since a minute only counts against someone who received it.
  3. Record acceptance of the last minutes, including any amendment.
  4. Copy every open action forward with its reference, owner, due date and where it now stands.
  5. Leave closed rows in place with the date they closed, because the closures are what make it a record.
  6. Work through the ten standing items in order, recording what was decided rather than what was said.
  7. Give every item a line, since "nothing this meeting" is a record and a blank cell is not.
  8. Name an owner and a date against each action, using the meeting and item number as its reference.
  9. Sign it off and issue within two working days, while people still recognize the decisions.

One thing to watch if you both chair and take the notes. Where the chair can also direct a change, anything written as a decision may be read as an instruction. Write "to be instructed" for anything not yet formally directed, and attribute every decision to the person who made it.

Meeting Agenda Templates for Different Types of Project Meetings

Different meetings need different agendas. The structure holds, but the standing items and the cadence change with the purpose.

Meeting Cadence What the agenda covers
Kickoff or preconstruction Once, at start Roles and authority, contract status, correspondence, schedule, submittals, permits, site rules
Weekly progress Weekly Schedule, RFIs, change orders, cost, quality, risks, permits, site and neighbors
Site or coordination Weekly or fortnightly Sequencing, clashes, temporary works, deliveries and safety
Control group or steering Monthly Cost, schedule, risk and anything needing a decision above delegated authority
Design coordination As required Clash detection, outstanding information, design changes and their schedule impact
Closeout At completion Defects, handover documentation, commissioning status and lessons learned

The first meeting sets the tone for every one after it, which is why the project kickoff meeting agenda is worth treating separately rather than reusing the weekly format.

Two at either end of the project need their own preparation. A project control group meeting is a governance forum, so the agenda has to separate what is being reported from what is being decided. And at closeout, a lessons learned meeting runs differently again, since the purpose is surfacing what nobody wrote down at the time.

Run More Productive Project Meetings with Mastt's AI

Project meetings consume 25-35% of delivery team time. Without structure, discussions drift into status updates that could happen asynchronously. Meeting agendas transform gatherings into decision engines that advance delivery.

With Mastt's AI, you generate customized agenda structures in seconds, tailored to your meeting type and project needs. Every template arrives ready for your team, eliminating preparation delays.

Related Articles and Templates

Explore these resources for project meetings, decisions, reporting, and stakeholder coordination:

FAQs About Project Management Meeting Agendas

Actions from last time, then safety, progress against schedule, open RFIs and submittals, change orders, cost and pay applications, quality and punch list, risks and delay events, permits, site access and neighbors. Keep the items in the same order every week so people know when to prepare.
Two working days for anything requiring preparation or a decision, and a day for a routine progress meeting. Sending it on the morning means nobody has read the pre-reads, which turns the first twenty minutes into people catching up in the room.
A daily site huddle runs ten to fifteen minutes. A weekly progress meeting sixty to ninety. A monthly owner, architect and contractor meeting ninety to one hundred twenty. Consistently overrunning usually means too many items or the wrong people in the room.
Phrase them as questions rather than topics. "Do we accelerate the services rough-in to recover two weeks?" tells everyone what is being asked. "Services update" invites a report. The first produces a decision, the second produces a discussion.
Word for the agenda itself, since it is a document to be read, circulated and kept as a record. Excel suits an action register that runs alongside it across many meetings. Most teams find one Word file per meeting, saved by meeting number, is enough.
