Lessons Learned Meeting and Agenda Template

Enter your email below to download the file.

By downloading, you agree to receive marketing emails from Mastt. Unsubscribe anytime.

Oops! Something went wrong while submitting the form.
Free Template

Lessons Learned Meeting and Agenda Template

FREE lessons learned meeting and agenda template in Excel. A run sheet with the questions to ask out loud and a capture sheet that turns observations into owned actions.

Templates
Word Template
Excel Template
Powerpoint Template
Lessons Learned Meeting and Agenda Template
Template by
Doug Vincent
Published:
Oct 24, 2024
Updated:
August 26, 2026

What is a Lessons Learned Meeting?

A lessons learned meeting is a structured session where a project team decides what to repeat and what to change next time. Its purpose is to convert experience into actions somebody owns.

A lessons learned meeting is also called a lessons learned workshop, lessons learned session, post-mortem, project retrospective, project debrief or post-project review. The output goes into the lessons learned register.

Lessons Learned Meeting Example

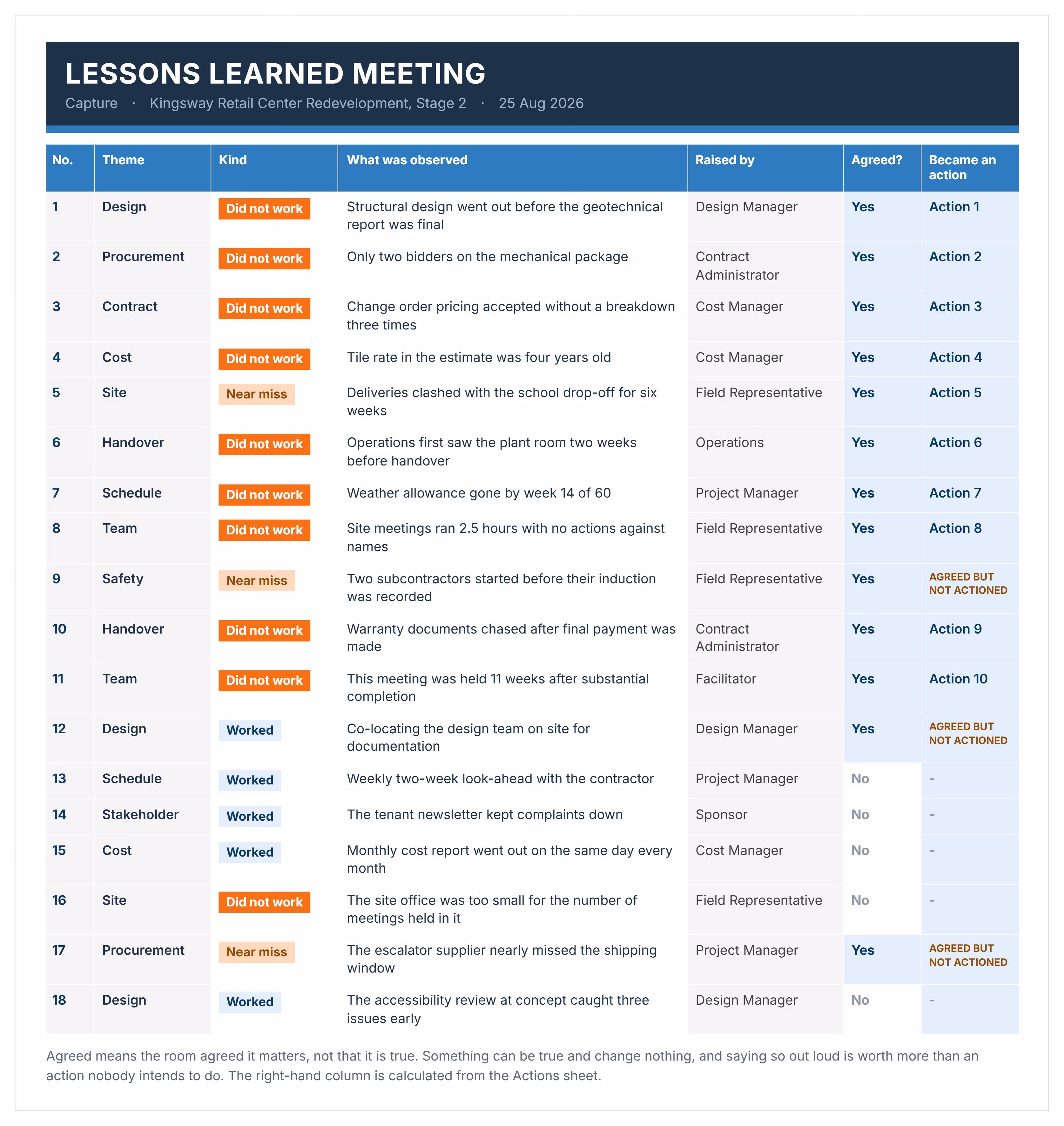

Here is a good example of a lessons learned meeting capture sheet, with eighteen observations recorded during a session on a retail center redevelopment.

Lessons learned capture sheet with 18 observations tagged worked, did not work or near miss, and the actions each became.
Lessons learned meeting example showing observations captured by theme, kind and the role that raised them.

When to Hold a Lessons Learned Meeting

Conduct a lessons learned meeting at each phase gate, after major milestones, and within four weeks of completion. Not only at the end.

PMI's best-practice guidance is to hold lessons-learned sessions at various times throughout the life of your project, and to review lessons from previous projects at the beginning of the next one. PMBOK's sixth edition added Manage Project Knowledge for the same reason: lessons should be captured continuously rather than only at closeout.

The Association for Project Management quotes Dr Penny Pullan arguing that a session held after a project ends is too late to change anything, and the report only gets filed.

Match the length to the occasion: ninety minutes for a full retrospective, an hour for many projects, ten minutes as a standing slot in a team meeting.

Lessons Learned Agenda: The 90-Minute Run Sheet

# Mins Item Led by
1 5 Purpose and ground rules Facilitator
2 10 Silent write-down All
3 10 Where the project landed against its baseline Project manager
4 15 What worked, and why it worked All
5 20 What did not work, and why All
6 8 The near misses All
7 15 Turn observations into actions Facilitator
8 5 Read the actions back Facilitator
9 2 Where this goes Facilitator

The silent write-down at item 2 is how the quietest person gets heard. The near misses at item 6 are the lessons nobody paid for. Reading actions back at item 8 is what stops the session ending in observations.

For a phase-gate review, run items 2, 4, 5 and 7 only. That fits an hour.

Questions to Ask in a Lessons Learned Meeting

Write the question before the meeting. PMI lists asking focused open-ended questions as a standard best practice, and an agenda of topic headings produces generalities.

  • Purpose: We are here to change how the next project runs, not to decide whose fault it was.
  • Silent write-down: Two things that worked and two that did not, on your own, before anyone speaks.
  • Baseline: What did we say we would do on cost, time and scope, and what did we actually do?
  • What worked: What would you do again, and what specifically made it work?
  • What did not: Where did we lose time or money, and what was the first sign it was going wrong?
  • Near misses: What nearly went wrong and did not?
  • Actions: What changes, who owns it, and by when?
  • Read back: Anything without a name against it will not happen. Is this list right?
  • Where it goes: Who reviews the register, and before which project?

Question 5 produces the most useful answers, because "what was the first sign" moves the room from what happened to when it became knowable. PMI also recommends root-cause analysis on project problems.

Lessons Learned Meeting Ground Rules

Ground rules keep the session focused on what changes rather than who was at fault. Five cover it, read out at the start rather than attached to the invitation.

  1. No names. Describe what happened, not who did it. Recording the role keeps the record safe to circulate afterward.
  2. Everyone writes before anyone talks.
  3. A complaint with no proposed change does not become an action. A complaint costs nothing to make. A proposed change means the person thought about the alternative.
  4. Near misses count.
  5. The facilitator reads every action and owner back before anyone leaves.

Who to Invite and What to Send With the Invitation

Invite the project manager, sponsor, cost manager, contract administrator, design manager, field representative and end user, plus a facilitator who was not running the project. Keep it to five to ten people. Send the agenda three days ahead, naming what each person brings.

Role Attends Brings
Facilitator Whole session Nothing. They run it.
Note-taker Whole session Nothing. They capture it.
Project manager Whole session Baseline against final on cost, time and scope, one page.
Project sponsor First and last 15 minutes Authority to change a standard.
Cost manager Whole session The five largest variances by value and their causes.
Contract administrator Whole session Change orders grouped by cause, and the claims position.
Design manager Whole session RFI and submittal counts, and the three biggest sources of rework.
Field representative Whole session The three things that most disrupted work on site.
Operations or end user Whole session What they inherited that they would build differently.
Next project's manager Invite them Nothing. They are the audience.

PMI lists having someone other than the project manager facilitate as a best practice. Give them a separate note-taker, since facilitating and participating objectively at the same time does not work. For a troubled project, run an anonymous survey first and present the results without names.

How to Conduct a Lessons Learned Workshop Using This Template

Appoint a neutral facilitator, send the agenda three days ahead, run the session against fixed questions, and convert every agreed observation into a change with an owner and a date before anyone leaves.

  1. Schedule it for the occasion: a phase gate, a milestone, or within four weeks of completion.
  2. Appoint a facilitator who was not running the project, and a separate note-taker.
  3. Send the Agenda sheet three days ahead, naming what each person brings.
  4. For a troubled project, run an anonymous survey first.
  5. Read the ground rules out at the start.
  6. Run the silent write-down before any discussion.
  7. Record what was observed on the Capture sheet, against the role that raised it, never the person.
  8. Mark whether the room agreed, since a lesson one person holds is not yet a lesson.
  9. Convert each agreed observation into an Actions row with a change, an owner and a date. Reject anything missing one.
  10. Read every action and owner back before anyone leaves.
  11. Move the actions into the register and name who reviews them, and before which project.

What's Included in This Lessons Learned Meeting Template

Five sheets, from invitation to owned actions.

Sheet What it holds
Agenda The run sheet with the question for each item, what each attendee brings, who is in the room, and the ground rules.
Capture Theme, kind, what was observed, the role that raised it, whether the room agreed, and the action it became.
Actions Each agreed change with an owner and a date.
Lists Dropdown values behind theme and kind.
Notes & Assumptions What was assumed and what to change first.

Capture records the role, never the person. That is what makes the record safe to circulate.

Related Articles and Templates

Explore these resources for lessons learned meetings, project reviews, closeout, and continuous improvement:

FAQs About Lessons Learned Meetings

To convert project experience into changes the next project makes. A session ending in observations has not achieved it; one ending in agreed changes with named owners and dates has.
Ninety minutes for a full retrospective, around an hour for many projects, ten minutes as a standing slot for continuous capture. Match the length to the occasion.
Someone who was not running the project. Independent facilitation is widely treated as good practice, because a project manager cannot neutrally chair a discussion about their own decisions.
State the purpose at the start, record roles rather than names, and require every complaint to come with a proposed change.
Vocabulary, mostly. Retrospective is the agile term and runs each sprint. Lessons learned is the project management term and runs at phase gates and completion. The shift toward capturing lessons continuously rather than only at closeout reflects the agile habit of reviewing every iteration.
Into the lessons learned register, the project's own document. PMBOK separates that from the lessons learned repository, an organizational process asset updated at Close Project or Phase. The register is where a project records; the repository is where the organization keeps.
Five to ten. Fewer loses perspectives, more becomes unmanageable. For large teams, split into groups and have each present back.
