EPCM vs EPC: Key Differences Explained

Anna Marie Goco
Post author:
Anna Marie Goco
Contributor:
Reviewed by:
Published:
Jan 27, 2025
Updated:
Jan 27, 2025
EPCM vs EPC: Key Differences Explained

Deciding between EPCM and EPC is one of the most critical choices in construction project management. These delivery methods shape how risks are allocated, costs are managed, and timelines are achieved. Getting it right can be the difference between a smooth, successful project and one plagued by delays or overruns.

Whether you prioritize control and flexibility with EPCM or prefer the streamlined simplicity of EPC, the right method depends on your unique needs. For more insights into how delivery models impact success, check out this comprehensive Project Delivery Methods guide. Let’s explore the key differences to help you decide with confidence.

TL;DR

Choosing between EPCM and EPC is crucial for construction project success. In an EPC framework, the contractor assumes full responsibility for delivering a turnkey project, including most risks. On the other hand, EPCM offers an advisory role, with the owner retaining control and bearing key risks. Learn which approach suits your project needs best.

Comparing EPCM vs EPC

When evaluating EPCM (Engineering, Procurement, and Construction Management) and EPC (Engineering, Procurement, and Construction), understanding how they differ across critical aspects can help you make an informed decision. Here’s a closer look at what each approach entails.

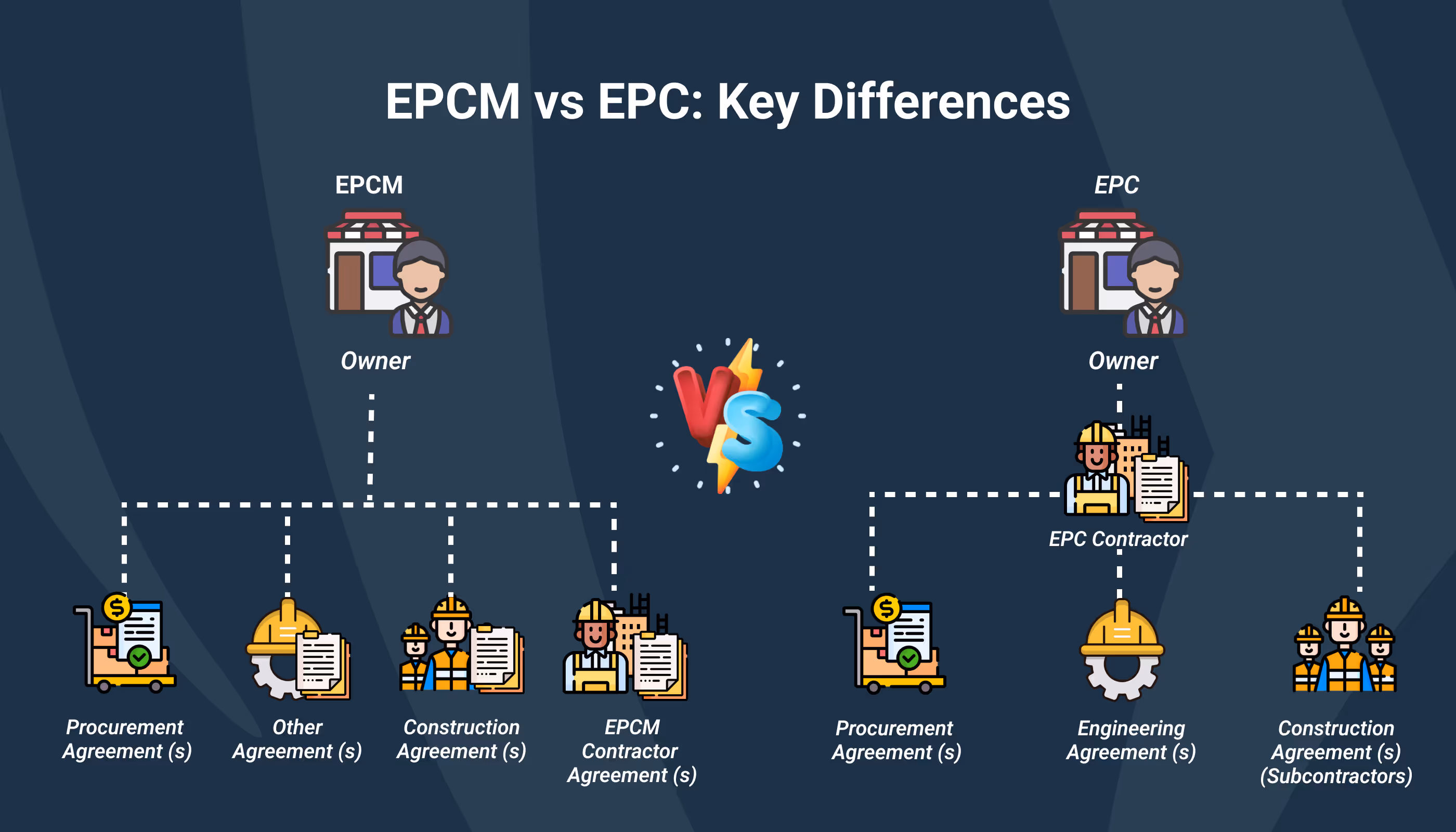

Comparison of EPCM and EPC project delivery models showing differences in ownership, contractor roles, and agreement structures in construction projects.
EPCM vs. EPC: Key Differences in Risk, Responsibility, and Project Control

Scope

EPCM focuses on providing engineering and construction management services. The actual construction activities remain the owner’s responsibility, often subcontracted to third parties. The EPCM contractor acts as a consultant to oversee and coordinate these efforts, ensuring that work progresses as planned.

In contrast, EPC places the entire construction process, including engineering, procurement, and construction, under the contractor’s responsibility. The contractor delivers a turnkey project solution, managing every aspect from start to finish.

Construction Risk Allocation

In EPCM, the owner retains most construction-related risks, including cost and schedule overruns. The EPCM contractor provides expertise to help the owner manage these risks effectively but does not assume legal responsibility for them.

EPC, however, places these risks on the contractor. Cost overruns, delays, and similar risks are borne by the contractor, giving the owner a level of risk protection and accountability.

Subcontractor Interface Risks

In EPCM, the owner legally manages subcontractor risks. The EPCM contractor supports the owner in coordinating and supervising subcontractor activities but does not assume legal liability for any issues that may arise.

On the other hand, the EPC contractor manages all interactions and risks associated with subcontractors. They are responsible for ensuring subcontractors meet quality, timeline, and budget expectations.

Project Control and Flexibility

EPCM allows the owner to retain significant control over the project, including selecting contractors and making key decisions throughout the construction process. This model also provides flexibility for design changes during the project, enabling adjustments without incurring significant additional costs.

EPC, on the other hand, transfers most of the control to the contractor. Once the agreement is signed, the contractor decides on construction sequencing, methodologies, and detailed design development. This limits the owner’s ability to make changes, as adjustments often result in additional costs through variation orders.

Cost and Time Certainty

EPCM typically operates on a cost-plus-fee basis or a professional services agreement. The owner assumes the risks of time and cost overruns, with payments tied to the volume of work managed or the resources allocated. Costs are more variable but offer transparency.

EPC, by comparison, operates on a fixed-price basis, giving the owner cost certainty. The contractor absorbs cost overruns and may face penalties for delays, ensuring that projects are delivered on time and within budget.

Procurement of Materials and Equipment

In EPCM, the owner executes procurement agreements and bears all associated liabilities. The EPCM contractor assists with procurement coordination and provides recommendations but does not take on procurement responsibilities directly.

EPC simplifies this process, as the contractor manages all procurement activities, from sourcing materials to securing equipment. This reduces the owner’s workload and ensures a streamlined procurement process.

Care for Works

In EPCM, the responsibility for the constructed works lies with the subcontractors under their respective agreements. The EPCM contractor oversees quality control, ensuring any issues are promptly raised with the owner to maintain project standards.

In EPC, the contractor assumes responsibility for the care and quality of the constructed works. They are accountable for ensuring that all work meets contractual standards and specifications.

Typical Insurances

In EPCM, the owner typically secures construction-related insurances, such as Construction All-Risk (CAR). The EPCM contractor’s insurance obligations are usually limited to professional indemnity and specific liabilities outlined in the agreement.

EPC contractors, however, secure key insurances such as CAR, performance bonds, and coverage for delays or losses (e.g., Delay in Start-Up or Advanced Loss of Profits). This comprehensive coverage reduces the owner’s risk exposure.

Aspect EPCM EPC
Scope Provides engineering and management; construction is the owner's responsibility. Handles engineering, procurement, and construction as a turnkey solution.
Risk Allocation Owner retains risks; contractor supports but assumes no liability. Contractor assumes most risks, including cost and delays.
Subcontractor Risks Owner manages subcontractors; contractor provides oversight only. Contractor manages and assumes all subcontractor risks.
Control and Flexibility Owner retains control and flexibility for design changes. Contractor takes control; limited owner input and design flexibility.
Cost Certainty Costs are variable; owner bears cost and time risks. Fixed price; contractor bears cost and time risks.
Procurement Owner procures materials; contractor assists with coordination. Contractor handles all procurement activities.
Care for Works Subcontractors are responsible; contractor ensures quality control. Contractor assumes full responsibility for care and quality.
Insurance Owner secures insurance; contractor carries limited liability. Contractor secures all necessary insurances.

When Is EPCM the Right Choice?

EPCM contracts are ideal for projects where the owner wants to maintain significant control over the engineering, procurement, and construction phases. This includes scenarios where flexibility, experience, and cost efficiency are key considerations. Here are the common conditions where EPCM is preferred:

Owners Want Increased Control

EPCM allows owners to directly oversee critical aspects of the project, such as appointing specific subcontractors or making design adjustments as the project evolves. This level of involvement is particularly beneficial for projects where customization and adaptability are priorities.

Owners Have Strong In-House Expertise

For organizations with experienced teams and a track record of managing large projects, EPCM provides the framework to leverage that expertise. Owners take on more responsibility, including managing risks and coordinating between multiple stakeholders, which requires a capable in-house team.

Contractor’s Focus Is on Engineering

EPCM is often chosen when the contractor is a leading engineering firm with strong design credentials but does not want to undertake construction work. This arrangement allows the contractor to focus on its core strengths while the owner manages the construction phase.

Project Is Funded by the Owner

When a project is financed directly through the owner’s balance sheet, EPCM becomes a viable option. Since EPCM does not involve transferring significant financial or construction risks to the contractor, it aligns well with projects that don’t require external project-specific financing.

Lower Capital Costs (CAPEX)

Owners often choose EPCM to reduce capital expenditure. Unlike EPC contracts, where the contractor assumes substantial risks and charges a premium for doing so, EPCM leaves those risks with the owner, resulting in potentially lower overall project costs.

Real-World Example: Balranald Critical Minerals Project

The Balranald Critical Minerals project in New South Wales, Australia, highlights how EPCM can be successfully applied. For this project, Iluka Resources appointed Worley as the EPCM contractor to oversee engineering, procurement, and construction management services.

The project focuses on developing the West Balranald deposit, known for its rich reserves of rutile, zircon, and rare earth minerals. With Iluka maintaining control over the construction phase and Worley focusing on engineering expertise, the EPCM model ensures flexibility and cost efficiency while leveraging Worley’s design capabilities.

When to Use EPC

EPC is ideal for projects where owners want to minimize risks and delegate responsibility. Here’s a breakdown of when EPC is the best choice:

  • Risk Transfer: EPC is suitable when owners want to pass on most construction risks—such as cost overruns, delays, and quality issues—downstream to the contractor, while accepting less control over project development.
  • Limited In-House Expertise: If owners lack the internal resources or expertise to manage complex projects and interface risks, EPC ensures streamlined execution by assigning full responsibility to the contractor.
  • Cost and Quality Assurance: EPC provides greater financial and quality protection. Fixed-price contracts reduce exposure to budget overruns, while insurance and performance bonds offer additional safeguards.
  • Bankability: For projects relying on external financing, EPC contracts are often preferred by lenders. These agreements reduce perceived risks, making the project more attractive to investors and banks.

EPC Example: Saudi Aramco NGL Fractionation Facilities

One notable example of EPC contracting is the development of the Saudi Aramco NGL Fractionation Facilities in Saudi Arabia. With an investment exceeding $3 billion, Saudi Aramco awarded the project to a joint venture between Técnicas Reunidas and Sinopec Engineering Group. The project involved two major EPC packages:

Riyas NGL Fractionation Trains (Package 1)

Scope: Construction of two trains, each capable of processing 255 thousand barrels per day (MBD) of Natural Gas Liquids (NGLs). The package also included fractionation, treatment, dehydration, and refrigeration units.

Estimated Duration: 46 months.

Riyas NGL Common Facilities (Package 2)

Scope: Development of common infrastructure, including feed and product surge storage, chemical storage, and utility systems such as steam recovery, utility water, nitrogen, cooling water, drainage, and flare systems.

Estimated Duration: 41 months.

This project exemplifies how EPC contracts are structured to manage large-scale, complex developments. By assigning specific packages to experienced contractors, Saudi Aramco minimized project risks while ensuring efficient execution within defined timelines.

Final Thoughts on EPCM vs EPC

When deciding between EPC and EPCM, there’s no universal answer—it all depends on the specific needs of your project. Each framework has its strengths and trade-offs, and the best choice will vary based on several factors.

EPC frameworks are ideal for transferring significant risk to the contractor, which provides the owner with predictability in costs and schedules. However, this comes with higher upfront costs and minimal owner involvement once the contract is signed. On the other hand, EPCM offers owners more flexibility and control during the project but requires them to retain more construction risks and invest time in active management.

Ultimately, the decision should be tailored to the specific project and organizational needs. Factors such as local regulations, the company’s culture, and management’s risk tolerance should also be part of the evaluation process. There’s no one-size-fits-all answer, but understanding these key considerations can help you make the best choice for your project.

Anna Marie Goco

Written by

Anna Marie Goco

Anna Marie Goco is a Senior Content Producer at Mastt, writing for cost estimators, cost engineers, project managers, and owner's representatives. She has completed TAFE NSW short courses in construction contract administration and project management, and holds Google's Foundations of Digital Marketing and E-commerce certificate.

LinkedIn Icon

Contributions by

LinkedIn Icon
Back to top

Take control of your next project

Get access to Mastt instantly and start automating work in minutes
