Data Center Development: Full Pre-Construction Guide

Data center development covers all steps to prepare land, power, and permits before building starts. Get clear guidance, checklists, and tools to plan every phase.

Popular

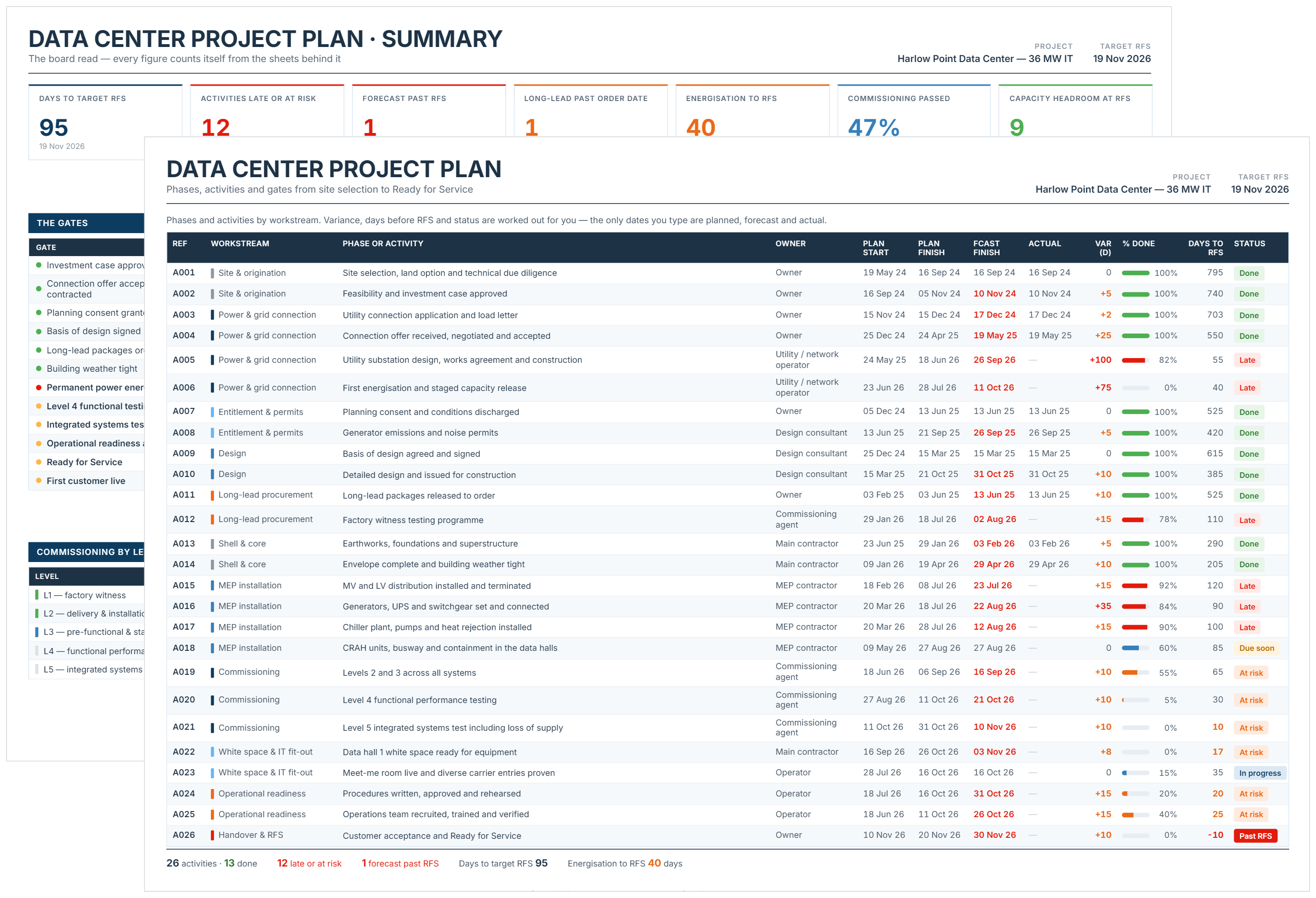

Use this FREE Project Dashboard Template to track progress, budget, risks, and key milestones, all in one clear, easy-to-share report.

Data Center Development
Back to top

Data center development prepares the entire project for construction kickoff. It covers the full pre-construction scope: securing the site, grid, fiber, permits, budget, and procurement path

This guide breaks down each step of the preconstruction process, enabling construction teams to avoid delays and deliver fully ready data center assets.

TL;DR
Data center development covers every pre-construction step necessary to deliver a build-ready site, including zoning, grid, fiber, permits, capital, ESG, and equipment. Success depends on sequencing each milestone to align scope, risk, and delivery speed across high-demand digital infrastructure projects.

What is Data Center Development?

Data center development involves preparing a site thoroughly for digital infrastructure before any construction begins. It includes land control, utility access, permitting, procurement, Environmental, Social, and Governance (ESG) planning, and capital structuring.

Teams align scope and risk, define key considerations, and set project timelines before building begins. The development phase guides data center investments and ensures readiness for procurement, ESG, and FID.

Data center development is different from data center construction. Development handles planning, approvals, and logistics. Construction handles the physical build. The development sets the project scope, timelines, and risk alignment. Construction turns plans into operational facilities.

Why Companies Are Racing to Build Data Centers

Companies are racing to build new data center space to meet soaring data center demand for digital infrastructure, AI, and cloud computing. As workloads grow and end-users expect faster services, data center operators need more capacity, speed, and regional reach.

The top drivers of data center growth include:

  • AI Infrastructure Growth: AI focused data centers support dense computing, cooling, and power capacity
  • Public Cloud Expansion: Hyper scale data center developers build to meet AWS, Azure, and Google demand
  • Edge Data Center Needs: Edge computing requires local latency and regional availability
  • Streaming & Media: Services like Netflix need greater data processing and storage capacity
  • ESG and Net-Zero Goals: New builds improve data center efficiency over retrofitting existing data centers

Major hubs like Ashburn and Singapore offer high-value data center infrastructure when developers control power and fiber early. Those who secure land fast will dominate the data center market.

Modern data center development with high-density server racks.
AI, cloud, and edge are reshaping data center build priorities.

Core Stages in the Data Center Development Lifecycle

The core stages in the data center development project lifecycle cover planning, approvals, funding, and execution readiness. Each step reduces risk, aligns timelines, and supports reliable delivery.

The sections below break down each stage and explain how it contributes to successful data center development.

1. IT Load and Demand Validation

Validating IT load ensures projects meet forecasted data center capacity across each delivery phase. This process informs utilities and aligns buildout timing with data center design needs.

Key steps for accurate IT load planning include:

  • Forecast phased demand: Break down AI, storage, and compute workloads across delivery stages.
  • Define rack density: Set cabinet-level power and cooling targets by application type.
  • Align with utility filings: Sync IT load forecasts with interconnection forms and lead-time planning.

Early megawatt projections help utilities lock queue slots and coordinate energization with build schedules.

2. Site Selection and Control

Sites must meet power consumption needs, have diverse fiber access, and align with zoning laws. A strong design brief outlines rack density, liquid cooling, power targets, and ESG benchmarks. Developers also assess environmental overlays and energy consumption constraints.

Key criteria for selecting and securing land for a data center facility include:

  • Check zoning codes to Confirm the data center's use and allowable footprint.
  • Secure land control: Lock the site with purchase, lease, or option.
  • Map fiber access: Confirm dual-carrier routes or carrier-neutral entry.
  • Flag utility status: Note if MWs are committed or available (without technical depth).

Sites without committed grid capacity or diverse fiber routes can’t move into procurement or entitlements.

3. Concept-Design Brief

The data center concept-design brief outlines the core technical, operational, and ESG performance requirements. It gives project managers, architects, and engineers a shared baseline for scope, compliance, and cost planning.

Inclusions to define in a well-structured data center design development brief include:

  • Floor Space Breakdown: Define GFA, white space, and support zones for each delivery phase.
  • Power Density Targets: Specify rack-level load expectations (e.g., 8–15 kW per rack).
  • Cooling Strategy: Set preferred cooling systems and airflow distribution design.
  • Redundancy and Compliance: Outline N, N+1, 2N levels and align with certifications (e.g., Uptime Tier, LEED).

A clear brief links power density, cooling strategy, and ESG specs to real-world delivery constraints.

4. Capital Structuring and Funding

Capital structuring for data center projects aligns construction costs, ownership rights, investor returns, and risk. Capital modeling is essential for appealing to data center owners and steering committees. This process also supports investment-grade project finance and on-time procurement.

Steps to structure and fund a data center development include:

  • Define budget: Include capex, opex, and reserves.
  • Source capital: Lock equity or debt per risk profile.
  • Set governance terms: Outline JV roles or co-investors.
  • Map returns: Lock IRR, leaseback terms, or sale strategy.

Capital terms drive how equity, debt, and project governance align with lead times, tenant risk, and delivery cash flow.

5. Permits and Entitlements

Data center development requires multiple approvals that align with planning laws, utility access, and site conditions. Each permit must support site readiness and unlock construction at the right stage. These are crucial in regions with many planning controls and traditional data centers.

Key permit and entitlement types to identify early in the development lifecycle:

  • List major approvals: Planning, zoning, utility, environmental, and building code.
  • Identify dependencies: Track permit gating for grid or site works.
  • Include deliverables: Reports, stamped plans, and fire systems.
  • Plan early reviews: Flag red tape during land control.

Each permit stage ties directly to utility access, fire systems, and zoning timelines that impact start dates.

6. Long-Lead Equipment Procurement

Long-lead procurement locks in critical equipment with extended manufacturing timelines. It aligns vendor slots with funding and delivery milestones to avoid construction delays.

Key planning actions for this stage include:

  • Flag early items: Mark long-lead gear in the concept brief.
  • Align order timing: Link to FID or tenant commitment.
  • Sync vendors and design: Hold lead-time check-ins during design and entitlement.

Lead-time mismatches between design approval and equipment delivery often push energization and occupancy milestones.

7. ESG and Sustainability Integration

ESG targets help shape design, procurement, and funding decisions from the start. Teams define core performance goals and carry them through delivery. Projects often aim for power usage effectiveness benchmarks while sourcing clean energy like small modular reactors.

Key actions to integrate ESG in early development include:

  • Set ESG benchmarks: Lock energy, carbon, and water targets early.
  • Include ESG in design docs: Make it part of RFP and tender specs.
  • Coordinate with investors: Align with frameworks like GRESB, LEED, EU Taxonomy.

ESG targets influence material selection, cooling methods, and grid sourcing from the earliest bid specs.

8. Final Investment Decision (FID) Handoff

The Final Investment Decision confirms the project is fully scoped and ready to enter construction. It signals that critical inputs: land, permits, power, capital, and procurement, are locked.

Core requirements for FID readiness include:

  • Design Freeze: Lock scope and specs before contractor engagement.
  • Capital Readiness: Align model, draw schedule, and reserves.
  • Permit Status: Confirm grid letters and environmental approvals.
  • Demand Pipeline: Internal use or signed LOIs in place.
  • Procurement Readiness: Long-lead gear released or staged.

FID approvals hinge on firm power access, contract-ready tenants, and capital models that absorb timing risks.

8 stages of data center development from planning to FID handoff
Decisions made in early stages shape cost, risk, and delivery certainty.

Data Center Site Selection: Power, Fiber, and Zoning

Construction teams evaluate data center sites by confirming power capacity, fiber access, and zoning approval pathways. Some evaluate data center campus reuse or retrofit feasibility. Each location must meet development needs for utility interconnection, network performance, and entitlement approval without delay.

To select a data center site with the right utility, network, and zoning conditions, assess the following:

1. Confirm Grid Capacity and Utility Queue Readiness

Grid capacity is confirmed by validating available megawatts at nearby substations and checking the site's queue position. Projects must align grid access with delivery timelines and utility buildout plans.

To assess grid readiness for a data center site, confirm the following:

  • Request utility load letters showing available capacity and competing reservations.
  • Submit phased interconnection applications that reflect IT load growth by stage.
  • Review utility infrastructure plans for substations, feeders, and transmission upgrades.
  • Map energization timelines against design, permitting, and build milestones.

Projects in high-demand regions often request queue verification letters to avoid late-stage access issues.

2. Secure Dual-Path Fiber with Carrier Redundancy

Fiber and network routes are selected based on physical diversity, service provider presence, and latency to key interconnection points. The goal is to avoid single points of failure and ensure long-term carrier flexibility.

Use this checklist to assess dual-path fiber availability and carrier readiness:

  • Confirm two physically separate entry points and route maps.
  • Validate the presence of Tier 1, Tier 2, and regional carriers.
  • Measure latency to hyperscale cloud regions, IXPs, and key data nodes.
  • Inspect conduit routes, duct banks, and dark fiber access where possible.

Fiber path overlap is a common issue. Carrier diversity doesn’t help if all routes follow the same trench.

3. Evaluate Land Control Terms and Reuse Feasibility

Land acquisition for data center projects involves reviewing lease terms, ownership rights, and existing structures to determine their potential for reuse. Every site must support the necessary infrastructure, meet regulatory requirements, and align with the program's phasing.

Evaluate land or building reuse options for data center site development by reviewing:

  • Title and access rights, including easements, encroachments, or shared-use conditions
  • Land control structure: freehold, leasehold, or call option with defined term lengths
  • Brownfield feasibility, including structural loading, ceiling height, and clear span
  • Demolition or retrofit cost compared to greenfield construction timelines

Some brownfield assets offer faster permitting or approvals, but only if the structural design meets data center MEP requirements.

4. Clear Environmental, Floodplain, and Zoning Risks

Environmental constraints and planning regulations can restrict data center development even on technically viable sites. These must be cleared before land is secured or entitlement timelines are set.

Key zoning and environmental considerations in data center site due diligence include:

  • Flood zone classification and site-specific stormwater infrastructure conditions
  • Environmental overlays, including biodiversity, heritage, or fire risk zones
  • Permitted use under current zoning code and development control plans
  • Height, boundary setbacks, and buffer zones relative to nearby properties

Early GIS mapping and planning overlays can identify potential issues before teams invest in legal, title, or utility reviews.

4 steps in data center site selection: grid, fiber, land, zoning.
Site selection shapes data center speed, cost, risk, and scalability.

Data Center Development Financing Models and Exit Strategies That Drive Delivery

Data center development relies on structured financing models that align capital sources with risk, delivery stage, and exit goals. These models support project funding, manage exposure, and enable asset recycling or long-term hold.

To evaluate financing strategies for data center construction, leasing, and sale, consider the following models:

Financing Model How It Works When and Why to Use It
Developer-Funded (Balance Sheet) The developer covers all project costs using its internal equity. This allows full control but limits scale, strains cash flow, and delays reinvestment across multi-site programs.
Build-to-Suit Lease (with Hyperscaler or Enterprise Tenant) A long-term lease commitment from the tenant secures income to back debt or forward funding. Lenders and investors prefer this model for lower delivery risk and defined returns.
Forward Purchase Agreement An investor agrees to acquire the data center once it has been built and leased. The developer carries build-phase risk and then recycles capital post-stabilization for future phases or new projects.
Joint Venture (JV) or Club Deal Multiple investors co-fund and co-manage the development across sites or regions. This spreads risk, aligns interests, and supports larger pipelines with shared governance and exit terms.
Sale-Leaseback or Exit to an Infrastructure Fund After delivery, the asset is sold to a long-term infrastructure fund or a Real Estate Investment Trust (REIT). The developer exits with capital returned, and the buyer gains stable income backed by a hyperscale or enterprise tenant.

Strong development programs map their capital stack to each phase: equity at land control, tenant-backed debt during delivery, and institutional exit post-lease. Teams that build this timeline early avoid capital gaps that stall procurement or delay go-live.

Securing Permits and Approvals for Data Center Development

Data center development teams secure permits and entitlements by aligning agency approvals with delivery phases. Early coordination with utilities, zoning boards, and stakeholders prevents delays and unlocks site readiness.

These actions reduce risk across grid access, utility interconnection, and construction start.

Step 1: Coordinate Data Center Permitting Across Grid, Fire, and Utility Authorities

Data center permitting requires tight coordination with grid operators, fire marshals, and local infrastructure agencies. To align approval timelines with trenching, energization, and commissioning, track each dependency like this:

  • Build a permitting matrix with responsible parties and agency response times
  • Link each approval to utility trenching, energization, and commissioning phases
  • Flag long-lead permits that gate power access or major works

This coordination reduces delays between entitlement approvals and infrastructure handoff.

Step 2: Secure Local Government Zoning and Community Engagement Approvals

Zoning approvals and stakeholder engagement play a critical role in data center entitlement workflows. To reduce objections and keep planning permits on track, take these early steps:

  • Notify planning authorities with site use, PUE targets, and delivery timelines
  • Host briefings for adjacent property owners before access, traffic, or noise shifts
  • Log feedback in an engagement tracker and confirm mitigation responses

Transparent outreach supports smoother planning approvals and fewer downstream objections.

Step 3: Integrate Permit Tracking Into the Data Center Construction Delivery Plan

Permit tracking must stay integrated with the full data center delivery plan from day one. To align entitlements with construction triggers and procurement timelines, apply these tools and workflows:

  • Use project-wide platforms to track permit status, owners, and risk levels
  • Link permits to FID milestones, long-lead procurement, and capex draw schedules
  • Store digital copies of stamped plans, backup specs, and approval letters

Embedding permitting workflows into the delivery WBS keeps entitlement scope visible from day one.

Aerial view of large-scale data center development site.
Early permitting syncs utilities, zoning, and builds into one timeline.

How Can Long-Lead Equipment Procurement Prevent Data Center Development Delays?

Teams prevent data center delays by reserving long-lead equipment as early as possible. Transformers, generators, switchgear, and chillers often take 9 to 18 months to arrive. Late orders can push energization, stall commissioning, and risk missing the go-live deadline.

Early procurement ties equipment schedules to capital approval and design freeze milestones. This keeps site progress aligned with delivery, even when global supply chains become more challenging.

Use this guide to time orders for key data center systems:

Long-Lead Equipment Key Procurement Actions
Power Transformers Submit specifications 9 - 12 months in advance: reserve vendor slots during utility coordination.
Generators (Diesel/Gas) Place soft POs after confirming the backup load profile and runtime hours.
Switchgear & UPS Systems Finalize the layout and place orders six months before site installation.
Cooling Equipment (CRAC/Chillers) Select units based on cooling strategy: time delivery with build phase installation.
Prefabricated MEP Modules Confirm module specs, routing, and lift path: sync delivery with structural milestones.

Vendor slots fill fast, especially in high-demand markets. Locking soft orders early, even with draft specifications, protects project delivery timelines when supply chains become tighter.

How are ESG Targets Embedded in Data Center Development?

Teams embed ESG targets in data center development by setting performance requirements before design, procurement, or vendor selection. These targets lock sustainability into each decision from day one.

To apply ESG requirements across data center development, define and track the following:

ESG Area What to Lock Early Why It Matters
Energy Performance Target PUE, EUI, and renewable power mix Guides electrical design and procurement
Water Strategy Use recycled or non-potable water, low-use cooling Reduces environmental and operational impact
Materials and Embodied Carbon Specify low-carbon steel, concrete, insulation Cuts upfront emissions and boosts certifications
Bid and Contract Specs Require ESG tracking in RFPs, scoring, and contracts Bakes ESG into vendor deliverables
Supplier Criteria Vet ESG reports, labor standards, ethical sourcing It avoids delays from vendor rework or audits

Many ESG risks emerge later if they aren’t embedded in specifications or contracts upfront. When targets drive sourcing, delivery teams avoid redesigns, lost incentives, and investor reporting gaps.

Who Governs and Approves the Final Investment Decision?

A project steering committee governs data center development and approves the Final Investment Decision (FID) once all key project inputs have been confirmed. This group ensures site control, capital structure, power access, and tenant commitments meet investment criteria before greenlighting construction.

Use this governance table to clarify who approves data center FID milestones, capital terms, and project triggers:

Governance Element What It Covers When It's Triggered
Steering Committee Scope, risk, capital, utility strategy Once the site is secured or the LOI is signed
FID Checklist Capex model, LOIs, power letters, land control Before long-lead awards or builder lock
Investor Rights Voting thresholds, exit terms, JV governance During capital structuring or JV setup
Stage Gates ESG alignment, zoning status, construction risk Before the capex draw or vendor award
Fiducial Model IRR, lease terms, delivery schedule, capex plan Final FID approval milestone

Tight governance frameworks give data center development investors confidence and help delivery teams avoid scope changes or funding gaps. Locking FID approval to utility, capex, and tenant milestones also prevents slowdowns later in the construction cycle.

How Can Mastt Help With Data Center Development?

Mastt helps project teams manage data center knowledge and development with precision, speed, and full visibility. From feasibility through to FID handoff, Mastt centralizes capital planning, procurement, and delivery tracking in one platform.

Construction planning teams use Mastt to:

  • Track pre-construction milestones across permitting, grid access, land control, and long-lead procurement.
  • Align capex drawdowns to FID checklists, investor terms, and construction triggers.
  • Monitor ESG, risk, and timelines through live project dashboards built for asset owners and consultants.

By integrating delivery plans, governance requirements, and funding models into a single workspace, Mastt helps avoid delays, reduce rework, and keep data center programs investor-ready.

Drive Efficient Data Center Delivery at Scale

Many data centers' development demands speed, precision, and smart coordination across every lifecycle stage. From power and fiber due diligence to ESG integration and long-lead procurement, each decision shapes delivery project timelines and capital efficiency.

High-performing construction teams treat data center delivery like a scalable product: tightly governed, commercially aligned, and risk-aware from day one. When investment committees, design leads, and construction partners work from a shared playbook, projects hit go without gridlocks, rework, or funding stalls.
