What is a Cost Benefit Analysis Template?

A cost benefit analysis template is a pre-built spreadsheet that weighs the total cost of a project against the total benefit it delivers, with both converted into today's money. You enter your costs and benefits, set a discount rate, and it returns a net present value and benefit cost ratio you can put in front of a decision maker.

Cost benefit analysis, or CBA, is how capital investment gets justified in government, infrastructure, and any organization choosing between competing projects. Working from a template means you are not rebuilding the discounting maths every time, and it keeps the structure consistent for whoever has to review your assumptions later.

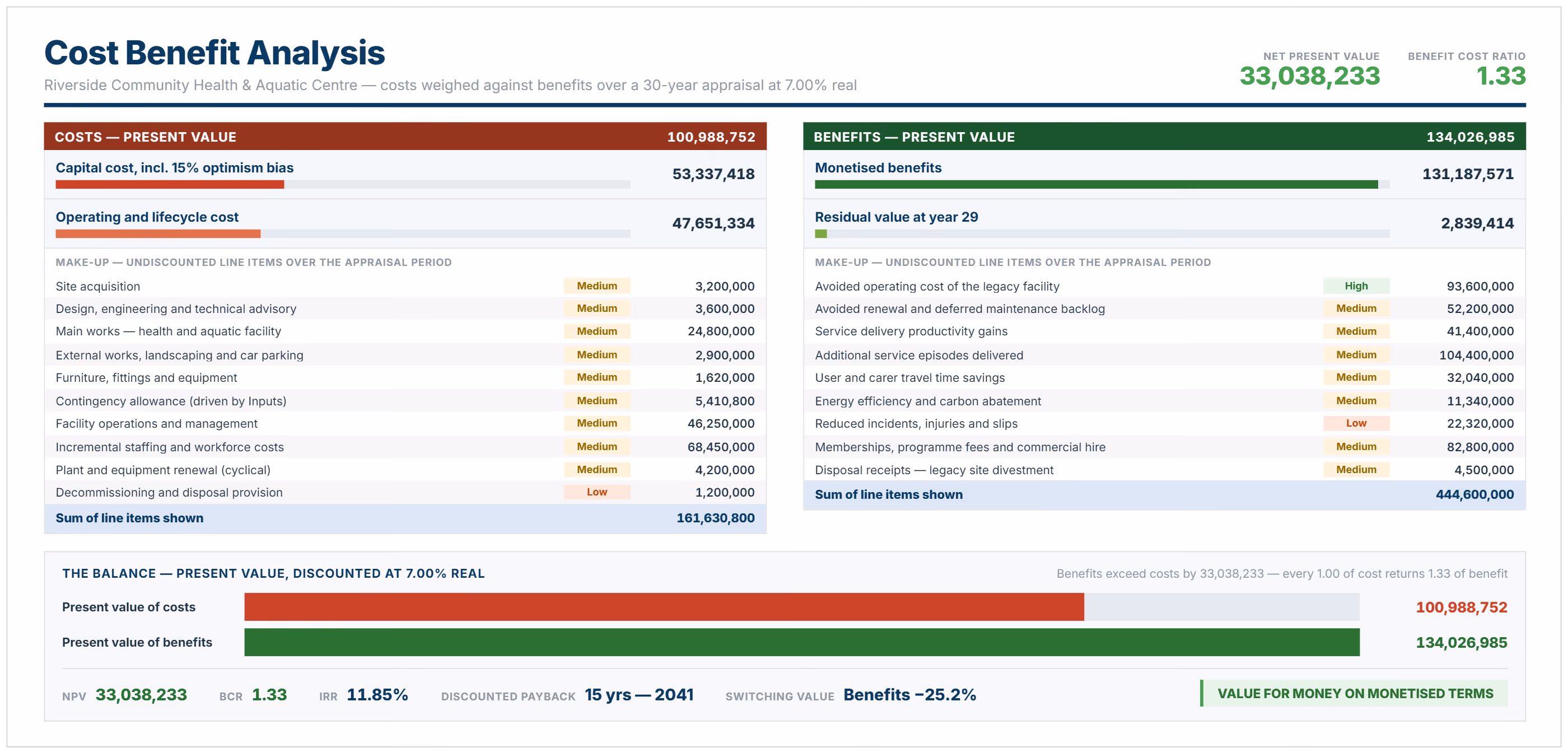

Cost benefit analysis example comparing present value of costs and benefits with NPV, BCR and IRR.

What's Inside the Excel Workbook

Twelve sheets, all driven from a single control sheet.

Sheet What it does
Inputs & Assumptions Every driver: appraisal period, discount rate, optimism bias, contingency, residual value, ramp-up, carbon price.
Cost Inputs Capital, operating and lifecycle cost lines that spread across the years automatically.
Benefit Inputs Benefit lines with valuation basis, evidence source and ramp-up.
Cash Flow The calculation engine, one row per year, every cell a formula.
Results & Appraisal Summary NPV, BCR, net BCR, IRR, discounted and simple payback, equivalent annual value.
Sensitivity Analysis One-way sensitivity, switching values and a tornado ranking.
Risk & Optimism Bias Quantified risk register with PERT expected values and a contingency adequacy test.
Scenario & Options Comparison Competing options side by side.
Distributional Impacts Who bears the costs and who receives the benefits.

The color coding runs through every sheet. White cells are yours to fill in, tinted blue cells are assumptions you need to evidence, and off-white cells hold formulas that should be left alone.

The workbook opens on a worked example for a community health and aquatic centre, so you can see a finished appraisal before clearing it out and entering your own numbers.

How to Do a Cost Benefit Analysis in Excel

Set your drivers on the Inputs & Assumptions sheet, replace the example cost and benefit lines, then read the result off the Results sheet. The year profiles, subtotals and cash flow all build themselves from what you enter.

Have your discount rate, appraisal period and cost estimate ready before you open it, since everything downstream depends on those three.

  • Set the project name, currency, price base year, appraisal period and the real discount rate your jurisdiction mandates. The 7% shown is a placeholder rather than a recommendation
  • Set the optimism bias uplift, contingency budget percentage, residual value method, benefit ramp-up and carbon price
  • Replace the example cost lines, tagging each one as Capital, Operating or Lifecycle and recording its basis of estimate
  • Replace the benefit lines with the annual value at full realization, the valuation basis, and where the supporting evidence comes from
  • Read NPV, BCR, IRR and payback on the Results sheet, then record the impacts you could not reasonably put a number against
  • Check the switching values on the Sensitivity sheet, and build the quantified risk register on the Risk & Optimism Bias sheet

Everything in the model is incremental, which means with-project minus base case. Your base case is the do-minimum rather than do nothing, so it still carries whatever spend keeps the existing asset safe and operating.

Anything that would happen under both scenarios is excluded from the analysis, because it makes no difference to the decision.

How to Read the Cost Benefit Analysis Table

The results table is built from five calculations.

Measure How it is calculated What it tells you
Present value (PV) Future value multiplied by the discount factor What a future cash flow is worth today.
Net present value (NPV) PV of benefits less PV of costs The decision measure. A positive figure means the project is worth doing.
Benefit cost ratio (BCR) PV of benefits divided by PV of costs Ranks options when funding is limited. Above 1.0 means benefits exceed costs.
Internal rate of return (IRR) The discount rate at which NPV reaches zero Information only, and unreliable when the net cash flow changes sign more than once.
Discounted payback The first year cumulative present value turns positive A liquidity measure rather than a measure of value.

NPV is what makes the decision, while BCR is for ranking one option against another. Anything with a BCR between 1.0 and 1.2 sits inside the error band of a typical appraisal, so treat it as marginal until the switching values support it.

A switching value is how far a single input can move before NPV falls to zero, and a case where benefits can only drop 8% before it fails is a fragile one no matter how the headline ratio reads.

Do You Need All Twelve Sheets?

Four of them give you a complete appraisal: Inputs, Cost Inputs, Benefit Inputs and Results. If what you want is a simple cost benefit analysis in Excel, use those four and leave everything else untouched.

The remaining sheets earn their place once the decision comes under scrutiny. Sensitivity and switching values show how much your answer can take before it flips.

The risk register tests whether the contingency you have set actually covers what could go wrong. Distributional analysis sets out who carries the cost and who receives the benefit, which tends to be one of the first things a board wants to see.

The overall structure follows the common ground between HM Treasury's Green Book, Infrastructure Australia's assessment framework, the European Commission's CBA Guide and World Bank appraisal practice, without committing you to any one of them.

Related Articles and Templates

FAQs About Cost Benefit Analysis Template

Use the rate your jurisdiction or organisation mandates rather than choosing one yourself. It varies considerably, from 3.5% under the Green Book social time preference rate to somewhere between 6% and 12% in World Bank and ADB appraisals.
It downloads as an Excel workbook and opens in Excel, Google Sheets or LibreOffice. Keep it in the current format rather than saving down to legacy .xls, because some of the calculations depend on named ranges.
Yes. Enter the avoided costs as benefit lines and the investment required as cost lines, and the NPV will tell you whether the saving justifies the spend across the appraisal period.
Contingency covers identified risks that sit inside your defined scope. Optimism bias corrects for the systematic tendency to underestimate cost and overestimate benefit, based on what comparable projects actually delivered. Carrying both without checking them against each other is a common way projects end up double-counting risk.
Long enough to capture the benefits, which usually means the useful life of the asset or whatever your policy standard sets. The workbook is built for up to 40 years and the worked example runs over 30.
