RFI template in Word with request form, reply section, cost and notice fields, and a worked example.
Construction RFI Template

Enter your email below to download the file.

By downloading, you agree to receive marketing emails from Mastt. Unsubscribe anytime.

Oops! Something went wrong while submitting the form.
Free Template

Construction RFI Template

Use this construction RFI template in Word to submit design clarifications and contractor questions with clarity. Ensure every request for information is properly documented, answered, and tracked in one structured format.

Templates
Word Template
Excel Template
Powerpoint Template
Construction RFI Template
Template by
Jackson Row
Published:
Apr 19, 2024
Updated:
August 18, 2026

What is an RFI Template in Construction?

An RFI template is a standard form used to raise a single Request for Information on a construction project, so the question, the documents it concerns and the date the answer is needed are captured the same way every time. Teams also call it an RFI form, and the two mean the same thing.

The template is the document you send. The RFI process is what happens around it: who may answer, how long they have, and what the answer obliges anyone to do. This form is built for the second part, which is why it carries the reply and the claim as well as the question.

What's Included in This Construction RFI Template

Most RFI forms stop at the question. This one runs in three parts.

Field group What it captures
Request details Request number, project and project number, date raised, and the date the issue was found.
Priority P1 work stopped, P2 at risk, P3 needed soon, P4 routine.
Who and where Sender, the role it goes to, copies, discipline or trade, and location on site.
Which document needs clarifying Drawing and revision, and the specification clause.
Documents checked before asking Everything already reviewed, including coordination and clash reports.
The question One clarification per request.
What you propose The proposed answer, and what it does to cost or time.
When the answer is needed Date the work needs it, float, programme activity, period allowed, reply due by.
Attachments What is attached and how many, and who issued it.
Part 2, the reply Who answered, their role, date of the reply, date the reply was received.
Did the reply change the work? Clarification only, instruction issued, instruction still required, or returned.
What instructed it The instrument that authorised the change, and who issued it.
Already in the documents? No, partly, or yes it was in the issued set.
Part 3, cost and time Cost effect claimed, time claimed, disruption, and the date the claim window closes.
Contractual notice Not required, required and not yet served, or served, with the reference.

Parts 2 and 3 are what separate this from a one-page RFI form. Answering and instructing are not the same power, and they are not always held by the same role. A consultant can answer a question about design intent without holding any authority to change the work.

Construction RFI Form Example: A Completed Request for Information

The same form, filled in end to end on a hospital project.

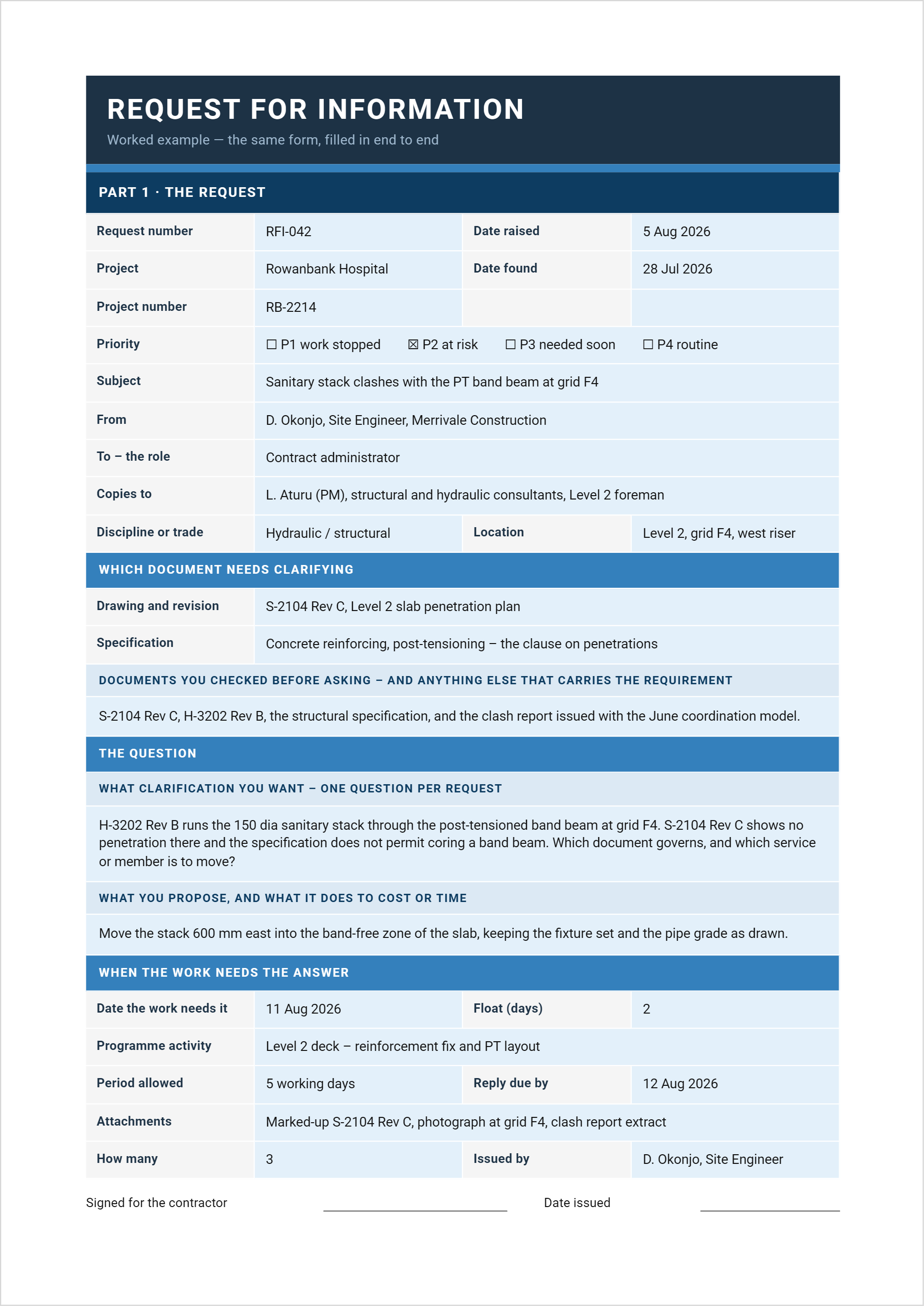

RFI template worked example showing request number, priority, drawing reference, question and reply due date.

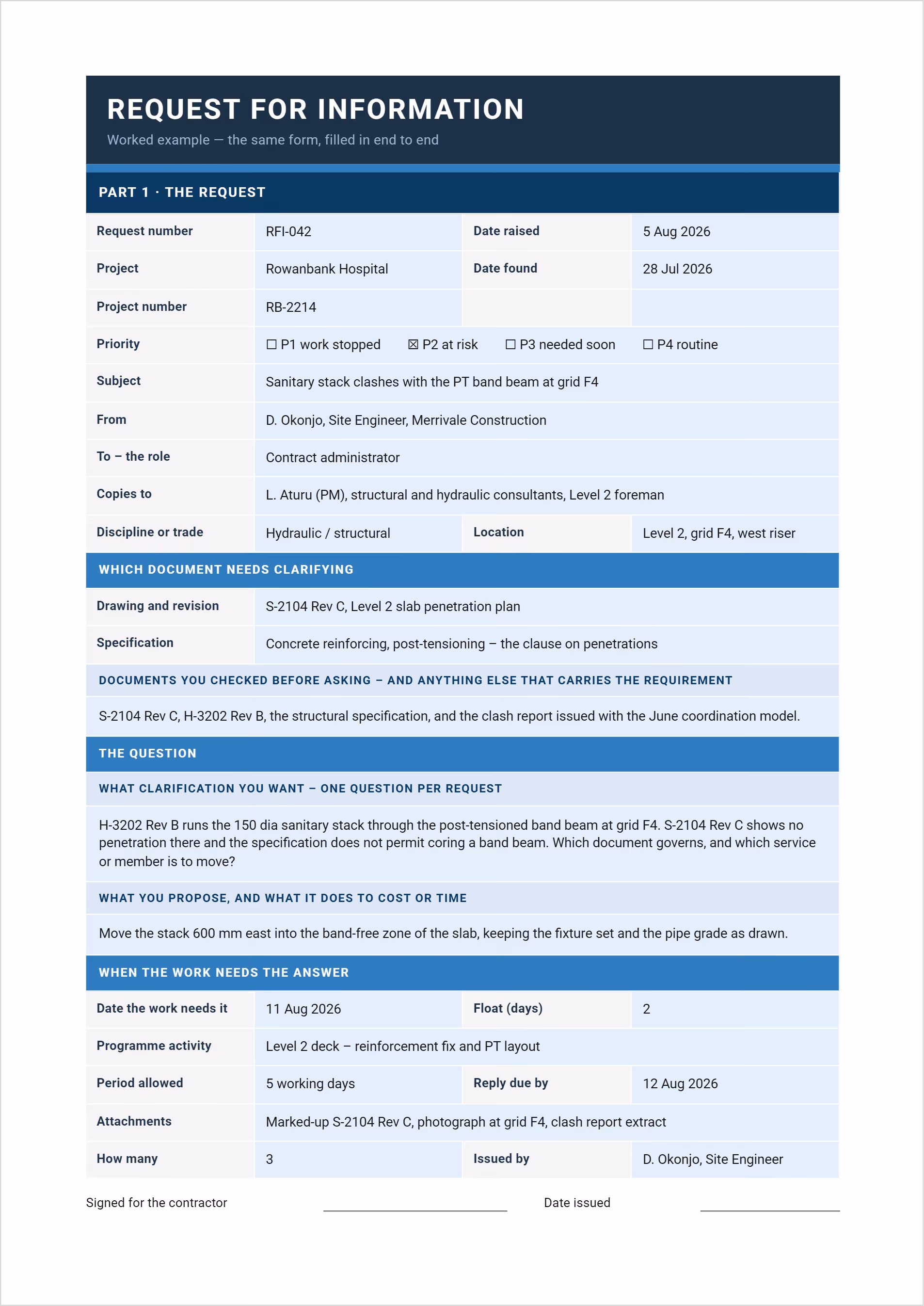

Construction RFI example showing a completed request for information form.

Two drawings conflict and the form names both with revisions. A sanitary stack runs through a post-tensioned band beam on one, while the slab penetration plan shows no penetration there.

Three things get it answered fast. The documents already checked are listed, a solution is proposed rather than just a problem raised, and the needed-by date ties to a program activity with two days of float.

Part 2 carries the lesson. A sub-consultant replied, holding no power to change anything. The contract administrator instructed it separately, which is what makes the work safe to build.

How to Use This Construction RFI Template

Copy the form for each request and number it in sequence. If one gets withdrawn, mark it void and keep the number retired.

  1. Set the priority, then name the drawing and revision or the specification clause that needs clarifying.
  2. List every document you checked before asking, including any coordination or clash report.
  3. Write one question per request, since most project specifications require a single subject per RFI.
  4. Propose an answer and say what it does to cost or time.
  5. Enter the date the work needs the answer off the program, and name the activity it feeds.
  6. Record the date the reply was received, not only the date printed on it.
  7. Where the reply changes what the documents require, get it instructed before the work is built.
  8. Diarize the claim window, which usually runs from the event rather than from the reply.
  9. Add every issued form to one numbered register so the full set stays traceable.

For the wording of the question itself, how to write a construction RFI covers what gets answered fast and what comes back with more questions.

RFI Template in Word, Excel or PDF: Which Format to Use

Use Word to raise and reply to a request, PDF to issue the signed copy, and Excel for the register rather than the form itself.

Format Best for
Word Raising and replying. Fields expand as you type, and the form prints to one page for signature.
PDF Issuing a locked copy once signed, and attaching to correspondence.
Excel The register rather than the form, since a single request needs no sorting or filtering.

If your team already runs RFIs through Procore, Aconex or Autodesk Build, use this form to set what people must supply before they open a ticket, since most platforms accept whatever gets typed into the field.

Mastt handles it differently, storing RFI forms in its construction document management software against the budget, contract and risk records they relate to, so the form sits with the commercial data it affects.

Why Construction RFI Forms Get Returned Unanswered

Coordination specifications commonly list grounds for returning a request without answering it. These come from the specification rather than the contract conditions, and most also require the request to come from the contractor rather than a subcontractor direct.

  • Information already contained in the contract documents
  • Approval of a submittal, or an interpretation of the designer's action on one
  • Approval of a substitution
  • Approval of the contractor's means and methods
  • An adjustment to the contract time or contract sum
  • A request that is incomplete or inaccurately prepared

The first is the most common, which is why this form asks what you checked before asking. Listing the drawings, specification sections and coordination model you had already reviewed removes the easiest reason to return it.

Related Articles and Templates

FAQs About RFI Templates

Yes. Both describe the blank document used to raise one request. Some teams reserve "form" for the printed version and "template" for the file they copy, but the artefact is identical.
Both, for different jobs. This template is the form you fill in to ask one question. A register is the log holding every request on one numbered list, with status, who owes the answer and response dates. If you are trying to see what is overdue rather than raise a question, the RFI register is the page you want.
No. A procurement RFI gathers information from vendors before a contract exists, and sits alongside an RFQ and a request for proposal. This form clarifies contract documents during delivery, when the contract is already in place.
One. Project specifications commonly require a single subject per request, and combining questions means the whole request waits on the slowest answer.
Not on its own. Where the reply changes what the contract documents require, the change has to be instructed as a variation, direction or minor change before it is built. The response section of this form records what instructed it and who.
It depends on your contract. Most standard forms either say nothing about RFIs or ask only for a response with reasonable promptness, and some leave the period blank for the parties to fill in. Read yours and set the period allowed to match.
An RFI asks what the documents mean. A submittal proposes a product, shop drawing or sample for review against what the documents already specify.
Topic:
Construction RFI Template

Written by

Jackson Row

Jackson Row joined Mastt's founding North American team in 2023, implementing the platform for US government agencies and Fortune 500 organizations. He holds a Bachelor of Engineering in civil and mining engineering from UNSW and began his career as a construction cadet on civil projects in Sydney. At Mastt, he contributes articles on payment and client-side project management.
