Measuring Project Success in Construction: KPIs, Outcomes and Scorecards

Dr. Greg Usher
Post author:
Dr. Greg Usher
Doug Vincent
Contributor:
Doug Vincent
Jackson Row
Reviewed by:
Jackson Row
Published:
Sep 15, 2026
Measuring Project Success in Construction: KPIs, Outcomes and Scorecards

Measuring project success in construction starts with understanding what the owner needs the completed asset to achieve. A project can finish within its approved budget and schedule while leaving the client disappointed with the result. This article explains how to measure the success of a construction project, using research-based criteria and a practical assessment process.

TL;DR
Measuring project success in construction means comparing delivery results and client outcomes against agreed objectives. Set measurable targets and use a scorecard to track cost, schedule, quality, and stakeholder satisfaction. Explain how approved changes affect expected benefits and assign responsibility for verifying asset performance once the facility is in use.

What Does Project Success Mean in Construction?

Project success in construction means achieving the project’s agreed objectives, including delivery requirements and the benefits expected from the completed asset. It covers how well the team delivers the work and whether the result meets the needs it was built to serve.

To assess both delivery and outcomes, researchers distinguish between project management success and overall project success. Success in project management asks whether the team met its budget, schedule, and quality requirements. Overall project success also asks whether the completed facility achieves its intended purpose.

The people involved may also have different expectations of that outcome. Owners look for the benefits that justified their investment. Contractors consider profitability, while users judge how well the facility supports their daily activities. Agreed success criteria establish which expectations the project must meet.

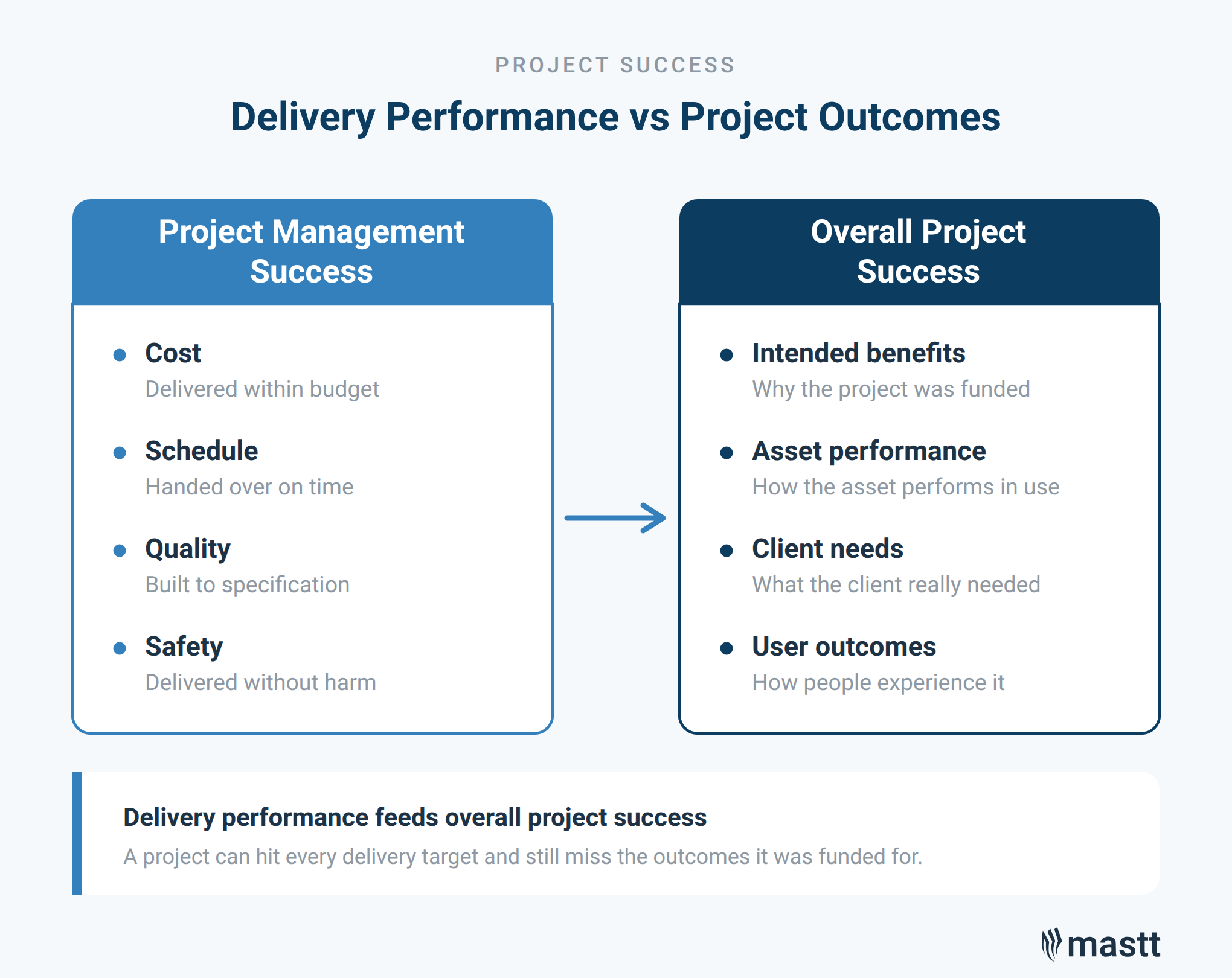

Comparison of project management success measures with overall project outcomes.
Delivery performance contributes to project success, but overall success also depends on whether the completed asset achieves the outcomes it was funded to deliver.

Which KPIs Measure Construction Project Success?

Construction project success KPIs measure performance against agreed delivery targets and the owner’s expected outcomes. Useful measures include budget variance, milestone delays, rework costs, and client satisfaction. These project success evaluation metrics and criteria should connect directly to what the project needs to achieve.

Performance Area KPIs to Track What They Show
Cost Budget variance, forecast final cost Whether costs remain within the approved budget and how changes affected the original position.
Schedule Milestone variance, days ahead or behind Whether key construction and operational dates remain on track.
Quality Rework cost, inspection pass rate, defects Whether the work meets requirements and unresolved defects affect use.
Safety Incident frequency and severity, corrective actions closed The level of harm and whether identified safety issues are being addressed.
Client and user satisfaction Survey scores and feedback Whether client and user expectations are being met, including where their views differ.
Handover readiness Accepted handover items, unresolved issues Whether the asset is ready for use and whether any critical items remain.
Asset performance Capacity, utilization, operating cost Whether the asset performs against the targets tied to the business case.
Environmental performance Waste, energy use, embodied carbon Whether agreed environmental targets are being achieved on a consistent basis.

How Do You Measure the Success of a Construction Project?

To measure the success of a construction project, compare verified results with agreed objectives and performance targets. Define what a successful outcome requires, then collect evidence showing whether the project meets those requirements.

Step 1: Define the outcome with the owner

Review the business case and project brief with the project owner. Ask what problem the project must solve and what the completed facility needs to make possible. Include operators and users to confirm the requirements that affect everyday use.

For example, a client requesting a pipeline needs to move water or oil between locations. Record that purpose in the brief, then agree on the required capacity and reliability. This gives the team a specific outcome to assess when the pipeline is complete.

Step 2: Turn objectives into measurable success criteria

Project success criteria in construction turn broad objectives into results the team can assess. For each objective, agree on a construction project success criterion and choose a KPI that provides evidence against it. Record the target, measurement method, and person responsible for accepting the result.

For example, a school extension intended to provide more teaching space needs a capacity requirement and an availability date. The team could measure the number of additional usable student places available by the start of term. Keep essential acceptance conditions visible individually so a favorable overall score cannot hide an unmet requirement.

Step 3: Record the baseline and measurement rules

Save the original approved scope, budget, and schedule as the project baseline. Define each calculation and its data source so the team measures performance consistently. For cost reporting, specify whether the figure represents expenditure to date, forecast final cost, or final cost.

Improvement targets also need a starting point. For example, a target to reduce energy use needs existing consumption data for a comparable period. Account for differences in occupancy and operating hours so the comparison reflects the improvement being assessed.

Step 4: Assign responsibility and review the evidence

Name someone responsible for maintaining each KPI and agree on reporting dates. Use traceable records, including cost reports, schedule updates, and commissioning results. Check that the information is current and covers the relevant reporting period. A project controls software can help keep cost, schedule, risk, and reporting data connected as teams review performance against agreed targets.

We have been entrusted with people's money and time. And we need to be able to report on that very, very clearly. Explain where results differ from targets, what remains uncertain, and which decisions need the client’s attention. For satisfaction measures, ask consistent questions and record the reasons behind the responses.

Step 5: Assess changes before revising targets

When a proposed change order affects an objective, show the owner its consequences before seeking approval. Compare the available options against cost and schedule commitments, including their effect on the intended benefits.

What I need to deliver is what they need at the end, even if they didn't know what it was at the start. Involve the client in choosing the revised outcome and record their decision. Update approved targets while retaining the original baseline. Explain any benefits reduced or removed, so meeting revised targets does not conceal what the project has lost.

Step 6: Verify results and assign follow-up

Compare each target with the final evidence and record whether it was achieved, partly achieved, unmet, or awaiting verification. Explain the judgment and link it to the supporting record. Assign corrective actions for unresolved requirements, with a responsible person and due date.

Some benefits require operating data before they can be confirmed. Assign someone within the owner’s organization to collect that data and agree on a review date. Record whether each benefit is awaiting assessment, delayed, or no longer expected.

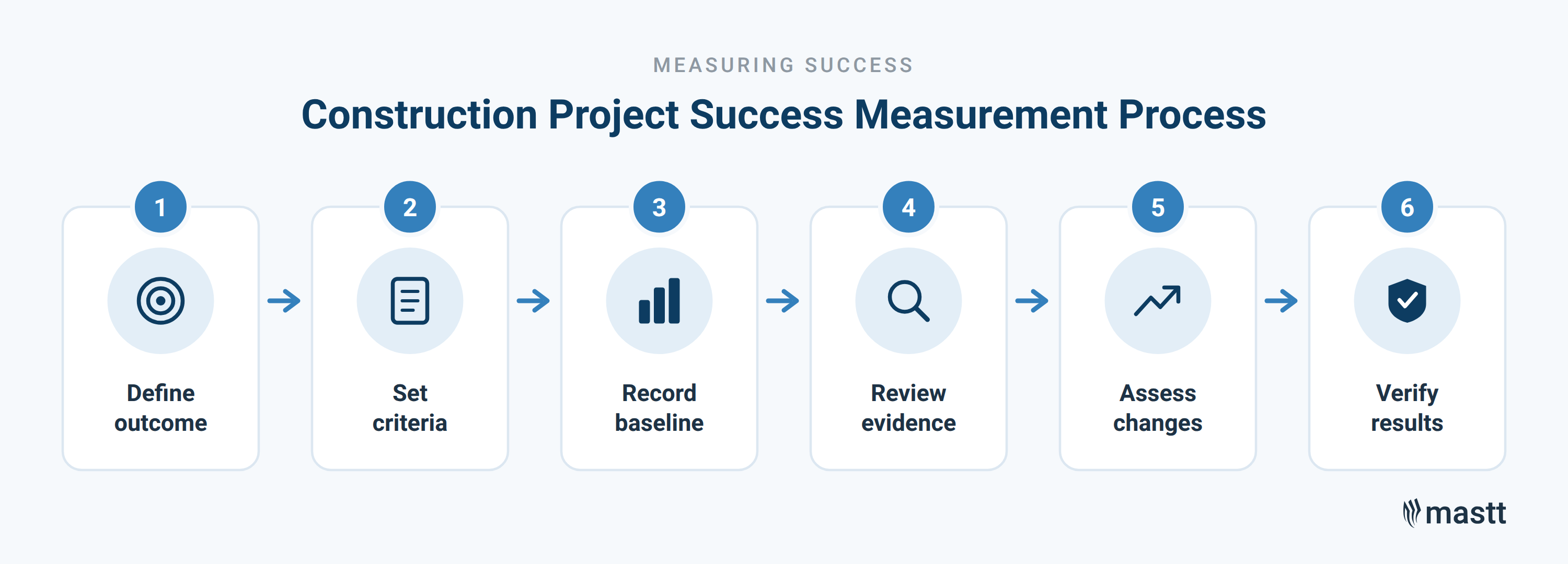

Six-step construction project success measurement process.
Construction project success should be measured through a repeatable process that starts with agreed outcomes and ends with verified results.

When Should You Measure Construction Project Success?

Begin defining success during planning, review progress throughout project delivery, and verify outcomes at handover and during operation. Each stage provides different evidence, so the assessment should reflect what can reasonably be confirmed at that point.

Project Stage When to Review What to Assess
Planning and feasibility Before approving the investment Whether the project can achieve its intended benefits within available funding and time.
Design and procurement At design approvals and before awarding contracts Whether the design, cost, and delivery plan still support the agreed objectives.
Construction At reporting intervals and key milestones Whether current performance or emerging issues threaten the agreed targets or outcomes.
Significant changes Before approving changes to scope, cost, timing, or benefits How the change affects the expected result and agreed benefits.
Handover and closeout At acceptance and during closeout Whether the asset is ready for use and any critical items remain unresolved.
Operation Once representative operating data is available Whether the asset delivers the expected performance and user outcomes.

Schedule reviews early enough for their findings to influence the next decision. For example, assess readiness before confirming an opening date, while there is still time to address outstanding work. If evidence is incomplete, record what remains unverified and when it will be checked again.

What Does a Construction Project Success Scorecard Look Like?

A construction project success scorecard places agreed targets beside actual results, supporting evidence, and an assessment of each outcome. It shows which requirements were met and which need further action or verification.

The scorecard below illustrates a hypothetical $4 million school extension providing 120 additional student places. Reviewed three months after opening, it compares agreed targets with delivery results and early feedback from staff. All figures are illustrative.

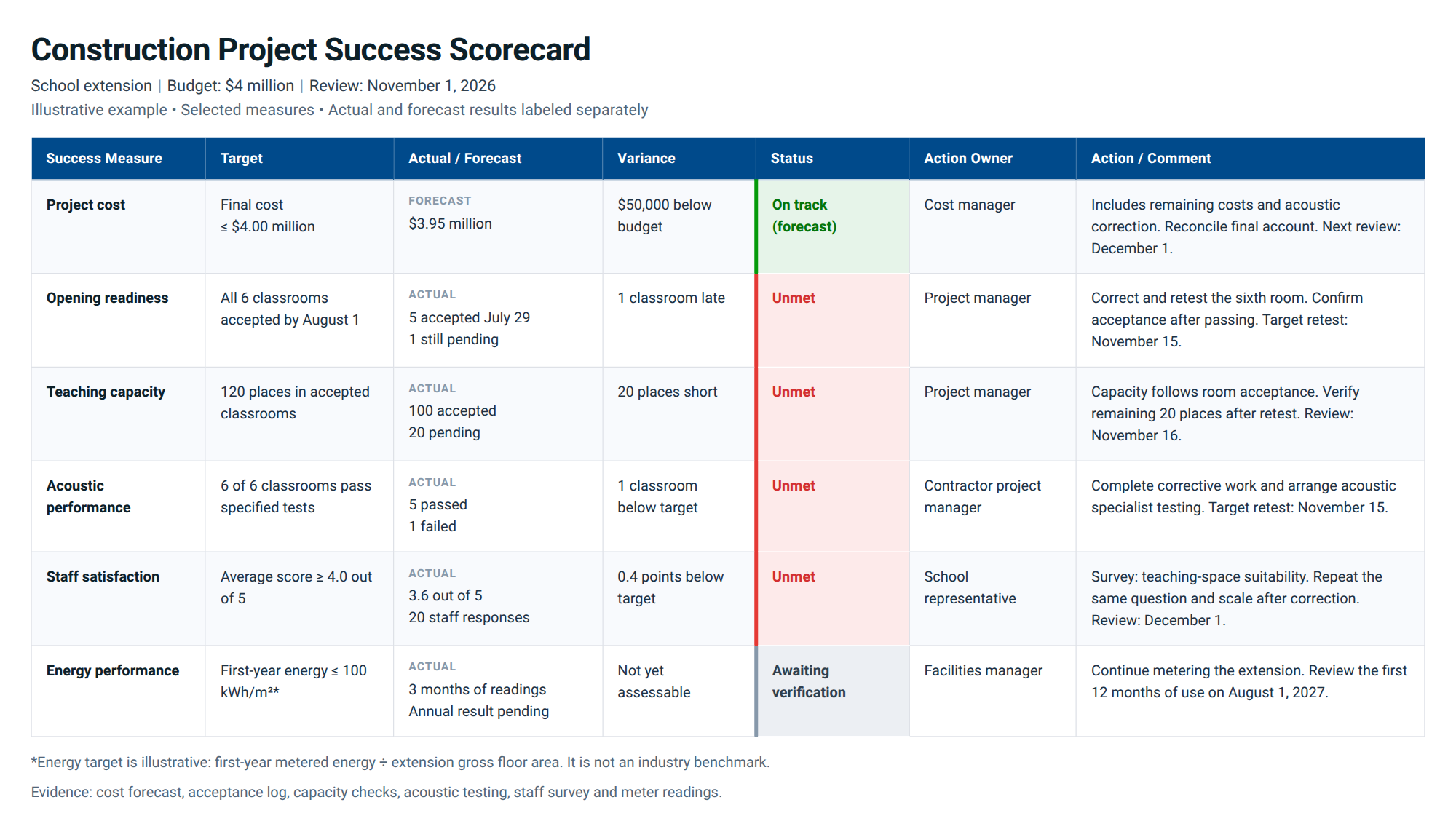

Construction project success scorecard comparing targets, actual or forecast results.

Use the action column to explain what must happen before an unmet requirement can be accepted. Update each status when new evidence becomes available, keeping forecasts clearly labeled until results are confirmed.

Mastt’s project performance dashboard template provides a starting point for organizing these measures and reporting progress to the owner.

Why Can a Project Meet Its Targets and Still Disappoint the Client?

A project can meet its budget and schedule targets yet still disappoint the client. This happens when the completed asset delivers fewer benefits than the owner originally expected.

I call this a “disappointing success.” On one defense project, our budget fell from about $12.5 million to $8 million while construction was underway. The team finished under the revised budget and ahead of the revised schedule. However, stakeholders felt the completed project no longer delivered what they originally needed.

Two issues commonly cause this gap:

  • Revised targets can reduce expected benefits. Scope, budget, or schedule changes may make delivery targets easier to achieve. Yet the finished asset may provide less value than originally planned.
  • Clients may not understand the trade-offs. Explain how proposed changes affect the finished outcome before approval. This helps the owner understand what they are accepting and what benefits may be lost.

Measuring project success should therefore consider the completed outcome, not delivery targets alone.

Put Project Success Into Measurable Terms

Measuring project success starts with a shared understanding of what the owner needs the investment to achieve. Turn those expectations into clear targets, and keep the client involved when decisions change the expected outcome. Build your scorecard around those outcomes, with evidence for each assessment and someone responsible for checking benefits after handover.

FAQs About Measuring Project Success

Critical success factors are the conditions that increase the likelihood of a project achieving its objectives. They can include strong owner support, clear responsibilities, capable teams, effective communication, adequate resources, and active risk management. The key success factors for a construction project should support the success criteria agreed at the start.
Responsibility for project success is shared across the project team, but accountability should be clearly assigned. The project manager usually manages delivery, while the owner or sponsor remains responsible for defining the expected benefits and confirming whether the investment achieves them.
Project success criteria define the results used to judge whether the project succeeded. Critical success factors are the conditions or practices that help the team achieve those results. For example, completing a facility by an agreed opening date is a success criterion. Effective schedule management and timely decision-making are factors that can help achieve it.
Yes, depending on the project’s agreed success criteria and the value delivered by the completed asset. An over-budget project may still achieve its main objectives, but the cost overrun should be assessed against the approved business case and the benefits gained from the additional expenditure.
