What is a Change Log?

A change log is the register of every change raised on a project: what changed, why, who raised it, what it was claimed to cost, what was approved, and where it currently stands.

It is the record produced by integrated change control. A change request enters the log when raised and stays there until it is approved, rejected or withdrawn, so nothing is decided off the record.

A change that has been priced but not decided is an exposure, not a cost. Only approved changes move the contract sum, and a project change log that blurs the two will show a position better or worse than the real one.

Change Log Example

Here is an example of a completed change log, showing the log itself and the contract position it produces.

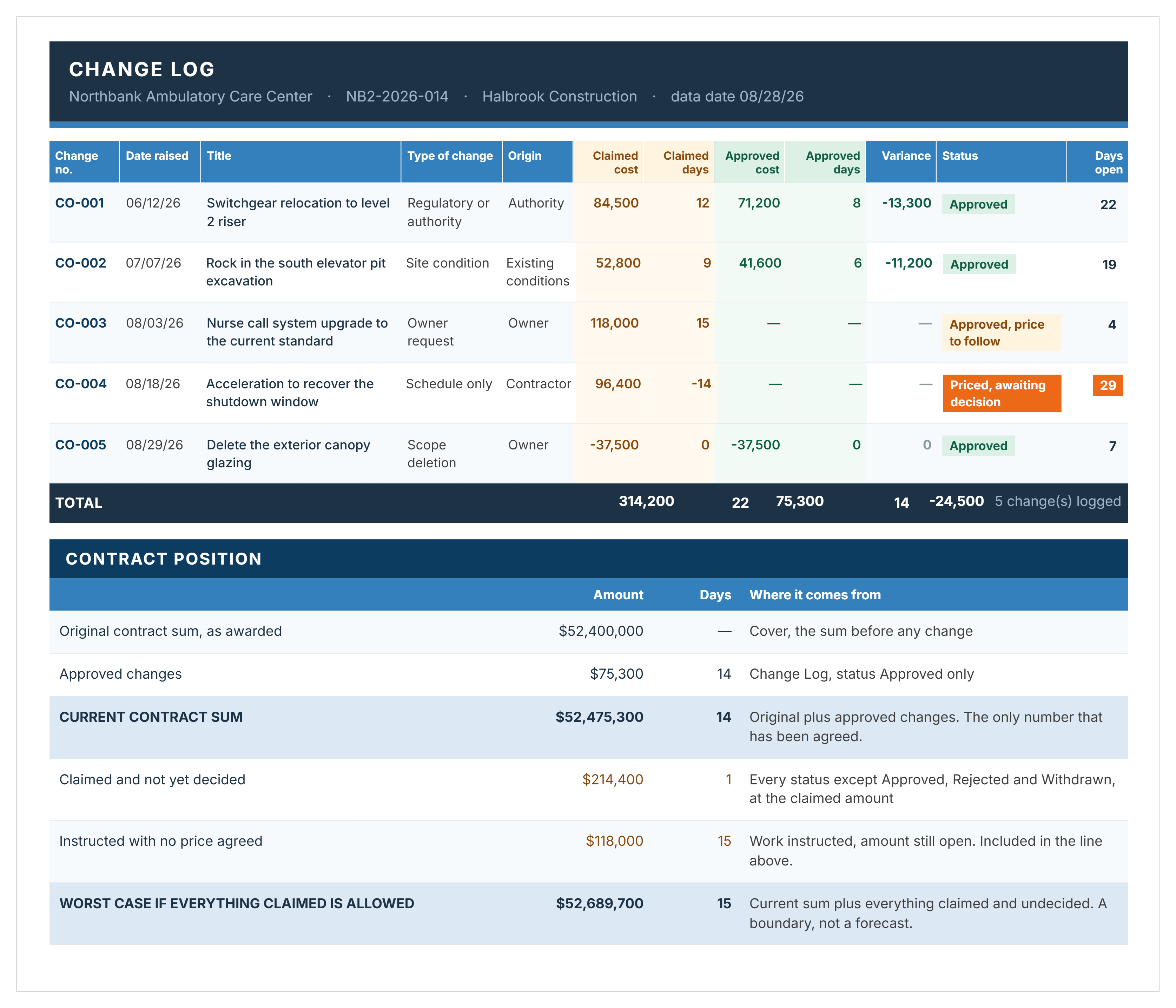

Construction change log example showing five change orders with claimed versus approved amounts, variances and the current contract sum.
Change log example showing claimed and approved cost and days per change, status, days open, and the contract position built from approved changes only.

What to Include in a Change Log Template

A change log needs one row per change and two sets of columns: what is claimed and what is approved. Everything else supports those. This free template covers it across six sheets.

Sheet What it holds
Cover Project, contract and data date, set up once.
Change Log One row per change, with claimed and approved kept apart.
Contract Position Original contract sum, approved changes, current contract sum, and what is still open.
Change Summary Counts and totals, all calculated from the log.
Lists The four drop-downs: status, type of change, origin and route.
Notes and Assumptions What the file assumes and what it does not do.

The log records, per change: change number, date raised, raised by, title, what changed and why, type of change, origin, route, cost claimed, days claimed, cost approved, days approved, variance, status and days open.

Four drop-downs do the work:

  • Status: Raised, under review, priced and awaiting decision, approved, approved with price to follow, rejected, withdrawn, deferred.
  • Type of change: Scope addition, scope deletion, design change, site condition, owner request, regulatory or authority, error or omission, substitution, schedule only, correction with no cost or time.
  • Origin: Owner, designer, contractor, authority, third party, existing conditions, not established.
  • Route: Change order, change directive, change request not instructed, absorbed with no change order, allowance drawdown, contingency drawdown.

Route records how the change is being carried. A change absorbed or drawn from contingency never becomes a change order, so it would leave no trace in a log that only tracks change orders.

How to Use This Change Log Template in Excel

Fill in the claimed columns when a change is raised, and leave the approved columns empty until somebody with authority decides.

  1. Complete the cover with the project, the contract and the data date.
  2. Edit the four drop-down lists to match your contract's vocabulary before logging anything.
  3. Give every change a number and log it the day it is raised, not the day it is priced.
  4. Record what changed and why, then set the type of change and the origin.
  5. Enter the claimed cost and claimed days. Leave the approved columns blank.
  6. Set the route, so it is clear whether this becomes a change order, a directive, or is absorbed.
  7. Fill in the approved cost and days only when the decision is made, and update the status.
  8. Read the contract position and change summary. Both calculate from the log, so nothing is typed twice.

The contract position separates three numbers: the current contract sum, which is the only figure agreed; what is claimed and not yet decided; and the worst case if everything claimed is allowed. That last figure is a boundary, not a forecast.

Change Control Log and Change Management Log Templates

A change control log and a change log are the same document. Change control is the process; the change log is the record it produces. A change management log is usually the same register on a project, though the term also appears in organizational change management, where it tracks something different.

Name What it records Where the term comes from
Change log Every change on a project, and its status The common project management term
Change control log The same register, named after the process PMBOK, integrated change control
Change management log The same register on a project. In organizational change management it tracks people-side change instead Business change and ITIL
Document change log Versions of a single document, not changes to a project Document control and revision history
Change order log Approved contract changes, with their cost and time effect Construction contract administration

Related Articles and Templates

Explore these resources for project change tracking, change requests, approvals, and contract changes:

FAQs About Change Log Templates

A change log works better as an Excel spreadsheet, because it is a register that gets sorted, filtered and totaled. Word suits the change request form that feeds the log, not the log itself.
The register of every change request on a project and its status, maintained through integrated change control. PMBOK treats it as an output of that process, and PMP material refers to it as a project document updated whenever a change is raised or decided.
Nothing. Both name the same document. Register is more common in construction and in UK and Australian practice; log is more common in US project management.
The project manager or contract administrator. One person should own it, because a log two people update in parallel stops reconciling within a month.
The day it is raised, before it is priced. A change that only enters the log once it has a price attached has already spent time as an unrecorded exposure.
A revision history for a single document, recording version, date, author and what changed. It belongs in the document it describes, not in a project change register.
Log them like any other change, with the type set to design change and the origin set to designer. Design changes that are absorbed rather than instructed still belong in the log, because they consume time even when they carry no cost.
