What is a Construction Quality Control Checklist?
A construction quality control checklist is the field document used to verify that completed work meets its specified acceptance criteria before the next activity covers it up. Each line names one check, the measurable criterion it must meet, the measurement actually taken, and who signed it off.
QA and QC are often written together as QA/QC, but they do different jobs. Quality assurance is the system that prevents defects: procedures, approved methods, competency and audits. Quality control is the verification that one specific piece of work conforms. The quality management plan sets out the assurance side. This checklist is the control side, and it produces the records an auditor, certifier or client asks for when the system is tested.
What's Included in This Construction Quality Control Checklist Template
Nine sheets built to ISO 9001:2015, with the forms and checklists feeding registers that calculate their own status.
Construction Quality Control Checklist Example

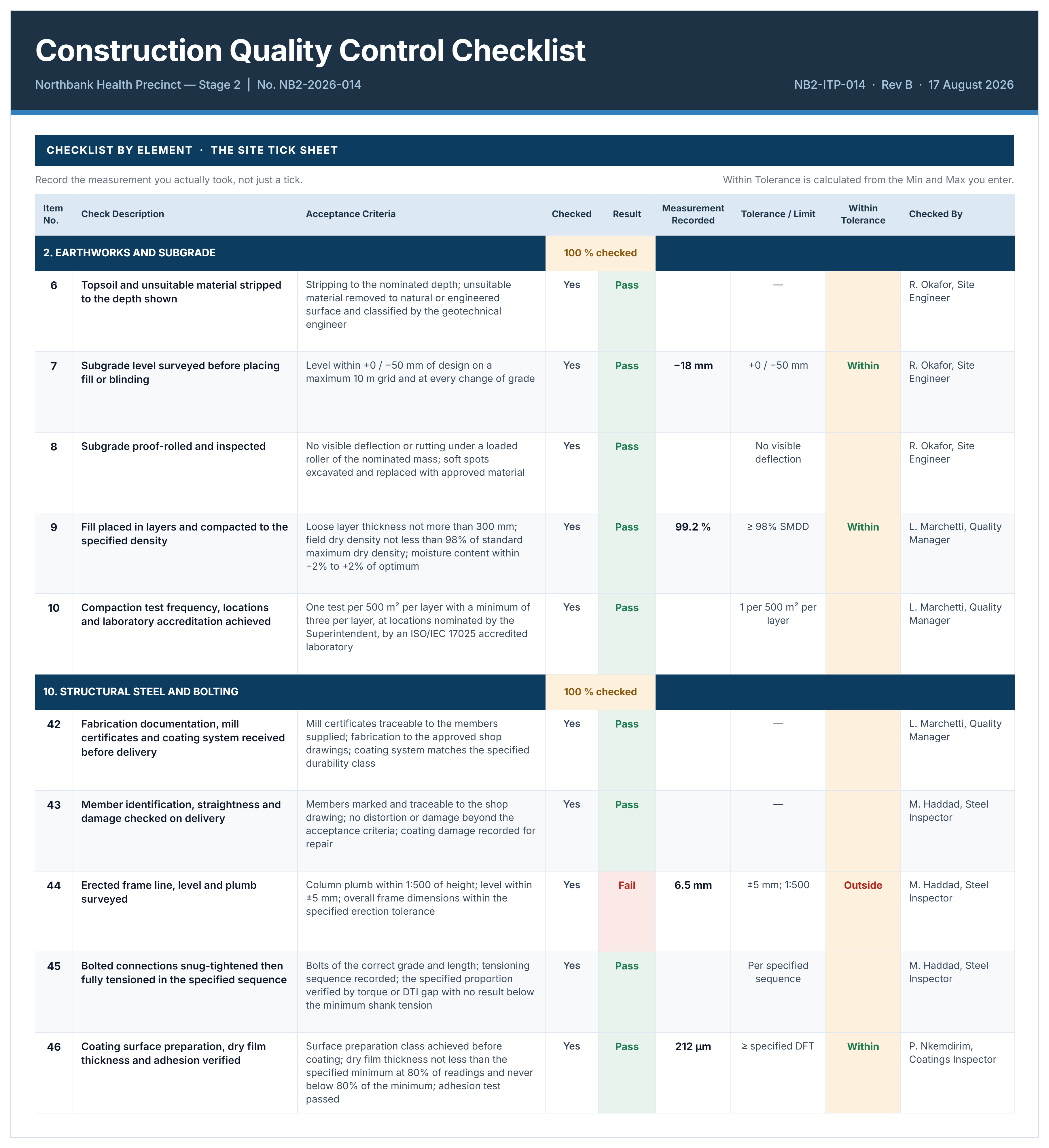

Here is an example of a completed construction quality control checklist, showing earthworks and structural steel checks on a health precinct project.

How to Use This Construction Quality Control Checklist in Excel
Build the inspection plan before the work starts, get it accepted, then work down from it. Every other sheet in the workbook reads from that plan.
- Complete the Cover once per package, since every sheet echoes the project, number and currency from there.
- Build the inspection and test plan first, one row per inspection or test, and have the client or superintendent accept it before work begins.
- Write acceptance criteria as a measurable limit and the method of measuring it, because "to the satisfaction of the engineer" is not something anyone can verify.
- Mark each row as a hold point, witness point, surveillance, review of records or test.
- Check the hold point banner at the start of every shift and before authorizing any pour, backfill or close-up.
- Give the site crew the Checklist by Element sheet and record the measurement taken, not just a tick.
- Open a lot before the work starts, and put the lot number on the inspection plan, the test register and every non-conformance.
- Raise a non-conformance the moment work fails its acceptance criteria, with the root cause recorded honestly.
- Record every test with its specified value, units, result and operator, then attach the certificate reference.
- Read the dashboard before every progress claim, handover offer and audit.
Delete the example rows before you issue the workbook. They exist to show what each field wants, and they will read as real inspections if they survive.
Construction Inspection Checklist: Hold Points and Acceptance Criteria
A construction inspection checklist works because of two things: what each inspection is allowed to stop, and how precisely the pass condition is written.
Every row in the inspection plan carries a type, and the type decides what happens when work reaches it:
- Hold point: Work must not proceed past it. The inspection has to be carried out, the result recorded as a pass, and where the row requires it, the client has to sign off.
- Witness point: The client is given notice and may attend. Work may proceed if they do not.
- Surveillance: Monitored during the activity rather than at a fixed stopping point.
- Review of records: Verified from certificates, test reports or submitted documentation.
- Test: A measured result against a specified value, recorded on the test register.
Only the hold point has teeth, which is why the plan listing them is a controlled document. Every revision must be issued, accepted and distributed before the work it governs starts, and superseded revisions removed from site so only the current one is in use.
Non-Conformance Reports and Closing Out a Lot
A lot is a defined quantity of work inspected and accepted as a unit, such as one concrete pour, a layer of fill over a stated chainage, or one level of steel erection. It cannot be closed while a test has failed or a non-conformance report is open, and the register calculates that rather than leaving it to judgement.
Four dispositions are available when work does not conform, and two of them need somebody else's agreement:
- Rework: Bring it to the specified standard.
- Repair: Restore it to an acceptable condition by a method the designer accepts.
- Use as is: Accept the non-conforming work, which requires written concurrence from the design consultant.
- Reject: Remove and replace.
Target close dates calculate from severity, so a critical NCR runs on a shorter clock than a minor one. Record the root cause category honestly, because a register full of "workmanship" teaches you nothing, while a pattern of "sequence or coordination" tells you the schedule is the problem rather than the trades.

👉 Start creating professional construction quality control checklists with Mastt AI today and establish inspection standards that actually prevent defects.
