Construction quote template summary showing fixed price, provisional sums and total including tax over an exclusions page.
Construction Quote Template

Enter your email below to download the file.

By downloading, you agree to receive marketing emails from Mastt. Unsubscribe anytime.

Oops! Something went wrong while submitting the form.
Free Template

Construction Quote Template

Quote the job without carrying risk you never priced. This FREE construction quote template keeps provisional sums out of the fixed price and shows the client exactly what can still move.

Templates
Word Template
Excel Template
Powerpoint Template
Construction Quote Template
Template by
Jackson Row
Published:
Sep 23, 2025
Updated:
August 26, 2026

What is a Construction Quote?

A construction quote is a builder's priced offer to carry out described work, on stated terms, until a stated date. It is an offer rather than a contract, and it becomes binding when the client accepts it.

It is also called a building quote, a builder's quote or a construction quotation, and on smaller residential jobs simply a quote. They describe the same document. What separates a good one from a number on a page is that it says what is not included, keeps anything that cannot be priced yet out of the fixed price, and states how long the price holds.

Construction Quote Sample

Here is a good example of a construction quote, covering a Level 3 office fit-out with a fixed price of $372,820 and a total payable of $474,672.

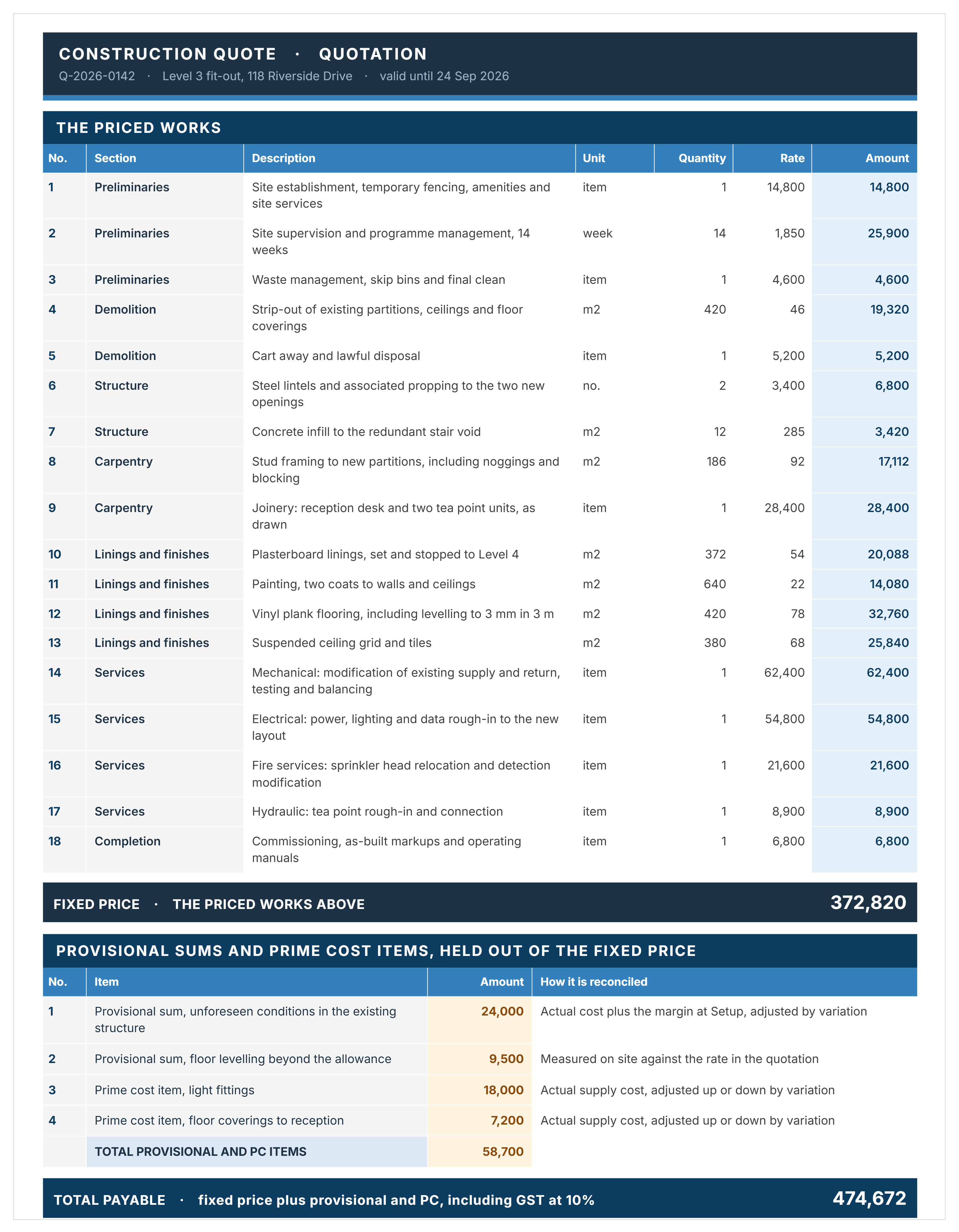

Construction quote priced line by line with unit, quantity and rate, fixed price and provisional sums held separately.
Construction quote sample showing priced works by section, provisional sums and total payable including GST.

What's in This Construction Quote Template

A building quote needs the priced works, the amounts that can still move, the exclusions, and how long the price holds. This template covers all of it across eight sheets.

Sheet What it holds
Setup Client, project, quotation number, date, valid until, builder and licence, documents priced, the contract intended. Plus the tax label and rate, margin on provisional work, retention and defects liability period.
Quotation The priced works, section by section, with unit, quantity and rate on every line. The amount, subtotals, tax and total all calculate.
Provisional & PC Items Provisional sums and prime cost items, held out of the fixed price and totalled separately.
Exclusions & Qualifications What is excluded, and the assumptions the price was built on.
Variations A register, so the quote becomes the baseline rather than a dead document.
Quote Summary The whole quotation on one screen, including what percentage of the price is provisional.
Lists Units, variation statuses and the tax setting, all editable.
Notes & Assumptions What was assumed, what to change first, and what the file is not.

The tax label and rate are set once at Setup and read by every formula: GST at 10% for Australia, 15% for New Zealand, VAT at 20% for the United Kingdom. Quantity times rate is always calculated, never typed.

How to Write a Construction Quote Using This Excel Template

Price the work first, then write the exclusions, then check what proportion of your number is still provisional before you send it.

  1. Set the tax label and rate at Setup, since every formula in the workbook reads them.
  2. Enter the client, project, quotation number, the documents priced at their revisions, and the contract you intend to sign under.
  3. Set the validity date, because the supplier quotes behind your price expire too.
  4. Price the works section by section, with a unit, a quantity and a rate on every line.
  5. Put anything that cannot be priced yet on the provisional sheet rather than burying it in the fixed price.
  6. Write the exclusions before you send the number, not after somebody asks.
  7. Set the qualifications: access assumed, hours assumed, what the price is based on, and what happens if the documents change.
  8. Read the provisional percentage on the summary, and say it out loud at the presentation.
  9. Log every variation as it arises, including the ones the client rejects.
  10. Leave superseded lines in place rather than deleting them, since the history of the price is part of the record.

A builder who quotes a number without the exclusions has transferred risk they never priced. That is the difference between a quote that holds and one that gets argued about.

Quoting Materials, Labour and Provisional Sums

Three kinds of cost sit in a construction quote, and they behave differently once the job starts.

Item What it is How it is priced What happens later
Materials and labour The works you can price now Unit, quantity and rate on every line Fixed. Only a variation changes it
Provisional sum Work that cannot be priced yet, such as making good conditions not visible at inspection An allowance, held outside the fixed price Reconciled against actual cost plus the agreed margin, either way
Prime cost item Goods the client will select, such as light fittings or floor coverings A supply allowance, held outside the fixed price Adjusted up or down by variation once the selection is made

Fixed lines are checkable. Vinyl plank flooring at 420 m² and a rate per square metre can be tested by anyone. "Flooring, $32,760" cannot.

Keeping provisional sums and prime cost items out of the fixed price is the honest way to present a number, and it produces the figure that matters most at the presentation: what percentage of the price can still move. If a third of your quote is provisional, the client should hear it from you rather than find out later.

Exclusions and Qualifications: What Defines the Price

Anything not written into the quote or listed as a provisional sum is not in the price. That is not a technicality. It is the whole basis on which the number was built.

Exclusions name what is out:

  • Asbestos and hazardous materials, including survey, removal and disposal.
  • Structural certification, where an engineer's design and certification is assumed to come from the client.
  • Statutory approvals, development and building approval fees, and any long service levy.
  • Out-of-hours work, where the price assumes normal working hours.
  • Latent conditions below the slab.
  • Furniture, loose fittings and equipment.
  • Data and communications cabling beyond rough-in.
  • Escalation after the validity date.

Qualifications name the conditions the price depends on:

  • The drawings and specification priced, at the revisions stated. A later revision is a variation.
  • Access assumed, including hours, lifts available and laydown area.
  • Existing services, assumed to be as shown on the documents provided.
  • The programme assumed, including whether any shutdown or client hold points apply.
  • How quantities were measured, and which items are measured on site.

Each line decides who pays for a specific surprise. A quotation with a thin exclusions list transfers risk the builder has not priced and cannot recover.

The variations register keeps this current after acceptance. Only an approved variation changes the contract sum. A variation marked instructed with a price to follow does not move it.

Generate Your Next Construction Quote with Mastt AI

Mastt AI is your built-in assistant, generating a clear, structured construction quote template that’s ready to use.

Mastt AI interface showing how to create a construction quote template.

Related Articles and Templates

Explore these resources for construction quotes, estimating, material costs, bids, and pricing:

FAQs About Construction Quotes

The priced works with a unit, quantity and rate on every line. Provisional sums and prime cost items listed separately. Exclusions. The assumptions the price depends on. The tax treatment. A validity date. And the contract you intend to sign under.
An estimate is an approximation and can change. A quote is a fixed offer for defined work at a stated price. Provisional sums are the one part of a quote that moves, which is why they are shown separately.
Not on its own. It is an offer, open until its validity date, and it becomes binding when the client accepts it. Acceptance is usually an instruction to proceed on those terms, with a contract signed afterwards that incorporates them.
Long enough to be considered and no longer, commonly thirty days. Supplier quotations and labour rates both move, so if the client accepts after the date, reprice and say so.
It should state the position clearly, showing the subtotal, the tax and the total payable rather than leaving the client to work it out. In Australia GST is 10%, in New Zealand 15%, and in the United Kingdom VAT is 20%, though rates change and reduced rates apply to some work. Quoting a bare number without saying whether tax is included is the most common cause of a disputed first invoice.
Only when it is approved. An instruction with a price to follow does not move the contract sum, and treating it as though it does is how builders end up carrying work nobody agreed to pay for.
Walk them through the priced works, then the exclusions, then what can still move. Clients who understand the provisional items before they sign do not treat the reconciliation as a claim afterwards.
Topic:
Construction Quote Template

Written by

Jackson Row

Jackson Row is the Growth & North American Market Lead at Mastt. With a background in risk modeling, cost forecasting, and integrated project delivery, he helps capital project owners work smarter and faster. Jackson’s work supports better tools, better data, and better outcomes across the construction industry.

LinkedIn Icon
Back to top

Frequently Asked Questions
