A FREE construction scope of work template in Word. Define the work, the standards it must meet, what is excluded, and where it meets the next trade's scope.
A construction scope of work is the contract document defining exactly what work a contractor must perform: the activities, the standards they must meet, and what is excluded.
It controls what gets paid for. Work described in it is work the contractor must deliver; work left out becomes a variation priced after award.
Document
What it defines
When it is used
Scope of work
The work one party is contracted to perform, and to what standard
Scope plus milestones, payment terms and acceptance criteria
Professional services and consulting engagements
Specification
How the work must be built: materials, tolerances, workmanship
Referenced by the scope, not a substitute for it

Construction Scope of Work Example

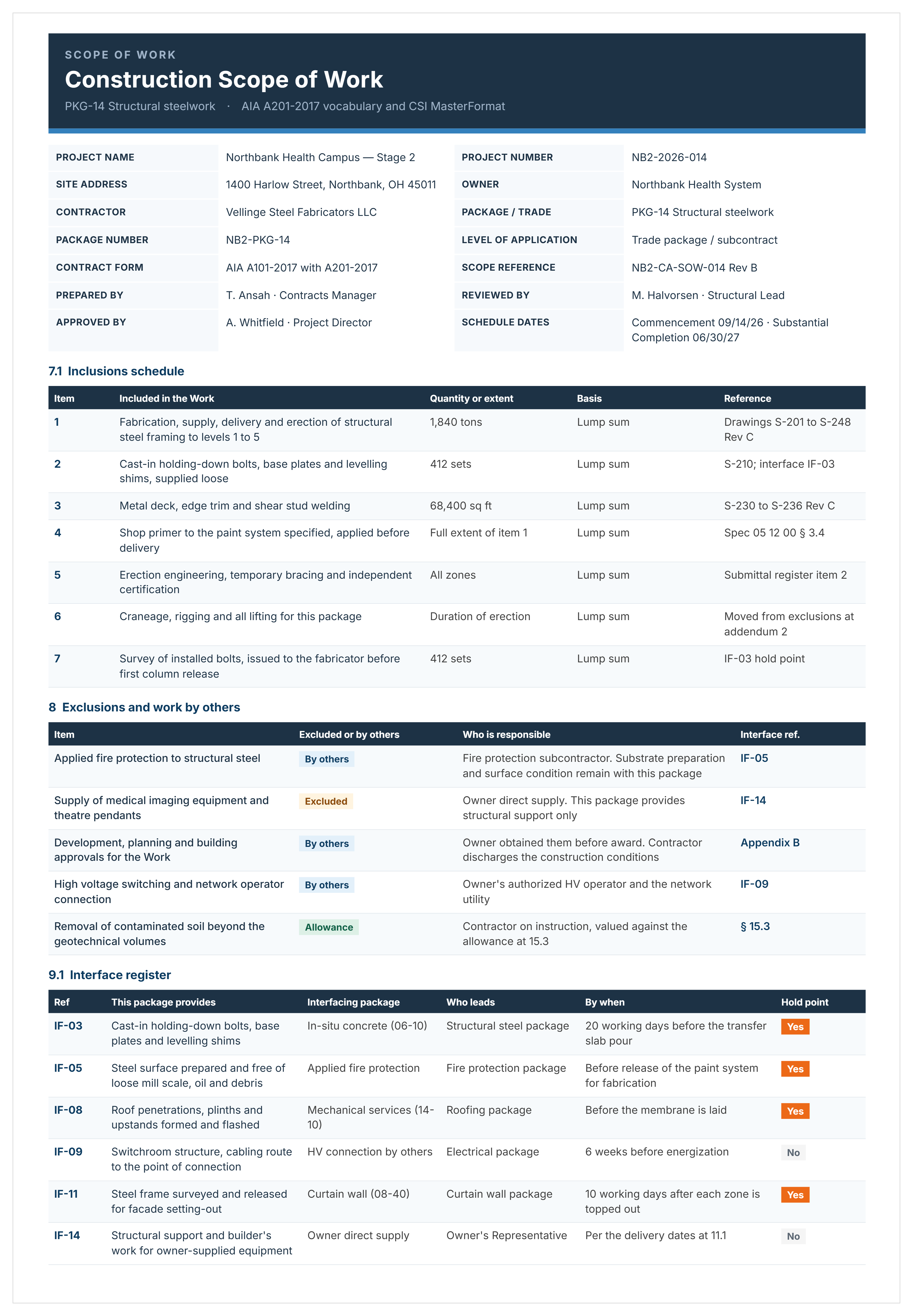

Here's an example of a construction scope of work for a trade package, showing the inclusions schedule, the exclusions and work by others, and the interface register.
Construction scope of work example showing the inclusions schedule with quantities and drawing references, exclusions with named responsibility, and the interface register with hold points.
What Should You Include in a Construction Scope of Work Document?
A construction scope of work document needs five things: the work broken down far enough to price, the standards it must meet, what is included, what is excluded, and where this scope meets somebody else's.
This template in Word format covers all of it across eighteen sections.
#
Section
What it covers
1
Document control
Revision history, distribution, and which document takes precedence when two conflict.
2
Contents
Navigation for the document.
3
Introduction and project overview
The project, the site and its constraints, the parties and their authority, the contract form, defined terms.
4
Scope summary
A plain statement of the Work, and the scope at a glance.
5
Basis of the scope
Drawing register, specification register, models, geotechnical and survey information, and the issue status of each.
6
Detailed scope of work
Scope by work breakdown and trade element, scope by construction stage, and the workmanship standards and tolerances.
7
Inclusions
The inclusions schedule.
8
Exclusions and work by others
What is not in this scope, and who is doing it instead.
9
Interfaces and coordination
The interface log, naming every point where this scope meets another.
10
Site conditions, access and constraints
What the contractor is taking on with the site.
11
Schedule and sequencing requirements
Dates and sequence obligations that bind the work.
12
Quality requirements
Inspection, testing and acceptance.
13
Health, safety and environmental requirements
Obligations carried by this scope.
14
Submittals and deliverables log
What must be submitted, when, and to whom.
15
Commercial framework
How the scope connects to the pricing and payment structure in the contract.
16
Completion, turnover and warranty
What finished means, and what is handed over.
17
Assumptions, clarifications and qualifications
What the scope assumes to be true.
18
Acceptance and execution
Signatures.
What Is Excluded from a Construction Scope of Work?
Anything the contractor is not being paid to do, named explicitly, plus who is doing it instead. An exclusion that does not say who picks the work up has moved the argument rather than settled it.
Exclusions worth writing on most projects:
Work by others. Owner-supplied equipment, separate contracts, utility authority works, and anything the owner is delivering directly.
Design. Whether the contractor is designing any part of the work, and to what stage. Design responsibility left unstated is design responsibility argued about later.
Latent conditions. Contamination, unmarked services, rock, and asbestos. What was assumed, and what happens if the assumption is wrong.
Temporary works. Access, scaffolding, craneage, hoarding, and traffic management, when another party is providing them.
Permits and approvals. Which the owner obtains and which the contractor obtains.
Testing and commissioning. Where the contractor's obligation ends and the operator's begins.
Making good. Reinstatement of adjacent areas, landscaping, and existing finishes disturbed by the work.
Provisional items and allowances. Anything priced against an allowance rather than a measured quantity.
For a client-side team, the exclusions schedule is the most useful page in the document. It is the list of work still sitting with the owner, and on most projects nobody has costed it.
How to Write a Scope of Work in Word Using This Template
Complete the basis of the scope before writing any of the scope itself. You cannot describe work accurately without knowing which drawings and specifications you are describing, and what status they are at.
Fill in document control, including which document takes precedence when the scope and the specification disagree.
Complete the project overview: the site and its constraints, the parties, their authority, and the contract form.
Register every drawing, specification, model and survey the scope relies on, with the issue status of each.
Write the scope summary as a plain statement of the Work, then break it down by work element and by construction stage.
Set the workmanship standards and tolerances, choosing prescriptive or performance wording deliberately for each.
Complete the inclusions schedule, then the exclusions and work by others.
Fill in the interface register, naming every point where this scope meets another party's.
Record every assumption. An assumption not written down is a risk somebody has priced silently, or not at all.
Sections 10 to 16 cover site conditions, schedule, quality, health and safety, submittals, the commercial framework and completion. Fill them in against the contract rather than from the template's defaults.
What Are the Different Types of Construction Scope of Work Templates?
Four, and the difference is who is procuring the work: a project scope of work, a consultant scope of services, a trade scope of work, and a subcontractor scope of work.
Type
Covers
Written by
Project scope of work
The whole project, all trades
Owner or owner's representative
Consultant scope of services
Design or professional services, measured in deliverables
Owner or owner's representative
Trade scope of work
One package: plumbing, electrical, mechanical, structural steel
General contractor or project manager
Subcontractor scope of work
One subcontractor's portion within a package
General contractor
Any of them can be written prescriptively, specifying the method and materials, or on performance, specifying the result the work must achieve. The template flags which suits each element.
Project type changes the content, not the structure. A residential remodel scope turns on rooms and fixtures; a tenant improvement scope turns on building coordination. Both use the same eighteen sections.
Related Articles and Templates
Explore these resources for construction scope, bidding, estimating, materials, and scope changes:
The party procuring the work. An owner or client-side project manager writes it for the prime contract and for consultant engagements; a general contractor writes it for subcontract packages. Whoever writes it defines what gets paid for.
To define what each contractor and consultant is engaged to deliver before going to market. On the owner side the project manager writes the project scope and the consultant scopes, then reviews the trade scopes a contractor writes from them.
The same structure works for any trade. A plumbing, electrical or mechanical scope uses the same sections as any other; what changes is the detailed scope and the interface register, which for a single trade is the section that matters most.
A project scope defines the boundaries of the whole project, including what it will not deliver. A scope of work defines what one party is contracted to do inside those boundaries. One is a planning document, the other is a contract document.
That the drawings it references are at a status worth pricing, and that every exclusion has a named owner. A scope issued against preliminary drawings will be priced with qualifications, and the qualifications are where the budget moves after award.
It references them rather than containing them. Pricing, payment schedules and the change order process sit in the contract; the scope defines the work those terms apply to.
Detailed enough that two people reading it would agree what is included. A line that says install flooring fails that test. A line that says supply and install luxury vinyl plank to floors 2 and 3, 4,500 square feet, over a substrate prepared flat to 1/8 inch in 10 feet, passes it.
It becomes a change order, priced after the contract is signed and without competitive tension. For an owner, that is the single most expensive consequence of a rushed scope.
A spreadsheet suits a scope broken into numbered line items across many trades, because it sorts and filters. Word suits a scope that needs narrative around the items, which most prime contract scopes do. Public and institutional owners often prescribe the format anyway, so check the procurement instructions before choosing.
