What is a Multiple Project Tracker?

A multiple project tracker is a single sheet holding one row per project, with the cost, schedule and status of each in the same columns so they can be compared. It answers one question: which project needs attention now.

Also called a multi project tracker or a multiple project tracking template. It is not a schedule, because it holds no tasks or dependencies, and it is not a project list, because a list records what exists while a tracker records how each one is doing.

Multiple Project Tracking Template Example

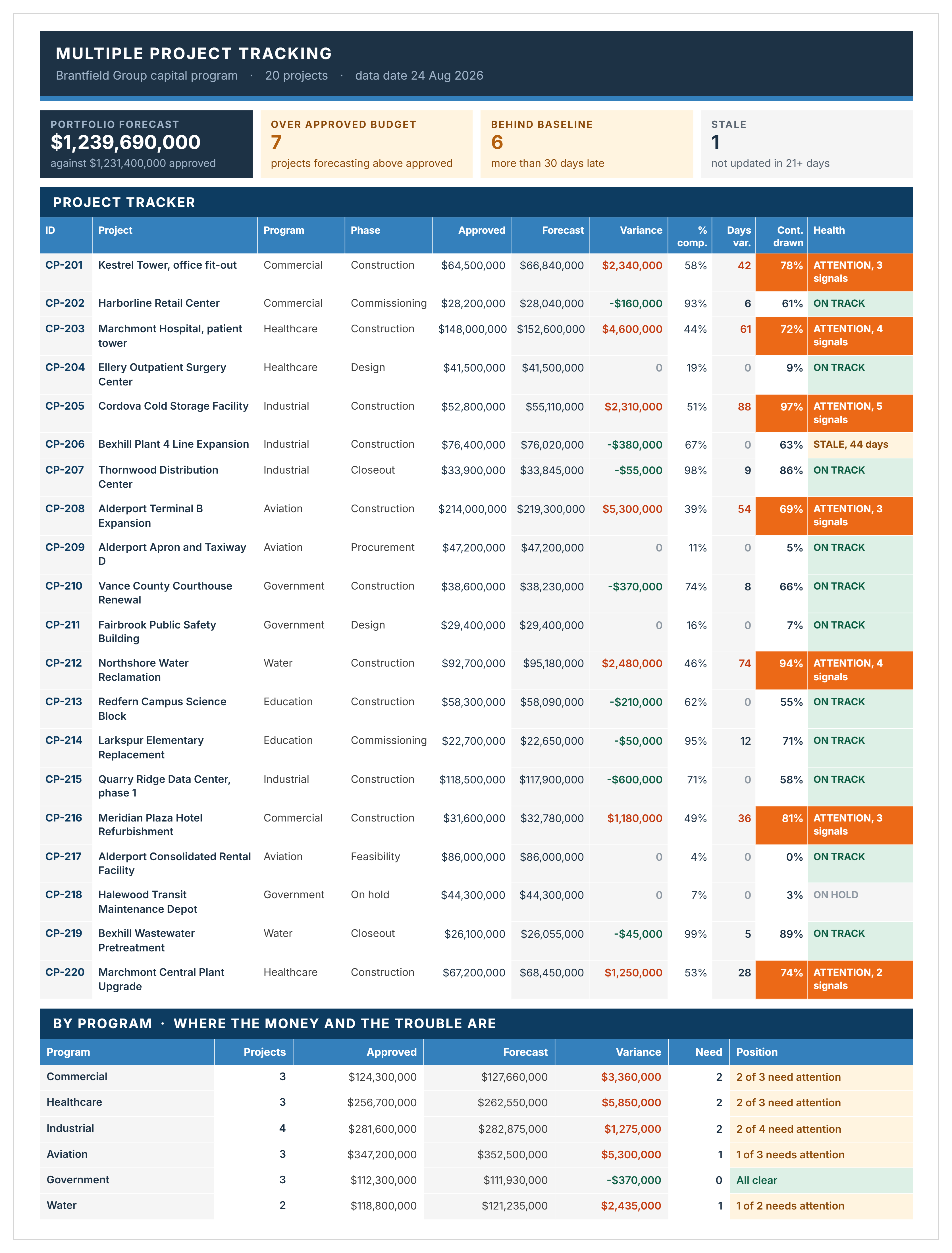

Here's a good example of a multiple project tracker, covering twenty capital projects worth $1.24 billion.

Completed multiple project tracker example for a capital program across commercial, healthcare, industrial, aviation and government projects.
Multiple project tracking template example showing twenty projects with variance, contingency drawn and health status.

What to Track Across Multiple Projects

Track four things on every project: money against approved budget, schedule against baseline, how much contingency has been drawn, and when the row was last updated.

Column What it holds
ID and project The reference and name, so a row can be traced to a file.
Program and phase Which portfolio it belongs to, and where it has reached.
Project manager One named person per project.
Approved budget The figure authorized, not the current estimate.
Forecast Cost at completion as it stands today.
Cost variance Forecast against approved, calculated.
Percent complete On the same basis for every project.
Baseline finish The approved completion date.
Forecast finish Completion as it stands today.
Days variance Forecast finish against baseline, calculated.
Contingency drawn Percentage of the contingency allowed, spent so far.
Open risks Count from the project's own register.
Overdue actions Count past due on the project's action log.
Last updated The date somebody actually touched the row.
Health The count of failed tests, calculated.

Contingency drawn against percent complete is the column most trackers leave out, and it moves first. A forecast is a judgment and judgments lag; contingency drawn is arithmetic.

How to Track Multiple Projects in Excel Using This Template

Update the whole portfolio on one day each month. A tracker where half the rows are current and half are six weeks old is worse than none, because the comparison between projects stops working.

  1. Set the six thresholds on the Reference sheet before entering anything, since every row scores against them.
  2. Edit the dropdown sources for phase, program and project manager to match your organization.
  3. Replace the fifteen example projects, typing over the white cells only.
  4. Insert new rows inside the existing block rather than below it, so the formulas and the ranking follow.
  5. Enter approved budget and current forecast from the same source you report from, not from two different ones.
  6. Enter percent complete on the same basis for every project, since mixing cost-based and time-based percentages makes the contingency test meaningless.
  7. Enter contingency drawn as a percentage of the contingency allowed, not of the budget.
  8. Set the phase to On hold for any paused project, which keeps its row and its budget but removes it from the ranking.
  9. Update every row on the same day each month, then read the ranking rather than the individual rows.
  10. Revisit the thresholds annually, since a 2% cost tolerance suits some portfolios and not others.

Fifteen to twenty projects is where a spreadsheet works. Past that, the monthly update becomes a job in itself and the data is out of date before the meeting. Capital program management software holds the same figures live, so the ranking reflects today rather than the day someone last typed.

How This Template Scores and Ranks Project Health

Every project is scored against six objective tests. Its health is the count of tests it fails, so nobody has to argue about whose project is worse.

Test Default threshold
Forecast over approved budget More than 2%
Forecast finish behind baseline More than 30 days
Contingency drawn ahead of percent complete More than 15 points
No status update More than 21 days
Open risks 8 or more
Overdue actions 3 or more

Change any threshold and every row re-scores. Staleness is a failed test on purpose. A project reporting on track that nobody has touched in six weeks is not on track, it is unknown, and most trackers show it green. Projects on hold keep their row and drop out of the ranking.

Related Articles and Templates

Explore these resources for multiple project tracking, scheduling, portfolio oversight, and program management:

FAQs About Multiple Project Tracking Templates

One row per project with approved budget, forecast, cost variance, percent complete, baseline and forecast finish, contingency drawn, open risks, overdue actions and the date the row was last updated. Anything that cannot be filled in for every project belongs somewhere else.
A project list is a directory: what projects exist, who runs them, what they are worth. A tracker adds how each one is doing against its budget and baseline, which is what lets you rank them.
Monthly, with every row updated on the same day. Rolling updates make the tracker useless for comparison, because a row updated yesterday and a row updated five weeks ago are not measuring the same moment.
Around fifteen to twenty before the monthly update becomes the bottleneck. The limit is not the spreadsheet, it is the number of people you have to chase to fill it in.
Yes. A tracker needs standard formulas rather than anything exotic, so a workbook built in Excel will open and calculate in Sheets. Conditional formatting is the part that travels least well between the two, so check any status or health highlighting after import before you rely on it.
No, and it should not try. A tracker holds one row per project. Tasks, dependencies and durations belong in a schedule, and mixing the two produces a file that does neither job.
Because nobody has updated it inside the staleness threshold, which is commonly set at around three weeks. A row nobody has touched has no current information behind it, so reporting it as on track would be reporting the last person's opinion rather than the project's position.
