What is a Notice of Delay Template?
A notice of delay template is a pre-structured document format that organizes delay notifications into standardized sections for contract compliance. It provides fields for delay event details, causation analysis, critical path impact, and supporting evidence required under contract notice provisions.
The template for notice of delay ensures contractors include all mandatory information that superintendents and contract administrators require for valid notice. It structures delay documentation consistently, making it easier to meet strict notice timeframes and avoid omissions that trigger time bars.
Notice of Delay Construction Template Format
A construction notice of delay template includes every detail needed to comply with contract provisions. It substantiates extension of time claims with proper documentation and clear delay causation evidence.
A delay report format documents the following essential components to meet superintendent requirements:
- Project identification: Contract number, project name, site address, and relevant contract clause requiring notice.
- Notice date and reference: Date of notice issuance and reference to specific contract provisions governing delay notifications.
- Delay event description: Clear explanation of what occurred, when it started, and how it affects the works.
- Cause of delay: Root cause such as weather, latent conditions, variations, or restricted site access.
- Critical path impact: Explanation of how the delay affects critical activities and extends project completion, demonstrating schedule impact beyond float consumption.
- Delay duration: Start date, expected end date, and total days of impact on the program.
- Extension of time claimed: Number of days or weeks requested as time extension under contract provisions.
- Mitigation measures: Actions taken or proposed to minimize delay impact and accelerate recovery, demonstrating reasonable delay mitigation efforts.
- Supporting evidence: Attachments such as site photos, Bureau of Meteorology weather reports, consultant correspondence, or critical path analysis demonstrating schedule impact.
- Cost claim reservation: Statement reserving rights to claim delay-related costs separately if applicable under contract terms.
- Contractor details: Name, signature, position, contact information, and date of submission for audit trail purposes.
- Distribution list: Record of who received the notice for compliance with contract notification requirements.
💡 Pro Tip: Always cross-reference your delay notice with the exact contract clause requiring notification. Different forms like AS 4000, NEC, or JCT have varying notice periods. Missing the deadline triggers time bars that kill your claim.

How to Use This Construction Delay Notice Template

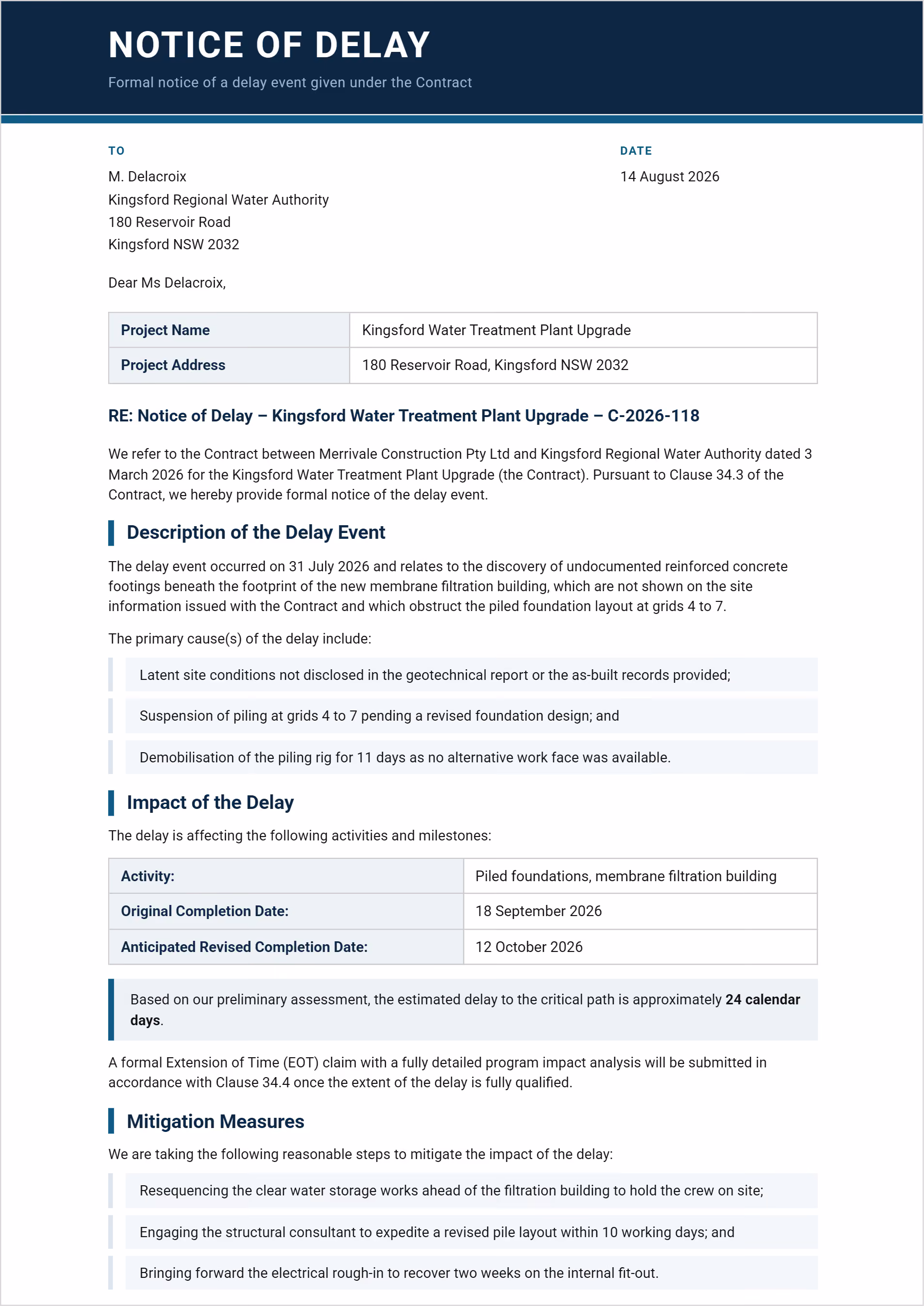

Fill in the contract details, describe the delay event and its impact on the program, then issue it inside the notice period your contract sets. The letter puts the principal on notice and reserves your position while the extension of time claim is prepared.
Replace every bracketed placeholder, and check the clause references against your executed contract before sending.
- Enter the date, recipient, project name, project address and contract number in the header
- Cite the contract, its date, and the clause that requires notice of a delay event
- State the date the delay event occurred and describe what happened, then list the causes separately
- Complete the impact table with the affected activity, the original completion date and the anticipated revised date
- Give a preliminary estimate of the delay to the critical path in calendar days
- Confirm that a full extension of time claim with program impact analysis will follow, under the relevant clause
- List the reasonable steps you are taking to mitigate, since most contracts require mitigation as a condition of entitlement
- Keep the reservation of rights paragraph intact, then sign, date and issue by the method the contract requires
Issue this before the notice period expires rather than waiting for the full picture. The letter is deliberately preliminary, giving an estimate of critical path impact and confirming a detailed claim will follow, because a late notice can extinguish an otherwise valid entitlement.
Why Use a Template for Construction Delay Notices?
Using a construction delay notice template ensures every contractual requirement is met when notifying delays. A structured format protects time extension rights. It creates defensible documentation that superintendents can assess efficiently.
Key reasons to use a construction delay notification include:
- Compliance with notice provisions: Templates ensure all mandatory information required by contract clauses is included without omissions.
- Protection against time bars: Timely, complete notices prevent contractual time bars that eliminate extension of time entitlements.
- Consistent documentation: Every delay is recorded using the same structure, creating reliable audit trails for contract closeout.
- Faster approval processing: Superintendents can assess notices quickly when information follows expected formats.
- Evidence preservation: Structured templates prompt attachment of supporting documentation while evidence is fresh and contemporaneous.
- Critical path clarity: Standard formats require clear explanation of schedule impact and float consumption, not vague assertions.
- Reduced disputes: Complete notices with proper delay causation justification minimize disagreements over time extension entitlements.
- Professional credibility: Well-structured delay notifications demonstrate commercial competence to project owners and contract administrators.
- Cost claim preservation: Proper notice preserves rights to later claim delay-related costs even if initially claiming time only.
- Concurrent delay management: Templates help document multiple simultaneous delay causes with separate causation analysis for each event.
💡 Pro Tip: Send your delay notice to every party listed in your contract's notice provisions. Missing even one required recipient can invalidate the notice under strict contract interpretation.
When to Use a Construction Delay Notice Template
A delay notification template should be used immediately when events occur that may impact project timelines. Early notification allows superintendents to assess impacts and approve mitigation measures before delays compound.
Critical situations requiring a delay notice letter include:
- Adverse weather events: Rainfall, extreme heat, high winds, or other conditions preventing safe work on critical activities.
- Latent site conditions: Unforeseen ground conditions, contamination, or underground services not shown on drawings requiring investigation.
- Variations and design changes: Owner-directed changes that extend critical path activities or prevent progress on planned works.
- Information delays: Late provision of drawings, specifications, or approvals needed to proceed with scheduled activities.
- Access restrictions: Delayed handover of work areas, restricted site access, or coordination issues affecting planned sequencing.
- Utility conflicts: Undisclosed services, relocation delays, or authority approval delays affecting critical path works.
- Subcontractor delays: Subcontractor failures affecting critical activities, though these may not qualify for EOT depending on contract terms.
- Force majeure events: Pandemics, civil unrest, or other extraordinary events beyond reasonable control.
- Concurrent delays: Multiple delay causes occurring simultaneously requiring separate project delay notice submissions for each cause with distinct causation analysis.
- Float consumption events: Activities consuming remaining float that may later become critical if additional delays occur.
💡 Pro Tip: Always issue delay notification forms during the delay event itself, not weeks or months later. Contemporaneous notification carries far more weight with superintendents and in dispute resolution.
Common Problems with Generic Delay Notice Templates
Preparing delay notices manually often results in incomplete submissions that superintendents reject immediately. Without proper structure, contractors miss critical information that contracts require for valid notice.
Typical issues with manual construction delay letter templates include:
⚠️ Missing contract clause references: Notices fail to cite the specific provision requiring notification, allowing superintendents to argue invalid notice.
⚠️ Vague delay descriptions: Generic statements like "site conditions" without specific details make delay causation assessment impossible.
⚠️ No critical path analysis: Failing to demonstrate impact on critical activities means delays may only consume float, not extend completion.
⚠️ Late submission: Missing contractual notice deadlines, often 2-5 working days, triggers time bars that eliminate claims regardless of delay merit.
⚠️ Insufficient evidence: Delay notice letters without supporting documentation like photos or weather data become "he said, she said" disputes.
⚠️ Incomplete distribution: Sending notices to some but not all required parties invalidates notification under strict contract interpretation.
⚠️ Format inconsistency: Each delay documented differently makes pattern analysis impossible and undermines credibility during contract closeout.
⚠️ No cost reservation: Failing to preserve cost claim rights in the construction delay notification means accepting time extension without compensation for delay costs.
⚠️ Float consumption ignored: Not addressing how delays affect remaining float makes it difficult to substantiate schedule impact on later concurrent delays.

Protect Your Time Extension Rights with Mastt AI
Every day of delay without proper notice increases liquidated damages exposure and weakens extension of time claims. Superintendents reject incomplete notices routinely, forcing contractors to resubmit while precious notice deadlines expire.
