Fatigue management plan template with scope, applicable instruments and model Code fatigue thresholds table.
Fatigue Management Plan Template

Enter your email below to download the file.

By downloading, you agree to receive marketing emails from Mastt. Unsubscribe anytime.

Oops! Something went wrong while submitting the form.
Free Template

Fatigue Management Plan Template

Use this fatigue management plan template to control hours-of-work risks and prevent fatigue-related incidents. Systematic hazard identification protects crews while demonstrating the regulatory compliance construction sites require.

Templates
Word Template
Excel Template
Powerpoint Template
Fatigue Management Plan Template
Template by
Doug Vincent
Published:
Nov 24, 2025
Updated:
August 18, 2026

What is a Fatigue Management Plan Template?

A fatigue management plan template is a structured workplace safety document used to identify, assess, and control fatigue hazards in construction environments. It provides a systematic framework for managing risks from extended shifts, early starts, physically demanding work, and equipment operation.

The template establishes procedures for monitoring work hours, enforcing rest requirements, and implementing controls that prevent fatigue-related incidents. Construction teams use it to demonstrate due diligence and maintain compliance with Occupational Safety and Health Administration (OSHA) guidelines and state safety regulations.

Fatigue management plans treat tiredness as a hazardous workplace condition requiring the same systematic controls applied to fall protection or confined space entry. The template documents how organizations will identify workers at risk, implement preventive measures, and respond when fatigue compromises safety.

What's Included in Fatigue Risk Management Plan Templates?

A fatigue risk management plan template contains the essential components needed to systematically control fatigue hazards across construction operations. The structure captures identification methods, control measures, monitoring procedures, and compliance documentation in one framework.

Core elements in effective fatigue management documentation include:

  • Fatigue Risk Assessment Matrix: Evaluation criteria rating likelihood and severity of fatigue hazards based on shift patterns, work intensity, and environmental conditions.
  • Hours-of-Work Limitations: Maximum daily hours, weekly limits, consecutive workday restrictions, and mandatory rest periods between shifts aligned with duty-hour regulations.
  • High-Risk Work Identification: Specific activities where fatigue creates elevated danger, including crane operation, working at heights, traffic control, and heavy equipment use.
  • Administrative Controls: Work-rest schedules, shift rotation patterns, break requirements, job rotation protocols, and workload distribution strategies that limit exposure.
  • Fitness-for-Duty Procedures: Pre-shift checks, worker self-assessment tools, supervisor observation protocols, and criteria for removing fatigued workers from high-risk tasks.
  • Incident Reporting Requirements: Documentation procedures for fatigue-related near misses, accidents, and signs of worker impairment requiring investigation.
  • Training and Communication: Educational content on fatigue risks, sleep hygiene, circadian rhythms, and responsibilities for workers, supervisors, and management.
  • Monitoring and Review Protocols: Scheduled audits of work hours, roster compliance checks, effectiveness assessments, and continuous improvement processes.
💡 Pro Tip: Include clear "trigger thresholds" in your template, like three consecutive 12-hour days or any shift starting before 5am. Specific numbers make enforcement easier than vague "excessive hours" language that supervisors interpret differently.

Fatigue Management Plan Example

Here's an example of a fatigue management plan template completed for night and shutdown works on a rail interchange project. It shows the threshold table in section 4 and the declaration response in section 7.

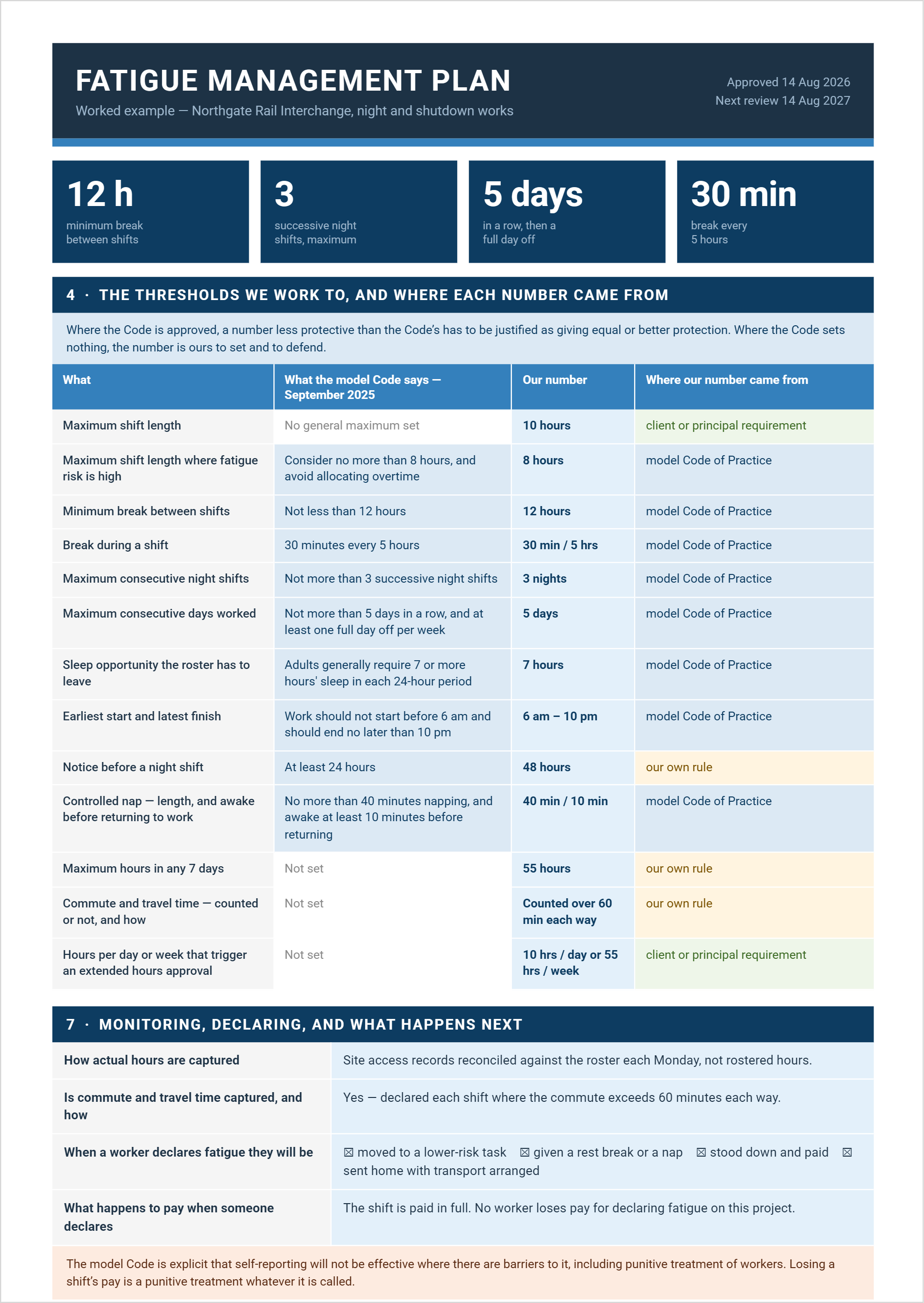

Fatigue management plan example showing shift length, break and night shift thresholds with the source of each number.
Fatigue management plan example showing threshold table and fatigue declaration response.

The fourth column is what makes a fatigue management plan defensible. Every number is attributed to the model Code, a client requirement, or a house rule. Where the Code sets nothing, this plan still sets a number and says whose it is.

Then read the last row of section 7. The shift is paid in full. That line decides whether anyone ever declares fatigue at all.

How to Use This Fatigue Management Procedure Template

Start with section 2, which establishes which law and which code actually apply to your project, then set your thresholds in section 4 against what the September 2025 model Code says. Everything after that follows from those two decisions.

Work through the eight sections in order, then copy the appendix forms as often as the work needs.

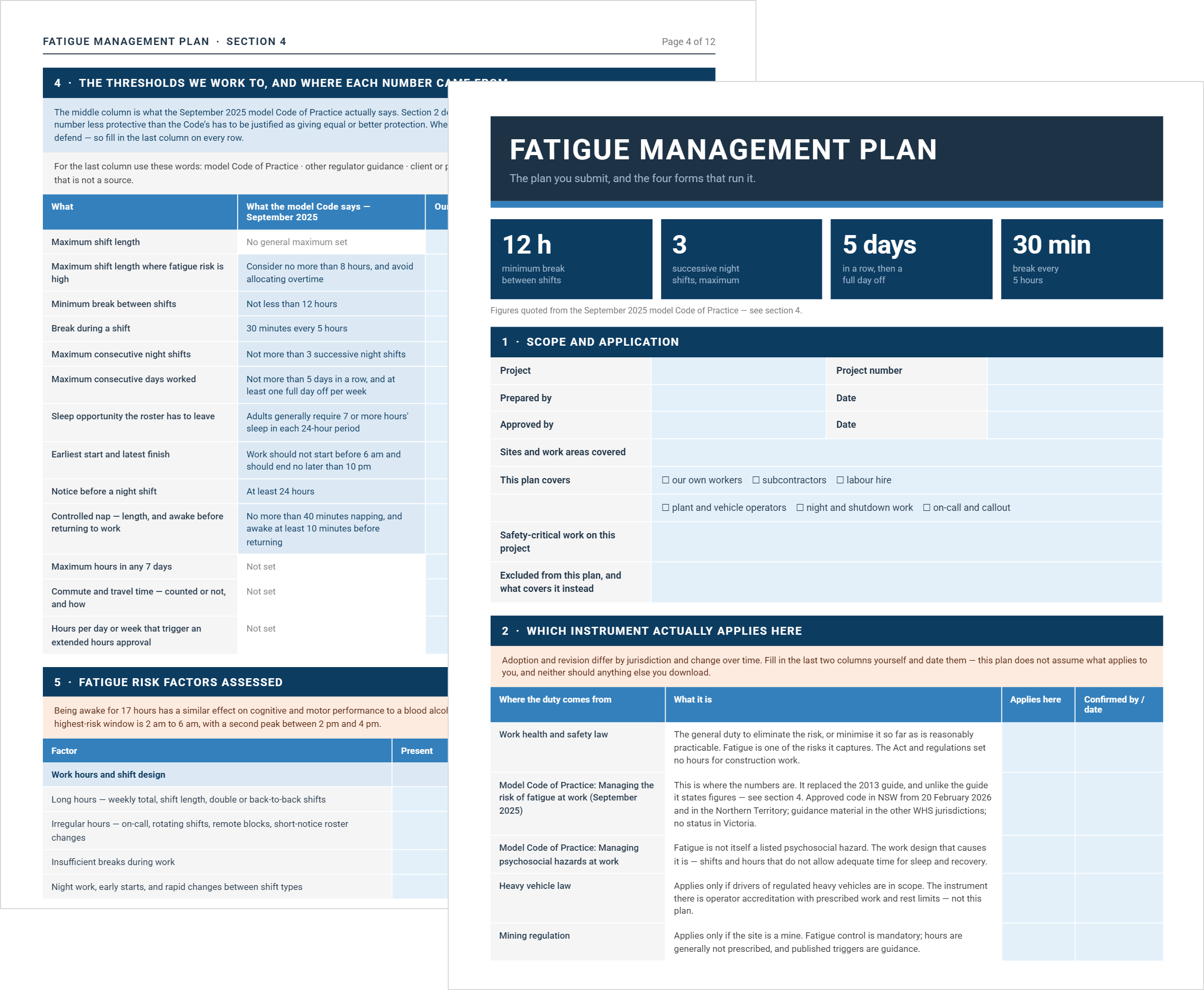

  1. Complete section 1 with the project, the sites covered, which categories of worker are in scope, and what safety-critical work exists on the job
  2. Fill in section 2 before anything else, confirming which instrument applies and dating each confirmation, since the fatigue code is approved in some jurisdictions, guidance in others and has no status in Victoria
  3. Scope out heavy vehicle drivers and rail safety workers, because those groups are covered by accreditation and a mandatory fatigue risk management program rather than by this plan
  4. Name a person against every role in section 3, including subcontractors and labor hire providers who hold hours worked for other hosts
  5. Read the middle column of section 4, then set your own number on every row and record where it came from, using the Code, regulator guidance, a client requirement or your own rule
  6. Assess the factors in section 5 against the work you are actually doing, including monotony and low-demand tasks, which are listed hazards rather than soft options
  7. Work down the controls in section 6 in order, since roster design is a primary control and asking a tired worker to be careful is the weakest layer on the page
  8. Answer the pay question in section 7, stating what happens to a worker's money when they declare fatigue
  9. Copy Appendix A, B, C and D as needed, one to a page, for self-declarations, extended hours approvals, roster assessments and fatigue reports

The pay row in section 7 decides whether the rest of the plan works. The model Code is explicit that self-reporting fails where barriers exist, including punitive treatment, and losing a shift's pay is punitive whatever it is called. Leave that row blank and you have built a system in which nobody declares.

Why Construction Sites Need Fatigue Management Plans

Construction sites need fatigue management plans because tired workers operating heavy equipment or working at heights create catastrophic incident risk. Structured fatigue controls prevent the injuries, deaths, and liability exposure that result when impaired workers make critical safety errors.

Fatigue impairs cognitive function and reaction time similarly to alcohol intoxication. Extended wakefulness degrades the judgment, alertness, and coordination required for safe equipment operation and high-risk construction tasks.

Construction fatigue management plans delivers critical safety outcomes:

  • Prevents serious incidents and fatalities: Reduces crane accidents, vehicle collisions, falls from heights, and equipment-related injuries caused by impaired judgment and slowed reactions.
  • Demonstrates regulatory due diligence: Provides documented evidence of hazard management that satisfies OSHA general duty requirements and state safety legislation.
  • Protects against liability claims: Creates defensible records showing reasonable precautions were taken when fatigue-related incidents result in worker injury or property damage.
  • Maintains project productivity: Well-rested crews work more efficiently, make fewer mistakes, and require less rework than fatigued workers struggling through extended shifts.
  • Reduces workers' compensation costs: Lower incident rates translate directly to reduced insurance premiums and fewer medical claims requiring management time.
  • Supports competitive bidding: Clients increasingly require documented fatigue management plans before awarding contracts on major projects and government work.
  • Improves workforce retention: Workers value employers who prioritize health and safety over relentless overtime pressure that destroys work-life balance.

Documented fatigue controls reduce incident risk substantially compared to informal hour management. The difference lies in clear procedures that supervisors actually enforce.

When to Implement Fatigue Risk Controls

Fatigue risk controls should be implemented during project planning before crews mobilize to site. Early deployment enables teams to build realistic schedules that protect safety without emergency adjustments mid-project.

Deploy a fatigue management plan at these critical moments:

  • Pre-construction planning: Establish work-hour limits, shift patterns, crew rotation schedules, and rest requirements before contracts execute and schedule pressure builds.
  • Shutdown and turnaround work: Apply enhanced controls when compressed schedules create extended-hour pressure to complete critical maintenance or emergency repairs.
  • Weather makeup periods: Implement strict monitoring after rain delays when teams work extended hours to recover lost time on tight schedules.
  • Night shift operations: Deploy additional controls for graveyard shifts when circadian disruption compounds fatigue risks beyond standard daytime work.
  • Remote project sites: Strengthen procedures when long commute times add 2-3 hours to work shifts, creating extreme wake-time exposure.
  • Seasonal peak demand: Heighten monitoring during busy periods when skilled labor shortages tempt contractors to overwork available crews.
  • After fatigue incidents: Immediately review and strengthen controls following any accident, near miss, or observed impairment linked to tiredness.
💡 Pro Tip: Require fatigue management plans in your subcontractor prequalification process. Don't wait until a tired excavator operator hits a gas line to discover subs have zero hour controls.

Best Practices for Managing Workplace Fatigue

Effective workplace fatigue management requires leadership commitment that treats hours-of-work controls as non-negotiable safety requirements. Smart practices balance productivity demands against the physiological reality that tired workers create unacceptable risk.

☑️ Set clear maximum work limits: Establish firm daily hour caps (typically 12-14 hours maximum), weekly limits (usually 60-70 hours), and consecutive workday restrictions that supervisors can't waive.

☑️ Enforce mandatory rest periods: Require minimum 8-10 hours between shifts, mandate days off after consecutive work periods, and prohibit "clopening" turnarounds under 10 hours.

☑️ Monitor actual work hours: Track time from home departure to return, not just on-site hours, capturing commute impact on total wake time.

☑️ Rotate high-risk tasks: Limit continuous exposure to cognitively demanding work, alternate physically intense activities with lighter duties, and provide recovery time.

☑️ Create reporting-friendly culture: Encourage workers to self-report fatigue without punishment, remove barriers to speaking up, and praise those who recognize their impairment.

☑️ Schedule strategically: Avoid early morning starts under 5am when possible, limit night shifts to essential work, and use forward-rotating schedules that align with circadian rhythms.

☑️ Provide adequate rest facilities: Ensure break areas support actual rest, maintain comfortable temperatures, reduce noise, and prohibit work discussions during breaks.

☑️ Lead by example: Ensure supervisors and managers model appropriate work hours, take scheduled breaks, and demonstrate that safety trumps schedule pressure.

Mastt AI chat interface generating customized fatigue management plan from user input

Build Safer Worksites with Systematic Fatigue Controls with Mastt

Fatigue management shouldn't mean adapting generic templates that ignore construction realities. Workers deserve systematic protection from hours-of-work hazards that create preventable incidents, injuries, and deaths.

With Mastt AI, you can generate fatigue management plans tailored to actual shift patterns, work intensity, and operational constraints. Plans include construction-specific controls, realistic work-hour limits, and enforcement procedures that supervisors can actually implement.

👉 Start creating compliant fatigue management plans with Mastt AI today and protect crews from preventable fatigue-related incidents.

Related Articles and Templates

FAQs About Fatigue Management Plan Templates

Word format works best for customization and updates, while PDF suits site distribution and compliance documentation. Excel formats help track hours and roster compliance but don't replace comprehensive plan documentation.
Yes. OSHA general duty requirements apply regardless of company size, and documented controls protect against liability when fatigue contributes to incidents. Simple plans work for small operations but systematic procedures remain essential.
Document realistic schedules during bidding, build contingency time for delays, communicate limits clearly upfront, and prioritize safety over unrealistic expectations. Contract terms should define work-hour restrictions before project start.
Yes. Cognitive fatigue from complex problem-solving, decision-making under pressure, and coordination challenges impairs safety as much as physical tiredness. Effective plans address both dimensions.
Review plans quarterly at minimum, immediately after fatigue-related incidents, when shift patterns change significantly, or when regulatory guidance updates. Continuous improvement requires regular assessment and adjustment.
Topic:
Fatigue Management Plan Template

Written by

Doug Vincent

Doug Vincent is the co-founder and CEO of Mastt, the AI capital-project management platform used by governments, Fortune 500 companies, and consultancies across APAC, North America, and MENA. Before founding Mastt in 2019, he spent a decade at RPS delivering more than $2 billion in capital works, including the $2.1B Defence Navy Infrastructure program, and holds a CPSPM certification with the AIPM. He contributes content and speaks on AI in capital project delivery at Mastt.

LinkedIn Icon
Back to top

Frequently Asked Questions

More Templates

Supercharging Construction Project Management with AI-Powered Tools
