What is a Project Report Template?

A project report template is a pre-structured document for reporting a project's status to whoever funds or governs it. It covers where the project stands on cost, schedule, risk and quality, what moved this period, and what decisions are needed next.

A project report template gives you the structure, so each period you update the content rather than rebuild the document. Most are issued monthly, some quarterly, and the same structure carries across the project's life. For reporting on a fixed monthly cycle, use the monthly report template in Word.

Project Report Format: What to Include

A standard project report format opens with the project's identity and current status, then works through progress, schedule, cost and risk, and closes with what the reader has to decide. Governance reports also carry a distribution list and a sign-off, because a report nobody is named on cannot be relied on later.

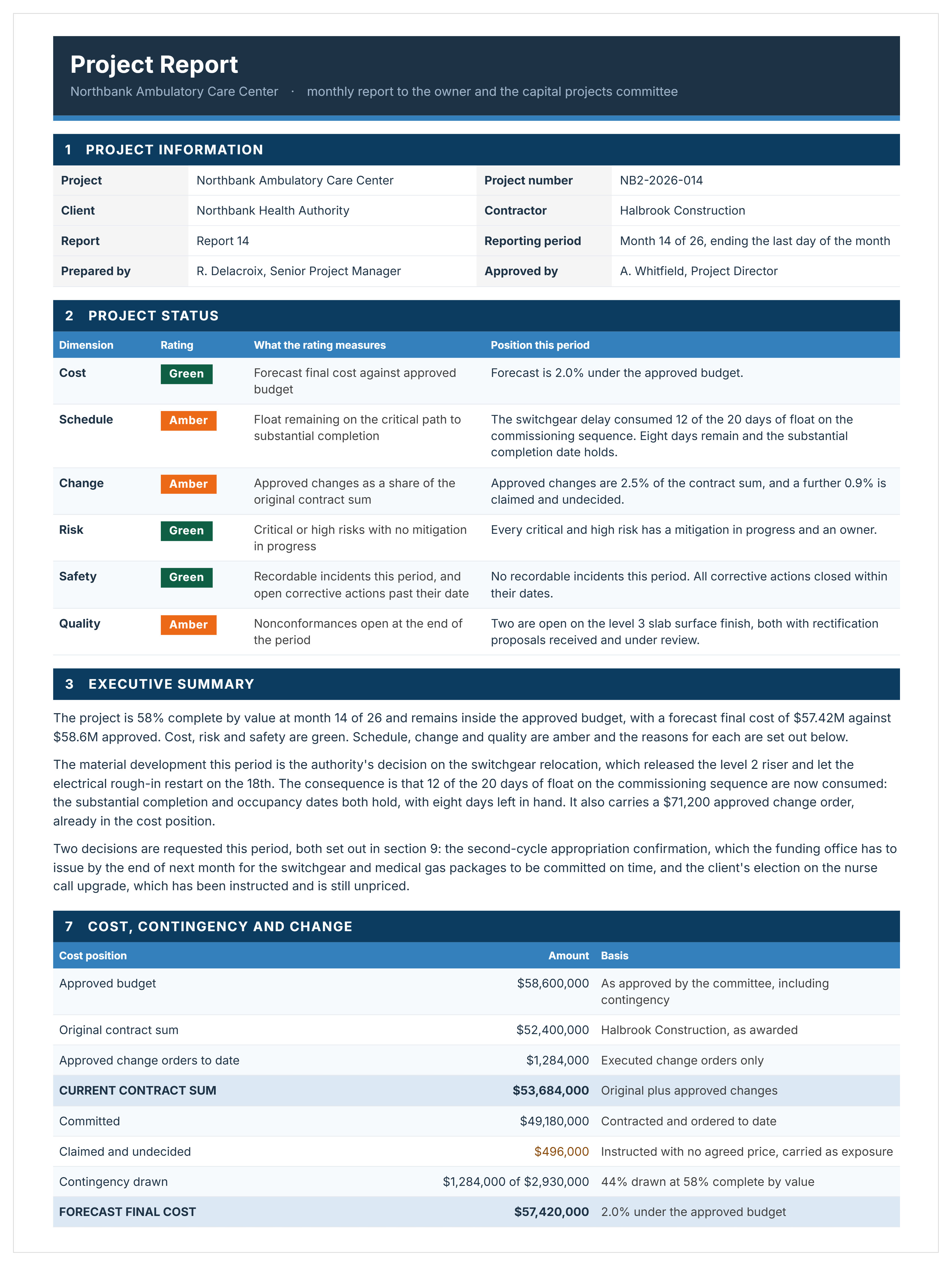

Completed project report first page with status ratings, format, executive summary and cost position for a healthcare construction project.
Project report template showing project information, status ratings with the test behind each, executive summary and cost position.

This template covers that format across ten sections.

# Section What it covers
1 Project information Project, number, client, contractor, report number, reporting period, prepared by, approved by, distribution list.
2 Project status Six dimensions rated, each printing the test and threshold behind its rating.
3 Executive summary Where the project stands, what changed this period, and what is being asked for.
4 Goals and objectives Each objective, what success looks like, its status and its position this period.
5 Progress this period What moved, and what starts or continues next period.
6 Schedule and milestones Baseline against forecast or actual, the basis for each, and the variance in days.
7 Cost, contingency and change Approved budget, forecast final cost, contingency drawn, approved and pending changes.
8 Risk, safety and quality Open risks with mitigation status, incidents, and nonconformances.
9 Decisions required Each decision, who makes it, by when, and what happens if it is not made.
10 Look ahead Next period, the next three periods, and what would change this report.

A sign-off block follows, recording who prepared the report, who approved it, and the date the figures are current to.

How to Use This Project Report Template in Word

Replace every number and every sentence. The structure is what transfers, not the content.

  1. Complete the project information block, including the reporting period and the distribution list.
  2. Agree your status thresholds with whoever receives the report, before the first one is issued.
  3. Rate each status dimension against those thresholds, and state the position that produced the rating.
  4. Fill in the body sections: goals, progress, schedule, cost, risk.
  5. List the decisions you need, each with an owner, a date and the consequence of missing it.
  6. Complete the look ahead, including what would change the report.
  7. Write the executive summary last, once you know what the report says.

The file's own guidance adds two rules worth following: report the exception rather than the diary, and keep every figure deriving from one set of inputs so the totals in different sections agree.

A template is filled in from scratch every reporting period. Capital project management software keeps the same report structure cycle to cycle and pulls the numbers from live project data, so the report is assembled rather than rewritten.

How This Template Publishes the Test Behind Each Status Rating

Most project reports show a color with nothing behind it. This template prints the test and the threshold next to every rating, so a reader can check the color rather than accept it.

Six dimensions, each with a stated test:

Dimension What it measures
Cost Forecast final cost against approved budget.
Schedule Float remaining on the critical path to substantial completion.
Change Approved changes as a share of the original contract sum.
Risk Critical or high risks with no mitigation in progress.
Safety Recordable incidents this period, and open corrective actions past their date.
Quality Nonconformances open at the end of the period.

The file carries worked thresholds for each, but they are illustrative. Set your own and agree them with whoever receives the report before the first one is issued.

Related Articles and Templates

Explore these resources for project reporting, status updates, performance tracking, and stakeholder reporting:

FAQs About Project Report Templates

Monthly is standard on capital projects, with quarterly reporting to a board or committee. The period matters less than keeping it fixed, since a report issued on a moving cycle cannot be compared with the one before it.
The project manager prepares it and a project director or sponsor approves it. Both names belong on the document, along with the distribution list, so a reader six months later knows who stood behind the figures.
Where the project stands, what changed this period, and what is being asked for. Write it last. A reader who gets no further than the first page should still know the position and the decisions outstanding.
The report issued at project completion, covering final cost against budget, final schedule against baseline, what was delivered, and lessons learned. It closes the reporting record rather than continuing it, so it is written once and not on a cycle.
Word, for a periodic report. It is mostly narrative and tables, which Word handles better. Where figures come from a spreadsheet, bring the totals across rather than embedding the sheet.
Long enough to carry the status, the exceptions and the decisions. Most monthly reports run five to ten pages with detail in appendices. The test is whether a reader can find the decisions without hunting.
Not well. A project report is a single-project document, and reporting across a portfolio means repeating it for each one, which is where program management software rolls cost, risk, schedule and reporting up into one view.
