Retail Construction Project Management: How to Build for Tenants You Don’t Have Yet

Joshua Gamble
Post author:
Joshua Gamble
Contributor:
Doug Vincent
Reviewed by:
Doug Vincent
Published:
Jul 10, 2026
Retail Construction Project Management: How to Build for Tenants You Don’t Have Yet

In retail construction project management, you often break ground before you know your tenants. On most projects, the leases aren’t signed when we start. We might have preferred operators in mind (food, specialties, medical), but the market decides who takes each tenancy.

This article covers how to manage a base build for unknown tenants and how retail differs from residential. It also covers how to deliver while a center keeps trading.

TL;DR
Retail projects are built around uncertainty. Flexible base builds, early leasing input, and spare service capacity help absorb late tenant changes. Careful staging protects cost, program, and ongoing trading operations.

What Is Retail Construction Project Management?

Retail construction project management is the planning, coordination, and delivery of a retail building on behalf of its developer. The project manager runs the base build, services, and tenancy layouts so the center can take tenants as they sign. What sets retail apart is that you usually start before the leases are signed.

Most of my career has been in retail, from a family shopfitting business to tenancy delivery on a center redevelopment. Tenancies fill as leasing progresses. So you plan and sequence the work around a mix you can only estimate at the start.

Retail vs Residential Construction

Retail and residential projects differ on one thing that changes everything: certainty. In residential construction, you know the product before you build it. In retail construction, you don’t, so you build for change rather than a fixed design.

The gap between the two shows up across the whole delivery:

Factor Residential Construction Retail Construction
What you deliver A finished, sellable asset for a set demographic A flexible framework for a market-led tenant mix
When tenants are set Chosen up front, before design Confirmed during construction, as leases sign
Typical changes Late and cosmetic, mostly soft finishes Structural, down to moving tenancy walls
Build approach Build to a fixed design Build for change

For retail development, the tenants are only half the picture. A shopping center only works if people keep coming through the door. Foot traffic drives sales, and sales drive the leasing rates a developer depends on. So you design for the shopper, not only the tenant.

How Do You Manage a Retail Base Build for Unknown Tenants?

You manage a base build for unknown retail tenants by designing for flexibility. Then you control where change can happen later. The base build is the shell-and-core you commit to before leases exist. Every allowance in it decides whether a late tenant is a quick change or a redesign.

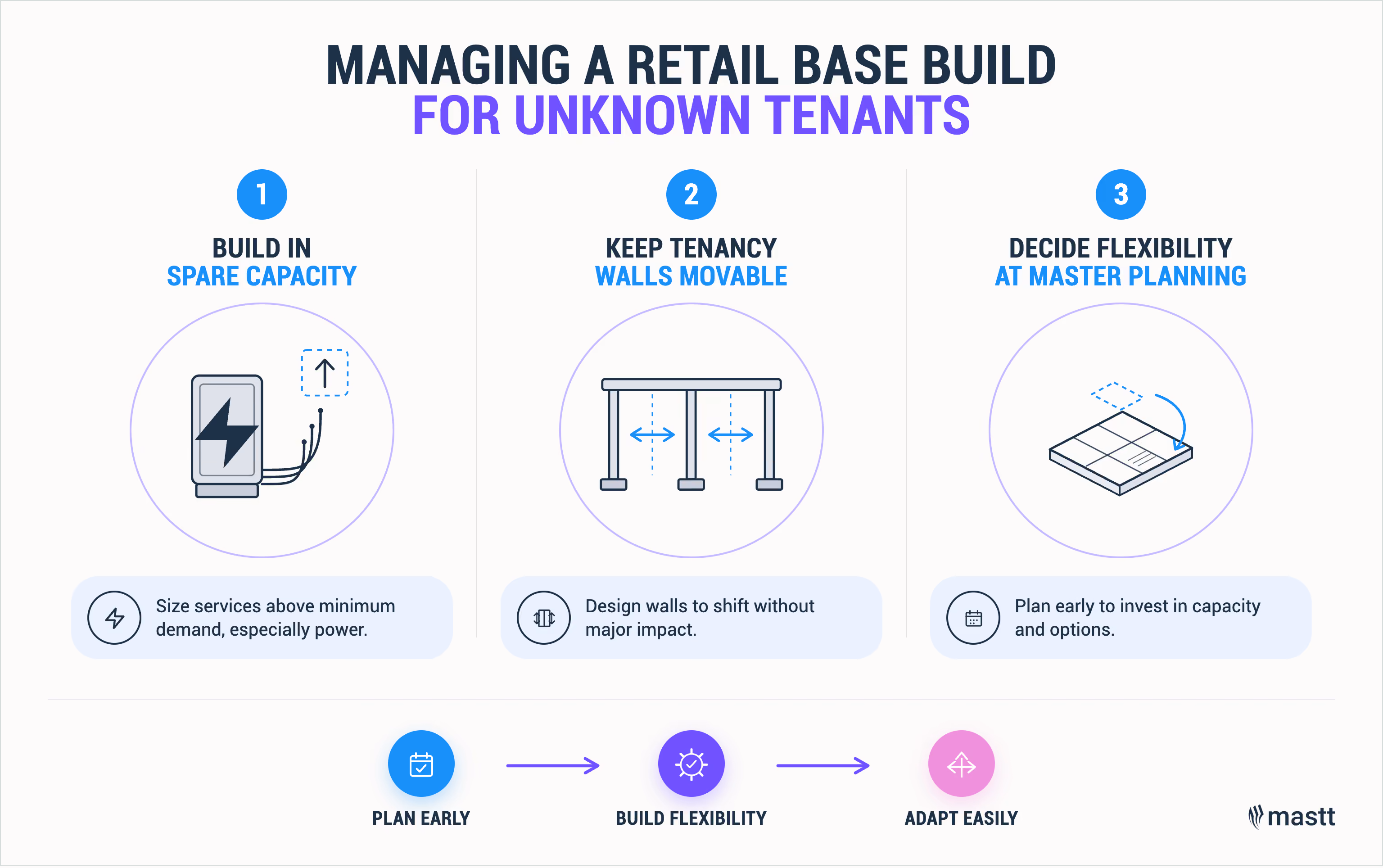

Retail base build strategies for unknown tenants: spare capacity, movable tenancy walls, and master planning flexibility.
A flexible retail base build gives future tenants more room to fit out without costly rework.

1. Leave spare capacity in the services

Size the services above the base case, especially power. A food operator may need a 100-amp three-phase supply, and that’s common across a center. Build to the minimum, and the first demanding tenant might force an upgrade you should have priced.

2. Keep the tenancy walls movable

Inter-tenancy walls will move. Leasing splits one tenancy in two, merges two into one, or resizes a space for a signed tenant. Detail these walls so they shift without touching the structure or major services.

3. Decide the flexibility in master planning

These calls belong at master planning, while you can still spend money on capacity or move things around. Come in after the master plan is set and you’re unwinding decisions instead of shaping them.

I have seen this play out with ALDI. They need around 10 kPa of floor loading, which means a suspended slab, plus their own power supply and boards. None of that is cheap to retrofit. So we price it into the base build early, while it is still just a line on the drawings.

💡 Pro Tip: Let the most demanding tenant you might land set the base for that zone. You can’t add floor strength or a dedicated supply after the pour.

How to Manage Leases That Sign During Construction

You manage it by getting ahead of the leasing process, because you can’t control its timing. Leasing is a sales process, so deals close when tenants commit, sometimes at the end of construction. Your job as project manager is to protect the program and budget against that uncertainty.

In practice, you manage leases as a PM with three levers:

  • Advise leasing before signing. Tell the agent what a tenancy can and can’t have, and what a change will cost.
  • Push for early lease commitments. The earlier a tenant signs, the more you can absorb without retrospective works. A late signer might give you only a week.
  • Spot what a lease needs immediately. My business partner Olli and I both came from tenancy delivery. We see straight away what a lease demands and whether it works.

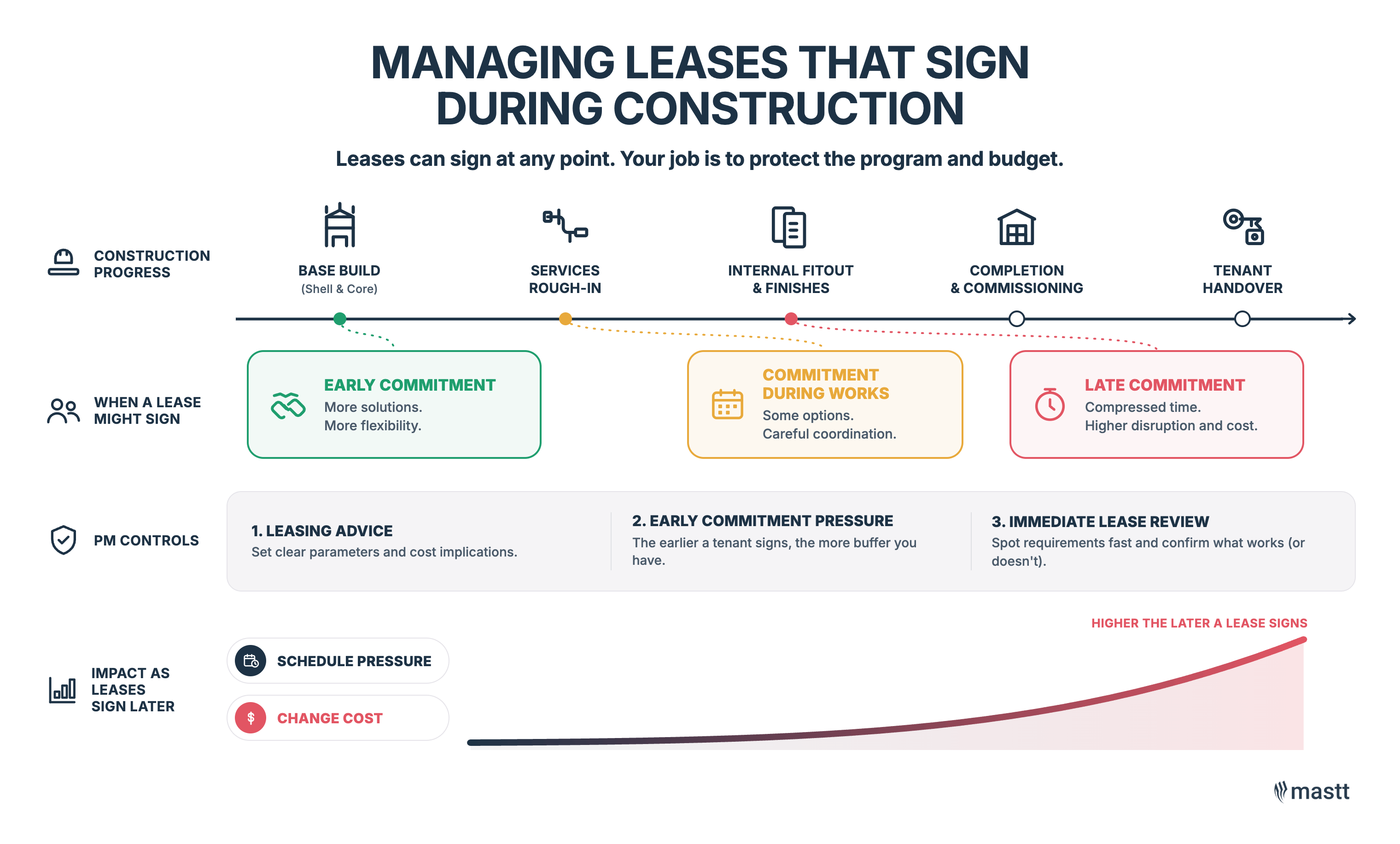

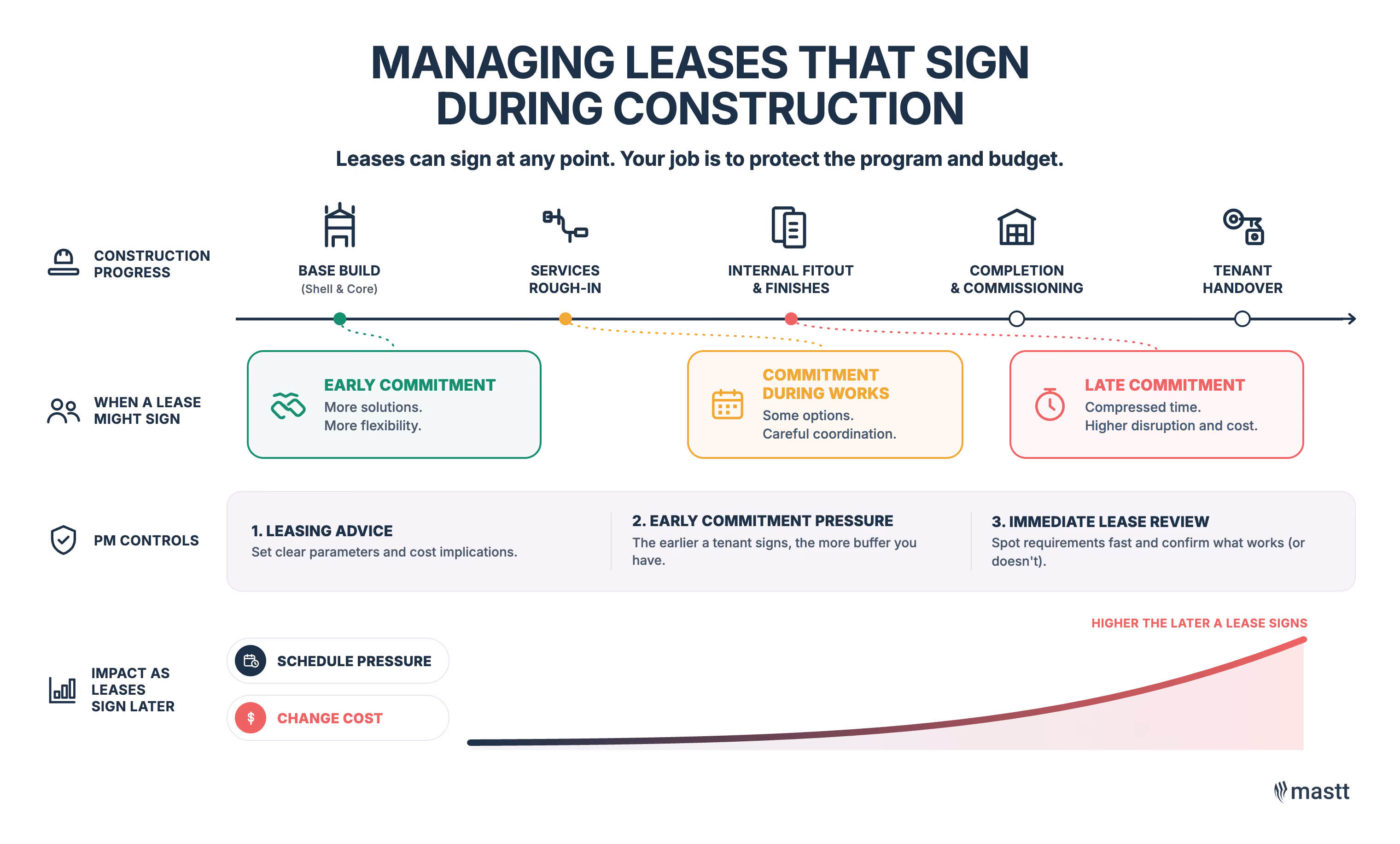

Lease timing during construction, from early commitment to late commitment.
The later a retail lease signs, the harder it is to protect the program and budget.

How Do You Keep a Shopping Center Trading Through Redevelopment?

A shopping center can continue trading during redevelopment by treating everything operational as untouchable. Every shop that’s open has to stay open, so the sequence works around trading hours.

That rule shapes how you sequence the work:

  1. Move disruptive and noisy work to night shifts, out of trading hours.
  2. Plan every tie-in around a center that can’t go dark.
  3. Where there are several distribution boards, piggyback off one and keep the rest live.
  4. Stage the night tie-in fully, so power is on before the doors open.

Power tie-ins are the recurring problem here. Nobody wants to shut the whole center down to connect, and retailers want the lights on first thing.

Plan for Flexibility on a Retail Project

Retail delivery rewards the project manager who plans for the tenant mix to change. Set the framework early, and a late deal is routine, not a scramble.

If you’re setting up controls for a retail development, start where a late tenancy change hits first. That means variation (change order) management and contract management. Guides to both are a practical place to start.

FAQs About Retail Construction Project Management

A new retail center is generally easier to design because new services and infrastructure can be planned without working around existing conditions. Redevelopment is often more complex to sequence because the retail center usually needs to remain open and operational while construction work is underway.
Cost is usually the main priority because a retail development must deliver a financial return. If the project costs do not support a viable business case, the developer is unlikely to proceed. Feasibility therefore influences almost every design, procurement, and construction decision.
A client-side project manager acts as the retail developer’s eyes and ears throughout the project. They oversee day-to-day delivery, coordinate consultants and contractors, monitor cost and program, and resolve issues before they reach the client, allowing the developer to focus on broader business priorities and future projects.
If a contractor or trade becomes insolvent before completing its work, the project can be significantly delayed. The main contractor may need to secure the site, assess incomplete work, and appoint a replacement. This can disrupt the construction program and, depending on the contract arrangements, increase project costs.
