Jackson RowConstruction project cost tracking helps teams monitor spending against the budget. Explore tools, methods, and best practices for tracking commitments, actual costs, and changes.
Use this FREE Construction Cost Tracker Template to monitor budgets, actuals, and cost variances. Track contracts, change orders, EAC, and payment progress for better cost control across your project.
Construction project cost tracking helps owners decide whether they can afford further work as a project develops. Those decisions become harder when approved changes, payment records, and forecasts are out of date. Keeping the information current gives the team time to address cost increases before committing more of the budget.
Construction project cost tracking is the process of recording and comparing project costs with the approved budget. It shows the value of contracts and changes, how much has been paid, and which obligations remain unpaid.
Cost tracking connects these records to specific work packages or budget categories. When a cost changes, the team can trace it to the relevant contract, variation (change order) or expense. This provides the detail needed to explain differences between the budget and the project's current commitments.

Construction cost tracking should cover labor, materials, equipment, contracted work and the owner's wider project expenses. That includes feasibility work and consultant appointments before construction starts, where they form part of the approved scope.
The following categories describe the costs within that overall project budget:
💡 Pro Tip: Include costs outside the main construction contract, such as consultant fees and owner-purchased equipment. Use Mastt construction project cost management software to track these costs against their own budget categories.
Construction cost tracking combines methods for recording obligations, grouping expenses and assessing performance. Owners often use commitment tracking with cost codes. Contractors also use job costing to collect delivery costs against each project.
These methods can operate together within the same reporting process:
For example, an owner records an excavation contract as a commitment and assigns it to a siteworks cost code. The contractor's job-cost records collect the labor, equipment and other costs of delivering that excavation work. Comparing those costs with the volume excavated gives a unit cost, which helps explain changes in production costs.
The project manager usually coordinates cost tracking, while delivery teams and finance supply and verify the underlying records. The owner establishes reporting requirements and delegates spending authority.
Each role contributes a different part of the financial picture:
Maintaining a cost record does not automatically give someone authority to approve additional spending. A project manager may record an expected change while its approval remains with the owner.
A construction cost tracker should show the approved budget, commitments, payment status and forecast final cost for each budget category. Linked contract and change records provide the detail behind those totals.
A contract, invoice and payment can relate to the same work. Separate fields show how much is committed, incurred, approved and paid:
Track construction project costs by linking commitments, changes and payments to the approved budget as they arise. Reconcile those records with finance, then use them to reassess the cost of completing the project.

Enter the approved project budget and divide it into categories that reflect the project's scope. Those categories should also cover early expenses, such as feasibility studies and initial consultant appointments.
Set up the following before the team begins entering records:
Record each contract or binding purchase order at its full value when awarded, so the commitment appears before invoicing. Link it to the agreed scope, supplier, approval and budget code.
The contract replaces the earlier forecast allowance for the scope it covers. Check that scope before removing the allowance, since delivery, installation or commissioning may still require separate funding. Retain estimates for excluded work and update the completion forecast to reflect any difference between the allowance and agreed price.
For an owner's building contract, the agreed price already includes the contractor's underlying resource costs. Adding those labor and material costs again would overstate the owner's total.
Enter a change when the potential cost is identified, then update its status as it is assessed and approved. This keeps expected additional costs visible while the parties work through scope and pricing.
Maintain the following information as each change develops:
Record each invoice or payment application against its contract and check it against the assessed work or deliveries. Update the approved amount after assessment, then record the payment date and amount when finance confirms payment. Keep any retainage visible against the same contract so the unpaid obligation remains traceable.
For directly managed construction, record daily labor hours, material deliveries and equipment usage against the relevant activity. These records provide evidence for checking charges when invoices arrive. Separate quantities from rates so the team can see whether a higher charge reflects additional resources or a price increase.
Reconcile the project cost report with finance's records to identify missing entries and explain differences. Some discrepancies affect payment status, while others change the expected final cost.
Compare both sets of records using the same reporting cutoff, then resolve differences by type:
In our school capital program, I reconcile project managers' reports with the payment records supplied by finance. The finance records arrive at month-end, and project reports follow by the third business day of the next month.
Update the construction cost forecast using full commitments and the expected costs outside those commitments. These additional costs include unprocured work, assessed pending changes and remaining risks.
Check what has changed since the last report and what that means for the owner:
I treat a missing forecast as a warning sign because payment records alone cannot show the cost of completion.
A construction cost tracker shows the approved budget, commitments, payments and completion forecast for each cost category. The community centre example below also breaks larger categories into individual work packages.

The $10.04 million forecast is $160,000 below budget, although construction is forecast $35,000 over its allocation. Uncommitted work is included, and payments are already counted within commitments.
Track costs across multiple construction projects by bringing their cost reports into one portfolio view. Use that view to identify projects needing attention and assess how funding decisions affect the wider program.
Bring project reports for the same reporting period into one summary, with a row for each project. Show the approved budget, forecast final cost, budget variance, payments and remaining contingency.
In our program, head office controls the budget structure. Consistent categories allow us to compare project figures before combining them.
Compare each project's forecast with its budget and previous report. Flag increasing costs, unresolved variations and contingency that may be insufficient for the remaining risks.
Consider the project's stage when interpreting those flags. Early design estimates carry more pricing uncertainty than costs supported by awarded contracts.
Add the project forecasts and compare the total with approved funding for the same projects. Retain individual project variances alongside the total, since an overall surplus can conceal a project funding gap.
Then combine expected payments by month. Several projects can reach major payment milestones together, creating a concentrated cash requirement even when each remains within budget.
For projects needing additional funds, show where the money would come from and how other planned work would be affected. Check funding restrictions and approval requirements before proposing a transfer.
Our schools have ten-year plans linked to campus master plans. Extra spending on one project can reduce funding for later work, so school leaders are involved in those decisions.
Record approved transfers and any resulting changes to scope, budgets or forecasts in the affected project reports. Those updates then become the basis for the next portfolio review.
💡 Pro Tip: Use capital program management software to connect the portfolio summary to each project’s cost records. This keeps the combined view aligned with updates to project commitments and forecasts.

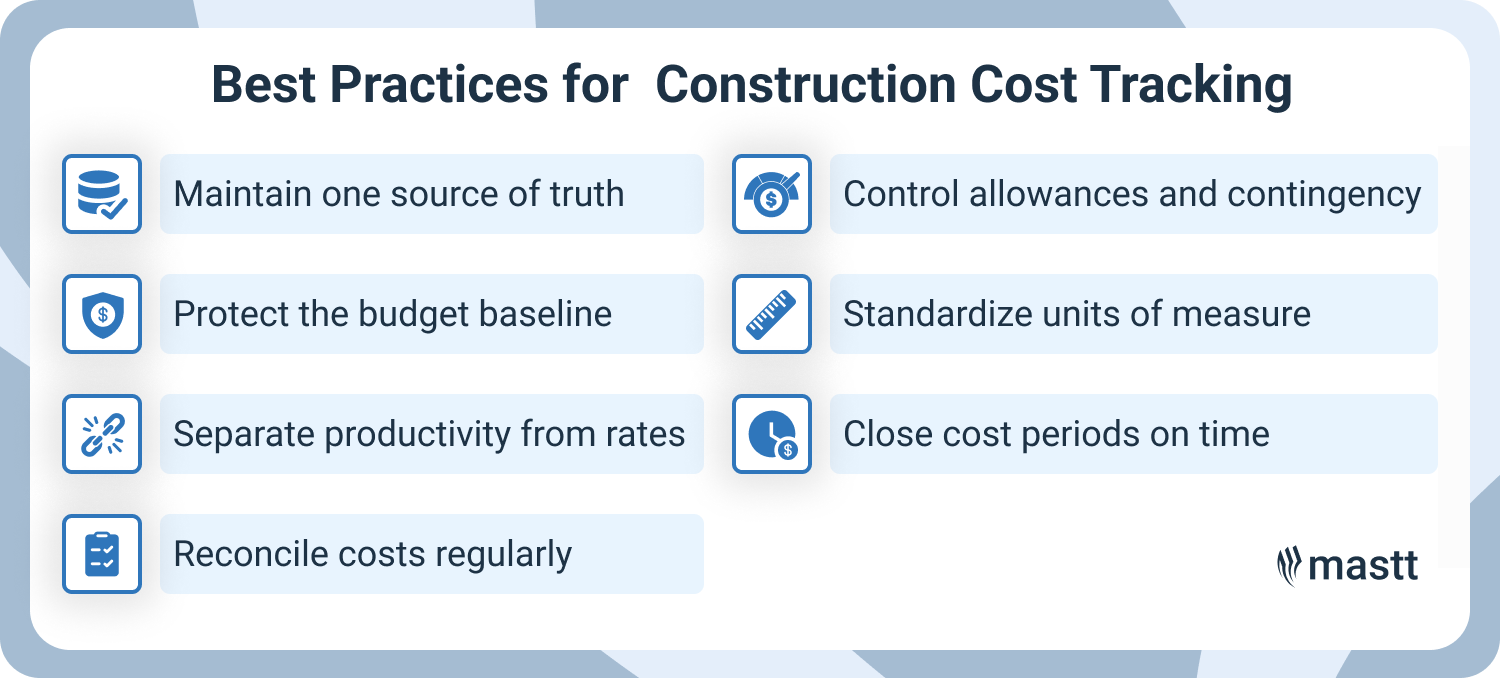

Accurate cost tracking depends on traceable records, consistent reporting rules and clear spending authority. These practices support construction budget control as contracts, forecasts and funding decisions change.
Preserve the original budget and each approved revision
Keep the original budget alongside the current approved budget, with the authority and date for each adjustment. The history should show whether an adjustment adds funding or reallocates the existing budget.
Compare the forecast with both the current budget and the previous report. An increase in approved funding can remove a reported deficit while the expected cost remains unchanged. Showing the forecast movement separately preserves that distinction.
Keep approval limits current as contingency falls
Check the applicable authority before approving a change or transferring funds. The person authorized to approve the work may differ from the person authorized to release contingency.
In our program, project managers' approval limits are based on a percentage of remaining contingency. As the reserve falls, more variations require approval from school leaders or head office.
Assess the combined effect of small changes
Once a project draws on construction contingency, I look more closely at the combined value of its variations. Several modest approvals can consume funding needed for a larger unresolved issue. I consider that total alongside the risks still outstanding before assessing whether the remaining reserve is sufficient.
Grouping changes by cause helps with that assessment. For example, repeated design changes may point to unresolved details that could generate further costs. Review those details with the design team when updating the risk allowance.
Escalate decisions before the next reporting deadline
Agree which events require immediate attention, including forecast overruns, unexpected commitments and changes beyond delegated authority. A monthly reporting cycle should not delay a decision needed before work is instructed.
For an unresolved discrepancy, identify the amount, the person investigating it and the possible effect on the forecast. This gives the owner a clear view of the uncertainty before further spending is considered.
Keep supporting records accessible when figures change
Retain the contract, assessment and approval behind each change in value or status. A reviewer should be able to follow a pending estimate into an approved commitment and then into payment records.
If the team uses a spreadsheet, maintain one shared working file and protect its calculation cells. Save each issued report separately so later updates do not erase the figures used for earlier decisions.
Construction cost tracking uses spreadsheets, field records, accounting systems and dedicated cost-management software. Field records describe the work performed, while accounting records show invoices and payments. Project reports combine these with commitments and forecasts.
The main tools support different parts of that process:
Start with a construction cost tracker template to track your budget, commitments, payments and forecast. When you need to coordinate updates across teams and projects, Mastt’s cost management software connects those records and gives you visibility across the portfolio.
A construction project cost tracker should show what is committed, what remains unpaid and whether the budget will cover completion. Keep contracts, variations and remaining cost estimates current so the owner can assess further spending against the project’s full obligations.
