Lien Waiver: Definitive Guide for Construction Projects

A lien waiver is a legal document that shows payment was made and lien rights are waived. Learn the rules, types, and how to use lien waivers properly.

Popular

Free Lien Waiver Form. 4 x Ready to use Microsoft Word forms for construction Lien Waivers.

Lien Waiver
Back to top

A lien waiver is a document used in construction to confirm payment and waive the right to file a mechanics lien. Once signed, it serves as proof that payment was made and that the paid party won’t file a lien for that amount.

Project managers, owners, and contractors rely on lien waivers to avoid double payments, reduce legal risks, and keep financing and progress on track. Let’s talk about what lien waivers are, the different types, when to use them, how to fill them out, and what to watch out for.

TL;DR
A lien waiver confirms payment and waives lien rights, protecting owners, contractors, and lenders. It is a legal tool that prevents double payment and disputes. If you manage or fund construction projects, understanding how lien waivers work is critical to getting paid and staying protected.

What is a Construction Lien Waiver

A lien waiver is a legal document used in construction to give up the right to file a mechanics lien after receiving payment. It confirms that payment was made and that the paid party, usually a contractor, subcontractor, or supplier, won’t make a lien claim for that amount.

The purpose of a lien waiver is to reduce the risk of duplicate claims and protect the project from legal complications. It serves as written proof that the payment process is moving forward as expected.

Lien waivers are a standard part of the pay application cycle. They’re exchanged during progress payments, final billing, and sometimes before funds are released.

Lien Waivers vs. Lien Releases

A lien waiver is signed before a mechanics’ lien is filed. It gives up the right to file a lien in exchange for payment. A lien release form is used after a lien has already been filed. It formally removes the lien from the property record.

Both are legal documents, but they serve different purposes in the payment process.

Feature Lien Waiver Lien Release
When It is Used Before a lien is filed After a lien has been filed
What It Does Waives the right to file a lien Removes an existing lien from the property
Purpose To secure payment and reduce lien risk To clear title or resolve a filed lien
Common In Routine payment processes (e.g. progress billing) Dispute resolution or lien payoff situations
Filed With County No Usually, yes
Triggers Payment is issued or expected Lien has been recorded and must be lifted

Example: A subcontractor submits a lien waiver with their pay app to confirm they won’t file a lien once they’re paid. Months later, a supplier who wasn’t paid files a mechanics lien.

Once that lien is settled, the supplier signs a lien release to formally remove it from the public record. The waiver prevents a lien. The release clears one already in place.

4 Types of Lien Waivers in Construction

There are four standard types, and they fall into two categories: conditional and unconditional, applied to either progress payments or final payments.

1. Conditional Waiver on Progress Payment

Use this when payment has been requested but not received yet. It applies to partial or milestone payments made during the project.

The conditional waiver on progress payment only becomes effective once the payment clears. This protects subcontractors and suppliers from giving up lien rights before funds actually arrive. It’s often used at standard billing intervals, for example, after pouring a slab or framing is complete.

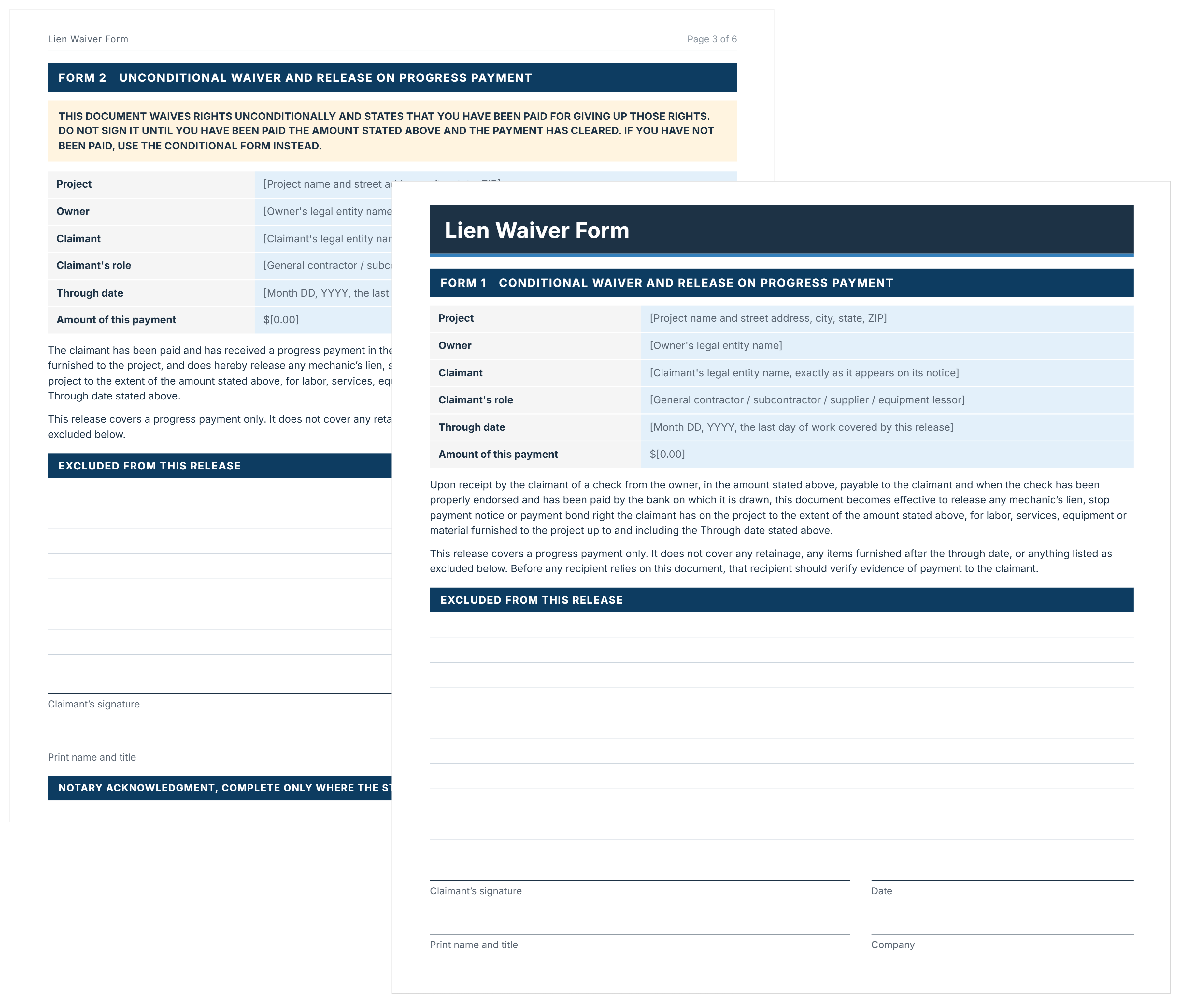

Legal form titled “Conditional Waiver and Release on Progress Payment,” with sections for identifying information, check details, exceptions, and signature.
Example of a Conditional Waiver on Progress Payment. Protects your lien rights while payment is still in transit.

2. Unconditional Waiver on Progress Payment

Use this only after a progress payment has been received and confirmed. Unconditional waiver waives lien rights immediately for the work or materials covered in that payment.

There are no conditions when it comes to unconditional waivers on progress payments. Once signed, rights are gone, even if the payment later bounces. It’s efficient but risky if issued too early.

Legal form titled “Unconditional Waiver and Release on Progress Payment,” including sections for claimant and project details, check amount, exceptions, and signature.
Example of an Unconditional Waiver on Progress Payment. Use only after full payment has been received and cleared.

3. Conditional Waiver on Final Payment

Use this at project close-out when submitting a final invoice, and payment is still pending. It protects against losing lien rights before the last payment clears. This is commonly used when handing over punch list completion, warranty documents, or final deliverables.

Legal form titled “Conditional Waiver and Release on Final Payment,” showing claimant and project details, payment conditions, disputed amounts, and fields for signature and notarization.
Example of a Conditional Waiver on Final Payment. Keeps your rights intact until final payment clears.

4. Unconditional Waiver on Final Payment

Use this only when the final payment has been fully received, processed, and cleared. It immediately waives all lien rights on the project. It’s the highest-risk document for contractors and subs if used too early.

Mistakes on final payments' unconditional waiver are hard to fix. Once signed, the lien rights are gone, even if the payment fails later.

Legal form titled “Unconditional Waiver and Release on Final Payment,” outlining claimant and project information, disputed claims section, and areas for signature and notarization.
Example of an Unconditional Waiver on Final Payment. Confirms that the job is complete and fully paid.

Why are Lien Waivers Necessary?

Lien waivers are required to prevent lien claims after payment is made. They protect owners, contractors, lenders, and anyone responsible for funding a project.

Without lien waivers, subcontractors or suppliers can still file a mechanics lien, even if they’ve already been paid.

  • Prevent mechanics liens from subcontractors and suppliers: A signed waiver proves that payment was received and lien rights for that work have been waived.
  • Ensure clean title for financing or property sale: Lenders and buyers need confirmation that no one can later claim unpaid work on the property.
  • Protect project owners from double payment: Owners avoid paying twice when waivers confirm that subs and suppliers have already been paid.
  • Maintain lender confidence during construction draws: Lenders use waivers to verify that previous payments reached the right parties before approving more funds.
  • Encourage payment transparency and accountability: Waivers create a paper trail that shows who got paid, when, and for what scope of work.

Lien waivers help document who’s been paid, how much, and for what work. This minimizes the chance of miscommunication or claims down the line.

Who Needs to Use Lien Waivers?

Anyone involved in construction payments needs to use lien waivers. They’re part of every payment exchange, from top to bottom of the project chain. Each party has a specific role in requesting, issuing, or verifying them.

Here’s who typically uses lien waivers in the construction industry:

  • Project owners require signed waivers before releasing payment to ensure no future lien claims.
  • General contractors collect waivers from subcontractors and suppliers and submit their own to owners or lenders.
  • Subcontractors/suppliers must complete and sign lien waivers to receive payment for their work or materials.
  • Lenders/title companies review lien waivers as part of the draw process to confirm the project has no outstanding claims.
📌 Everyone involved in the construction payment chain relies on lien waivers for protection. Missing just one waiver, especially from a lower-tier subcontractor, can open the door to lien exposure and project delays.

How Lien Waivers Fit into Construction Pay Applications

Lien waivers are a core requirement in every construction pay application. In AIA billing workflows, lien waivers are frequently submitted alongside the G702/G703 package.

A complete pay application often includes:

  • Cover sheet (e.g. AIA G702) which summarizes the payment request and application status.
  • Schedule of Values (e.g. AIA G703) that breaks down the contract value and progress to date.
  • Lien waivers signed by the contractor and subs to show that lien rights are waived for the covered work.
  • Payment certificates issued by the architect, consultant, or owner's rep to approve payment.

Because lien rights are tied to payment, the timing of each waiver is essential. Because each progress payment is tied to a formal request for funds, owners and lenders often require conditional lien waivers before releasing payment and unconditional waivers afterward as confirmation.

Here’s how lien waivers typically fit into the payment flow on a construction project:

  1. The contractor submits the pay application, along with conditional lien waivers from themselves and all lower-tier subcontractors and suppliers.
  2. The owner or lender reviews the package and, if everything checks out, releases payment.
  3. Once payment clears, the contractor provides unconditional lien waivers to confirm that the money was received and lien rights are officially waived.

Essential Elements to Include in a Lien Waiver

Every lien waiver must clearly show who is getting paid, for what, and what rights are being waived. Incomplete or vague waivers can be challenged, or worse, open the door to payment disputes or invalidation.

Here's what to include in a lien waiver to protect your position:

  • Project Name and Location: List the full legal project name and jobsite address. This avoids confusion, especially on portfolios with multiple active jobs.
  • Contractor/Subcontractor Name: Use the full legal entity name of the company waiving lien rights, not a trade name or nickname. This ensures the waiver is enforceable and tied to the correct contract.
  • Payor (General Contractor or Owner): Identify who is issuing the payment. This helps clarify the relationship and obligation, especially if there are layered payment structures or multiple funding sources.
  • Payment Amount and Covered Date Range: Be precise. Include the dollar amount covered and the “through date” indicating how far along the work is paid. This is one of the most commonly disputed details if it’s left blank or too general.
  • Type of Waiver: State the waiver type explicitly. Conditional waivers protect you if payment hasn’t cleared. Unconditional waivers waive rights immediately, so timing must match.
  • Signatory Name, Title, Signature, and Date: The person signing must have the authority to bind the company. They can be a principal, a project manager, or a project owner. Include their name, title, and signature date. Without this, the waiver may not hold up.
  • Notary Section (optional): A few states require notarization. In others, it’s not required, but some owners or lenders may still ask for it. Check both state law and contract terms.

Key Considerations When Signing a Lien Waiver

Signing a lien waiver transfers legal rights, sometimes more than you intend. It can impact your ability to recover payment, pursue change orders, or file claims.

So, reviewing a waiver carefully before signing is essential to protect your position and avoid costly mistakes. These are the areas that require close attention before signing any lien waiver:

1. Understand What You're Giving Up

Some lien waivers include language that goes beyond just lien rights. You might be waiving the ability to pursue unpaid change orders, delay damages, or other unresolved claims.

Always match the waiver’s language to what you’ve been paid for. If the scope is unclear or too broad, revise it or ask for clarification before signing.

2. Look for Hidden Risk in Indemnity Clauses

Indemnification clauses buried in a waiver can shift liability onto you for issues you didn’t cause. For example, a broadly worded clause could hold you responsible for defects or delays outside your scope. Lien waivers should only waive lien rights and nothing more.

3. Use the Correct Lien Waiver Form for Your State

In states like California, Texas, Nevada, and Florida, lien waivers must follow strict statutory language. Even small edits can make the waiver invalid, or worse, waive more rights than intended.

Always confirm you’re using the required lien waiver form if state law applies. If you’re unsure, consult legal or compliance resources before signing.

4. Confirm That Payment Has Been Received and Cleared

Never sign an unconditional waiver unless the money is in your account and fully processed. Doing so waives lien rights immediately, even if the payment later fails.

If funds haven’t cleared, use a conditional waiver instead. Don’t take the risk. Waiver timing matters.

A bad waiver can cost you more than a missed payment. It can eliminate your ability to recover it. Treat each one like a legal contract, not just a form. If it seems off, slow down and get it right.

State-by-State Lien Waiver Requirements

Construction law is local. Each state sets its own requirements for how lien rights are preserved, waived, or released. A waiver that’s valid in one state may be unenforceable in another. That means the lien waiver used on a project in New York might be invalid on a job in California. Always check the jurisdiction before using a lien waiver form.

Category Statutory Form States Flexible Form States
Examples California, Texas, Georgia, Nevada Florida, New York, Illinois, Washington
Form Requirement Must use exact statutory forms with prescribed language, structure, and layout No mandated form—custom formats are allowed
Modifications Allowed Not allowed. Even small changes can void the waiver Allowed, but risky if language is unclear or overly broad
Waiver Types Defined by Law Yes. Law defines when to use conditional/unconditional, progress/final waivers No. Waiver use and structure is contract-dependent
Legal Risk if Done Wrong High—incorrect forms may be unenforceable or expose the project to lien claims Medium—poorly written forms may waive more rights than intended
Common Practice Use state-issued waiver templates without edits Use negotiated or standardized forms for consistency

Common Mistakes When Handling Lien Waiver (and How to Avoid Them)

Lien waivers can either protect your project or cause serious financial risk. Most waiver issues stem from misalignment between payment timing, waiver content, and documentation processes.

Below are the most common mistakes made by both owners and contractors, and practical ways to prevent them.

For Project Owners & Project Managers

Owners and managers often focus on tracking dollars, but overlooking waiver accuracy can leave a project vulnerable to claims, even when payments were made.

Releasing Payment Without Collecting Lien Waivers

Paying a GC before receiving all lien waivers, especially from lower-tier parties, creates exposure to mechanics liens.

Solution: Make lien waiver collection a hard precondition to payment. Require a full set of signed waivers with each draw request, not just from the GC.

Accepting Unconditional Waivers Before Confirming Payment Cleared

Once signed, an unconditional waiver is binding, even if the payment fails. This puts the payor in a vulnerable spot.

Solution: Use conditional waivers during the approval process. Only accept unconditional waivers after the contractor confirms cleared funds.

Failing to Gather Waivers From Lower-Tier Subs and Suppliers

Even if your GC signs a waiver, any unpaid supplier or second-tier sub can still lien the job if they’re not included.

Solution: Require visibility into the full payment chain. Mandate tiered waiver collection and submission with every application for payment.

Using Outdated or Non-Compliant Forms

Using modified forms or incorrect formats in states with statutory waiver language can void the waiver.

Solution: Know your jurisdiction. In statutory states like CA, TX, and NV, use state-issued waiver templates without edits.

Overlooking the “Through Date” (Coverage Period)

If this field is missing or inaccurate, a waiver may not fully release lien rights for work already performed, leaving gaps in protection.

Solution: Cross-reference the waiver’s “through date” with the schedule of values and payment application to confirm alignment.

Not Storing or Tracking Waivers Systematically

Even signed waivers lose value if you can’t find them during an audit, dispute, or draw review.

Solution: Implement a waiver log. Use project management software or a shared document repository to organize waivers by billing cycle and tier.

For Contractors and Subcontractors

The biggest risk for contractors is unintentionally giving up lien rights, including for unpaid or disputed work.

Signing Unconditional Waivers Too Early

You permanently waive lien rights the moment you sign, regardless of whether payment actually lands in your account.

Solution: Do not sign unconditional waivers until you verify that payment has cleared. Until then, use conditional waivers to retain your rights.

Submitting Incomplete or Inaccurate Waivers

Leaving out payment amounts, through dates, or job details can make a waiver ambiguous or unusable.

Solution: Build a waiver checklist into your pay app process. Assign someone to verify all fields before submission.

Using the Wrong Waiver Type or Language

A common mistake is submitting a final waiver on a progress payment or signing a document that releases more than intended.

Solution: Match the waiver type to both payment timing and project status. If in doubt, consult legal or use a standard waiver from a trusted source.

Failing to Keep Records of Submitted Waivers

Without a documented waiver history, contractors lose leverage in closeout or dispute resolution.

Solution: Keep digital copies of every waiver submitted. Make sure it’s organized by project, billing period, and payor. Store these alongside the corresponding pay apps.

Waiving More Than Intended (e.g., Future Work or Retainage)

Some waiver forms include boilerplate language that accidentally releases rights tied to unpaid work, pending change orders, or withheld retainage.

Solution: Read every line. Strike or modify any language that waives claims not tied to the current payment. Always limit waivers to the specific dollar amount, scope, and timeframe already paid.

Final Thoughts on Construction Lien Waiver

Lien waivers may seem routine, but they carry real legal and financial weight on every construction project. Whether you’re paying or getting paid, how you handle these documents affects everything, from draw approvals to final closeout.

Use the correct form. Match the waiver to the payment status. Track every signature. And when in doubt, slow down and double-check. Getting lien waivers means building a reliable, transparent payment process that protects all parties and keeps projects moving.

FAQs About Construction Lien Waivers

Generally, no. Once a lien waiver is signed, it is legally binding and cannot be undone. Always verify payment has cleared before signing to avoid unintended consequences.
It shouldn't. A proper lien waiver only applies to work or materials already completed and paid for. Waivers that release rights for future work can create legal and payment issues.
In most jurisdictions, electronic signatures on lien waivers are legally enforceable, provided they comply with applicable electronic transaction laws. However, some states may have specific requirements, so it's essential to verify local regulations.
Most construction lien waivers do not need notarization. Plain or digital signatures usually meet payment rules in most regions. Your contract or local law may still demand a notary seal. Adding a seal where law bars it can void the lien waiver. Check those rules before signing to protect mechanics lien rights for owners and contractors.
