What is a Construction Traffic Management Plan?
A construction traffic management plan is a regulatory document outlining how traffic will be managed during building works. It addresses vehicle movements, pedestrian safety, and road network impacts throughout construction phases from demolition through to completion.
CTMPs are mandatory for most Development Applications in Sydney and across NSW councils. They demonstrate how builders will minimise disruption to surrounding roads, footpaths, and public transport. The plan becomes a contractually binding document once council approves your DA submission.
Transport for NSW and local councils require these plans before issuing Construction Certificates. Without an approved CTMP, projects cannot legally commence. The document protects workers, pedestrians, and motorists while ensuring construction proceeds efficiently.
What's Included in a CTMP?
The CTMP contains technical and operational details demonstrating safe traffic management throughout all construction stages. It provides councils with evidence that vehicle movements, pedestrian access, and road impacts have been properly assessed and mitigated.
Typical components of a construction management plan include:
- Project identification details: Development address, DA number, principal contractor details, project duration, and construction hours.
- Site location analysis: Existing road network conditions, traffic volumes, pedestrian flows, cyclist routes, and public transport services.
- Construction methodology: Work staging sequences, demolition activities, excavation phases, and building erection timelines affecting traffic patterns.
- Vehicle movement plan: Delivery schedules, truck types and frequencies, haulage routes, site access points, and egress arrangements.
- Swept path analysis: Technical diagrams showing construction vehicles can safely enter, manoeuvre within, and exit the site boundaries.
- Pedestrian management measures: Footpath diversions, temporary walkways, protective hoarding, construction signage, and safe crossing points near the worksite.
- Traffic control arrangements: Works zones, road closures, detours, Traffic Guidance Schemes (TGS), and temporary traffic signal modifications.
- Parking management strategy: Construction worker parking locations, visitor provisions, and impacts on existing on-street parking availability.
- Traffic staging plans: Functional Layout Plans (FLPs) showing site configurations for each major construction phase with control measure locations.
- Road safety audit: Independent assessment identifying potential hazards and recommending additional safety treatments where risks remain elevated.
- Emergency access provisions: Maintaining ambulance, fire brigade, and police access throughout construction despite temporary road modifications.
💡 Pro Tip: Include photographs of the existing site showing current traffic conditions. Councils process applications faster when they can visualise how your proposed controls fit the actual street environment.

How to Use This Construction Traffic Management Plan Template
Fill in section 3 before anything else, because the approving authority, the roads authority, the temporary traffic management document and the accreditation your traffic control plan preparer needs all differ by state. Then read the consent condition itself, since what a CTMP must contain is set by the individual authority.
The template is filled in for a worked example. Replace every entry and delete the banner before you issue it.
- Complete section 3 using the state table, recording the version of the traffic management document you are working to and the date you checked it was current.
- Fill in section 1 with the project, the consent condition this plan discharges, who approves it, and the accreditation held by whoever prepared it.

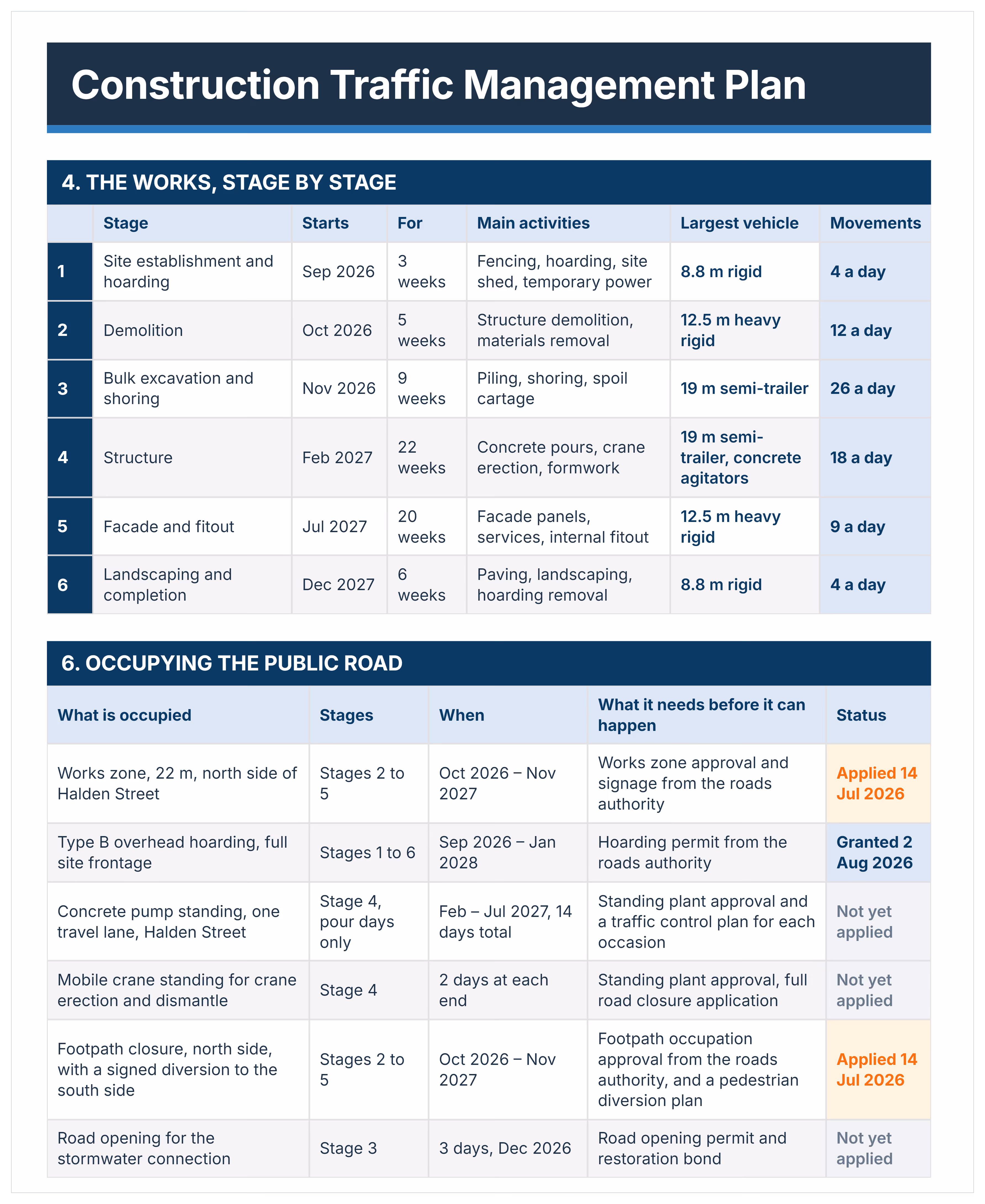

- Break the works into stages in section 4, one row each, since the largest vehicle and the movement count change between them.
- Set the approved routes in and out, the entry point, and whether vehicles can leave in a forward direction at every stage.
- List every part of the public road you will occupy in section 6, with the approval each one needs and its current status.
- Record every approval in section 7 the day you identify it rather than the day you apply, because each carries its own lead time.
- Reference your traffic guidance schemes in section 8 without drawing them into this document, as they are prepared and signed separately by the accredited person.
- Complete section 9 for everyone affected, including pedestrians with reduced mobility, cyclists, emergency services and any school on the route.
- Fill in section 10 for people and plant inside the fence, which stays on site rather than going to the authority.
Sections 1 to 9 and 11 go to the authority. Section 10 stays on site as part of your work health and safety management plan. Reissue the whole plan on any trigger in section 12, not a single page, and send it back to whoever approved the part that changed.
Why Construction Sites Need Traffic Management Plans
Construction activities inevitably disrupt normal traffic patterns, creating safety risks that require formal management strategies. A well-prepared CTMP protects everyone while ensuring regulatory compliance and avoiding costly delays in project approvals.
Traffic management planning delivers measurable benefits like:
- Council approval certainty: Satisfying DA conditions prevents planning refusals and eliminates resubmission cycles that delay Construction Certificate issue.
- Safety compliance: Meeting Work Health and Safety Regulation 2017 obligations protects workers and public from vehicle interaction incidents.
- Penalty avoidance: Preventing fines from Transport for NSW or council inspectors who find non-compliant traffic arrangements on site.
- Neighbour relations: Demonstrating consideration for local residents reduces complaints about construction vehicle movements and access disruptions.
- Delivery coordination: Structured scheduling prevents multiple trucks arriving simultaneously, eliminating road blockages and traffic congestion problems.
- Legal defensibility: Documented traffic management provides evidence of due diligence if incidents occur despite control measures being implemented.
- Subcontractor clarity: All trades understand access arrangements, parking locations, and delivery procedures before mobilising to the worksite.
- Emergency preparedness: Pre-planned emergency vehicle access prevents critical delays when ambulances or fire services need site entry.
- Cost predictability: Avoiding traffic management penalties and resubmission fees keeps projects within budget during planning and construction phases.
- Stakeholder confidence: Professional CTMP documentation demonstrates project management competence to lenders, insurers, and joint venture partners.
For example, sites without proper traffic management create street blockages triggering council enforcement action and work stoppages. A well-prepared CTMP prevents these disruptions. It coordinates deliveries, protects pedestrians, and maintains public road access throughout construction.
How to Develop a Construction Traffic Management Plan
Developing a construction traffic management plan requires systematic analysis of site conditions, construction methodology, and regulatory requirements. The process combines technical engineering with practical construction logistics across multiple assessment stages.
Follow these steps to prepare council-compliant CTMPs:
- Review DA conditions: Examine planning approval carefully for specific CTMP requirements including council standards, TfNSW guidelines, and submission deadlines.
- Conduct site inspection: Visit the location during peak traffic hours to observe existing vehicle volumes, pedestrian movements, and parking utilisation patterns.
- Define construction methodology: Document work staging sequences, vehicle types required, delivery frequencies, and maximum truck dimensions entering the site.
- Develop haulage routes: Map approved heavy vehicle routes from arterial roads to the site, avoiding local streets, schools, and residential areas.
- Prepare swept path analysis: Model construction vehicles navigating site entry, internal circulation, and exit movements using AutoTURN or similar software.
- Design pedestrian treatments: Plan footpath diversions, temporary walkways, protective hoarding, and safe crossing points maintaining accessibility standards.
- Create traffic staging plans: Develop FLPs and TGS following Australian Standard AS 1742.3 requirements.
- Conduct road safety audit: Engage independent auditor to review plans and identify hazards requiring additional mitigation before council submission.
- Submit and refine: Lodge CTMP with assigned planner, respond to council feedback, and revise documentation until formal approval is granted.
💡 Pro Tip: Request a pre-lodgement meeting with council's traffic engineer before formal CTMP submission. A 30-minute discussion often identifies issues that would otherwise require full resubmission cycles.

👉 Try Mastt AI today and generate your construction traffic management plan ready for traffic engineer review and council submission.
