Stakeholder Management Plan Template for Construction

Enter your email below to download the file.

By downloading, you agree to receive marketing emails from Mastt. Unsubscribe anytime.

Oops! Something went wrong while submitting the form.
Free Template

Stakeholder Management Plan Template for Construction

Free stakeholder management plan template in Excel. Score influence and interest, plan engagement, and record every promise you make in one workbook.

Templates
Word Template
Excel Template
Powerpoint Template
Stakeholder Management Plan Template for Construction
Template by
Jackson Row
Published:
Oct 15, 2025
Updated:
August 20, 2026

What is a Stakeholder Management Plan for Construction Projects?

A stakeholder management plan sets out who can affect a project, how much influence and interest each of them has, what you will promise them, and how you will keep track of what was said. It is a working register rather than a one-off document, updated through delivery as relationships shift.

On construction projects, the stakeholder list looks different from other sectors. Approval authorities, roads authorities, utility operators and regulators sit alongside residents, traders and landowners who never signed anything but live next to the site. Consent conditions turn some engagement into a legal obligation, and promises made in consultation become commitments the project has to discharge and evidence later. A plan that only lists names and contact details cannot carry any of that.

What's Included in This Stakeholder Management Plan Template

Sheet What it holds
Setup Project, the data date everything is measured against, and the two thresholds that decide what counts as high influence and high interest.
Register One row per group or organization: category, what it affects, influence and interest scored 1 to 5, priority, where they are now, where you need them, the gap, who owns the relationship and how sensitive the row is.
Matrix The register drawn as an influence and interest grid, which redraws itself when scores or thresholds change.
Engagement Plan What you promise each stakeholder, how, who leads it, how often, and when the next contact is due.
Commitments Every promise made, where it came from, what secures it, who owns it, when it is due and what evidence discharges it.
Log What was raised, and how it was taken into account or why it was not.
Reference The color key and every dropdown source.

Two things are deliberate. There is no "last contacted" field to maintain, since last contact reads off the Log and the next due date calculates from it. And where they are now sits separately from where you need them, because the gap between the two is what engagement is for.

Stakeholder Management Plan vs Register, Matrix and Communications Plan

Four documents share the stakeholder label and only one is a plan. The rest are components of it or a separate output.

Document What it is Answers
Stakeholder management plan The parent document Who matters, what we owe them, what was said
Stakeholder register A scored list of stakeholders Who are they and how much do they matter?
Stakeholder matrix The register plotted on a grid Who gets the most attention?
Stakeholder analysis The assessment behind the scores Why did we score them that way?
Communications plan Messages, channels and frequency How do we talk to them?

The register and matrix are sheets in this plan, so filling one populates the other. For the list alone use the stakeholder register, for the grid alone the stakeholder matrix template, and for messaging the communications plan.

Stakeholder Management Plan Example

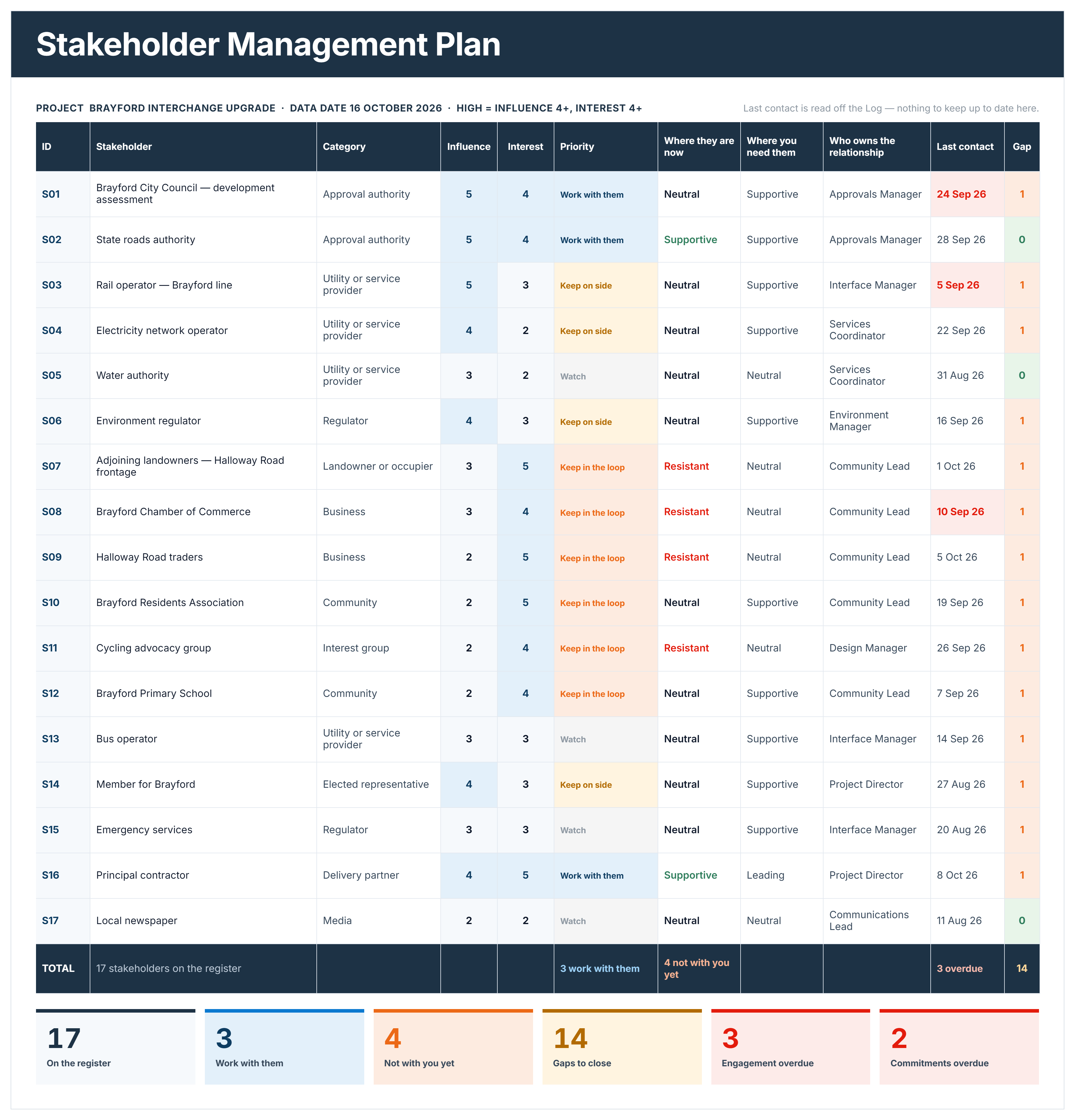

Here is a good example of a completed stakeholder management plan register, covering seventeen stakeholders on a road interchange upgrade.

Stakeholder management plan register example with influence, interest, priority, current and needed stance, owner and overdue contacts.
Stakeholder management plan example showing register with influence, interest and engagement gaps.

How to Write a Stakeholder Management Plan in Excel

Identify everyone who can affect the project or is affected by it, score their influence and interest, decide what you will promise each of them, then record every promise and every conversation. The template already has that structure, so most of the work is filling it in.

  1. Set the project, the data date and the two thresholds on Setup, since the matrix redraws from those numbers.
  2. List one row per group or organization on the Register rather than one per person, so the plan survives staff changes.
  3. Score influence and interest from 1 to 5, and let the priority and matrix position calculate.
  4. Set where each stakeholder is now and where you need them, so the gap is visible.
  5. Name one person who owns each relationship, since a stakeholder owned by the project team is owned by nobody.
  6. Record what you promise each stakeholder on the Engagement Plan, kept separate from how they currently feel about you.
  7. Set the contact cadence per stakeholder, and let the next due date work itself out from the log.
  8. Enter every promise on Commitments the moment it is made, with what secures it and what evidence will discharge it.
  9. Write the log entry the same day, recording what was raised and how it was taken into account.
  10. Read the Check columns, which name each problem in words rather than leaving you to spot it.

Set the data date to the date you are reporting rather than today. The whole workbook then reports as at that day, which is what makes a stakeholder position defensible three months later.

Tracking Stakeholder Commitments and Consent Conditions

A commitment is any promise the project has made to a stakeholder: no construction traffic on a street before a stated hour, two-way access maintained for traders, a noise limit, a tree retained. Most stakeholder templates have nowhere to record them. They arrive from three places, and only one is obvious:

  • Conditions of approval: Enforceable, and usually written down somewhere else as well.
  • Consultation: Somebody in a meeting agreed to something on the project's behalf.
  • Public statements: Made at an information session, in a newsletter or to media.

Always record what was committed, what secures it, who owns it, when it falls due and what evidence discharges it, then log how each request was taken into account, including where you said no and why. A commitment with no evidence attached cannot be proved, and a log with no refusals in it reads as consultation theatre.

Simplify Stakeholder Engagement Planning with Mastt

Whether you need a detailed stakeholder management plan template Word document for governance approval or dynamic Excel format for ongoing tracking, Mastt AI creates exactly what you need in seconds.

The platform understands construction industry stakeholder landscapes, automatically including relevant regulatory bodies, standard contractor relationships, and typical approval authorities.

Related Articles and Templates

Explore these resources for stakeholder analysis, engagement, communication, governance, and project alignment:

FAQs About Stakeholder Management Plans

On a scale, commonly 1 to 5, with influence measuring how much a stakeholder can affect the outcome and interest measuring how closely they are watching. Set the threshold for high explicitly rather than assuming it, since that line decides who lands in the top quadrants and gets the most attention.
One named person, usually a community or stakeholder lead on larger projects and the project manager on smaller ones. Individual relationships are owned by whoever is best placed to hold them, but the plan itself needs a single owner or it stops being updated.
The contact log is written the same day as any contact. The register is reviewed at each phase gate and whenever the stakeholder landscape changes, such as a new approval, a change in scope, or work moving to a new area. Commitments are updated the moment a promise is made.
The part of the plan that sets what you will do for each stakeholder: what you are promising them, who leads it, how often contact happens and when the next one is due. It is deliberately kept separate from how a stakeholder currently feels, because what you promise is an input and how they feel is the result.
Excel for the register, because it scores, sorts and filters, the matrix redraws from the scores, and the next contact date calculates from the log. Word suits the narrative sections of a broader engagement strategy, but the register behind it belongs in a spreadsheet.
Topic:
Stakeholder Management Plan Template for Construction

Written by

Jackson Row

Jackson Row is the Growth & North American Market Lead at Mastt. With a background in risk modeling, cost forecasting, and integrated project delivery, he helps capital project owners work smarter and faster. Jackson’s work supports better tools, better data, and better outcomes across the construction industry.

LinkedIn Icon
Back to top

Frequently Asked Questions

More Templates

Supercharging Construction Project Management with AI-Powered Tools
