What is a WHS Management Plan?
A WHS management plan is a written framework documenting how principal contractors manage health and safety for construction projects valued at $250,000 or more. The plan must be prepared before work commences and serves as the overarching safety management system integrating site-specific risks, responsibilities, procedures, and coordination arrangements.
This isn't a generic template copied from previous projects. Each WHS management system plan must reflect actual site conditions, specific hazards at that workplace, and unique construction activities. Your plan remains a living document throughout the project, getting reviewed and revised whenever risks change, new contractors arrive, or work methods evolve.
A WHS management plan differs from SWMS. SWMS address specific high-risk activities like excavation or working at heights. The management plan coordinates ALL safety aspects including SWMS collection, incident procedures, and consultation arrangements across your entire site.
Construction WHS Plan Key Components
A compliant WHS management plan template must contain specific mandatory elements under WHS Regulations 2011. Here's what construction documentation includes:
- Names, positions, and safety responsibilities: Document everyone with specific WHS duties, their contact details, and defined responsibilities for managing safety matters.
- Consultation, cooperation and coordination arrangements: Detail how you'll consult with workers and HSRs, and coordinate activities between multiple PCBUs on-site.
- WHS incident management procedures: Specify who contacts emergency services and SafeWork, response protocols, and incident scene preservation requirements.
- Site-specific health and safety rules: List PPE requirements, exclusion zones, permits, and how rules get communicated to everyone.
- SWMS collection and monitoring system: Describe how you obtain SWMS before high-risk work, review them, and monitor implementation.
- Project description and site details: Provide project scope, construction stages, site boundaries, and constraints affecting safety management.
- Hazard identification and risk assessment: Identify foreseeable hazards from construction methods, plant, materials, and interfaces between different contractors.
- Emergency response and rescue procedures: Detail evacuation procedures, assembly points, emergency contacts, and rescue equipment locations.
- Induction and training requirements: Specify white card requirements, site-specific induction content, and record-keeping systems.
- Welfare facilities and site amenities: Document toilets, drinking water, eating areas, first aid facilities, and amenities meeting regulatory requirements.
- Communication and reporting systems: Establish how safety information flows through toolbox talks, meetings, and incident reporting channels.
💡 Pro Tip: SafeWork inspectors look for evidence you're actually using your WHS management plan, not just that it exists. Document toolbox talks, safety meetings, and SWMS reviews referencing specific plan sections to prove it's a working document.

How to Use This WHS Management Plan Template

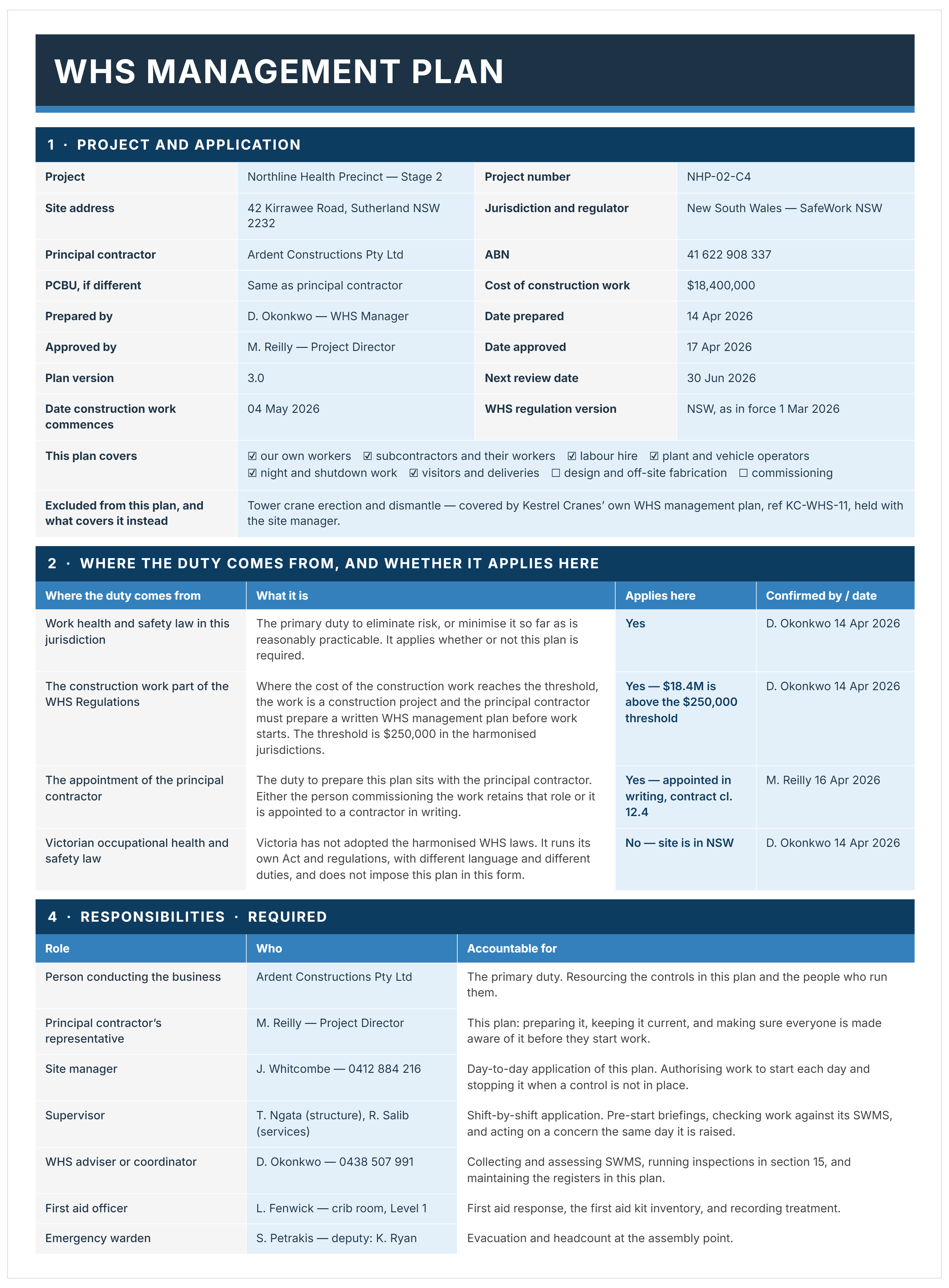

Complete section 2 first. It confirms which law applies at this site, whether the cost of the construction work crosses the threshold, and who holds the principal contractor duty. Everything else follows from those three answers.
The plan must exist in writing before construction work starts.
- Fill in section 1 with the project, jurisdiction, regulator and the cost of the construction work.
- Work through section 2 and date each confirmation, since Victoria has not adopted the harmonised laws.
- Get the principal contractor appointment in writing and reference it.
- Name a person against every role in section 4, and delete any role that does not exist here.
- Set the consultation arrangements, site rules and incident notifications in sections 5 to 7.
- Set the SWMS process in section 8: submission, assessment and briefing.
- Mark anything that does not apply rather than leaving it blank.
- Make every person aware of the plan before they start, and record it in the awareness register.
Why Construction Projects Need WHS Management Plans
A properly prepared construction WHS management plan ensures projects meet legal obligations whilst creating genuinely safer workplaces. The framework matters most when multiple persons conducting a business or undertaking (PCBUs) share WHS duties and coordination gaps create incident risks.
Here's why principal contractors need comprehensive safety management plans:
- Satisfies legal requirements: Meet mandatory WHS Regulations 2011 obligations before work starts, avoiding improvement notices and prosecution.
- Clarifies incident response: Everyone knows who contacts emergency services and SafeWork, plus scene preservation procedures when injuries occur.
- Coordinates multiple contractors: Document consultation between all PCBUs, clarify overlapping responsibilities, and prevent safety gaps.
- Integrates SWMS systematically: Create processes for collecting SWMS before high-risk work, reviewing adequacy, and monitoring implementation.
- Protects officers from liability: Demonstrate to SafeWork you took reasonably practicable steps, reducing personal exposure under WHS legislation.
- Documents worker consultation: Prove you consulted workers and health and safety representatives (HSRs), meeting legislative requirements and improving hazard identification.
- Prepares emergency responses: Establish tested procedures for medical emergencies, evacuations, and rescue operations reducing confusion when seconds matter.
- Addresses site-specific hazards: Control actual risks at your workplace including neighbouring properties, environmental factors, and project-specific challenges requiring tailored measures.
- Enables continuous improvement: Review safety performance, learn from near misses, and implement improvements throughout project life cycles.
Comprehensive plans transform tick-box compliance into genuine construction risk management preventing incidents before SafeWork investigators arrive asking why controls failed.
When to Prepare a Work Health and Safety Management Plan
A WHS management plan must be prepared before work commences and reviewed throughout the project.
- Before project mobilisation: Prepare comprehensive plans before any construction work starts, ensuring all safety arrangements are documented and communicated.
- After contractor appointments: Update plans whenever new subcontractors join projects, documenting their responsibilities and coordination arrangements.
- When scope changes significantly: Revise plans when approved variations introduce new hazards, change work methods, or alter site conditions.
- Following incident investigations: Review and update plans immediately after notifiable incidents, incorporating lessons learned and improved control measures.
- During construction phase transitions: Update plans when moving between major phases like earthworks to structural work, addressing new hazards.
- When site conditions change: Revise plans if weather events, neighbouring activities, or discovered conditions introduce unexpected risks requiring management.
- After regulatory inspections: Incorporate improvement notice requirements and SafeWork recommendations into revised plan versions.
- At regular review intervals: Schedule quarterly reviews ensuring plans remain current even when no specific triggers occur.
💡 Pro Tip: Schedule reviews every 90 days minimum even without specific triggers. Construction projects evolve constantly, and quarterly reviews catch risk creep before hazards become incidents that SafeWork investigates.

👉 Create your WHS management plan with Mastt AI today and build construction safety programs that protect workers whilst satisfying regulatory obligations.
