A basis of estimate is the written explanation behind a construction cost estimate. It lays out the scope, data sources, assumptions, and reasoning used to build the numbers. In short, the BoE shows how the estimate was created and why the costs make sense.
In this article, you’ll learn what a BoE includes and why it matters for construction estimating. You’ll also see how to write one and how different teams use it to review scope and cost decisions.
What is a Basis of Estimate (BoE) in Construction?
A basis of estimate (BoE) is the written record that explains how a project estimate was built. It outlines the data, methods, assumptions, and calculations used during construction estimating. This helps anyone reviewing the numbers understand where they came from and why they are reliable.
A BoE usually covers the project scope, the estimating approach, the pricing basis for labor and materials, and any limits or conditions that shaped the work. It also documents what was included, what was left out, and why certain choices were made. When someone reviews the estimate later, the BoE lets them see the reasoning without having to guess.
For example, if an estimator used recent crew production rates or vendor quotes to price a concrete package, the BoE explains the source of the data and why those values were chosen. This level of detail helps others validate the estimate, compare it to similar projects, and understand each cost driver.
BoE vs Cost Estimate: Key Differences
A basis of estimate explains the reasoning behind the numbers, while a cost estimate is the numerical outcome. The project cost estimate gives the price. The BoE shows how that price was built and why the costs are justified.
Here is a simple comparison between the BoE and cost estimate:
These two documents work together. The estimate answers “how much,” while the BoE answers “why.” When owners, lenders, or auditors ask about a cost driver, the BoE gives the explanation without forcing the estimator to defend the numbers from memory.
Why a BoE is Critical for Construction Estimating
A BoE is essential because it gives decision-makers the context they need to trust the numbers in a construction estimate. It explains how scope, data, and methods shaped the final project cost. Without it, project management teams make choices based on assumptions instead of clear reasoning.
- Clear scope alignment: Keeps everyone on the same page about what the estimate includes and what it does not.
- Transparent cost logic: Shows how quantities, crew rates, and pricing inputs were chosen.
- Reliable data trail: Points to the historical data, vendor quotes, or production rates that support each cost driver.
- Better risk planning: Documents known uncertainties so the team can prepare for cost or schedule impacts.
- Stronger owner reviews: Gives owners and lenders confidence that the estimate is grounded in real project conditions.
- Cleaner audit support: Helps auditors trace the estimate back to its assumptions without pulling the estimator back into the room.
- Consistency across projects: Helps teams compare similar work and understand why numbers move from one job to another.
A simple example is when a BoE explains the production rate used for a concrete crew. If the project later runs slower or faster, the team can trace the variance back to the documented rate instead of arguing over where the original number came from. That level of clarity is precisely why a BoE matters.
What are the Core Components of the BoE?
A BoE includes the key parts that explain how the construction estimate was built, like the scope, methods, data sources, and limits that shaped the numbers. Each one helps the project team understand the logic behind the estimate.
- Purpose and estimate type: States why the estimate was prepared and what stage it represents, such as conceptual, budget, or detailed.
- Project scope and deliverables: Describes the work included so reviewers know exactly what the estimate covers.
- Estimating methodology and data source: Explains whether the team used historical data, vendor quotes, crew rates, or other methods to build the costs.
- Pricing basis for labor, materials, equipment, and subcontractors: Shows the source of unit rates, markups, and cost elements used in the estimate.
- Assumptions, exclusions, and constraints: Lists the conditions that shaped the cost estimation and any work intentionally left out.
- Allowances and construction contingency: Calls out uncertain items or expected changes that need extra coverage in the numbers.
- Uncertainty and risk analysis: Identifies known risks and how they might affect cost or schedule.
- Benchmarking and validation checks: Compares the estimate against similar projects or internal metrics to confirm it follows reasonable patterns.
Clear BoE breakdowns also help teams keep estimates consistent across different projects and estimators. When everyone follows the same structure, it becomes easier to compare work, track cost patterns, and maintain reliable records that support decisions throughout the job.
How to Write a Basis of Estimate
Writing a BoE starts with defining the scope, sources, pricing logic, and assumptions. The goal is to make the numbers traceable so anyone on the project can follow the logic without guessing. Each step below reflects how experienced estimators build BoEs on real jobs:

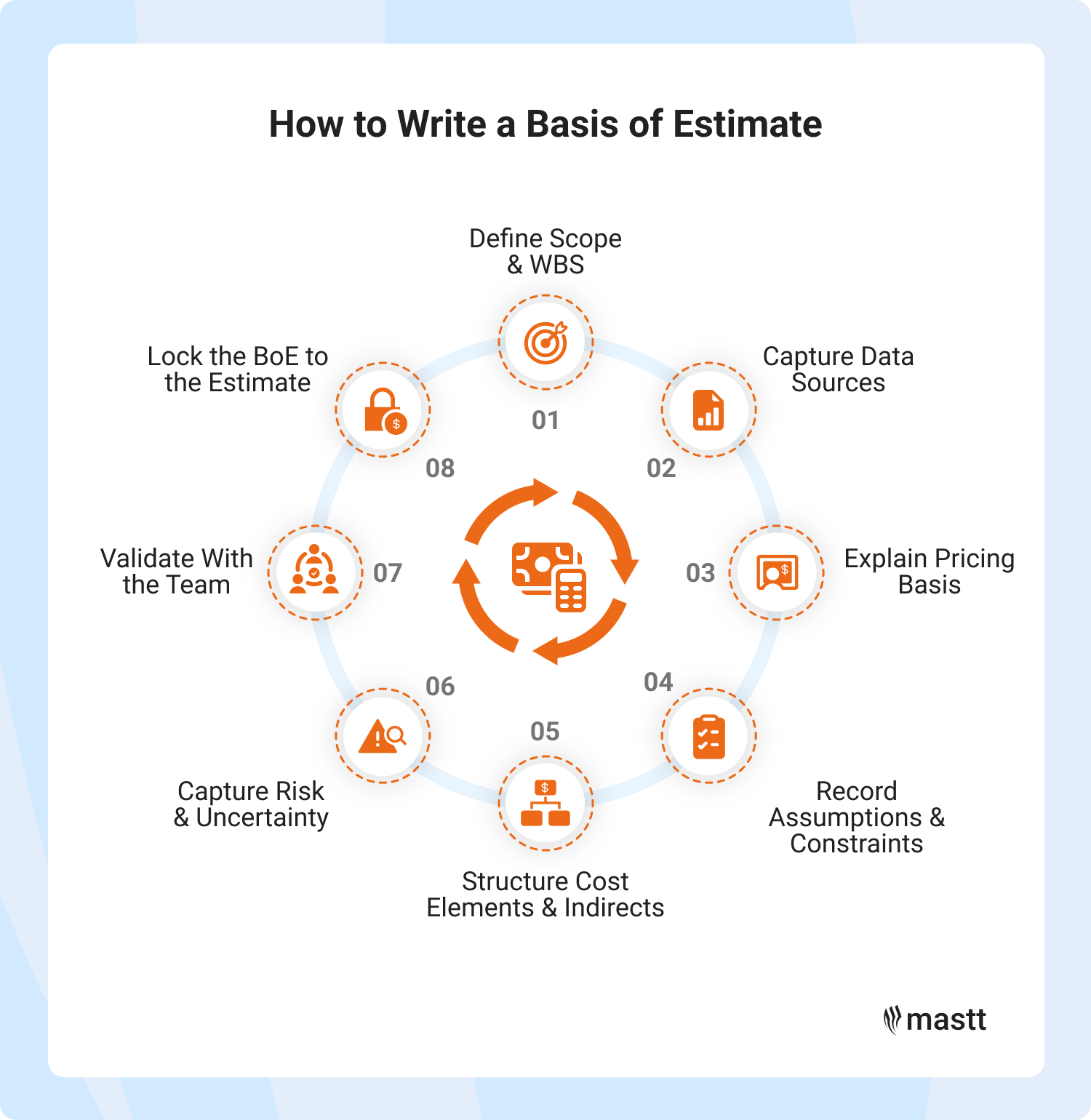

Step 1: Define Scope and WBS
Start by writing a clear project scope, including what is being built, where, and to what level of finish. Then match that scope to a work breakdown structure (WBS) or work packages that line up with how you plan to build the job: sitework, concrete, steel, envelope, interiors, MEP, general conditions, and so on.
In the BoE, that can be as simple as: “WBS 2.1 Slab on grade, 25,000 SF based on drawing A-102. Includes vapor barrier, rebar, placing, finishing, and curing.” This gives anyone reading the BoE a clean starting point for that part of the estimate.
Step 2: Capture Data Sources
Write down the actual data you used, not just “historical costs.” Name the project, year, and why it is comparable. For example, “Earthwork production based on Warehouse A, 2022, similar soil report and haul distance.”
Do the same for vendor and subcontractor quotes. Record who quoted, the date, validity, and what was included. If you pulled rates from a database, note the database name and date. This lets someone later check if the data is still reasonable.
Step 3: Explain Pricing Basis
Here you show how raw data turned into unit prices. For labor, state how you built the rate: base wage, fringes, payroll taxes, and any overtime rules you assumed. For materials, note the unit price, freight, sales tax, and waste factor. For equipment, record the rate and the hours you assumed.
If you are working with subcontractor numbers, say whether they are firm bids, budget quotes, or placeholders. One clear line in the BoE might read: “Carpenter labor rate of $68/hour fully burdened, based on current union agreement, straight time only.”
Step 4: Record Assumptions and Constraints
Any time you “assume” something while estimating, it belongs here. Write short, direct statements about work hours, access, phasing, laydown space, traffic control, winter conditions, or owner-supplied items.
Examples: “Assumes unrestricted access to loading dock during work hours” or “Assumes winter heat for interior work is by owner.” These sentences explain the conditions your costs were built on, which is what people forget first.
Step 5: Structure Cost Elements and Indirects
Show how you broke the work into cost elements. Explain, in words, how you treated labor hours, material quantities, equipment time, and subcontract scopes for each major work area. Then describe how you handled indirects such as supervision, trailers, temp power, safety, and cleanup.
For example: “General conditions include one full-time superintendent for 12 months and one project engineer for 10 months.” This keeps overhead from looking like a random lump sum.
Step 6: Capture Risk and Uncertainty
List the key risks that could increase the cost of this job and say how you allowed for them. Common items include underground unknowns, access limits, tight shutdown windows, weather, or design that is not fully defined.
If you adjusted productivity or added contingency, connect it to the risk in plain language. For example: “Applied 15 percent productivity reduction to deep trenching due to shoring and restricted access.” That line tells a reviewer you did not just pad the number.
Step 7: Validate with the Team
Before you call the BoE finished, walk it through with the project manager and, if possible, the superintendent or project controls lead. Ask them if the BoE matches how they expect to build the work.
If they see a mismatch, such as weekend work you did not allow for, or a crane you priced that they do not plan to use, fix it now. This is where you line up estimating reality with field reality.
Step 8: Lock the BoE to the Estimate
Once everyone agrees, clean up the wording, date the document, and tie it to a specific estimate version. Use the same job number and revision reference as the estimate. Store it where the whole team, accounting, and proposal staff can reach it, not in a personal folder.
When the BoE is locked to the estimate like this, it becomes a standing reference for reviews, disputes, and audits, instead of something people rebuild from memory.
💡Pro Tip: Kick off your BoE by running a quick ROM (rough order of magnitude) check with a construction cost estimator. It helps you confirm early cost ranges and spot missing scope before you start detailed pricing.
Who Uses the Basis of Estimates in Construction
The BoE is utilized by anyone who needs to understand how the estimate was built or confirm that it matches the project scope. It is created by the estimator, who builds the record of how each cost choice was made.
- Estimators: Capture how quantities, rates, and methods were chosen so they can explain, update, and reuse the estimate without guessing later.
- Project managers: Check that the estimated cost, scope, phasing, and site conditions match how they plan to build the job in the field.
- Proposal and preconstruction teams: Build bids, clarifications, and revisions from the same cost logic so messages to the client stay consistent.
- Cost controllers: Track budgets, commitments, and the actual cost back to the original assumptions and cost breakdown in the estimate.
- Schedulers: Align durations, crew sizes, and work sequences with the way work was planned and costed in the BoE.
- Project owners and clients: See what is included and excluded in the price, how costs were built up, and where the main risks and allowances sit.
- Lenders and investors: Decide if the budget is strong enough to support financing based on clear methods and realistic data.
- Auditors and reviewers: Follow each major cost item back to its data source, method, and assumptions during checks and audits.
When the BoE is written clearly, each of these stakeholders can find what they need without calling the estimator every time. That keeps decisions moving and reduces the risk of mixed messages inside the project team and with the client.
Common Challenges When Preparing a BoE and How to Avoid Them
Most BoE problems start with how they are prepared: rushed writing, unclear scope, and weak recordkeeping. But most of them are preventable with simple habits built into the estimating process.
💡 Pro Tip: During estimating, keep a simple “BoE log” on one page and add a line every time you make a non-obvious choice, like a rate, productivity, or scope assumption. At the end, drop those lines into the right sections of the BoE. This habit takes minutes during pricing and can save days of back-and-forth once the project is live.
Best Practices for Building a Strong Basis of Estimates
You create a reliable BoE by making it easy to read, easy to trace, and easy to test. The tips below focus on how the BoE works in real projects, not just how it looks on paper.
- Anchor the BoE to specific drawings and documents: Reference drawing numbers, spec sections, and RFIs so anyone can see exactly which design information each cost is based on.
- State the “date of money” and pricing conditions: Record the pricing date, currency, and any escalation or market assumptions so later changes in prices are easier to explain.
- Separate base cost, contingency, and allowances: Show these as distinct parts in the BoE so owners and PMs can see what is firm scope and what is risk coverage.
- Flag high-impact assumptions clearly: Highlight key assumptions that drive large cost items, such as productivity, shift patterns, or access limits, so reviewers can focus on what matters most.
- Explain the basis for major production rates: For big trades like earthworks, concrete, and steel, state how you arrived at crew outputs or cycle times, not just the final unit rate.
- Call out what changed since the last estimate: Include a short “key changes” note for re-issues so everyone can see where scope or cost logic has moved.
- Align BoE structure with the client’s reporting format: Match major sections to how the client or funder expects to see costs grouped so fewer questions come back at review time.
- Include a short quality check section: Note any internal checks performed, such as crosschecks against similar projects or independent reviews, to show the estimate has been tested.
💡Pro Tip: For each major cost category, add one line that answers, “What would have to change on site for this number to move by more than 10%?” That single sentence forces you to think through the risk and gives PMs a ready-made guide for what to watch during delivery.
How Software Can Speed Up BoE Preparation
Artificial intelligence and construction estimating software speed up BoE preparation by doing a lot of the heavy lifting on data, structure, and checks. They help estimators spend less time on admin work and more time on judgment and review.
☑️ Auto-filling BoE sections from the estimate: Software can pull scope, quantities, cost codes, and markups straight from the estimate, so you don’t have to retype the same information.
☑️ Reusing data from past projects: AI can scan historical estimates and BoEs to suggest rates, methods, and assumptions that match the current job.
☑️ Linking line items to drawings and documents: Modern tools can store drawing numbers, spec sections, and RFIs alongside each cost item so the BoE can reference them with a few clicks.
☑️ Flagging missing assumptions and gaps: AI can check for empty fields, unsupported rates, or items without notes and prompt the estimator to fill them in before issuing.
☑️ Keeping a clean audit trail and version history: Software tracks who changed what and when, which makes it easier to show how the BoE and estimate evolved.
☑️ Standardizing templates across the company: A shared digital template means every project starts with the same sections, structure, and labels, which keeps BoEs consistent.
☑️ Pulling in live or recent cost data: Integrated platforms can bring in current labor rates, material prices, or vendor quotes so the BoE reflects up-to-date information.
AI and software can turn the BoE into a byproduct of the estimating process instead of an extra task at the end. The estimator still owns the judgment, but tools handle the repetitive work and help catch issues early.
Build Clearer Estimates With a Stronger Basis of Estimate
The most reliable BoEs come from steady habits, like writing as you estimate, keeping data clean, and explaining significant cost drivers in clear, simple terms. When you do that, owners trust the numbers, PMs plan with confidence, and auditors spend less time digging for answers. If you want tighter control, fewer surprises, and smoother reviews, start with a clearer BoE.




.avif)




![Construction Cost Estimator [100% FREE Calculator]](https://cdn.prod.website-files.com/607f739c92f9cf647516b37b/67c0fa1d9a56de2ac61fe0ed_construction-cost-estimator.avif)
![Construction Cost Estimator [100% FREE Calculator]](https://cdn.prod.website-files.com/607f739c92f9cf647516b37b/68b2bcca6e193bbaa1f9a900_Jefbeck-Eje-SEO-Specialist-Mastt.avif)
