Work Package in Construction Projects: A Complete Guide

A work package is a small unit of work in construction. Learn how to use work packages to manage scope, budget, and tasks clearly from start to finish.

Popular

Free Work Breakdown Structure Template! Organize tasks, deliverables, and milestones into smaller, more manageable components.

Work Package
Back to top

A work package is a manageable chunk of work, clearly defined and assigned to the right people. It groups related tasks under a specific deliverable, like pouring a slab or installing wiring, so teams can stay focused and accountable.

Let’s talk about what work packages are, how they fit into the work breakdown structure (WBS), and how to use them to manage scope, cost, and time more effectively. If you're a project manager or owner, this is the tool that helps you stay in control from planning to handover.

TL;DR
Work packages are small, manageable chunks of construction work with clear scope, budget, and deadlines. They help teams stay focused, avoid confusion, and track progress. Used properly, they improve planning, cost control, and accountability. If you manage or own construction projects, understanding work packages is key to staying on track.

What is a Work Package in Construction?

A work package is the smallest unit of work in a construction project that you can plan, assign, and control. It sits at the lowest level of the Work Breakdown Structure (WBS) and includes a defined scope, budget, schedule, and deliverables. Each work package groups related tasks into one manageable unit that a team or individual can own.

Here’s how the structure breaks down:

Project → Phase → Work Package → Activity → Task

Example:

Build a House → Structural Phase → Foundation Work Package → Excavate, Pour, Cure

Think of it this way: phases cover broad project areas. Work packages focus on one specific deliverable, like pouring a foundation. Activities are the grouped steps to complete the deliverable. Tasks are the individual actions.

Work Package Example: Building a House

Let’s say you’re managing a project to build a house. One of the project phases is structural work, and within that phase, you create a work package for pouring the foundation.

This work package includes all the related activities needed to deliver a completed concrete slab:

  • Topographical survey of the site to confirm elevations and drainage
  • Setting out the foundation layout using site plans and benchmarks
  • Excavation to the required depth and dimensions
  • Installing formwork and reinforcement (steel bars, mesh)
  • Pouring concrete with slump and strength testing
  • Curing the slab using moisture retention methods for 7 days minimum

These tasks are bundled together because they lead to a single, clear deliverable: a ready-to-build foundation. The package also includes cost estimates, required equipment (like excavators and concrete pumps), labor hours, safety protocols, and a 10-day timeframe.

Here’s how it fits into the Work Breakdown Structure:

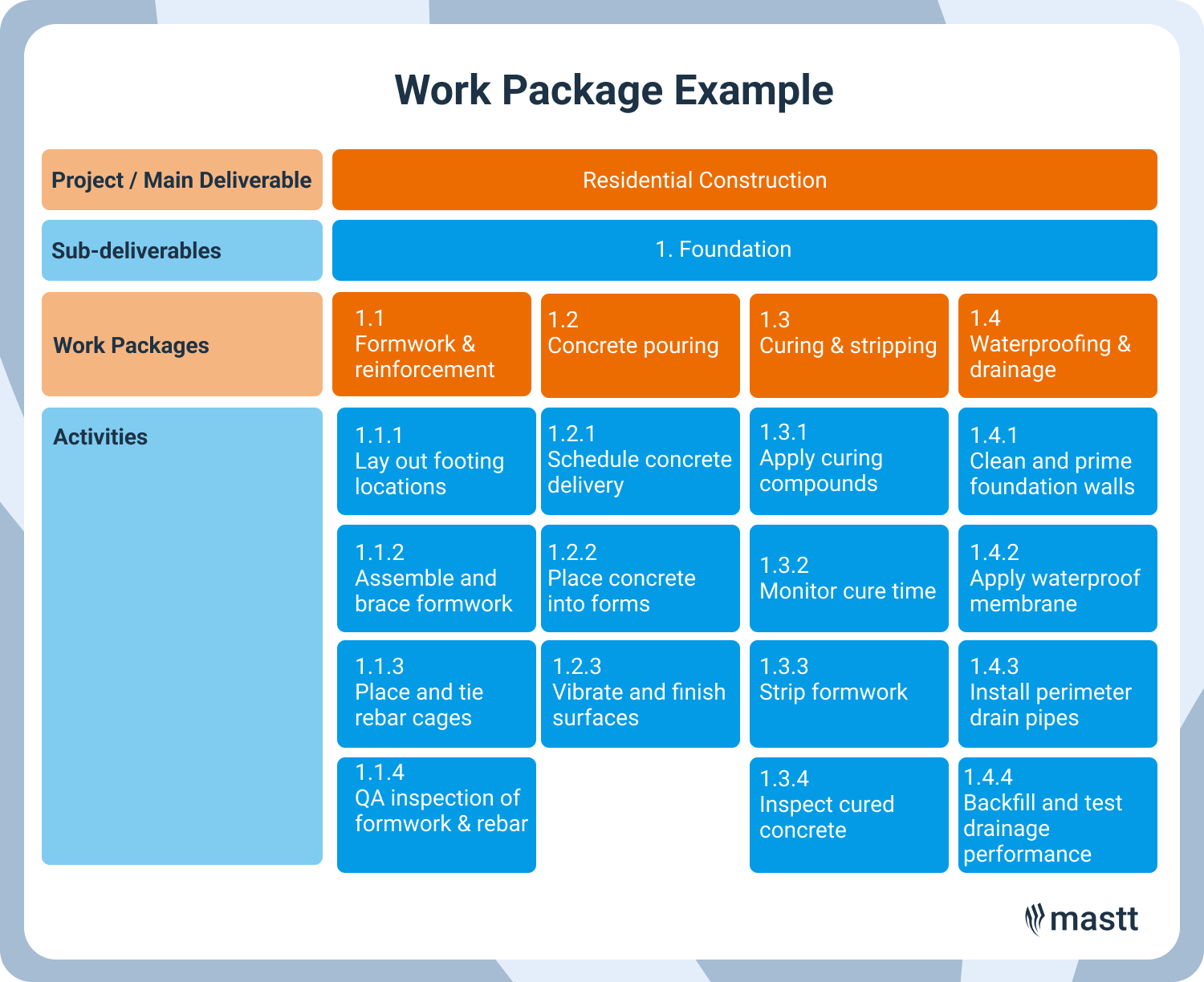

Chart showing a work breakdown for a residential construction foundation, including work packages like formwork, concrete pouring, curing, and waterproofing with related activities.
See how a single construction phase breaks into work packages that simplify planning, resource allocation, and on-site delivery.

This work package also depends on earlier site clearing and affects future packages like wall framing or plumbing rough-ins. That’s why defining boundaries, activity sequencing, and dependencies is critical.

4 Types of Work Packages

The main types of work packages in construction are Engineering Work Packages (EWPs), Construction Work Packages (CWPs), Installation Work Packages (IWPs), and Test Work Packages (TWPs). Each serves a specific role in construction planning, executing, or closing out work.

1. Engineering Work Package (EWP)

An EWP is an engineering deliverable used to create Construction Work Packages. It includes construction drawings, specifications, vendor data, and procurement documents. EWPs are released in a sequence that matches the construction schedule and are typically organized by discipline, such as piping or structural steel.

2. Construction Work Package (CWP)

A CWP is a detailed, executable section of construction work. It defines a specific scope, includes a budget and schedule, and is used to track performance. Each CWP stands alone. It doesn’t overlap with other CWPs. It can also be used for construction bidding, contracting, and progress measurement.

3. Installation Work Package (IWP)

An IWP is a detailed plan under a CWP, designed for field crews. It organizes everything needed before work begins. IWPs are focused on a single discipline and sized so that a single crew can complete them within one to two weeks, safely and efficiently.

4. Test Work Package (TWP)

A TWP ensures that systems or assets, like pipelines or equipment, meet specific testing requirements before handover to the owner or operator. Testing happens after construction is finished but before the formal turnover, confirming readiness and compliance.

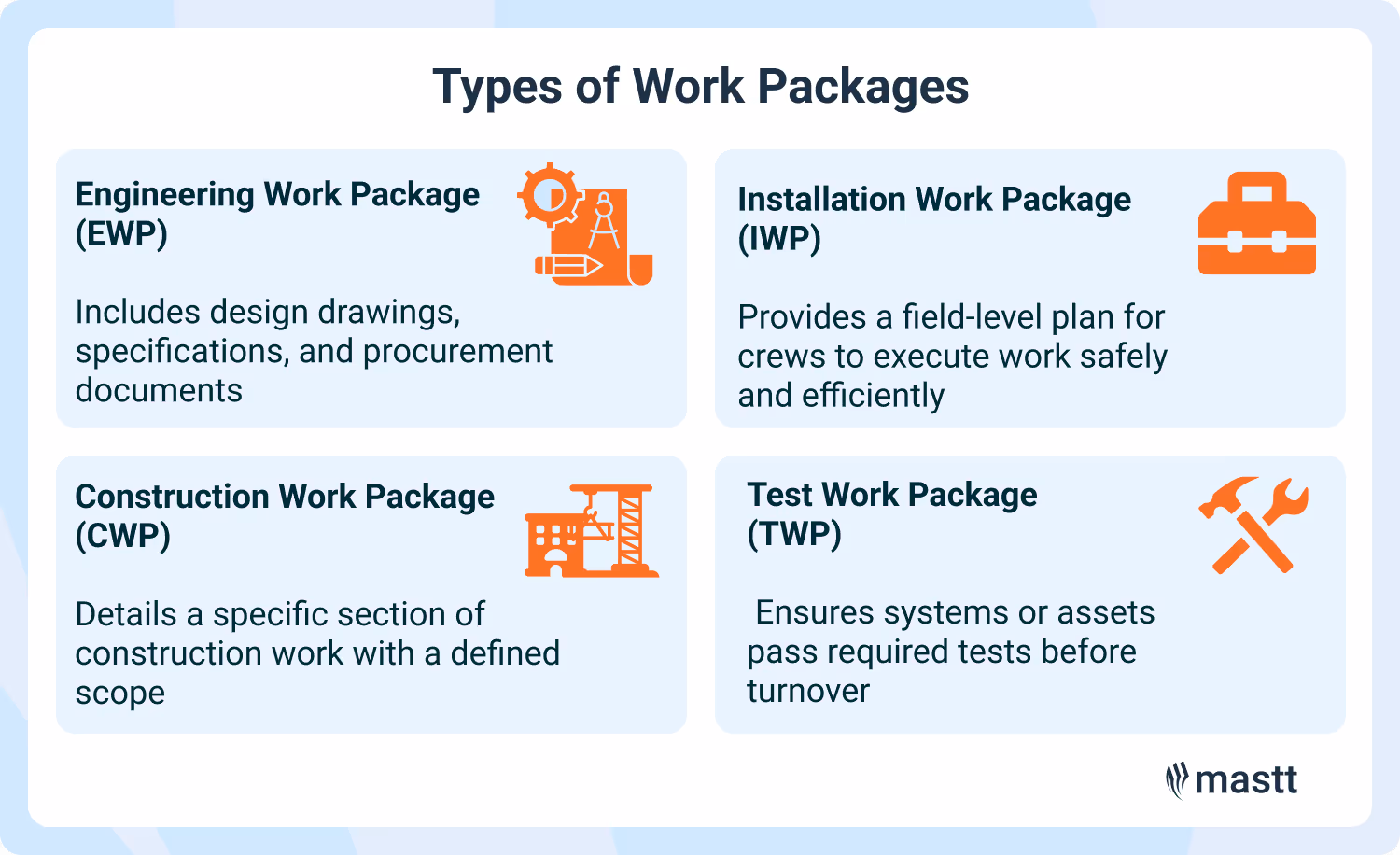

Summary of four key work package types—engineering, construction, installation, and testing—each tailored for a specific stage of project delivery.
The right work package type helps align teams, reduce errors, and accelerate delivery across all project phases.

Key Elements of a Well-Defined Work Package

A well-defined work package makes it easier to assign, execute, and measure progress. It includes the following core elements:

  • Scope of Work: Defines exactly what work needs to be done and what doesn’t. This includes the boundaries of the task, interfaces with other packages, and specific constraints. A clear project scope prevents duplication, avoids missed steps, and reduces scope creep during execution.
  • Deliverable: States the physical or measurable outcome that the work package must produce. It must be tangible, clearly tied to the scope, and verifiable at completion.
  • Start and End Date: Sets the time window for completing the work. These dates help the project team integrate the work package into the overall schedule and track progress against key project milestones.
  • Resources and Budget: Lists all required inputs and the associated cost estimates. This allows for accurate cost tracking, procurement planning, and workload balancing. It also ensures the team knows what they need before work begins.
  • Quality & Safety Requirements: Details the standards, specifications, and procedures that must be followed to meet all expectations. This may include checklists, inspection points, safety protocols, and risk management plans.
  • Owner and Accountability: Assigns one person or team responsible for the entire work package. Clear project ownership avoids confusion and keeps work on track.

How to Build an Effective Work Package

An effective work package turns a defined piece of work into a detailed, executable plan. It must be clear enough for a crew to act on, measurable enough for managers to track, and structured enough to support project-wide planning and control.

Step 1: Identify the Deliverable

Start with the outcome. What will this work package produce when it's done? The deliverable should be concrete and verifiable. If you can’t measure it or hand it over, it’s not clear enough. The deliverable sets the direction for everything that follows.

Step 2: Define Scope, Activities, and Boundaries

Clarify what’s included, what’s not, and where the package begins and ends. Break the deliverable down into grouped activities and related tasks.

For example, a "foundation" work package might include surveying, formwork, rebar, and pouring. Avoid overlap with other packages and document any interfaces or dependencies that affect sequencing.

Step 3: Assign Ownership and Resources

Designate one accountable owner. Ideally, someone who understands both the scope and the crew. Then list out the labor, materials, equipment, and subcontractors needed. This includes quantity, source, and delivery timing. Align resource needs with availability and flag any procurement lead times or constraints early.

Step 4: Set Budget, Timeframe, and Quality Standards

Build a cost estimate that covers direct and indirect resources. Define a realistic start and completion date, factoring in float time and sequencing. Set quality benchmarks: what does “done” look like, and what inspections or tests must be passed? Include relevant codes, standards, or client requirements to avoid delays or rework.

Step 5: Align With Project Schedule and WBS

Position the work package properly within the Work Breakdown Structure and master schedule. Confirm dependencies, what needs to be finished before this package starts, and what comes after. Make sure timing, logic ties, and resource allocations match the overall project plan. If changes are needed, coordinate early to avoid disruptions downstream.

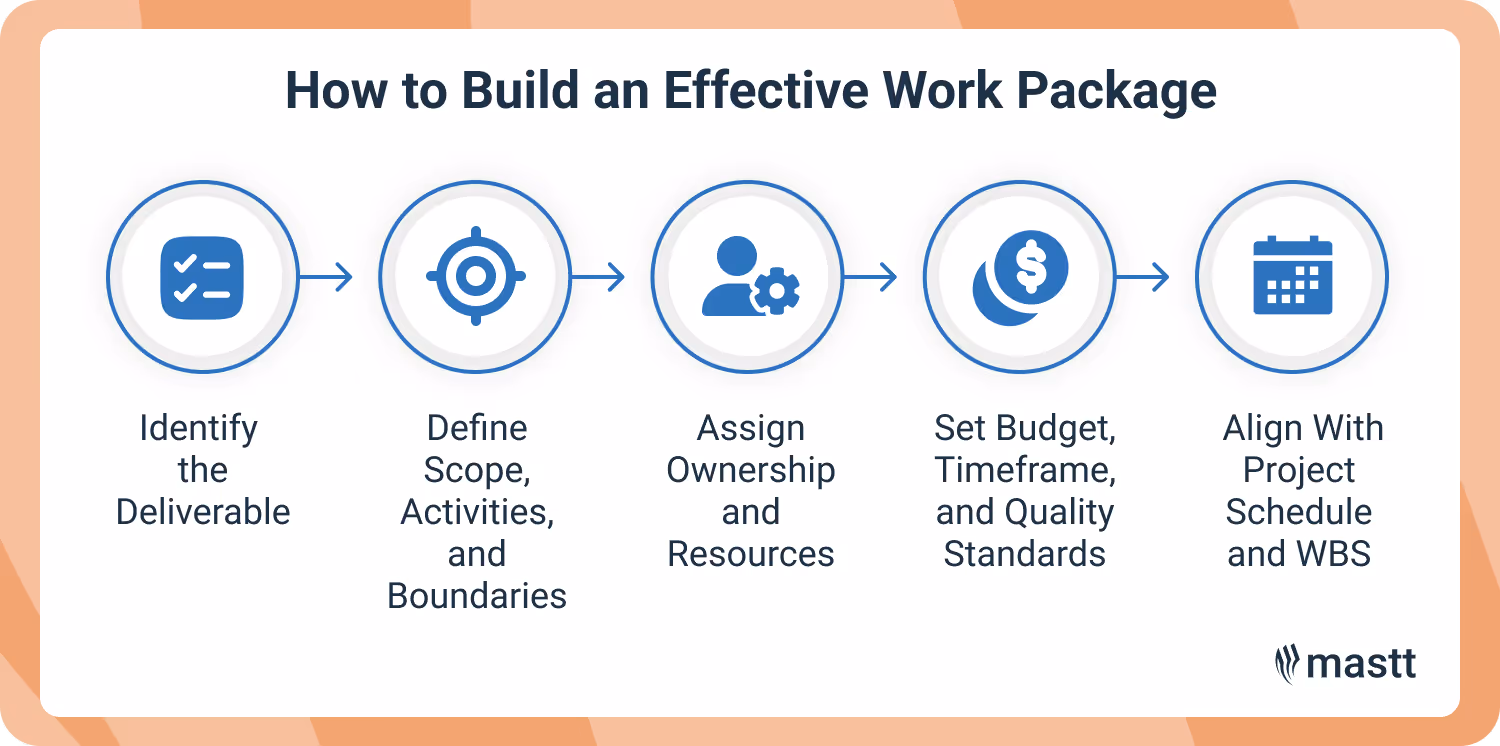

 Five-step framework for building effective work packages, covering deliverables, scope, ownership, standards, and schedule alignment.
A structured work package sets the foundation for predictable costs, timelines, and quality outcomes.

Benefits of Using Work Packages in Construction

Work packages give project managers more control over scope, time, and cost. They turn large, complex projects into smaller parts that are easier to plan, track, and manage. Here are the key benefits:

  • Granular control over scope and responsibilities: Each work package defines a clear section of work with one owner. This improves accountability and makes it easier to manage high-risk or detailed tasks without losing visibility.
  • Improved project scheduling and budgeting: With tasks grouped logically, teams can estimate time and cost more accurately. Packages help track actual vs. planned progress at a smaller scale, giving early warnings when things go off track.
  • Faster and more accurate cost estimates: Because each package deals with a limited scope, it’s easier to calculate direct costs like labor, materials, and equipment, as well as indirect costs. This leads to better construction cost forecasting and financial planning.
  • Supports concurrent activities: Work packages allow multiple teams to work in parallel on different scopes without interfering with each other. This helps keep the overall project moving and reduces idle time.
  • Highlights task dependencies: A well-structured package shows where tasks depend on each other. This helps teams schedule around shared resources, avoid conflicts, and make smarter sequencing decisions.
  • Helps track performance and progress: Work packages align with earned value metrics like CPI (Cost Performance Index), SPI (Schedule Performance Index), and cost or schedule variance. These project control indicators give a clear picture of performance in real time.

Challenges in Implementing Work Packages (and How to Solve Them)

Work packages are powerful tools, but they only work when properly implemented. Without the right coordination and support, they can fall short and cause delays, confusion, or wasted effort.

Here are the most common challenges and how to fix them:

Interdisciplinary Misalignment

Design, procurement, and construction teams often plan on different project timelines or use different assumptions. This leads to missing inputs, poor sequencing, or rework in the field.

Solution: Bring all disciplines together early to align scopes and timelines. Use shared planning tools and hold regular cross-team coordination reviews.

Training and Tool Gaps

Teams may not fully understand how to create, use, or manage work packages. Without the right tools or training, crews default to informal methods or skip key steps.

Solution: Train all stakeholders on how to use work packages and related software. Keep instructions simple and accessible.

Resistance to Structured Planning

Some teams see work packages as extra paperwork. If they’re used to flexible, informal project planning, they may resist adopting a more structured system.

Solution: Show the value. Use examples to demonstrate how work packages reduce confusion, clarify accountability, and speed up approvals. Start small and build trust with results.

Unmanaged Updates During Construction

Once a package is approved, it can become outdated if changes aren’t tracked. Crews might work from old versions, leading to mistakes or project delays.

Solution: Assign responsibility for maintaining and updating work packages as the project evolves. Use digital tools that flag changes and notify teams in real time.

How To Manage Work Packages on Large Projects

Large projects involve many moving parts, so managing work packages requires structure, coordination, and consistency. These best practices help keep packages clear, aligned, and under control.

1. Involve Teams Early in Defining the Scope

Get input from field supervisors, engineers, estimators, and procurement teams at the start. They know the real constraints that affect how work should be packaged. Early contractor involvement leads to packages that are realistic, complete, and easier to execute.

2. Use a Consistent Template or Format

Standardize the structure across all work packages. Every package should include clear scope, deliverables, project owner, timeframe, cost estimate, resources, and quality checks. A consistent format helps teams read, manage, and compare packages without second-guessing what's missing.

3. Review Packages During Phase Gate Meetings

Don’t wait until work starts to find gaps. Use phase gate reviews to check if each package is complete, coordinated with other scopes, and ready to release. This helps prevent rework and keeps packages aligned with overall project milestones.

4. Monitor Progress Weekly

Weekly reviews catch problems faster. Use tools like dashboards or short check-in meetings to track status, flag delays, and adjust resources. Don’t wait for monthly reports. By then, small issues may have turned into major delays.

5. Update Scope and Budget Dynamically

Projects evolve. Weather shifts, design updates, or procurement delays can all affect a work package. Make it standard practice to revise packages as needed, not just at the start. Use version control in your project management software to keep everyone working from the latest plan.

Tools and Software for Managing Work Packages

Work packages are only as effective as the systems used to manage them. Digital tools make it easier to keep packages up to date, track progress in real time, and keep teams aligned across disciplines and locations.

  • Mastt is built specifically for capital project owners and managers. It gives high-level oversight across all active work packages using a work breakdown structure, combining cost control, performance tracking, and progress dashboards in one platform.
  • Microsoft Project and Primavera P6 are industry staples for scheduling and earned value management. They allow teams to link work packages to timelines, assign resources, and monitor progress against baseline plans.
  • Procore offers a unified platform for managing documents, field activity, and workflows. Teams can attach drawings, RFIs, and construction submittals directly to work packages and keep everyone on the same page.
  • Hive supports flexible task management with visual timelines, Gantt charts, Kanban boards, and team dashboards. It’s useful for tracking work package status, managing dependencies, and coordinating across departments.

The right software helps teams stay current, reduce errors, and respond quickly to changes. Look for tools with live dashboards, collaboration features, version control, and resource tracking to keep work packages moving smoothly.

FAQs About Work Packages in Construction

Ideally, no. Each work package should have one clearly assigned owner to ensure accountability. Supporting team members can contribute, but one person should be responsible for delivery and reporting.
Work packages help in EVM by providing baseline data needed to measure cost and schedule performance. They let you track planned vs. actual progress using metrics like CPI and SPI.
Yes, but they're adapted to fit iterative workflows. In Agile construction, work packages may align with short sprints or deliverables and focus on flexibility while still defining clear scope and ownership.
Yes, especially if they involve multiple teams, trades, or scopes. Even on smaller jobs, work packages help clarify responsibilities, reduce confusion, and improve tracking.
