Construction Daily Report Template

Enter your email below to download the file.

By downloading, you agree to receive marketing emails from Mastt. Unsubscribe anytime.

Oops! Something went wrong while submitting the form.
Free Template

Construction Daily Report Template

FREE construction daily report template in Excel format. Capture what was built, who was on site, what stopped work, and the evidence behind every hour lost.

Templates
Word Template
Excel Template
Powerpoint Template
Construction Daily Report Template
Template by
Doug Vincent
Published:
Nov 4, 2025
Updated:
August 24, 2026

What is a Construction Daily Report?

A construction daily report is the record of what happened on site on one calendar day: what was physically built and where, who was there, what plant was working, what was delivered, what the weather did, and what stopped or slowed the work. One report per day, written the same day, signed and issued.

It matters because it is contemporaneous. A note written on the day carries weight that a reconstruction written six months later does not, and the daily report is usually the first document anyone asks for when a delay claim, a disruption claim or a dispute begins.

Some teams call the same document a daily field report or a jobsite daily report. If you need the superintendent's running log rather than the reported version, the construction daily log template covers that.

What to Include in a Construction Daily Report

A construction daily report needs seven things: the day and shift, the weather, the work carried out, the labor on site, the plant, the deliveries, and anything that delayed the work.

Sheet What it records
Cover Project, contract, report number, date, shift, prepared by, and the notice to proceed and completion dates.
Daily Report The one-page record: identity, weather read back from the log, work carried out today by area and package, work planned tomorrow with their prerequisites, and the certification.
Labor One row per crew: subcontractor, trade, supervisors, workers, apprentices, start and finish, breaks and total labor-hours.
Equipment Item, unit number, owner, meter start and finish, hours operated, standby hours, utilization, operator and pre-start inspection.
Materials & Deliveries Time, supplier, delivery ticket number, quantity delivered, rejected and accepted, destination and whether the test certificate came with it.
Delays & Disruption Start and finish, duration, activity affected, cause, delay category, who carried the risk, critical path affected, notice required and given, workers and equipment standing by, cost.
Site Events & Records Visitors, verbal directions, RFIs, safety observations, incidents, hold points, non-conformances, tests and inspections, with an action owner and follow-up date.
Weather Log One row per day, with running rainfall, running hours lost and the position against the contract's weather day allowance.
Daily Summary Workers on site, labor-hours, equipment, deliveries, delay hours and overdue notices, all calculated.

Construction Daily Report Example

Here is an example of a completed construction daily report, covering a rain-affected day on a health precinct project.

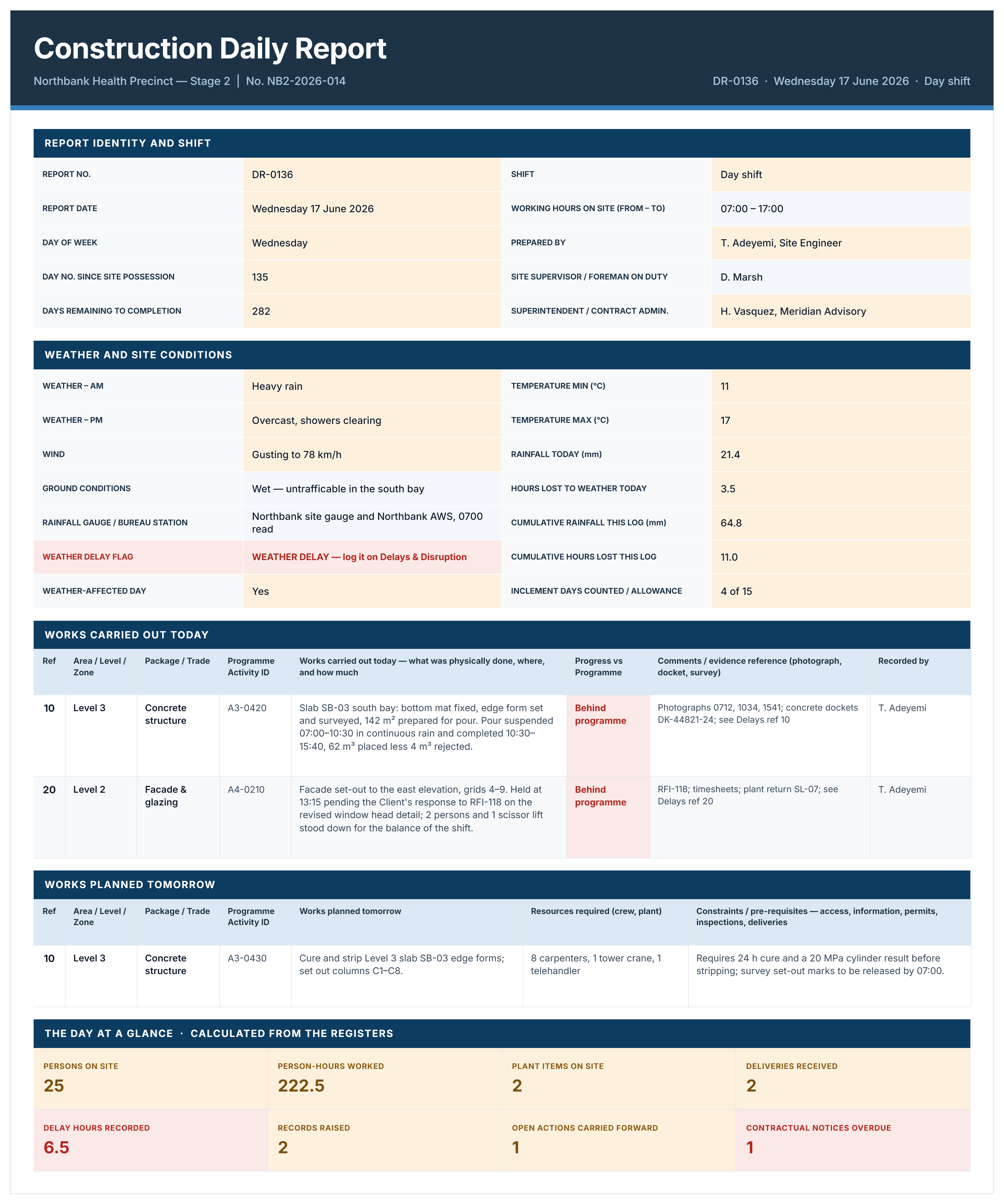

Completed construction daily report example recording weather delays, works carried out, works planned tomorrow and labor and plant totals.
Construction daily report example showing weather, works carried out and the day at a glance summary.

How to Write a Daily Report for a Construction Project Using This Template

Write it the same day, from what you saw, in enough detail that someone who was not there can follow it. The test is whether it still makes sense to a stranger in three years.

  1. Complete the Cover once per reporting day, since every other sheet reads the project, number and date from it.
  2. Enter the day's weather on the Weather Log first, naming the gauge or station the rainfall came from, because a regional forecast is not evidence of conditions on your site.
  3. Record works carried out by area, level and package, with quantities and the schedule activity ID, not a description of the trade.
  4. Record works planned tomorrow with the pre-requisites each one depends on, since that is what turns a report into a look-ahead.
  5. Enter every gang on the Labor sheet with start, finish and breaks, and let person-hours calculate.
  6. Record every machine, including plant that stood idle and why.
  7. Log deliveries with the docket number, and record rejections and missing test certificates on the day.
  8. Record every delay and disruption event with its start and finish time, cause, who carried the risk, and whether the critical path was affected.
  9. Use Site Events for anything else with evidential value, including verbal directions, which should be confirmed in writing.
  10. Read the Daily Summary, sign the certification, and issue within the time the contract allows.

A daily report is issued once and not rewritten. If a correction is genuinely needed, issue a revision saying what changed and why, and keep the superseded version. A diary that has been quietly edited is worth very little as evidence.

Recording Delays, Weather and Disruption

The delay sheet in the file is where a daily report stops being administration and starts being evidence. Every event gets a start time, a finish time, the activity it affected, and four judgements most reports skip.

  • Delay category: Inclement weather, late information, variation, access, industrial, or a supply issue.
  • Responsibility: Client, contractor, neutral or shared, recorded as it appeared on the day.
  • Critical path affected: Yes or no, because a delay to work with float is a different conversation.
  • Notice required and given: With the notice reference, since an entitlement is usually lost by a missed deadline rather than a weak argument.

Persons standing and plant standing sit alongside them, which is what converts an event into a cost. Fourteen people and three machines idle for three and a half hours is a number. "Rain delayed the pour" is not.

The weather log carries the running position, so the cumulative rainfall, the cumulative hours lost and the inclement days counted against the allowance are all current on any given day rather than reconstructed at the end.

Related Articles and Templates

Explore these resources for construction daily reporting, site records, progress, and schedule tracking:

FAQs About Construction Daily Reports

Usually the site engineer, superintendent or project engineer, signed by whoever holds responsibility for the shift. Some contracts require the owner's representative to countersign, and where they do, the countersignature is what makes it a joint record rather than one party's account.
A daily report covers one day and records facts: work, labor, equipment, weather, delays. A progress report covers a week or a month and interprets them, comparing progress against the schedule and forecasting completion. The daily reports are the evidence the progress report draws on.
Excel where you want person-hours, equipment utilization, delay hours and cumulative weather to calculate. Word suits a simple narrative version on a small job. Most contracts do not prescribe a format, but they do prescribe timing, so check how quickly yours requires the report to be issued.
Detailed enough that a stranger reading it in three years can tell what was built, where, by whom and what stopped it. Quantities, locations, grid references and activity IDs. A report that reads "work continued as planned" proves nothing when it matters.
Idle equipment, standing labor, verbal instructions and the reason work stopped. Those four are the ones that decide claims, and they are the ones most often missing because they record what did not happen rather than what did.
It is usually the first document requested. Its weight comes from being contemporaneous, consistent and unedited, which is why reports should be issued daily, kept as a complete series, and revised openly if a correction is ever needed.
