AI Readiness Assessment: Is Your Construction Firm Ready?

Erin Khan
Post author:
Erin Khan
Contributor:
Jackson Row
Reviewed by:
Jackson Row
Published:
Sep 25, 2026
AI Readiness Assessment: Is Your Construction Firm Ready?

An AI readiness assessment finds the data, access, reviewer, and cost gaps that can stall a construction AI trial before the team commits to one. This guide explains how to assess a construction workflow, interpret the findings, and prioritize preparation. A worked example shows how the assessment informs a decision about testing AI for project cost reporting.

Key Takeaways
  • An AI readiness assessment helps determine whether to pilot, prepare further, or reconsider a proposed use.
  • Start with one construction workflow and a measurable improvement. Readiness can differ across tasks.
  • Check project records, permissions, system connections, reviewer skills, and costs. Record evidence for each.
  • Strong data cannot make up for missing permissions or reviewers. Assign someone to resolve each essential gap.
  • Measure time savings through to an approved output. Include preparation, review, and corrections.
  • Being ready for a pilot does not prove the tool will deliver value. Test against agreed quality and cost targets.

What Is an AI Readiness Assessment?

An AI readiness assessment is an evaluation of whether an organization’s strategy, data, technology, people, and governance can support a specific use of artificial intelligence (AI). It compares current capabilities with the requirements of that use and identifies gaps.

Its main purpose is to help decision-makers choose whether to proceed with a controlled pilot, prepare further, or reconsider the proposed use. This gives the organization a basis for deciding where to commit time, staff, and budget.

In construction, the assessment examines readiness for project tasks, such as cost reporting or document search. It checks the project records, construction systems, client permissions, and staff that each task relies on.

How to Conduct an AI Readiness Assessment in Construction

Assessing readiness to use AI in construction starts with a specific workflow, then examines the data, systems, people, and controls needed to support it. For each step below, the team should record the evidence reviewed, gaps, required actions, and who will address them.

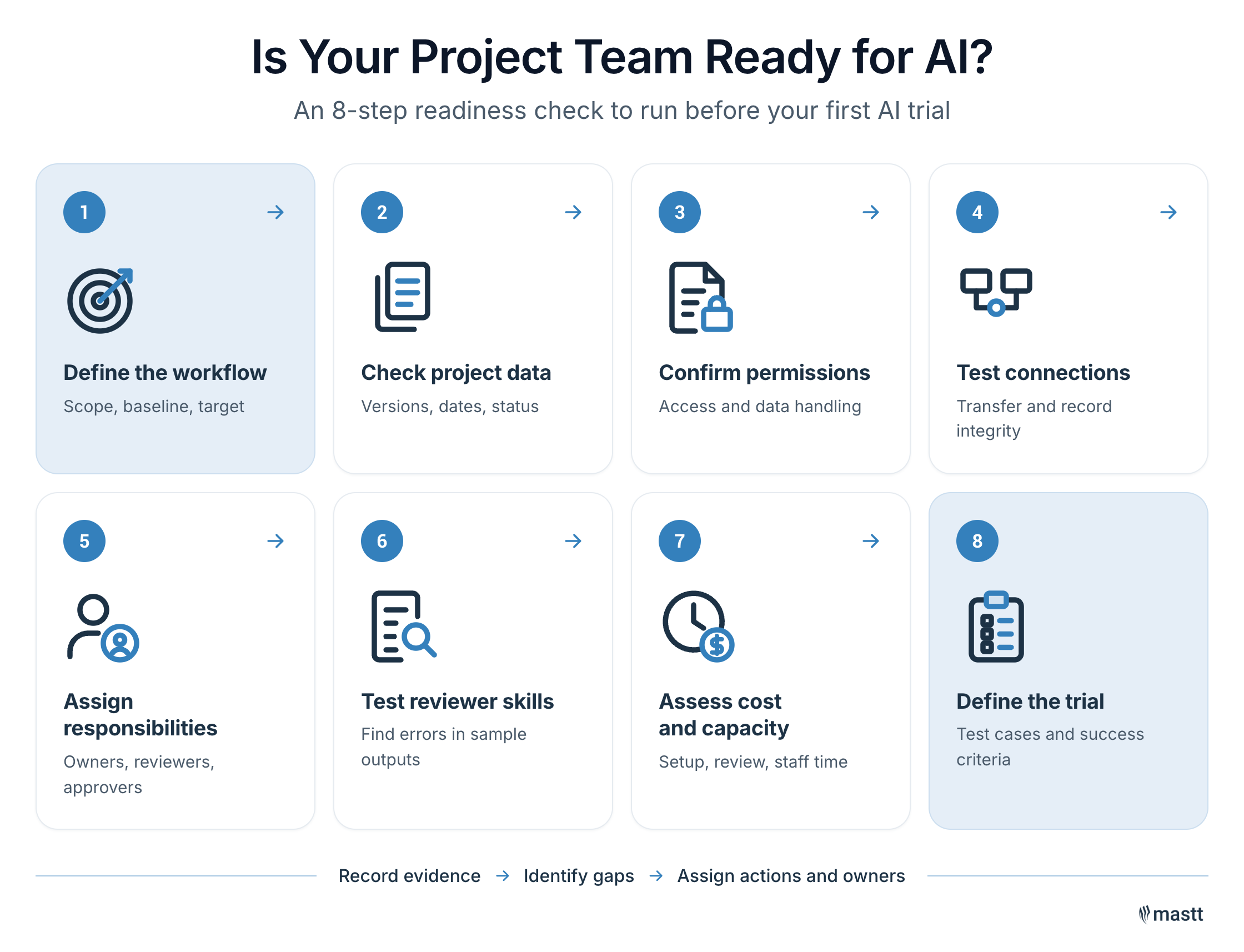

Eight-step AI readiness check covering workflow, data, permissions, connections, responsibilities, reviewer skills, cost, and trial criteria.
An AI readiness assessment checks whether the workflow, data, people, controls, and costs are ready for a trial.

Step 1: Define the workflow and expected improvement

The team should define a specific task and the problem it needs to solve. Examples include drafting cost reports, summarizing site meeting actions, or searching project documents.

When a construction company asks where to start with AI, I ask what problem it wants to solve and why. Teams often arrive with solutions in mind, but the problem needs to be clear before those solutions can be evaluated.

Before choosing a use case, I recommend that leadership sit down with department heads and field users and ask where their pain points are. That listening exercise surfaces what people care about and where AI can add value.

The team should document:

  • Scope and users: The project, task, and roles included.
  • Current performance: Time spent gathering information, producing the output, reviewing it, and correcting errors.
  • Expected improvement: A measurable target against the baseline, with clear quality requirements.
  • Operating limits: What AI may read, draft, or change, and which decisions require human approval.

For a cost-reporting pilot, define which tasks a tool such as Mastt AI Agent would handle. The scope could cover preparing a draft, with staff retaining responsibility for figures and approval.

Step 2: Check AI data readiness in project records

The team should inspect the records needed for the selected task and confirm that users can identify the correct versions and interpret them accurately.

I see teams dive into AI adoption and then pause because they do not have the internal data resources to support it. They realize they need to address the data first.

The review should check:

  • Document revisions: Current drawings and specifications are distinguishable from superseded versions.
  • Cost status: Approved budgets, current forecasts, and pending change orders remain distinguishable.
  • Dates: Records show their reporting period and latest update.
  • Project context: Project identifiers, units, and other essential details are retained.

Each data gap needs someone responsible for correcting it and maintaining the records during the trial.

💡 Pro tip: Tracing one figure from the latest cost report back to its source and approval record can reveal conflicting versions or missing decisions.

Step 3: Confirm access to client and project information

Relevant project, IT, and legal representatives should review client requirements, provider terms, and access settings to establish:

  • Permitted records: Which projects and information the tool may use.
  • Access boundaries: Which users and connected tools may retrieve information.
  • Provider handling: Where data is processed, who can access it, and whether it may be used for model training.
  • Retention and removal: How stored information and access will be managed when the trial ends, or staff leaves.

For a consultancy serving several clients, access testing should confirm that one client’s restricted records cannot appear in another client’s results. Unresolved permissions need a decision before the affected information enters the pilot.

Step 4: Evaluate connections to construction systems

For a shortlisted tool, the team should compare an authorized sample transfer with its source records. Before tool selection, the following checks can serve as requirements for evaluating candidates.

I still see a strong preference for off-the-shelf AI construction tools because many construction organizations do not have an internal team of technical specialists.

The review should check:

  • Transfer method: Whether a controlled export is sufficient or a maintained connection is needed.
  • Record integrity: Whether project identifiers, cost codes, dates, revisions, and change order status survive the transfer.
  • Access controls: Whether restrictions between projects, clients, and users remain effective.
  • Tool replacement: Whether project records remain usable if the tool is disconnected or replaced.

Step 5: Map AI responsibilities to project approval roles

The team should assign named people to maintain inputs, review outputs, approve their use, and resolve problems. For a cost-reporting pilot, responsibilities could include:

  • Workflow owner: Defines the reporting need and coordinates the trial.
  • Data owner: Maintains the source records.
  • Output reviewer: Checks figures, status, and explanations.
  • Report approver: Authorizes the report for issue.
  • Technical contact: Manages connections, access, and technical problems.

One person may hold several roles. The team should also name a backup reviewer and someone authorized to pause the trial.

These responsibilities should fit existing project controls. The National Institute of Standards and Technology (NIST) AI governance guidance recommends documenting AI roles and connecting AI governance to existing risk controls.

Step 6: Assess the project team’s ability to review AI outputs

Intended users should review sample outputs against source records, using examples with known errors or missing information. The exercise should test whether reviewers can:

  • Interpret costs: Distinguish an approved budget increase from a forecast overrun.
  • Verify sources: Identify superseded drawings or records from another project.
  • Recognize uncertainty: Flag missing dates, unclear change order status, or unsupported explanations.

Mastt’s 2026 AI in construction research surveyed 108 construction project management professionals. Among respondents, 29.6% identified accuracy and trust as their biggest barrier to greater AI use.

The team should record missed errors, training needs, and the time available for practice. Early-career staff also need opportunities to learn the underlying work, including estimating and checking calculations. AI adoption in construction explores the wider people issues behind implementation.

Step 7: Assess costs and staff capacity around project deadlines

The team should prepare an estimate covering:

  • Setup: Preparing records, configuring exports or connections, and training reviewers.
  • Ongoing work: Updating inputs, checking outputs, correcting errors, and maintaining connections.
  • Tool charges: Expected costs across users, projects, and reporting cycles.
  • Staff availability: Reviewer capacity around reporting deadlines, site commitments, and leave.

The estimate should separate one-time costs from recurring charges and staff hours. Assigned staff should confirm their availability, and the pilot should have a spending limit and usage tracking.

Time-saving estimates should cover the complete task through to an approved output, including review and corrections.

Step 8: Define a trial using representative project conditions

The trial owner should document the project scope, authorized records, reviewers, test cases, and acceptance criteria before testing begins.

I have seen integration issues during testing and have been glad they occurred in a copy of the production environment. Testing on a copy gives the team a way to investigate and fix problems without changing live financial data. For more on choosing between real and test data based on risk, see lessons on adopting AI in construction.

For cost reporting, an authorized copy of a reporting pack could include pending change orders, outdated forecasts, and missing commentary. The trial owner and reviewers should agree on how to check:

  • Accuracy: Figures match source records, and pending changes remain distinguishable from approved amounts.
  • Uncertainty: Missing information and unsupported explanations are flagged.
  • Approvals: Draft outputs receive the required review before issue.
  • Value: Total preparation, review, and correction effort is measured against the baseline.

NIST’s AI Risk Management Framework measurement guidance recommends testing performance in conditions similar to where the system will be deployed.

The plan should define what results justify continuing, correcting, or stopping the trial, and who makes that decision. It should also explain how the team will complete the task through its existing process if testing is paused.

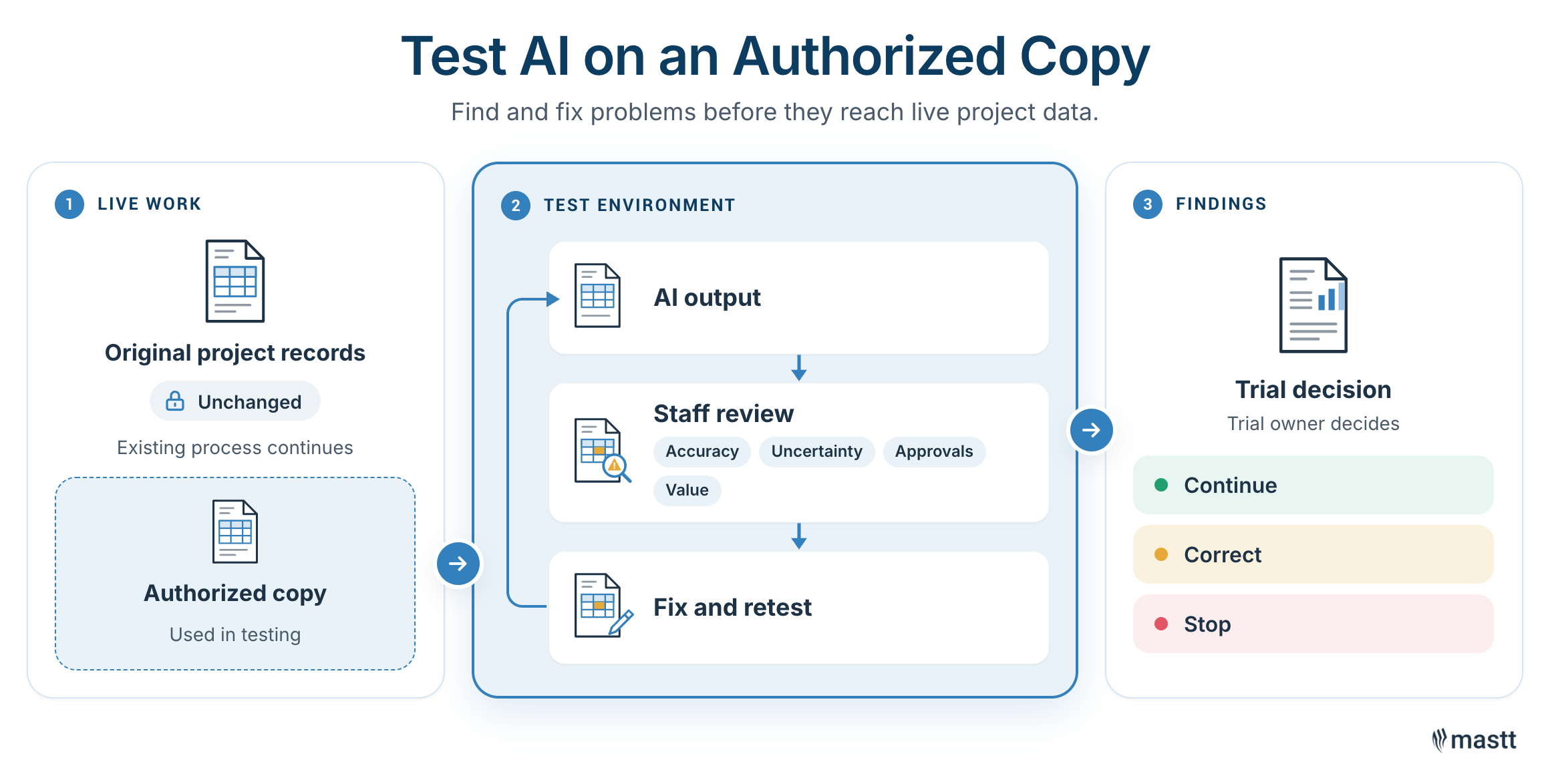

AI tested on an authorized project data copy during readiness assessment before use with live records.
Test AI on an authorized copy first during readiness assessment, review the output, then decide whether to continue, correct, or stop.

Common AI Readiness Gaps in Construction Teams

In my experience, AI pilots in construction run into trouble when costs, user interest, success measures, or data handling haven’t been checked first. Each of these gaps maps to a step in the assessment above:

  • Costs outrun the pilot budget: Early pilots can go over budget quickly, including token consumption charges. Projecting costs before the pilot starts, and using a sandbox where the use case allows it, keeps spending in check.
  • End users don't want the tool: A pilot needs innovation champions who are open to trying new tools and will share what works. Keeping sign-up open to any volunteer widens the group.
  • Success measures are never agreed: Set the metrics, and the person who judges success, from the start. Otherwise, the team can spin its wheels.
  • Data goes into tools unchecked: Before sharing, staff should confirm the information belongs in an AI tool and check the tool's data and training settings.

Most of these gaps come down to people and planning more than technology. Teams tend to focus on the technical side of a pilot, while culture and change management take longer to build. When a gap appears, I go back to the first question: what problem are we trying to solve, and why?

How to Interpret AI Readiness Assessment Results

The results should show whether the selected workflow can proceed to a controlled pilot and which gaps prevent it. The team should judge each gap against the pilot’s requirements and the consequences of an incorrect or unauthorized output.

The findings can support three practical outcomes:

Assessment outcome What it means Next action
Ready for a controlled pilot Evidence supports the proposed trial, with the required permissions, reviewers, and controls in place. Obtain approval and run the pilot within its agreed limits.
Preparation required Gaps prevent testing, but there is a workable way to resolve them within the proposed scope. Complete the required preparation and reassess before testing.
Reconsider the proposed use The current approach has no workable way to meet an essential requirement, such as authorized data access or reliable output review. Change the scope or approach, or select another use case.

Strengths in one area do not resolve weaknesses elsewhere. Reliable project data, for example, still needs permission for use and a qualified reviewer.

The third outcome can be hard to accept. I encourage teams to say no early when a use case isn't viable, rather than push it through.

AI Readiness Assessment Example: Project Cost Reporting

A project management consultancy is preparing to test AI-drafted commentary for its monthly cost reporting. In this hypothetical example, the tool would use a checked reporting pack to draft explanations for project manager review. Staff would retain responsibility for approving figures and issuing the report.

Assume the current process takes five staff-hours per report, including preparation, drafting, review, and corrections. The assessment identifies the following:

Assessment area Finding Action before the pilot
Purpose and measurement The task and baseline are defined, but the expected improvement is not. Agree on a time-saving target and report quality requirements.
Data One forecast is outdated, and the change register mixes approved and pending items. Update the forecast and clearly label change order status.
Permissions and systems The proposed export includes other clients’ records outside the trial scope. Prepare an authorized project-specific pack and test access restrictions.
Accountability and skills The project manager can review outputs, but leave cover is unclear. Assign a backup reviewer and check their capability through a practice exercise.
Costs and evaluation Subscription costs are known, but review and correction time remain uncertain. Establish how staff time and tool charges will be recorded during testing.

The assessment outcome is preparation required. Data corrections, access controls, and reviewer coverage need to be resolved before the pilot proceeds. The potential time savings remain a question for testing.

During the pilot, figures must match the checked pack, change order status must remain clear, and unsupported explanations or missing information must be flagged. Total time to produce an approved report would then be compared with the five-hour baseline and the agreed improvement target.

Keep the Assessment Current as Your AI Use Grows

A documented assessment gives a construction business a basis for deciding where to invest its effort. A clear explanation of what is ready, what needs attention, and why helps leaders and project teams agree on an achievable next step.

Keeping that assessment current makes progress visible. As the team builds skills, improves its data, and tests its systems, it gains evidence to support the next decision. Each review can show how its capacity to use AI is developing.

FAQs About AI Readiness Assessments

There is no fixed duration. A brief questionnaire may take minutes, while a detailed assessment requires interviews, evidence checks, and technical review. For a construction business, the schedule depends on the workflow’s complexity, access to project records, and reviewer availability.
Yes, depending on the task and tool. The company still needs someone responsible for source information and output review, with external technical support where needed. A limited off-the-shelf use case may be manageable without a dedicated data team.
Legacy systems do not automatically prevent AI use. The assessment should establish whether an authorized export, supported connection, or upgrade can meet the proposed workflow's requirements. Where a transition is needed, it can provide an opportunity to improve the company’s data environment with specialist support.
No. Readiness concerns the people, information, and systems needed for the selected task, including dependencies on other teams. A pilot can remain limited to one project or department while unrelated preparation continues elsewhere in the business.
AI readiness concerns whether the conditions are in place for a proposed use. AI maturity concerns how consistently the organization manages and improves AI over time. A construction business can be ready for a limited pilot while still developing broader AI capability.
