Data Center Design: Components, Process, and Best Practices

Data center design lays the foundation for reliable, efficient, and secure IT operations. Power systems, cooling, network infrastructure, security, and layout all need to be resolved before construction starts. This guide walks you through the key components of data center, standards, and planning steps.

TL;DR
Data center design covers power, cooling, network, security, and layout planning for IT facilities. The design determines most of the project cost and schedule before construction starts. Getting tier selection, cooling strategy, and equipment lead times right early prevents the most expensive changes later.

What is Data Center Design?

Data center design is the end-to-end process of planning a facility that can reliably house, power, cool, and protect IT equipment. It encompasses everything from data center building design to redundancy architecture, data storage provisions, and environmental controls.

The design phase in data center development is where the majority of the total project cost gets locked in. Early decisions on layout, capacity, and redundancy have lasting impacts on capital costs, operational efficiency, and future upgrade needs.

What are the Design Components of a Data Center?

Data center infrastructure spans seven core systems, including power infrastructure and the cooling system. Each affects the others and carries direct implications for project budget, schedule, and long-term operational cost.

Component What it covers
Power infrastructure Utility feeds, transformers, uninterruptible power supply (UPS) systems, backup generators, PDUs, redundancy switching
Cooling systems CRAC/CRAH, air economizers, liquid cooling (direct-to-chip, immersion), hot and cold aisle containment
Structural and civil Building envelope, raised floors, floor loading (100 to 300 lbs/sq ft), seismic and flood risk design
IT and network infrastructure Fiber backbone, copper cabling, rack layout, cable management, data storage systems
Fire detection and suppression NFPA 75/76 compliant suppression, clean agent systems (FM-200, FK-5-1-12), detection zoning
Security systems Multi-factor access control, CCTV, perimeter security, mantrap entries, physical security controls
BMS and DCIM Building management system, environmental monitoring, infrastructure management platform integration

These systems are interdependent. For example, rack layout affects airflow and cabling routes. That interdependency is why most costly design errors trace back to one system being designed in isolation from the others, making integrated construction management coordination essential.

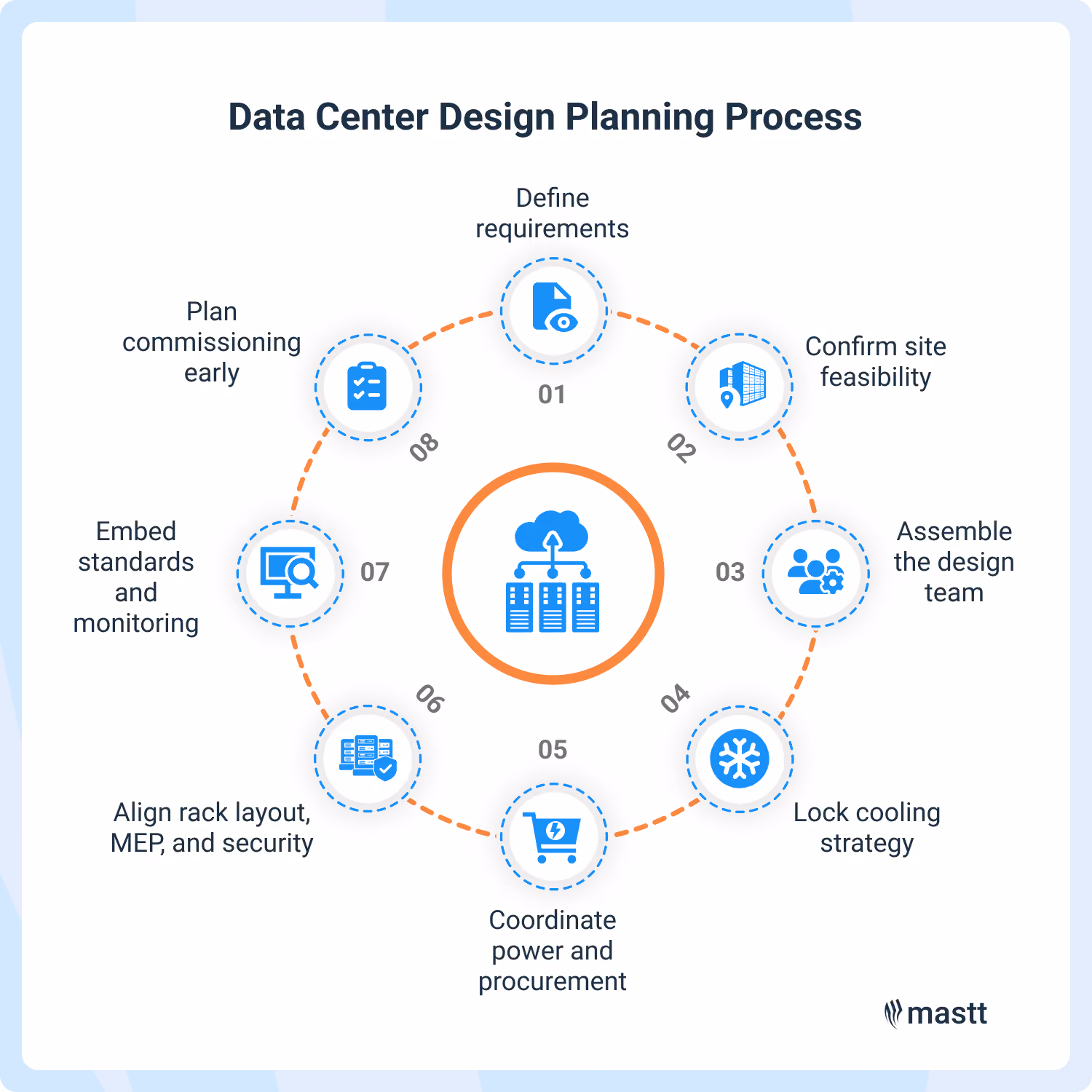

How to Plan a Data Center Design Process

Start planning the design of a data center by defining requirements and confirming site feasibility. The steps below follow the required sequence for these decisions.

Step 1: Define requirements before design starts

Document the IT load, tier target, site constraints, and budget range in an Owner's Project Requirements (OPR) document. Specify redundancy expectations for power systems and target Power Usage Effectiveness (PUE). Use the OPR to direct all subsequent design decisions.

Step 2: Select the site and complete the feasibility study

Confirm grid capacity before you commit to a site. Utility interconnection timelines often span 12 to 36 months. Address water access, local climate conditions, flood risks, and fiber connectivity during your site analysis.

Order a geotechnical survey to determine foundation requirements. Verify the site supports floor loads of 100 to 300 lbs per square foot.

Step 3: Assemble the design team early

Hire the architect, MEP engineer, commissioning agent, and cost planner. Bring the commissioning agent in at the start of the design phase. Ask them to review design documents for specification gaps and MEP coordination conflicts.

Include operations and facilities management personnel during design development. Ask them to identify maintenance access issues and control logic gaps.

Step 4: Lock in the cooling strategy before schematic design

Choose between air cooling and liquid cooling methods before structural design begins. This choice dictates structural loads, MEP layout, piping routes, and energy costs.

Specify air cooling for rack densities of 5 to 10 kW. Specify liquid cooling for high-performance computing workloads of 40 to 140 kW per rack. Changing the cooling strategy later forces a full MEP redesign.

Step 5: Coordinate power infrastructure and procurement early

Account for utility feeds, switchgear, UPS systems, and power distribution units (PDUs) in the design. Design the path from utility feed to rack-level distribution with redundancy appropriate to the target tier.

Build major equipment lead times into the project program. Factor in 12 to 52 weeks for switchgear and 16 to 40 weeks for transformers. Allocate 12 to 30 weeks for UPS systems and 20 to 40 weeks for backup generators.

Begin construction procurement during design development. Procure equipment early to hit the commissioning date.

Step 6: Coordinate rack layout with MEP and security design

Plan rack layout and cable routing alongside MEP systems. Confirm your fire suppression system selection in early design. Ensure the facility complies with NFPA 75 and NFPA 76 requirements.

Integrate physical security controls into the facility layout during design development. Map out access control, CCTV, mantrap configurations, and perimeter security.

Step 7: Build standards compliance into design documents

Assign compliance responsibility in the scope of work for each designer. Write BICSI-002 and TIA-942-C requirements into the basis of design. This provides a clear reference for reviewing substitutions during construction.

Specify BMS and DCIM integration during the design phase. Adding monitoring systems after construction increases installation costs.

Step 8: Plan for multi-level commissioning

Plan the structured sequence for data center commissioning during design. Schedule factory acceptance testing, site installation verification, system integration testing, and operational acceptance.

💡 Pro Tip: Build a long-lead equipment tracker on your construction project scheduling software during schematic design. Map each major item to its confirmed lead time and required on-site delivery date. Work backward from the planned commissioning date to verify the procurement schedule is achievable.

What are Data Center Tiers and Why Do They Matter for Design?

The Uptime Institute Tier Standard classifies data centers by availability target and redundancy level. The tier selected determines design complexity, equipment quantities, and total project cost.

Tier Redundancy What it means for the project
Tier I (99.671%) N, single path Single power and cooling path. Lowest capital cost. No maintenance without downtime.
Tier II (99.741%) N+1 components, single path Redundant components on a single distribution path. Moderate cost increase over Tier I.
Tier III (99.982%) N+1, concurrently maintainable Any component can be serviced without interrupting operations. Industry baseline for enterprise and colocation.
Tier IV (99.995%) 2N, fully fault-tolerant Dual independent paths for every system. Full system failure cannot interrupt operations. Adds roughly 40 percent to capital cost over Tier III.

Each step up in tier adds more equipment, more space, and more time to design and commission. That cost compounds quickly. Moving from Tier III to Tier IV after design has started typically adds 40 percent to capital cost and 3 to 6 months to the schedule. This is why tier selection needs to happen during preconstruction feasibility, before the design team is engaged.

💡 Pro Tip: Lock in the tier target as part of your project governance framework and Owner's Project Requirements (OPR) before engaging the design team. Once structural and MEP systems are designed to a specific tier, changing it requires a full redesign of the affected systems.

What Design Standards Apply to Data Centers?

Data center design requires compliance with specific industry frameworks, such as ANSI/BICSI 002-2024, ANSI/TIA-942-C, and the Uptime Institute Tier Standard. The table below summarises what each standard covers.

Design Standard What it covers
ANSI/BICSI 002-2024 Full facility design including structural, power, cooling, cabling, fire, and security
ANSI/TIA-942-C (2024) US commercial standard with four redundancy ratings (R1 to R4) that drive MEP system design
Uptime Institute Tier Standard Availability and redundancy benchmarks with optional third-party certification
NFPA 75 and NFPA 76 US fire protection requirements for IT equipment and telecommunications facilities
ASHRAE TC 9.9 Thermal guidelines for IT equipment temperature and humidity ranges (Class A1 to A4)
EN 50600 Series European data centre standards for efficiency, resilience, and security

Each applicable standard should be assigned to a specific designer's scope and written into the basis of design before design development starts. Standards that only appear in project specifications are easier to overlook during substitutions and value engineering.

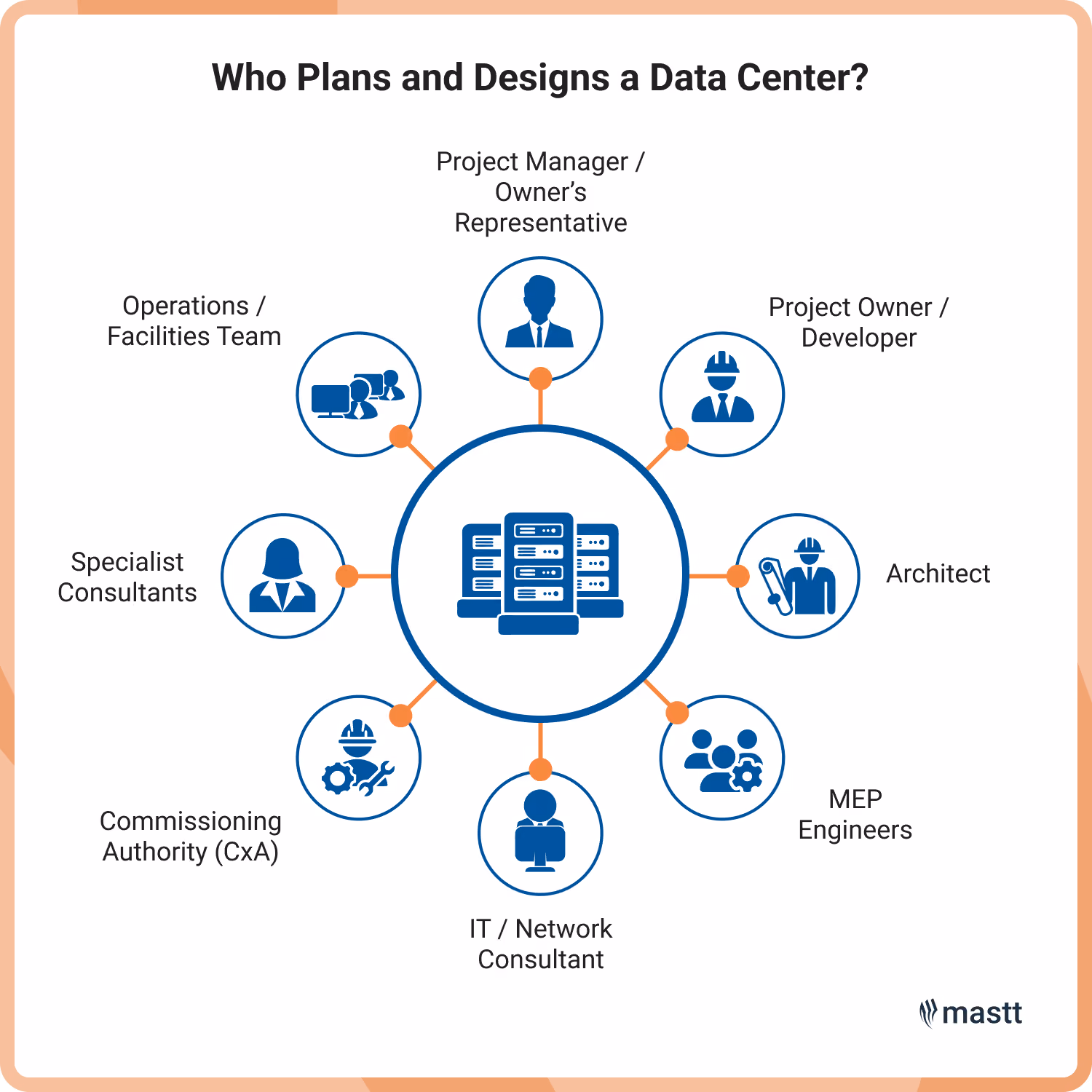

Who's Involved in Data Center Design?

Designing data center requires coordination across more specialist disciplines than most construction projects. The PM's job is to keep these stakeholders aligned on scope, schedule, and design intent throughout the design phases.

  • Project owner or developer: Sets the facility requirements, approves the target tier and budget, and signs off at each review gate. Their decisions on tier and capacity drive the entire project scope.
  • Project manager or owner's representative: Coordinates all parties, manages review gates, and tracks design deliverables and budget. A project management consultant often fills this role on large data center programs.
  • Architect: Handles the building envelope, spatial layout, code compliance, and coordination with local planning authorities. Active from concept through construction documents.
  • MEP engineers: Design the power distribution, cooling systems, fire protection, and plumbing. This is the largest design scope in a data center, and MEP coordination drives most of the design schedule.
  • IT and network consultant: Defines structured cabling, rack layout, connectivity requirements, and carrier coordination. Must be engaged from schematic design to avoid late-stage network conflicts.
  • Commissioning authority (CxA): Reviews design documents for testability and commissioning readiness. Should be engaged by the 60% design stage at the latest.
  • Specialist consultants: Includes acoustics, security, sustainability (LEED), and geotechnical specialists. Their involvement depends on site conditions and owner requirements.

The challenge for PMs is that these disciplines are deeply interdependent. A change in the cooling topology affects structural loads, electrical capacity, and plumbing routes simultaneously. Effective coordination reduces operational cost during construction and prevents rework.

Common Challenges in Designing a Data Center and How to Avoid Them

One of the most common challenges in designing data center is underestimating the complexity of interdependent infrastructure systems. Avoid this by running integrated design reviews at every project gate. The table below lists these common design mistakes and their specific solutions.

Common mistake How to avoid it
❌ Selecting the tier classification too late in the process. ✅ Lock the tier decision before schematic design begins. It affects every system's redundancy, cost, and schedule.
❌ Treating design disciplines in silos. ✅ Run integrated design reviews at every gate. Power, cooling, and structural teams must coordinate on shared constraints.
❌ Ignoring long-lead equipment in the design schedule. ✅ Identify switchgear, generators, and cooling units with 26 to 52 week lead times at the early design phases.
❌ Skipping commissioning planning until construction begins. ✅ Engage the commissioning authority (CxA) at 60% design to review Cx scope and write test scripts.
❌ Under-sizing power and cooling for AI and GPU workloads. ✅ Design for 40 to 100 kW per rack if the facility will support AI. This changes structural loads, cooling topology, and electrical room sizing.
❌ No formal design change process. ✅ Establish a design change orders workflow with cost and schedule impact assessment before approving any changes.
❌ Overlooking permitting timelines. ✅ Map regulatory approvals (zoning, environmental, building permits) into the design schedule from day one.

The common thread across these mistakes is that design decisions are deeply interconnected. A late tier decision, a missed lead time, or an uncoordinated discipline review can cascade into months of delay. Using a structured project controls approach helps contain these risks.

Best Practices in Designing Data Centers

Good data center design comes down to planning early, coordinating across disciplines, and making infrastructure decisions that account for future growth. These six practices help project managers protect long-term facility performance during the design phase.

☑️ Right-size the facility using realistic growth projections: Oversizing wastes capital. Undersizing forces costly retrofits within years of commissioning.

☑️ Design for modular expansion: Modular approaches allow incremental growth without disrupting live operations and support stronger construction risk management.

☑️ Target energy efficiency from the start: Aim for a PUE below 1.4 by incorporating free cooling, economizers, and renewable energy sources where feasible.

☑️ Run clash detection across all disciplines at every review gate: MEP and structural clashes found during construction cost far more to fix than those caught in construction drawings.

☑️ Document every design decision and its rationale: When value engineering discussions happen, the original rationale prevents unnecessary rework.

☑️ Build flexibility into power and cooling architecture: Scalable UPS, containment strategies, and adaptable cooling give the facility room to handle changing workload densities over its lifetime.

These are especially important for sustainable data center. Energy efficiency targets and environmental controls must be embedded in the design from the start. Operational efficiency in facilities management over the facility's lifespan depends on decisions made during this phase.

Design Trends Shaping Modern Data Center

Modern data center is evolving rapidly, driven by AI in construction trends, sustainability mandates, and new construction methods. PMs planning data center projects today need to account for these shifts in their design requirements and procurement timelines.

Cloud computing growth, edge computing deployments, and edge data center construction are also expanding the range of facility types PMs may encounter.

PMs using capital project management software today need to account for these shifts in their design requirements and procurement timelines. Each technological advancement adds new design variables that did not exist five years ago.

Early Design Decisions Drive Better Data Center Outcomes

Data center projects demand technical clarity early. Defining requirements upfront and confirming tier puts teams in a stronger position to protect cost, delivery, and long-term performance. For project managers planning a new facility or expansion, this is where better outcomes start.

FAQs About Data Center Design

A standard enterprise facility typically takes 12 to 18 months from OPR development through to construction-ready documentation. Hyperscale and Tier IV projects often run 18 to 24 months in project planning. The most common causes of overruns are late tier decisions, cooling strategy changes after structural design has started, and permitting delays.
Tier selection has the broadest impact on design complexity, project cost management, and schedule. It determines redundancy levels across every data center infrastructure system and drives MEP system sizing. Different data centers require different redundancy approaches, so tier selection made during feasibility prevents the most expensive redesigns.
A Tier III facility requires N+1 redundancy with concurrent maintainability. A Tier IV facility requires 2N fault tolerance. Tier IV requires dual, fully independent infrastructure paths for every system, which typically adds 40 percent to capital project management costs and considerable complexity to commissioning.
Air cooling costs less upfront but reaches efficiency limits above 15 to 20 kW per rack. Liquid cooling costs more to install but operates more efficiently at high densities. For AI environments, the higher capital cost is typically offset by operating savings within 3 to 5 years.
Yes, and the commissioning agent should be engaged at the start of design, not at the end of construction administration. A commissioning agent who reviews design documents will identify specification gaps, MEP coordination conflicts, and control logic errors before they become site problems.
