What Is FF&E in Construction: Scope, Schedule and Procurement

Gordon Grover
Post author:
Gordon Grover
Doug Vincent
Contributor:
Doug Vincent
Jackson Row
Reviewed by:
Jackson Row
Published:
Jul 15, 2026
What Is FF&E in Construction: Scope, Schedule and Procurement

FF&E in construction refers to all the furniture, fixtures, and equipment needed to make a completed building ready for use. Although these items often sit outside the main construction contract, they can still affect the budget, design, schedule, and opening date.

Getting FF&E right means knowing what counts as FF&E, who owns each item, and what the schedule must track. It also means managing procurement, lead times, installation, medical equipment planning, and handover so the building can open and operate as intended.

TL;DR
FF&E in construction means Furniture, Fixtures, and Equipment, which are needed to make a completed building usable. Though often outside the main construction contract, it can affect the budget, program, and opening date. Plan it early, assign procurement and installation, and track lead times in the master program.

What Is FF&E in Construction?

FF&E in construction stands for Furniture, Fixtures, and Equipment. It is a project scope category covering the items needed to furnish, equip, and complete the fitout of a facility so it is ready for use. These items often sit outside the main construction contract, although some connect to building services or require contractor support.

Furniture and fixtures generally cover movable items used within a space, while equipment includes the operational and technical assets needed to run it. Still, an item is not classified as FF&E solely because it is movable. Its classification is defined by the construction contract, specifications, and FF&E schedule.

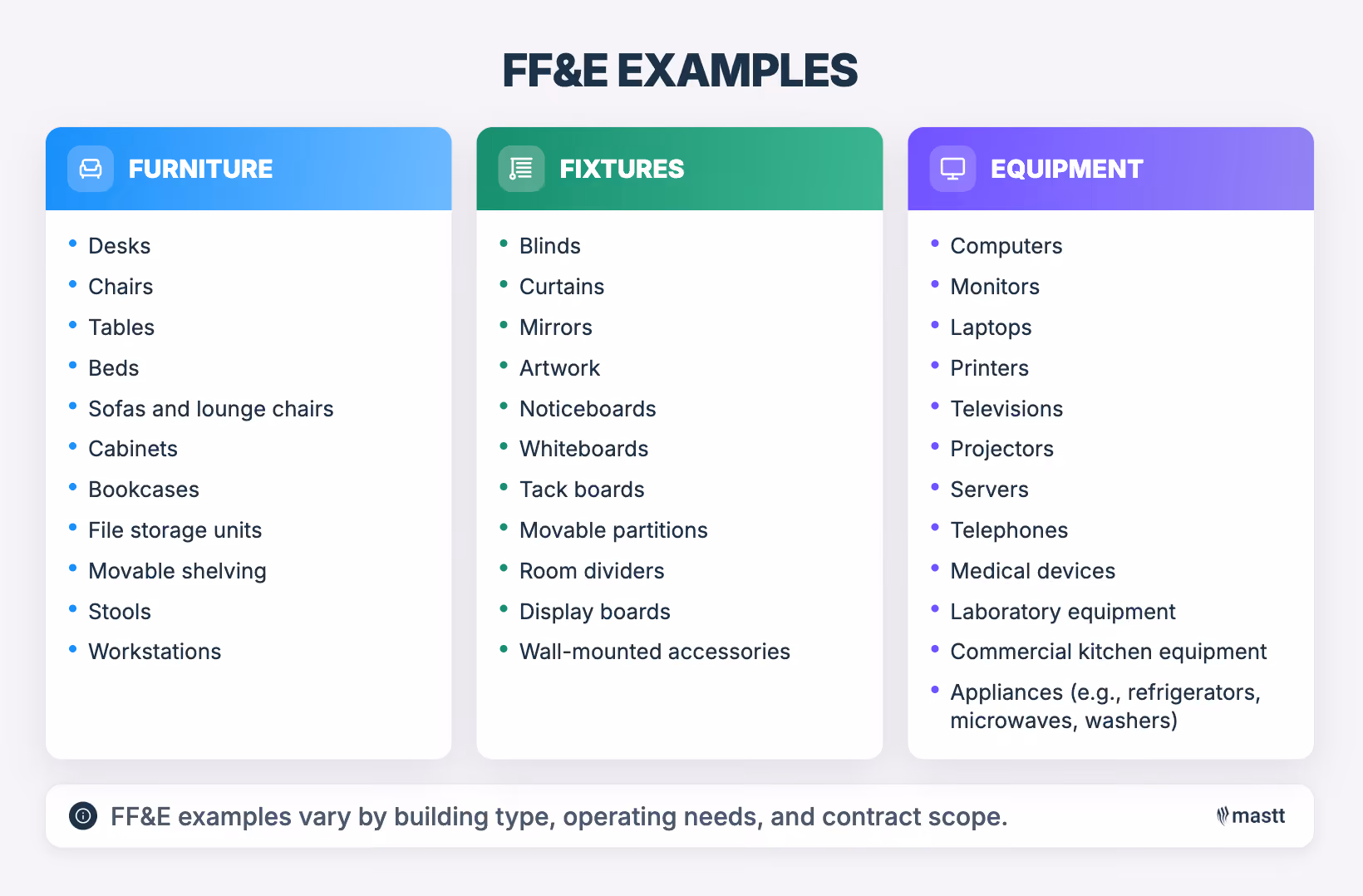

Infographic showing examples of furniture, fixtures, and equipment.
FF&E can include movable furniture, interior fixtures, and operational equipment. The exact items included depend on the building’s purpose, operational needs, and contract scope.

How Are FF&E Items Classified?

Project teams may classify FF&E as fixed or loose based on how each item relates to the building. In healthcare construction projects, for example, major medical equipment may be tracked separately because it brings greater technical, procurement, and commissioning demands.

Classification What It Usually Means Items That May Fall Into This Category
Fixed equipment Equipment attached to the building or dependent on permanent supports, services, or connections Sterilizers, mounted clinical equipment, fixed laboratory equipment, and selected commercial kitchen units
Loose equipment Movable items that can be placed, removed, or replaced without major building work Desks, chairs, movable beds, computers, portable devices, and loose storage
Major medical equipment High-value or technically complex healthcare equipment that needs early planning and specialist support MRI machines, CT scanners, and specialist equipment used in theatres or medical imaging spaces

These labels help assign responsibilities, but they are not universal and often overlap. The contract and FF&E schedule should define how each classification applies and who is responsible for each item.

What Items Are Included in an FF&E Package?

An FF&E package may include furniture, room fittings, technology, appliances, specialist equipment, and everyday accessories. The final list depends on how each space will be used, along with the building type, owner standards, tenant needs, existing assets, and agreed scope.

Specific examples of FF&E fall into the following categories:

FF&E Category Common Examples
Furniture Desks, chairs, tables, beds, sofas, cabinets, and movable shelving
Room fixtures and fittings Blinds, curtains, mirrors, artwork, noticeboards, and movable partitions
Technology equipment Computers, monitors, printers, televisions, servers, and phone systems
Appliances Refrigerators, microwaves, washing machines, and other freestanding units
Specialist equipment Medical devices, laboratory equipment, teaching equipment, and commercial kitchen units
Room accessories Bins, clocks, loose storage, and other movable items needed for daily use

An office may focus on workstations and meeting-room technology. A hospital may need patient furniture, clinical devices, and department-specific medical equipment. The package may also cover reused assets, tenant-supplied items, and equipment bought through existing supplier agreements.

What Does Not Count as FF&E?

Items that are permanently built into the property do not count as FF&E. They are typically included in the base building or project scope, installed during the main build, and intended to remain in place for the life of the structure.

Common examples of items that are not counted as FF&E include:

  • Built-in cabinets and fixed casework
  • Toilets, sinks, faucets, and other plumbing fixtures
  • Hardwired lights and electrical fittings
  • Air conditioning and ventilation equipment
  • Doors, frames, and fixed walls
  • Permanent floor, wall, and ceiling finishes
  • Beams, columns, and other structural parts
  • Fixed power, data, water, gas, and fire services

Unlike FF&E, which can be moved, replaced, or upgraded without major work, these elements are fixed components of the building itself. The difference can be confusing, but the way an item is installed usually helps determine where it belongs.

For instance, a freestanding refrigerator may count as FF&E, while a built-in unit may form part of the joinery package. A table lamp may be FF&E, while a hardwired light will usually sit within the electrical scope. Movable shelving may be FF&E, while built-in shelving may form part of the fixed fit-out.

Why Does FF&E Matter to Project Owners and Project Managers?

FF&E is important because it determines whether a completed building can operate as intended from day one. When not carefully planned, costs can escalate, and procurement timelines can slip. These challenges often extend the gap between practical completion and the point at which the facility is truly ready for use.

Key areas where FF&E impacts project outcomes include:

  • Total project cost: FF&E may sit outside the main construction contract, but it still requires funding within the overall project budget.
  • Opening date: Late equipment or furniture can delay occupancy even when the building work is complete.
  • Space functionality: Missing or unsuitable items can prevent a room from supporting its intended use.
  • Operational readiness: Equipment may need installation, testing, and acceptance before staff can begin using the space.
  • Long-term asset control: Clear records help the owner manage warranties, maintenance, replacement dates, and future upgrades.

For project owners and project managers, the main challenge is making sure FF&E does not become an afterthought. It needs to be planned alongside the design, budget, and program so the facility can open and operate as intended.

Who Is Responsible for FF&E in Construction?

FF&E responsibilities are shared across the owner, project team, contractor, suppliers, and end users. The contract and FF&E schedule should state who specifies, approves, buys, installs, tests, and accepts each item.

The following parties usually have a role in managing the FF&E package:

  • Project owner: Defines the operating needs, approves the budget, authorizes purchases, and accepts the completed FF&E package.
  • Project manager or owner’s representative: Coordinates the parties, manages approvals, tracks costs and lead times, and keeps the FF&E schedule current.
  • Architect or interior designer: Prepares layouts, specifications, finishes, and room information so each item fits the approved design.
  • Equipment planner or specialist consultant: Reviews technical equipment, supplier data, building connections, installation needs, and commissioning requirements.
  • Contractor: Provides access, supports, power, data, plumbing, protection, positioning, or installation where the contract assigns those duties.
  • Supplier or manufacturer: Provides product data, delivery updates, specialist installation, testing, warranties, and staff training where required.
  • Operator, tenant, or end user: Confirms how the space will be used and checks that the selected items meet daily operating needs.
  • Facilities team: Reviews maintenance needs, asset information, spare parts, warranties, and long-term replacement requirements.

In my experience, fixed equipment is more likely to sit with the contractor, while loose and major medical equipment usually remains with the client. The contractor may still provide the infrastructure or move the equipment into position, so those duties must be assigned item by item.

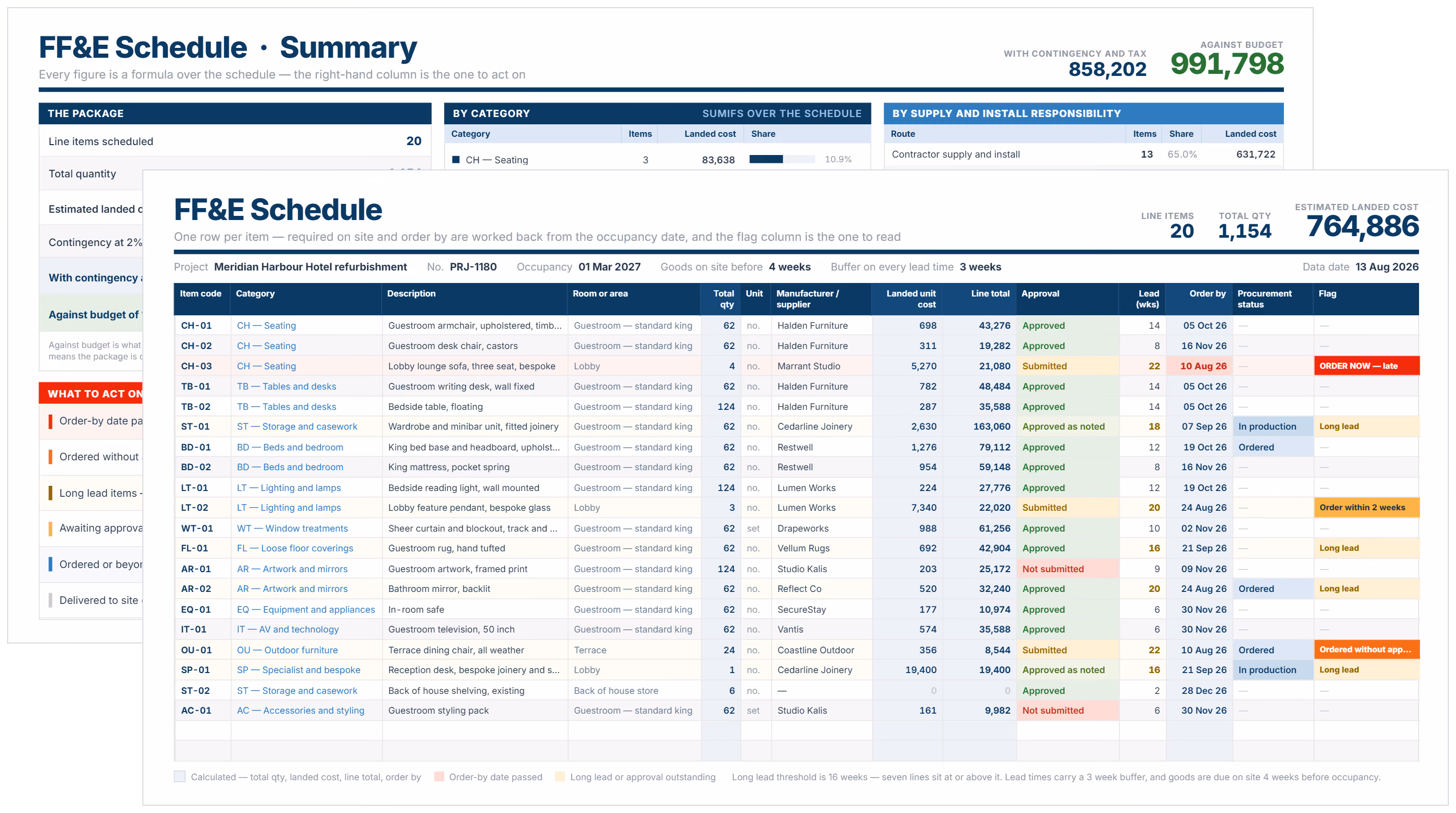

What Should an FF&E Schedule Include?

An FF&E schedule should record the information needed to design, buy, deliver, install, and hand over every item. It should also make responsibility clear at each stage, especially when the owner and contractor manage different parts of the work.

The exact fields will vary by project, but a practical schedule should include the following:

FF&E Schedule Field What It Records
Item ID A unique reference for tracking the item across drawings, budgets, and reports
Item description A clear name and short description of the furniture, fixture, or equipment
Category Whether the item is furniture, loose equipment, fixed equipment, or major equipment
Building, floor, and room The exact location where the item will be used
Quantity The number of units required in each location
Approved model or specification The selected product, performance requirements, dimensions, and finishes
Supplier or manufacturer The company providing the item and its technical information
Procurement responsibility The party responsible for purchasing the item
Installation responsibility The party responsible for positioning, connecting, or installing it
Building service requirements Any power, data, water, drainage, ventilation, structural support, or access needs
Budget and committed cost The approved allowance and the value of placed orders
Lead time The expected period for approval, production, and shipping
Required-on-site date The date the item must reach the project or storage location
Delivery and storage status Whether the item is ordered, manufactured, shipped, stored, or delivered
Commissioning and acceptance Who tests the item and confirms it is ready for use
Handover documents Warranties, manuals, serial numbers, training records, and asset data

The most important entries are the procurement and installation responsibilities. We use the FF&E schedule to show who buys each item and who installs it, since those duties often fall to different parties.

How Does FF&E Procurement Work?

FF&E procurement starts once the project team has confirmed what it needs, when each item is required, and who will buy it. The process then covers market engagement, supplier selection, ordering, delivery tracking, inspection, and final acceptance.

Step 1: Confirm the FF&E requirements

Finalize the item description, quantity, approved model, performance needs, budget, and required delivery date. The project team should also confirm any installation, service, access, and commissioning requirements before approaching suppliers.

On specialist healthcare projects, I engage the operator or tenant early to confirm the equipment model and obtain the supplier's technical information, so the design can be set before the equipment is ordered.

Step 2: Choose the procurement route

Select a route that matches the item’s value, complexity, and level of design detail. The main options are a Request for Proposal (RFP), a competitive tender or bid, a direct purchase, or an existing supplier agreement.

An RFP allows suppliers to propose products and service packages in response to an operational need. Competitive bidding works better when the specification is already clear. Direct purchase may suit proprietary products, replacement equipment, or assets available through an existing agreement.

Major medical equipment is often purchased by the client or tenant rather than the contractor. Some organizations already have agreements with selected manufacturers, so the project team needs to identify these arrangements early.

Step 3: Issue clear procurement documents

Give each supplier enough information to price the same scope. The package should include the approved specification, quantity, location, delivery date, installation duties, warranty terms, and required technical documents.

For complex equipment, include the relevant room layouts and service drawings. Suppliers should identify any power, data, cooling, structural, access, or maintenance needs that differ from the current design.

Step 4: Evaluate and select the supplier

Compare each submission against the approved specification and project needs. Price matters, but the assessment should also cover product compliance, lead time, technical support, installation ability, warranty terms, and supplier experience.

For high-risk projects, I place greater weight on whether the supplier or delivery team has handled similar equipment before. Their submission should show that they understand the technical and operational risks, rather than simply offering the lowest price.

Any proposed alternative should be checked against the room design and service requirements before approval. A cheaper substitute can create extra construction work if its dimensions or connections differ.

Step 5: Place and manage the order

Issue the purchase order only after the product, scope, price, responsibilities, and delivery terms are agreed upon. Record the production period, shipping date, storage plan, required-on-site date, and payment milestones.

Some major equipment has such a long lead time that the client must order it before appointing the contractor. I include the lead time in the master program because late equipment delivery can delay the contractor and incur additional costs for the client.

The team should continue checking supplier data during production. Approved changes must reach the designers and contractor before they affect the room or supporting services.

Step 6: Inspect and accept the items

Check the item against the purchase order when it reaches the agreed delivery or storage location. Confirm the model, quantity, condition, serial number, accessories, and required documents.

Record damage, missing parts, or specification differences before signing an unconditional delivery receipt. The team should also confirm where responsibility sits while equipment remains in off-site storage.

Some specialist equipment may stay in storage until the room is ready, then arrive near the end of construction or after practical completion. Final acceptance should follow installation, testing, commissioning, and any required staff training.

💡 Pro Tip: Build a hold point into the purchase order so the supplier cannot start manufacturing until the design team signs off on their final technical drawings. That single gate catches model changes while they are still free to fix, not after the room is built.
Infographic showing the six steps in the FF&E procurement process.
FF&E procurement covers planning, supplier selection, ordering, delivery, and acceptance, with lead times tracked in the master program.

How Is Medical Equipment Planning Different from Standard FF&E?

Medical equipment planning is more technical because the selected equipment can shape the room, building services, program, and commissioning work. Standard FF&E usually adapts to the finished space, while major medical equipment often needs the space designed around it.

The table below shows how the planning process differs at each stage.

Planning Stage Standard FF&E Medical Equipment Planning
Defining the room's purpose Confirm how people will use the space and what furniture or equipment they need. Start with the clinical purpose of the room, since a ward, theatre, imaging unit, and sterilizing department have different equipment needs.
Confirming the product Select products based on the approved layout, budget, and user requirements. Confirm the exact equipment model early and obtain operation and maintenance manuals and design information from the manufacturer.
Coordinating the design Check that items fit the room and suit the layout, finishes, and access. Design the room and building services around the selected equipment model.
Planning procurement Place orders based on supplier lead times and the required delivery date. Add major equipment lead times to the master program, since orders may be needed before the contractor is appointed.
Assigning responsibilities Record who purchases, delivers, installs, and accepts each item. Separate client procurement from contractor duties such as preparing infrastructure, bringing the equipment into the building, and positioning it.
Preparing for installation and commissioning Arrange delivery, assembly, placement, and testing where required. Coordinate ICT, building systems, backup power, supporting infrastructure, and how the equipment will be commissioned.

The key difference is that major medical equipment should be managed as a dedicated project workstream. It requires earlier decisions, closer input from operators and suppliers, and ongoing coordination between the design team, contractor, and commissioning specialists.

FF&E Mistakes that Delay Project Completion and How to Control Them

The most common FF&E mistakes are late decisions, unclear responsibilities, missed lead times, and poor coordination with the building design. These gaps can delay installation, hold up the contractor, or leave completed rooms unable to operate.

The table below shows the main risks and the controls needed for each one.

FF&E Mistake Recommended Control
⚠️ Confirming equipment too late ✅ Set equipment approval dates during design and obtain supplier data before services are finalized.
⚠️ Leaving responsibilities unclear ✅ Record procurement and installation responsibility separately in the FF&E schedule.
⚠️ Missing long lead times ✅ Confirm order-by dates during design and track them against the program.
⚠️ Skipping end-user review ✅ Hold design review workshops and obtain clear written approval before procurement.
⚠️ Accepting substitutions without a full review ✅ Check every substitute against the latest room layouts, specifications, and service drawings.
⚠️ Failing to coordinate building systems ✅ Review supplier requirements with the design team before construction locks in the services.
⚠️ Delivering equipment before the room is ready ✅ Confirm storage, delivery routes, room readiness, and installer access before releasing the item.
⚠️ Treating practical completion as operational readiness ✅ Allow a separate commissioning period before the room or facility becomes operational.

On complex health projects, we keep risk as a standing item in design, client, user group, and construction meetings. Major FF&E responsibility issues can be avoided by developing a clear schedule that identifies who procures and installs each item.

Turning a Finished Building into a Working One

FF&E is what separates a building that looks finished from one that can actually open. Plan it early, fund it in the budget, and carry the lead times in the master program, and handover becomes a smooth part of the job. The FF&E schedule is what gets you there. Keep it current and name who procures and who installs each item, so the gaps that delay openings never appear.

FAQs About FF&E in Construction

Fit-out is the work that turns a bare building into a usable space, including partitions, finishes, and building services. FF&E is the movable furniture, fixtures, and equipment added to complete that space. Fit-out is usually delivered under a construction contract, while FF&E is often procured separately by the owner.
FF&E runs alongside construction rather than only at the end. Specification starts in design, procurement runs in parallel with the build to absorb long lead times, and delivery and installation cluster in the final weeks before handover. Planning it this way stops late furniture or equipment from delaying occupancy.
MEP covers the mechanical, electrical, and plumbing systems built permanently into the structure, such as HVAC, wiring, and pipework. FF&E covers the movable items that sit within the finished space. The two must be coordinated, since equipment like medical devices often relies on MEP connections such as power, data, and drainage.
For small or simple projects, the design team and project manager can usually manage FF&E. On large, complex, or healthcare projects, a dedicated FF&E consultant or equipment planner helps control specification, procurement, and installation across hundreds of items. They reduce the risk of missed lead times and coordination gaps that hold up the opening.
