Anticipated Cost Report: Easy Guide for Construction Projects

An anticipated cost report shows the expected total cost of a construction project based on current information. It helps project teams understand how project costs are likely to land if current conditions continue.

In this guide, you’ll learn how an anticipated cost report works, what information it includes, and how construction teams use it for cost reporting and cost control.

TL;DR
An anticipated cost report is a construction cost reporting tool that forecasts a project’s expected final cost using the current budget, committed costs, and projected remaining work. It gives project teams early visibility into cost exposure. When updated regularly, it supports timely decisions and stronger cost control.

What is an Anticipated Cost Report?

An anticipated cost report (ACR) is a forward-looking cost reporting document used to forecast the expected final cost of a construction project. It takes your current actual costs and adds all committed expenses, approved change orders, and estimated costs for remaining work to show your projected final budget.

An anticipated cost report focuses on cost exposure and future outcomes. It includes signed subcontract agreements, pending change orders awaiting approval, and the estimated cost to complete work that has not yet been contracted.

Anticipated Cost vs Standard Cost Report: What’s the Difference?

An anticipated cost report focuses on forecasting the expected final cost of a construction project based on current conditions. A standard cost report focuses on tracking what has already been spent and committed at a specific point in time.

Area Anticipated Cost Report Standard Cost Report
Primary purpose Forecast the expected final project cost Track costs incurred to date
Time focus Forward-looking Historical
Cost types included Actual costs, committed costs, projected remaining costs, potential change orders Actual costs and committed costs
Risk visibility Highlights future cost exposure Limited insight into future risk
Typical use Cost control and forecasting Financial tracking and reporting
Common users Project managers, program managers, owners Accounting teams, project controls

The key difference is timing. Anticipated cost reports look ahead, while standard cost reports look back.

💡 Pro tip: When reviewing project health, use both reports together. Start with the standard cost report to confirm cost accuracy, then use the ACR to assess whether current commitments and pending changes will exceed the approved budget. This sequence helps catch overruns early, before they appear on invoices.

What is Included in an Anticipated Cost Report?

An anticipated cost report pulls together budget, cost, and forecast data to show the expected financial outcome of a construction project. It reflects both what has already happened and what is still likely to occur based on current commitments and remaining work.

Here's what makes up an anticipated cost report:

  • Original budget: The approved baseline budget established at the start of the project, used as the reference point for all cost comparisons.
  • Current or revised budget: The original budget adjusted for approved scope changes, budget transfers, and authorized revisions.
  • Committed costs: The total value of executed contracts, subcontracts, and purchase orders, including approved change orders.
  • Actual costs to date: Costs that have already been incurred and recorded, such as labor, materials, and subcontractor invoices.
  • Projected remaining costs: Estimated costs to complete work that is not yet fully billed or contracted.
  • Potential change orders: Pending or anticipated changes that may affect the final cost if approved.
  • Anticipated total cost: The combined view of actual costs, committed costs, and projected remaining costs.
  • Cost variance: The difference between the current budget and the anticipated total cost, used to identify overrun or underrun risk.

The level of detail varies by project size and complexity. A small renovation might track costs in a few major categories, while a large commercial construction project breaks down anticipated costs by cost account, trade, or building system. Your report should match the level of detail your project team needs to make informed cost-control decisions.

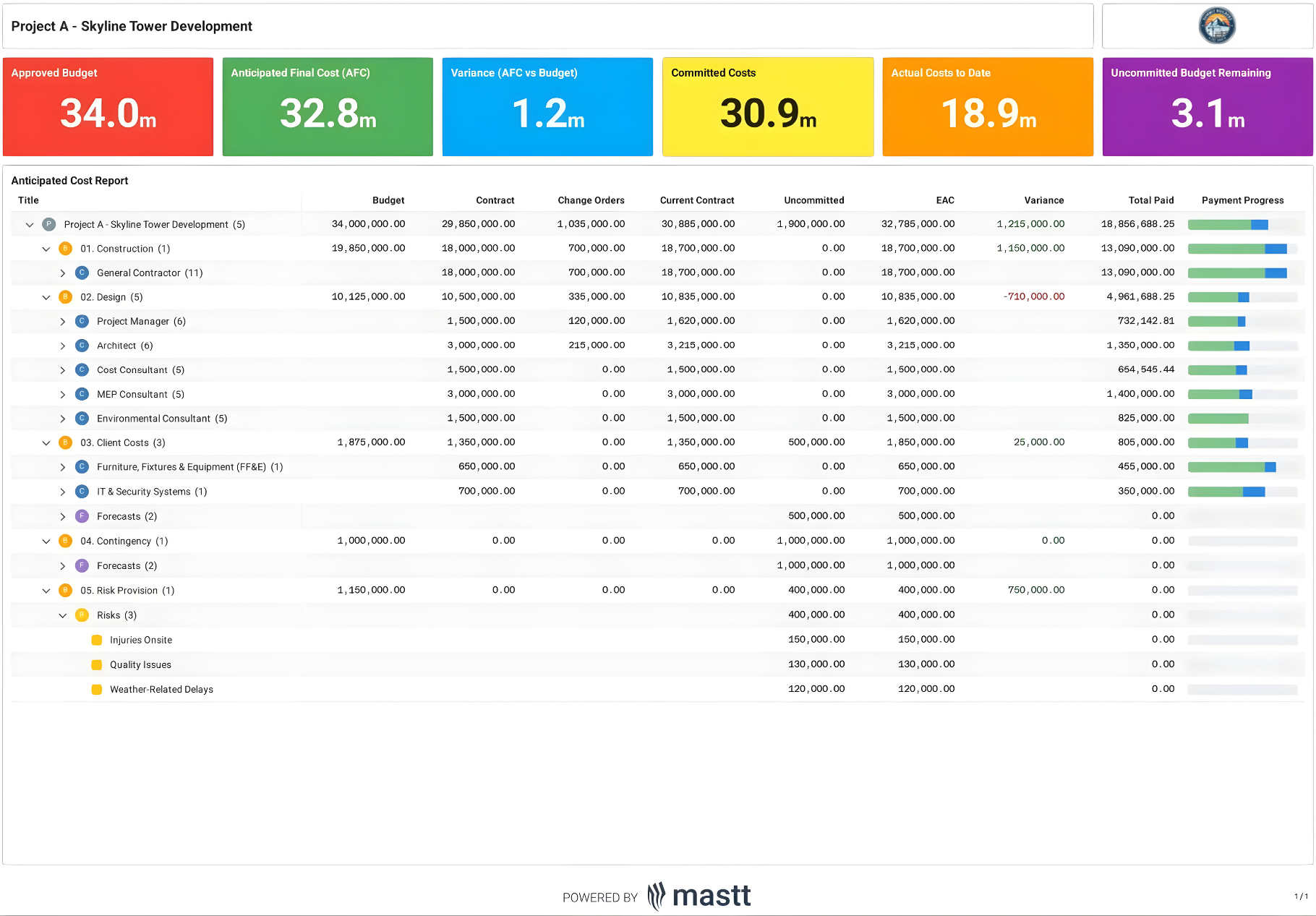

Anticipated cost report dashboard showing approved budget, anticipated final cost, variance, committed costs, actual costs to date, and detailed cost breakdown by code.
Example of anticipated cost report showing how budget, commitments, and forecasted final cost are tracked across project cost codes.

How are Anticipated Costs Calculated?

You compute anticipated costs by adding your actual expenses to all committed future costs and estimates for remaining work. Anticipated cost calculations are typically broken into two parts: budget calculations and cost calculations.

1. Budget Calculations

Your budget calculations show how much money you have available to spend. Start with your original budget and add approved changes:

Revised Budget = Original Budget + Approved Revisions

This gives you your current authorized budget based on approved scope changes. Then add pending approvals to see your full potential budget:

Anticipated Budget = Revised Budget + Approvals Pending

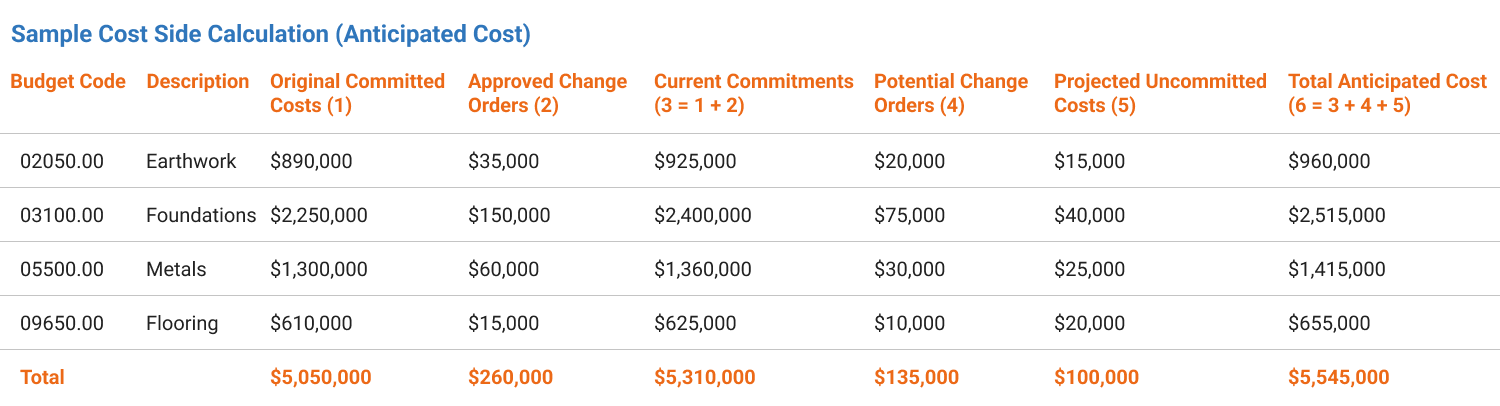

Sample cost side calculation table showing committed costs, change orders, projected uncommitted costs, and total anticipated budget.

2. Cost Calculations

Your cost calculations show how much you expect to spend. First, calculate your current commitments:

Current Commitments = Original Committed Costs + Approved Change Orders

This captures all costs you're legally obligated to pay. Then add potential changes and remaining work:

Total Anticipated Cost = Current Commitments + Potential Change Orders + Projected Uncommitted Costs
Sample cost side calculation table showing committed costs, change orders, projected uncommitted costs, and total anticipated cost by budget code.

3. Calculate Your Variance

Compare your anticipated budget to your anticipated cost:

Variance = Anticipated Budget - Anticipated Cost

A positive variance means you're projected to finish under budget. A negative variance signals an overrun that needs attention.

These calculations are usually performed at the cost code or cost account level, then rolled up to show the overall project position. Accuracy depends on keeping commitments, pending changes, and remaining cost estimates current as the project evolves.

How to Prepare an Anticipated Cost Report?

Preparing an anticipated cost report requires gathering current budget data, confirmed cost commitments, and estimates for remaining work, then organizing them into a consistent cost structure. The process takes coordination between your project team, accounting staff, and field personnel to ensure accuracy.

Step 1: Align your budget structure

Set up the report using the same cost codes or cost accounts from your project budget and accounting system. This prevents gaps, double-counting, and mismatched totals when you roll up costs.

Step 2: Gather your actual cost data

Pull all actual costs from your accounting system or project management software. Export invoices paid, labor costs incurred, material purchases, equipment rentals, and subcontractor payments through your reporting date. Organize these by cost account or trade to match your budget structure.

Step 3: Collect committed cost information

Review all signed subcontractor agreements, purchase orders, and material contracts. Document the total contract value for each commitment and what's been invoiced. Include retention amounts that you'll pay later. Your committed costs represent legal obligations even if the work isn't complete.

Step 4: List all change orders

Create two separate lists for change orders. Your first list includes all approved changes with signed documentation. Your second list captures pending change orders that have been submitted but await approval. Note the dollar amount and status of each change order so you can update quickly when approvals come through.

Step 5: Estimate costs for remaining work

Identify all work packages not yet under contract. Break these down by trade or scope and estimate costs using current market rates. Use actual productivity rates from your project rather than original estimate assumptions. Factor in any price increases you're seeing from suppliers or labor shortages affecting your schedule.

Step 6: Calculate your totals and variance

Add your actual costs, committed costs, approved changes, pending changes, and estimated remaining costs. Compare this total anticipated cost against your current budget to calculate variance. Document any significant variances by cost account so you can explain them to your project team and owner.

Step 7: Format and distribute the report

Organize your data into a clear report format that shows budget versus anticipated cost by category. Include a summary page with overall variance and detailed backup pages showing the calculations.

You can also use an anticipated cost report template that shows budget versus anticipated cost by category to maintain consistency across reporting periods.

💡Pro tip: Freeze the data cutoff before you start the report. Pull budget, commitments, and actual costs from the same reporting date every cycle, and document that cutoff in the report header. This prevents shifting numbers between versions and avoids false variances caused by timing gaps between accounting and project updates.

Who Uses Anticipated Cost Reports on Construction Projects

Multiple stakeholders across a construction project rely on anticipated cost reports to make informed financial decisions. Cost engineers and quantity surveyors typically prepare these reports and monitor ongoing cost performance. Project managers use the reports to oversee the overall budget.

These roles use anticipated cost reports to meet different project objectives:

Project Managers: Track overall project financial health and identify cost overruns early enough to implement corrective actions before budget problems become critical.

Cost Engineers and Quantity Surveyors: Monitor detailed cost performance by trade or cost account, validate contractor billing, and provide accurate financial forecasts to senior leadership.

Program Managers: Oversee multiple projects simultaneously and use ACR to allocate resources, prioritize funding, and identify projects at risk of overruns.

Project Owners and Developers: Review anticipated costs against available funding to determine if additional capital is needed and make go/no-go decisions on scope changes or project phases.

General Contractors: Manage subcontractor commitments, track change order impacts, and ensure they're staying within their guaranteed maximum price or lump sum contracts.

✅ Financial Controllers: Reconcile anticipated costs with cash flow projections, plan payment schedules, and ensure sufficient funds are available when invoices come due.

✅ Lenders and Investors: Verify project costs align with approved budgets before releasing construction draws or additional funding tranches.

💡 Pro tip: Tailor your ACR format to your audience rather than sending the same detailed report to everyone. Owners want a one-page summary that shows the total variance and the major risk items. Your CFO needs cash flow timing. Field superintendents need cost breakdowns by trade.

Common Anticipated Cost Reporting Mistakes and How to Avoid Them

Anticipated cost reports fail when teams treat them as historical accounting reports rather than forward-looking forecasts. This is the most common mistake, and it usually leads to forecasts that hide emerging cost risk.

Mistake How to Avoid It
❌ Using original estimates for remaining work instead of current pricing ✅ Update your estimated cost to complete monthly based on actual productivity rates and current market pricing from recent bids.
❌ Forgetting to include pending change orders in your forecast ✅ Track all submitted change orders in a separate column, even those not yet approved, so stakeholders see potential budget impacts.
❌ Double-counting costs that appear in both committed and estimated categories ✅ Reconcile your cost accounts monthly to ensure each scope item appears in only one category.
❌ Failing to update the report when new contracts are signed ✅ Set a calendar reminder to update committed costs within 48 hours of executing any new subcontract or purchase order.
❌ Including retention in actual costs before it's been paid ✅ Show retention as part of committed costs until payment is released, keeping actual costs accurate.
❌ Using mismatched cost codes between budget and accounting systems ✅ Map all accounting cost codes to budget line items at project start and document the crosswalk for your team.
❌ Not documenting assumptions behind cost estimates ✅ Add a notes column explaining the basis for each estimate so future updates maintain consistent logic.
❌ Ignoring scope gaps where no one has estimated the cost ✅ Review your scope document against cost line items quarterly to identify and estimate any missing work packages.

The most common reporting mistakes occur during transitions between project phases. When you move from design to construction or from structural work to finishes, cost ownership often shifts between team members. This creates gaps where no one updates estimates or captures new commitments, causing your anticipated costs to drift from reality.

Best Practices for Using Anticipated Cost Reports in Construction

Effective use of anticipated cost reports requires consistent processes, proactive monitoring, and clear communication across your project team. Following proven practices helps you catch budget problems early and maintain accurate financial forecasts throughout the project life cycle.

Apply these practices to maximize the value of your cost reporting:

☑️ Update Reports on a Fixed Schedule: Run your ACR on the same day each month so stakeholders know when to expect it and can plan reviews accordingly.

☑️ Compare Month-Over-Month Trends: Track how your anticipated costs change from one report to the next to identify which cost accounts are growing and whether the trend signals a problem.

☑️ Separate Contingency as Its Own Line Item: Show contingency spending separately rather than hiding it in other categories so everyone sees how much cushion remains in your budget.

☑️ Document Every Assumption: Record the basis for each estimate in your notes field so future updates maintain consistent logic and you can defend your numbers during budget reviews.

☑️ Reconcile Against Accounting Monthly: Cross-check your anticipated cost data against your accounting system to catch invoices that didn't get recorded or commitments that weren't entered properly.

☑️ Flag Variances Above a Threshold: Set a dollar or percentage threshold for variances that require explanation, such as any cost account more than 5% over budget or $10,000 off target.

☑️ Review with Field Teams: Walk through the report with construction superintendents and foremen to verify your estimates match what they're seeing on site.

☑️ Maintain Version Control: Save each month's report with a clear date stamp and keep a history so you can track how forecasts evolved and identify when problems first appeared.

☑️ Share Action Plans with Variances: When you distribute a report showing overruns, include specific actions you're taking to address them.

These practices separate project teams that react to overruns from those that prevent them. The most successful teams use anticipated cost reports as a forward-looking management tool. They outline scope priorities before budget pressures eliminate flexibility.

What Tools are Used for Anticipated Cost Reporting?

Construction teams rely on specialized software and systems to compile, track, and analyze the data that feeds anticipated cost reports. The right tools streamline data collection from multiple sources and reduce manual errors that compromise forecast accuracy.

  • Construction Project Management Software: Centralizes budgets, commitments, change orders, and forecasts so anticipated costs update automatically as contracts are signed and scope changes.
  • Accounting and ERP Systems Integration: Provide verified actual costs and committed values that form the financial foundation of your report.
  • Cost Management Software: Support cost code tracking, variance analysis, and forecast rollups at project and portfolio levels.
  • Spreadsheet-Based Templates: Work well for smaller projects, though they require strict version control to prevent calculation errors.
  • Project Reporting Dashboards: Combine cost forecasts with schedule performance and cash flow projections for executive decision-making.
  • Document Management Systems: Link cost line items to source documents like contracts and change orders for validation and audit trails.
  • Mobile Field Applications: Capture labor hours, equipment usage, and material quantities on-site that feed directly into estimated costs to complete.

The most reliable ACR pulls data from multiple systems but presents it in a single, consistent format. Integration between accounting and project management tools is critical to avoid timing gaps and conflicting numbers.

💡 Pro tip: Choose tools that lock commitments and actual costs once a reporting period closes. This prevents retroactive changes and keeps forecast trends meaningful from one reporting cycle to the next.

Make Anticipated Cost Reports Part of Cost Control

An anticipated cost report helps project teams see financial risk while there is still time to act. When teams keep the data current and treat the report as a forecasting tool, it becomes a reliable input for real decisions. Used consistently, it supports tighter cost control and fewer surprises as the project moves forward.

FAQs About Anticipated Cost Reports

Most project teams update anticipated cost reports monthly to align with accounting close cycles. On fast-moving or high-risk projects, more frequent updates may be needed to reflect new commitments or emerging cost exposure.
There is no formal requirement, but anticipated cost reports are widely used on projects where cost risk needs active management. Larger, more complex projects benefit the most because small changes can materially affect the final cost.
Responsibility typically sits with the project manager, with support from project accounting or cost controls. Accuracy depends on close coordination between the field team, finance, and anyone managing contracts or change orders.
Yes. Many owners rely on anticipated cost reports to understand budget exposure and expected final cost. The report often needs a higher-level summary view, but the underlying cost data remains the same.
A cost-to-complete report focuses on the remaining cost to finish the work. An anticipated cost report goes further by combining remaining costs with actual and committed costs to forecast the total expected project cost.
