Construction Project Scheduling: Methods, Tools, and Best Practices

A complete owner-side guide to construction project scheduling. Methods, tools, best practices, and how to keep the schedule driving the field.

Date posted:
October 22, 2024
Date updated:
June 3, 2026
Popular

Free Schedule Management Plan Template! Outline how your project’s schedule will be managed, monitored, and controlled throughout the project lifecycle.

Project Scheduling
Back to top

Construction project scheduling is how owners and project managers plan, sequence, and control the work so the build finishes on time. A useful schedule sequences activities, manages float, and keeps the office and the field aligned on what to build next.

This guide covers what construction project scheduling is, the phases and milestones a schedule models, and the methods used to build one. It also walks through how to put a schedule together, where it connects to cost, and how AI is changing the work.

TL;DR
Construction project scheduling plans and controls every activity on a build so it finishes on time. The main methods are the critical path method (CPM), the graphical path method (GPM), and look-ahead scheduling, all built around the critical path. Owners get the most value when the schedule drives field execution, not just status reports.

What Is Construction Project Scheduling?

Construction project scheduling is the process of planning every activity needed to deliver a build. It sequences activities with logical dependencies, assigns realistic durations, and connects them through milestones. The resulting construction schedule is the living document that links contract milestones, resource plans, procurement lead times, and field execution into one network.

Most owners treat the schedule as a calendar. A better mental model is a directed graph. Every activity has predecessors, successors, durations, and float, and the relationships between those four properties determine when the project actually finishes.

A working construction schedule sits at the intersection of scope, time, and resources. Scope tells you what has to happen, time tells you when, and resources tell you whether either is realistic. When any of these is wrong, the schedule starts to drift from the field.

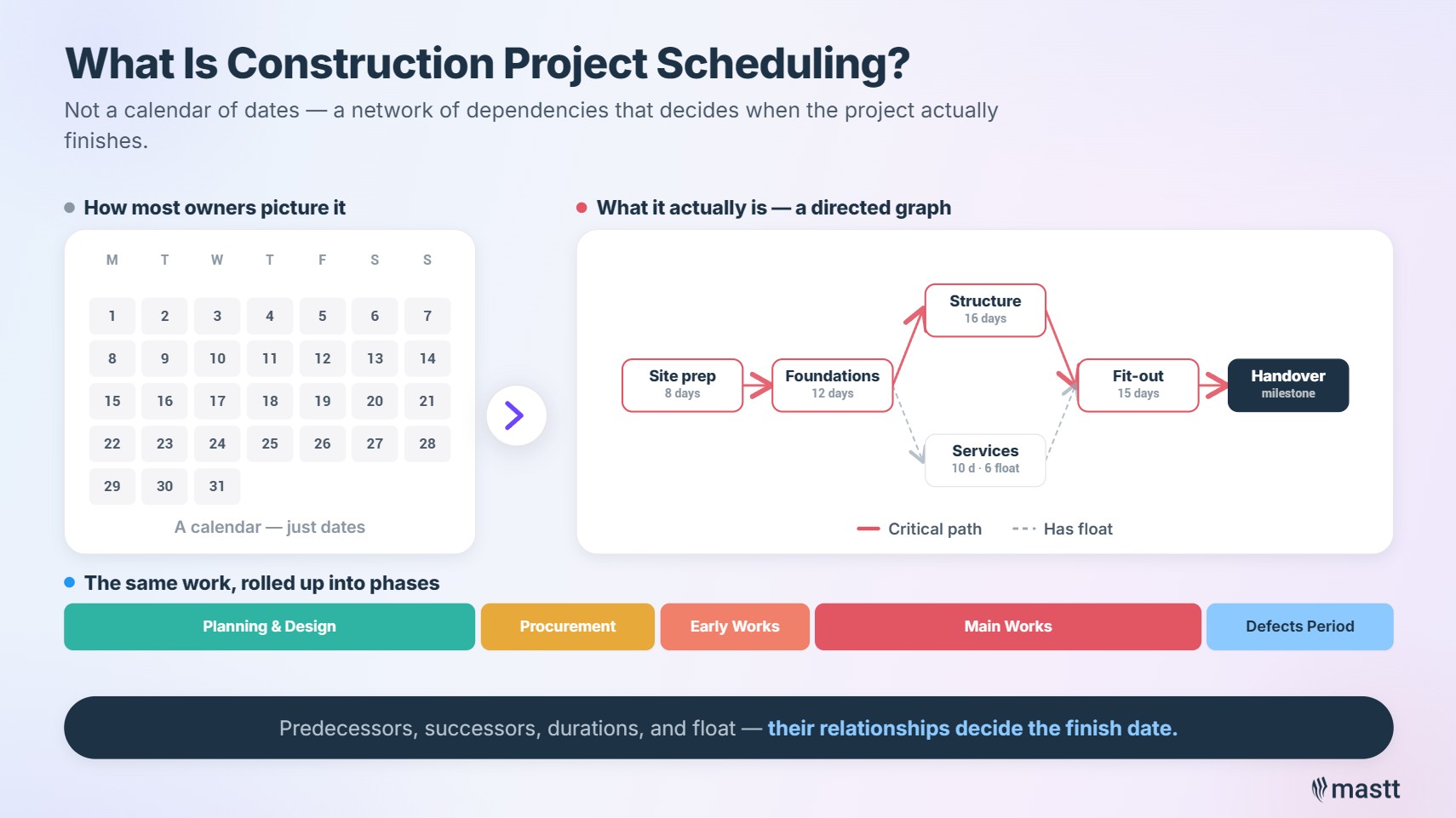

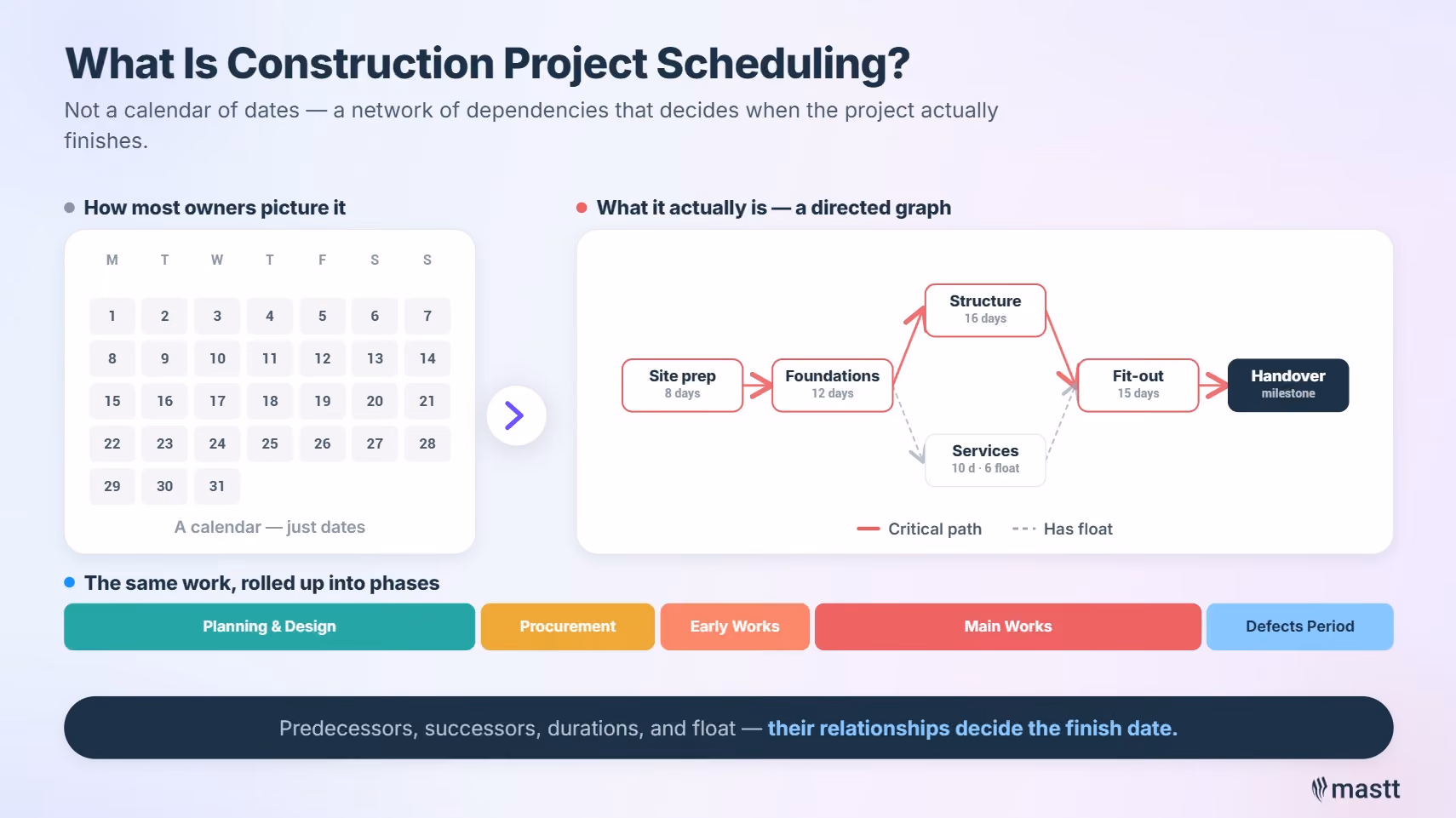

Construction project scheduling shown as a network of dependencies, not a calendar of dates.
A schedule is the network logic, not the calendar. The dependencies decide the finish date.

Why Does Construction Scheduling Matter to Project Owners?

Construction project scheduling matters because every day of delay costs an owner money. The cost shows up in extended general conditions, finance charges, and lost revenue. The schedule gives an owner control over those costs by sequencing work, identifying the critical path, and flagging emerging risk before recovery is needed.

Industry research from McKinsey & Company has documented a long-running productivity gap in construction. Unreliable scheduling sits at the center of the cost overruns and missed handover dates that gap produces.

A reliable construction schedule protects three things for an owner, each showing up in the project's profit and loss in a different way. Time-to-revenue protects the income side. Cost certainty protects the expense side. Risk position protects the contingency.

  • Time to revenue: Every day late is a day of lost revenue on a pharmaceutical plant, data center, hotel, or commercial building.
  • Cost certainty: A schedule that drifts pulls the cost forecast with it, and recovery costs tend to stack non-linearly.
  • Risk position: A defensible schedule limits exposure to change order conflicts, disputes, and extension-of-time arguments.

That last one is where the conversation gets uncomfortable.

"The bent of a lot of the CPM programs that I have seen has to do with litigations and claims, the ability to defend your position on a critical path network if there are claims after the project. And that seems like a pretty negative way to spend your energy."
- Timothy Mather

When the schedule is built to defend a position rather than deliver the project, it still costs the owner money. The cost just shows up in a different line item.

What Are the Phases and Milestones of a Construction Project?

A construction project moves through five recognized phases. Each phase has a different scheduling requirement:

  • Initiation: A high-level schedule of milestones, gate dates, and approvals.
  • Planning: Detailed master schedule, procurement schedule, submittal schedule, and resource plan. The baseline gets locked in here.
  • Procurement: Long-lead items, fabrication windows, and delivery dates tracked against contractor commitments.
  • Execution: Look-aheads, weekly updates, earned value tracking, and recovery planning when the work slips.
  • Closeout: Punch list, commissioning, handover, and lessons learned.

Each phase carries a different scheduling weight. Initiation and planning produce the baseline. Execution is where the schedule's value gets made or lost. Closeout is routinely under-planned, which is one reason projects miss their final completion date.

Most owners run a layered plan that gets denser as the work approaches, because the schedule that worked at initiation rarely survives execution untouched.

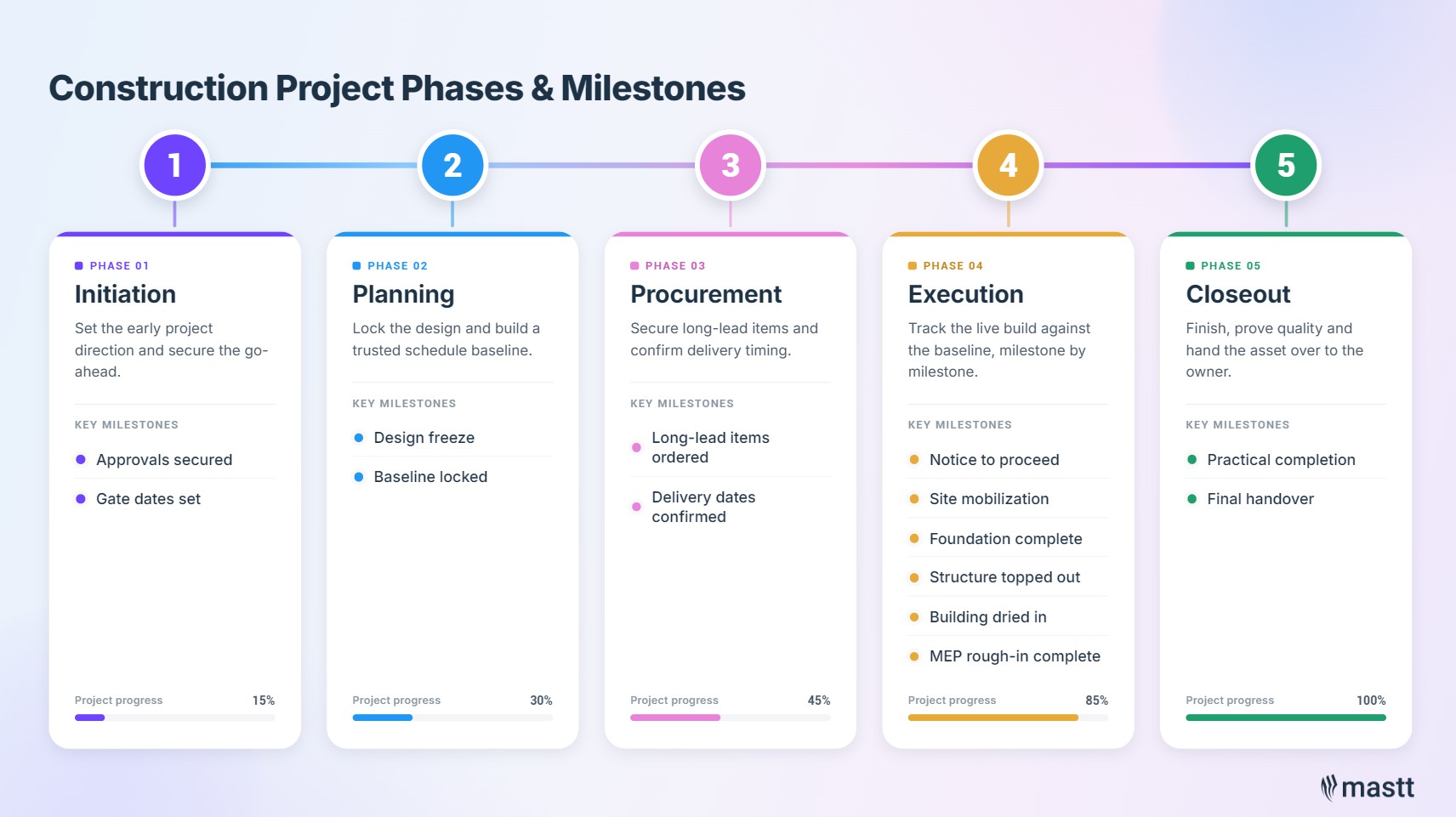

Construction project phases and milestones: Initiation, Planning, Procurement, Execution, Closeout, with progress tracking.
Each phase of a construction project has its own scheduling job, from approvals at initiation to handover at closeout.

Construction projects also share a recurring set of milestones an owner should be able to point to on any schedule. Each one is a decision point as much as a date such as:

  • Design freeze: Design uncertainty closes enough for the construction sequence to be locked in.
  • Notice to proceed: The contractual trigger authorizing the contractor to start work.
  • Site mobilization: Site offices, temporary facilities, security, and crew arrangements are in place.
  • Foundation complete: Structural work above grade can begin. First major schedule risk gate.
  • Structure topped out: The vertical structural frame is complete.
  • Building dried in: Roof and envelope complete, allowing interior work without weather exposure.
  • MEP rough-in complete: Mechanical, electrical, and plumbing (MEP) infrastructure installed before finishes.
  • Practical completion: Building usable for its intended purpose, even with minor punch-list items.
  • Final completion and handover: Punch list cleared, commissioning complete, owner takes operational control.

Each milestone needs specific data, sign-offs, or deliverables sitting behind it. Without those, the milestone is a flag on a chart, not a decision point.

What Are the Core Components of a Construction Schedule?

A construction schedule is built from five components: a work breakdown structure, activities, dependencies, durations, and milestones. A weak link in any of the five tends to fail the schedule in predictable ways.

The five core components:

  • Work Breakdown Structure (WBS): The hierarchical decomposition of the project into work packages.
  • Activities: Time-bound tasks with clear start and finish boundaries. Vague activities are one of the more reliable indicators of a weak schedule.
  • Dependencies: Logical relationships between activities, represented using the precedence diagram method.
  • Durations: Realistic timeframes based on reference data, not gut feel. A giveaway of guessed durations is that every activity is five or ten days long.
  • Milestones: Fixed events that anchor the schedule to the contract.

Beyond these five, a working schedule needs a schedule baseline (the approved version you measure against), a WBS dictionary (definitions for each work package), and clear written ownership of every activity.

What Are the Main Types of Construction Schedules?

A construction project uses several schedule types in parallel, each at a different level of detail and serving a different audience:

  • Master schedule: The full project schedule, used for executive reporting.
  • Baseline schedule: The approved master schedule, frozen at a point in time, against which actual progress is measured.
  • Look-ahead schedule: A detailed two-to-four-week view used by superintendents and crews. See look-ahead schedule.
  • Resource-loaded schedule: Activities tied to specific crews, equipment, and material deliveries. Resource leveling adjusts the schedule to respect resource limits (sometimes extending duration). Resource smoothing keeps the end date fixed while flattening resource peaks.
  • Recovery schedule: A revised, usually compressed plan built when the project is materially behind.

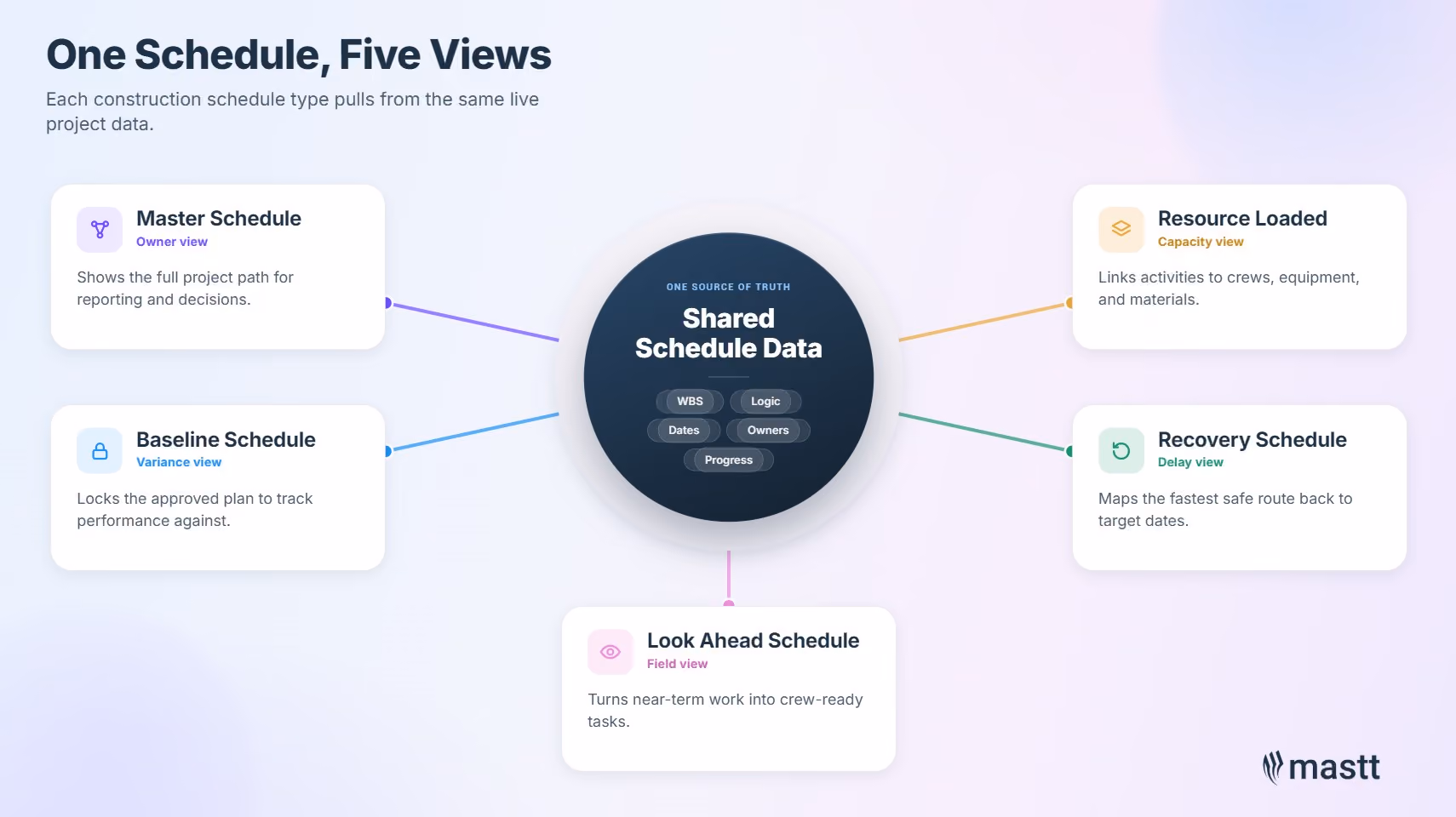

Five types of construction schedules sharing one data source: master, baseline, look-ahead, resource-loaded, and recovery.
All five construction schedule types should be views of the same data, not separate documents that need reconciling.

The five types are meant to be views of the same underlying data, not separate documents that need reconciling. When they drift apart, the master schedule and the look-ahead start describing different projects. The weekly update cycle then becomes reconciliation work rather than decision work.

Owners who treat the master schedule as the only one that matters lose touch with what crews are doing on site. Owners who only watch the look-ahead lose the longer-range view. The skill is keeping them in sync.

What Construction Scheduling Methods Should You Know?

Construction project scheduling methods fall into five main categories, each suited to a different project type, scale, and level of certainty. Most large projects use two or three of them in combination.

Method Best for Strengths Limitations
CPM Most large construction projects Network logic, float analysis, defensible critical path Scales poorly past 10,000 activities
GPM Front-end planning and pull sessions Visual, self-healing logic, fast to revise Less suited to very large schedules
Linear Roads, tunnels, multi-storey, pipelines Shows location and time together Weak for non-repetitive work
PERT High-uncertainty durations Three-point estimates capture duration risk Heavier to maintain than single-point CPM
Rolling wave Long programs with shifting scope Detail follows execution Requires steady process to keep the wavefront moving

Most construction project scheduling tools render these methods as Gantt charts on screen. A Gantt chart is the presentation layer rather than the method itself, showing activities as horizontal bars on a timeline with dependencies drawn between them. Primavera P6, Microsoft Project, and almost every other scheduling tool default to the Gantt view, even when the underlying logic is CPM or GPM.

The critical path method is the industry default. It underpins Primavera P6, Microsoft Project, and most other enterprise tools. NetPoint, the GPM implementation built by PMA Technologies, sits in a separate category as a planning-first canvas. Linear scheduling is the standard for repetitive infrastructure work.

Lean construction teams also use the Last Planner System. This pull-planning method, developed by the Lean Construction Institute, is most effective when paired with CPM. CPM holds the network logic; the Last Planner System drives the weekly commitments.

CPM does not scale gracefully on long programs.

"If you have a five-year program with 30,000 activities in it, you are making it up. You do not know that three years from now this I-beam is going to get bolted to that piece of concrete. It is just not true."
- Timothy Mather

Right-size the activity count to the certainty you actually have, not the certainty you want. A schedule with more activities than the team can update on a single cycle stops being a plan and becomes a record-keeping exercise. Rolling wave principles work well for anything past eighteen months out, with detail brought forward as crews approach each activity.

What Tools and Software Are Used for Construction Scheduling?

Construction scheduling tools fall into three categories based on who uses them and the job they do on a project. Most owners deal with all three at some point during delivery.

The three categories sit at different points in the schedule's life:

Category Tool examples What it does for the project
Enterprise CPM platform Primavera P6, Microsoft Project, Asta Powerproject Builds the detailed activity network, calculates the critical path, runs delay analyses, and produces the monthly schedule update.
Planning-first canvas NetPoint (GPM) Supports front-end planning, pull planning sessions, and visual collaboration with the trades before detailed scheduling begins.
Owner-side platform Mastt Consumes the CPM schedule, links it to cost, risk, and documents, and presents milestones, phase progress, and portfolio health for owner-level reporting.

Two adjacent categories are worth knowing. 4D BIM platforms like Synchro and Navisworks link the schedule to the 3D model. Sequence clashes show up before they hit the field. AI-layered tools are the newer category and are covered in the AI section below.

For project owners, the choice usually is not which CPM tool the contractor uses. It is which platform makes the schedule readable, defensible, and connected to cost and risk for the owner-side team.

Mastt's construction project scheduling software imports P6 and MS Project files directly. The schedule the contractor builds becomes the schedule the owner reads in context.

How Do You Create a Construction Schedule?

Creating a construction schedule follows six core steps: define the scope, build the WBS, identify activities, set durations, sequence the work, and baseline the result. Skipping any step produces a schedule that will not survive the first month of execution.

Step 1: Define the project scope clearly

Scope definition starts with the contract, the design drawings, and the project execution plan. Every activity in the schedule must trace back to something in scope. Anything outside scope belongs in a change-order register, not in the schedule.

Step 2: Build the work breakdown structure

Decompose the project into work packages, then break each work package into deliverables and activities. Use the same WBS the cost team uses, so cost and schedule remain reconcilable.

A WBS that lives inside dedicated construction scheduling software stays consistent with the activity network and the look-ahead it feeds. That removes the manual rebuilding most teams do when the WBS, the master schedule, and the field plan all live in separate files.

Step 3: Identify activities and assign owners

For each work package, list every activity needed to deliver it. Assign each activity a unique ID, a clear description, and an owner. "Install MEP services on level 3" is not an activity. "Install electrical rough-in on level 3, north zone" is.

Step 4: Estimate realistic durations

Use historical data, productivity rates, and crew sizing. Avoid round numbers across the board. Three-point estimating is worth the effort for any activity with material risk.

Step 5: Sequence activities with logical dependencies

Connect activities using finish-to-start, start-to-start, finish-to-finish, or start-to-finish relationships. Add lead times and lag times only when they reflect real constraints. The result is the project network, which is what CPM and GPM tools operate on.

Step 6: Baseline the schedule and version-control it

Lock the approved schedule as the baseline and protect it. Every formal update is a delta against the baseline. Without that version-control habit, the team cannot measure performance.

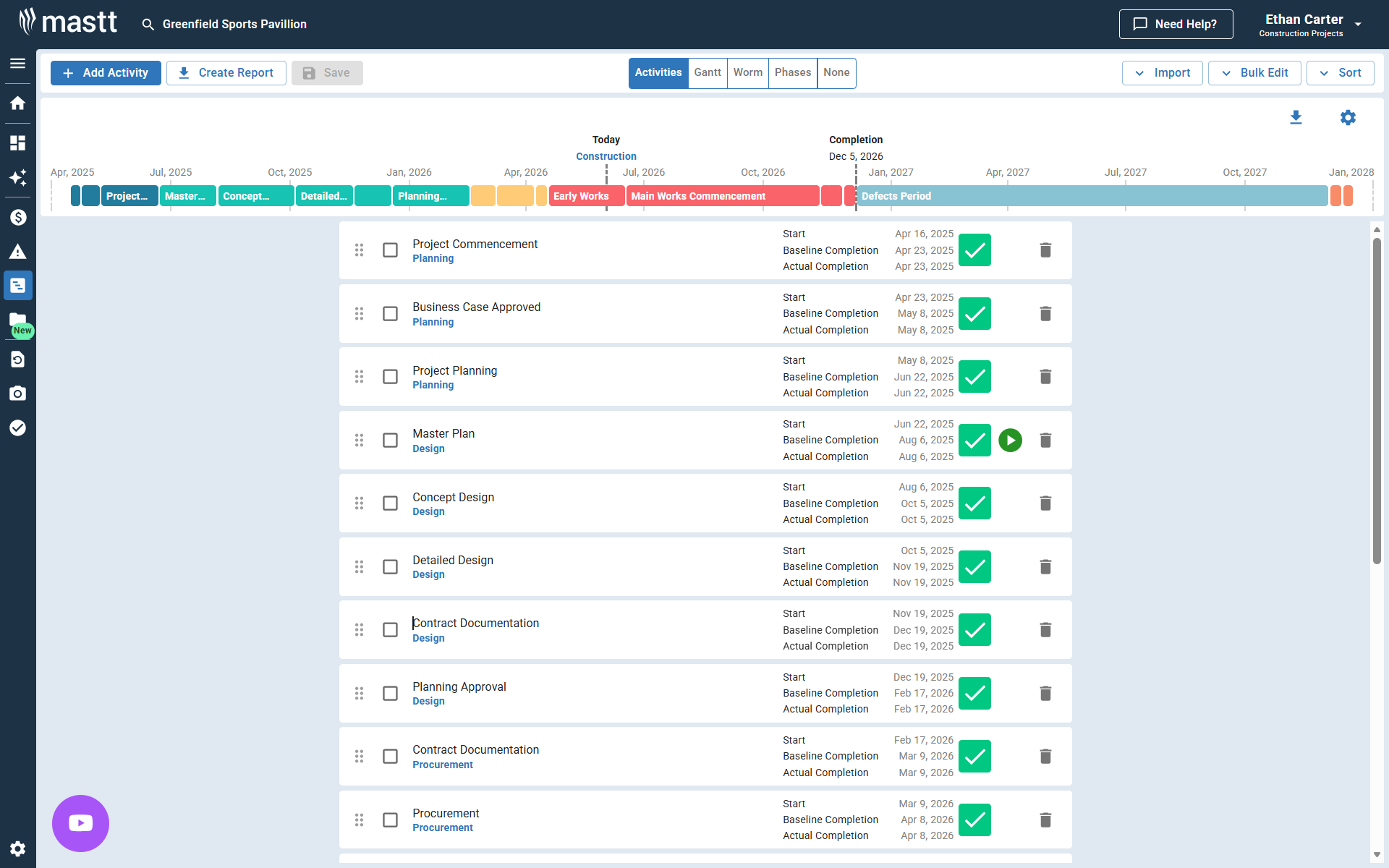

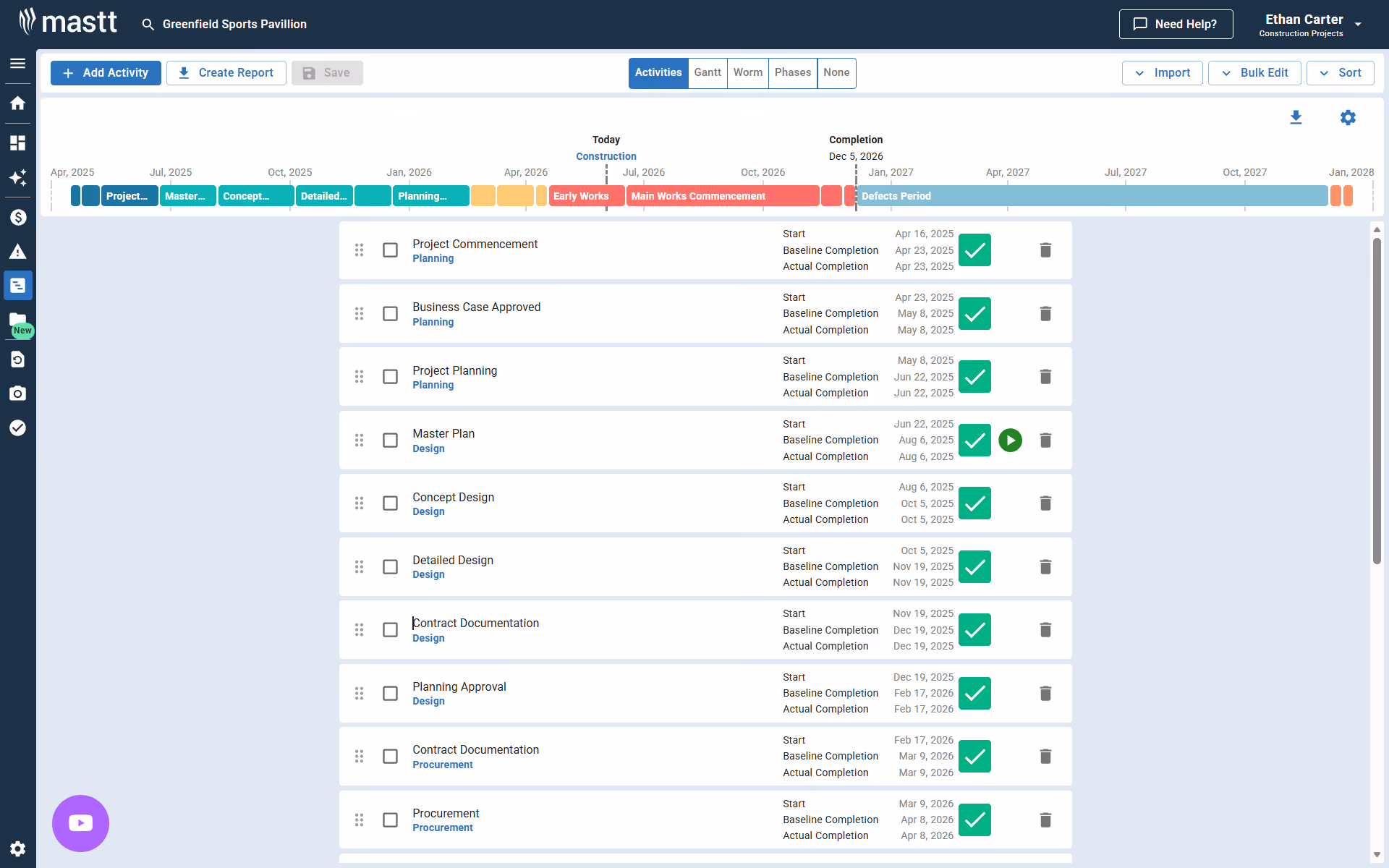

Construction project scheduling software in Mastt showing project phases, milestones, and baseline completion dates.
A construction project schedule in Mastt, with phases, activities, and baseline completion tracked in one view.

For a starting point, see the Mastt construction schedule template and the guide to developing a project schedule.

How Do Critical Path and Float Work in Construction Scheduling?

The critical path is the longest sequence of dependent activities in a construction schedule. It controls the project's finish date directly. Float is the time a non-critical activity can be delayed before it starts affecting the critical path. Managing float is how project managers absorb minor delays without losing the end date.

The critical path calculation runs a forward pass to compute earliest start and finish dates. A backward pass computes latest start and finish. Activities with zero float between those passes form the critical path.

The network underneath is usually drawn as an Activity-on-Node (AON) diagram, where each activity is a box and each dependency is an arrow between boxes. AON is the modern network diagram standard. Older Activity-on-Arrow (AOA) diagrams are rarely used today.

Two types of float matter day-to-day, and confusing them is a common scheduling error. Total float refers to the path; free float refers to the activity. Both are useful, but they answer different questions.

  • Total float is the maximum delay possible for an activity without pushing the project's finish date.
  • Free float is the delay an activity can absorb without affecting the start of its immediate successor.

See the worked walkthrough in free float vs total float.

The risk most teams underestimate is float erosion on near-critical paths. A path with three days of float is one weather event from becoming critical. That is the structural reason behind the "death by a thousand cuts" pattern many delayed projects show.

What Are Hammock Activities, Fragnets, and Schedule Slippage?

Some scheduling problems do not fit the standard CPM model. Every experienced planner uses a small set of specialist tools to handle them. These tools also help an owner read a contractor's monthly schedule update properly.

Term What it is When used Common misuse
Hammock activity Level-of-effort task spanning two events Site supervision, project management, temporary facilities Treated as schedule-driving
Fragnet Sub-network modeling a specific event Time impact analysis, change order modeling Biased placement to support a position
Schedule slippage Cumulative drift between baseline and actual dates Tracking degradation rate Confused with one-off variance
Time impact analysis (TIA) Prospective analysis of a delay event Supporting an extension-of-time request Selective fragnet placement

For deeper detail see the Mastt hammock activity glossary entry and the time impact analysis blog. The recognized TIA methodology is set out in AACE International's Recommended Practice 52R-06, Prospective Time Impact Analysis as Applied in Construction.

Owners who can spot a fragnet inserted for advantage spot schedule problems weeks earlier. The same goes for a hammock activity used to report rather than drive work. Owners who rely only on percent-complete reporting see the problems later.

How Do You Monitor and Control a Construction Schedule?

Monitoring a construction schedule means tracking actual progress against the baseline, identifying variance, and updating forecasts before issues compound. Control is what the project manager does with the variance. Most owners get into trouble when they treat the update cycle as reporting rather than steering.

Step 1: Set up a working monitoring rhythm

The construction project scheduler owns the monitoring rhythm. On large projects this is a dedicated role; on smaller projects it falls to the project controls lead or the project manager. Either way, the work is the same.

An effective monitoring rhythm operates on four moving parts that work together. Skipping any one lets the schedule lag the project rather than steer it.

  • Progress capture: Crews report actual percent complete or quantity installed against each activity, ideally daily.
  • Variance analysis: The planner compares actual to baseline and flags activities trending behind or ahead.
  • Forecast revision: Earned value metrics feed an updated forecast finish date.
  • Action triggers: When variance crosses a threshold, the team triggers a defined response.

The four parts work as a system. Progress capture without variance analysis is data without insight. Variance analysis without action triggers is insight without consequence.

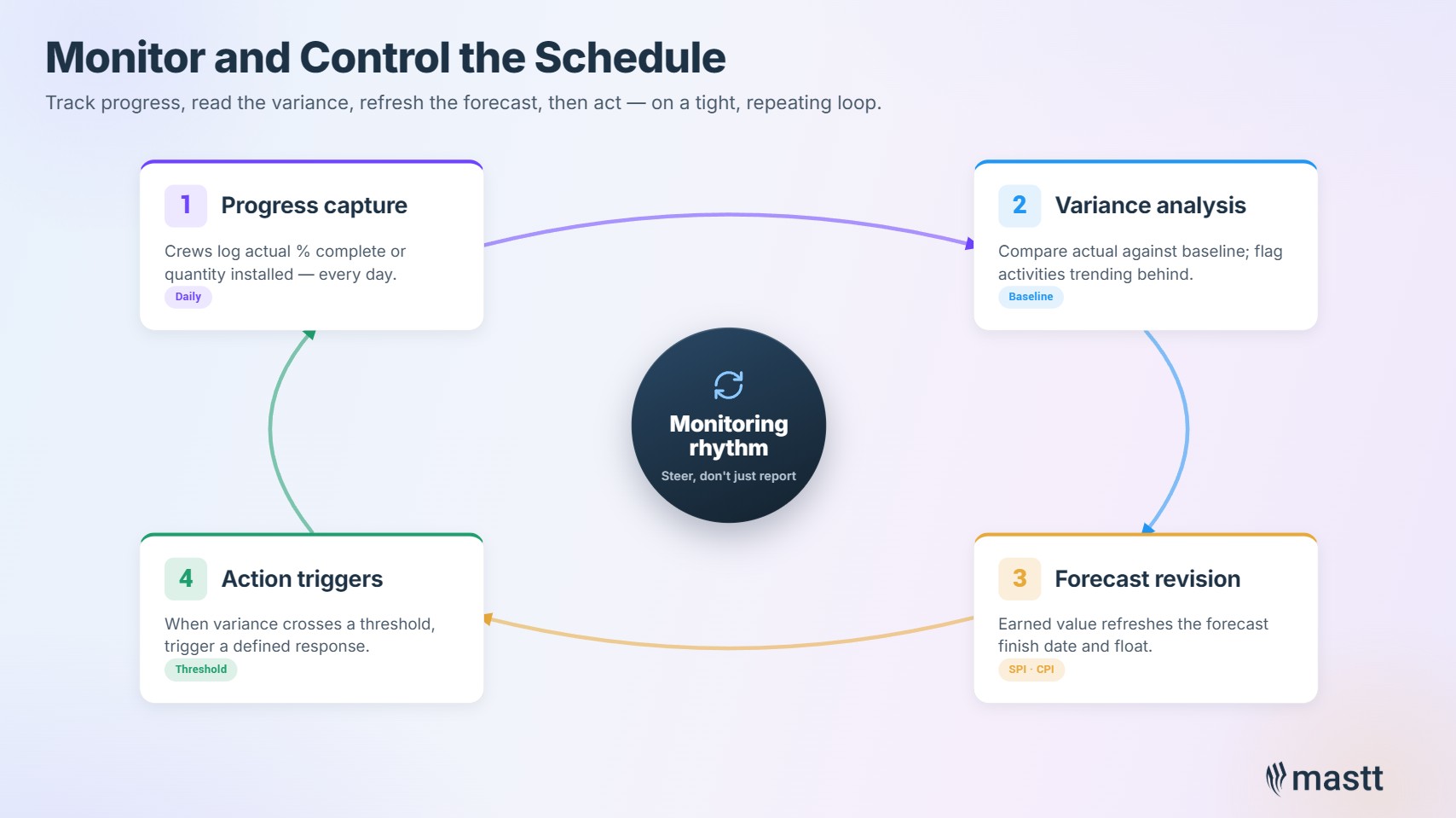

Construction schedule monitoring rhythm: capture progress, analyze variance, revise forecast, trigger action.
The four-step monitoring rhythm: capture progress, analyze variance, revise the forecast, then act. Steer, don't just report.

Step 2: Use earned value management metrics

Earned Value Management (EVM) gives the monitoring rhythm its numbers. It is treated as a core knowledge area in the Project Management Institute's PMBOK Guide. EVM combines three core values into a small set of derived metrics:

  • Planned Value (PV): The budgeted cost of the work scheduled for completion by the report date.
  • Earned Value (EV): The budgeted cost of the work actually completed by the report date.
  • Actual Cost (AC): The cost incurred to produce the earned value.

From those, two derived metrics summarize project performance. The Schedule Performance Index (SPI = EV / PV) tells you whether the project is ahead or behind. The Cost Performance Index (CPI = EV / AC) tells you whether the budget is holding. An SPI of 0.85 means the project is earning 85 cents of planned work for every dollar planned. That is an early signal the schedule needs intervention.

Step 3: Avoid the reporting trap

The biggest risk in monitoring is letting the update cycle stretch too far. Once the master schedule no longer reflects the field, it has stopped steering the project. If updates happen every two weeks but crews make decisions every two hours, the gap is real.

"I see the field work and the schedule as running on two separate parallel paths. Even if you were to do an update bi-weekly, that 30,000 activity schedule is not actually driving work on the site."
- Timothy Mather

Tightening the update cycle is one of the highest-impact moves a project controls lead can make. Moving to a continuous-status model, where field data flows into the master in near-real-time, takes that one step further.

If the weekly review meeting is dominated by reconciling percent-complete numbers, the schedule has stopped steering and started reporting.

Why Do Construction Schedules Drift From the Field?

Construction schedules drift when the master schedule and the look-ahead operate on different cadences and pull from different data. The two documents stop describing the same project, and every formal update becomes reconciliation work.

"It just seems like Kabuki theater to me. You are trying to align reality when really you should have one consistent platform that is thought out and is accessible to everyone and actually drives the work."
- Timothy Mather

Three signals tell an owner the drift is serious:

  • Activities are starting before their predecessors are complete.
  • The look-ahead and the master show different percent-complete for the same activity.
  • The contractor and the owner's representative are maintaining separate schedules.

Closing the drift is a tooling problem, a process problem, and a contract problem. The tooling fix is one shared platform. The process fix is making the look-ahead a view of the master. The contract fix is specifying which schedule is authoritative and how it gets updated.

How Should You Manage Construction Schedule Risk?

Schedule risk is the probability that activities, paths, or the project as a whole will finish later than planned. It should be analyzed continuously, not only at stage gates. The standard quantitative method is Monte Carlo simulation, which runs thousands of schedule outcomes against probability distributions for each activity duration.

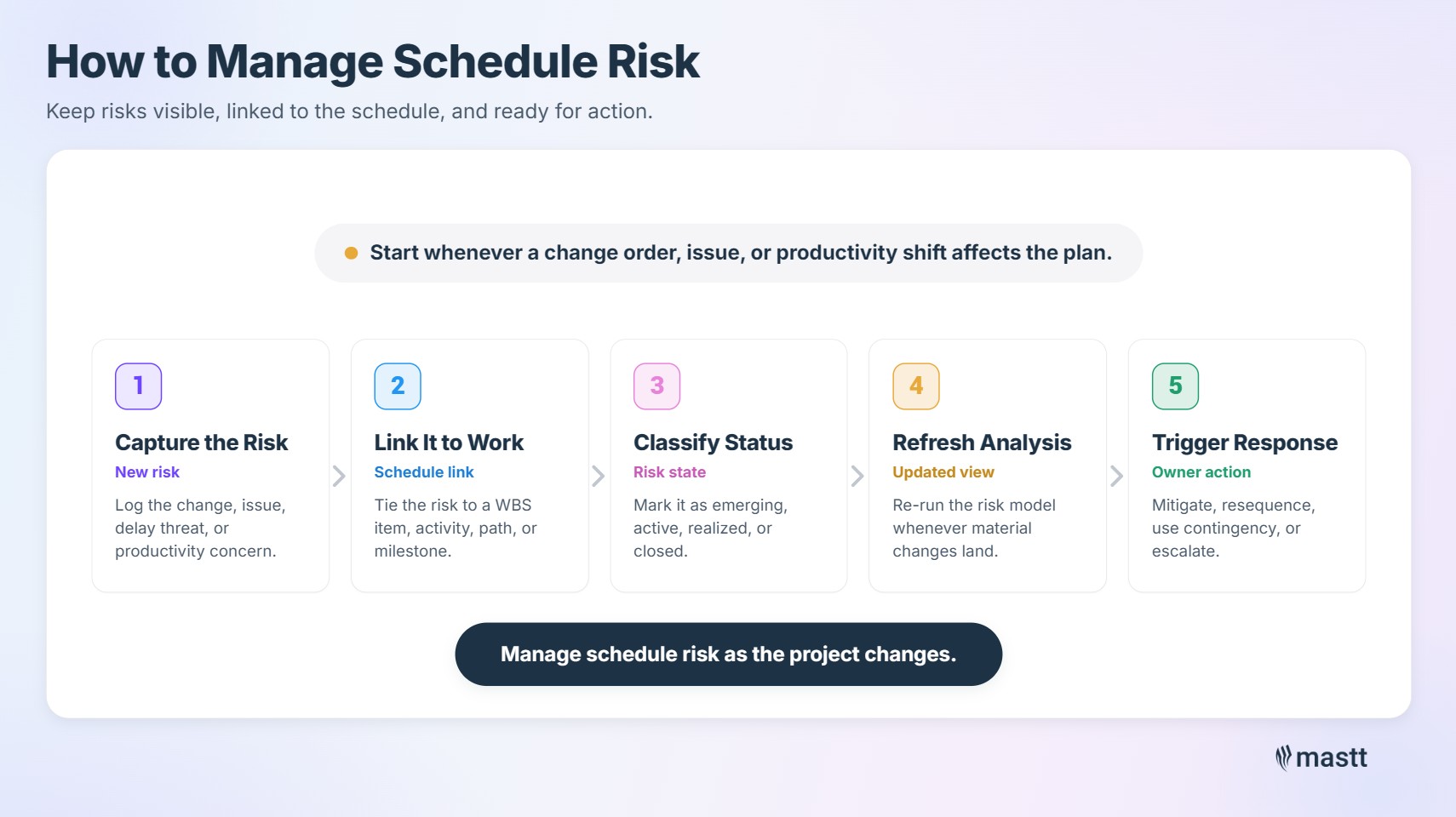

Five-step process to manage construction schedule risk: capture, link to work, classify status, refresh analysis, and trigger response.
The five-step rhythm for managing construction schedule risk.

The traditional pattern is to risk-load the schedule once at the start, run a Monte Carlo, and reference the result at stage gates. That misses the point. Risk is dynamic. Every change order, every emerging issue, and every productivity shift moves the distribution.

"Risk should actually be a part of your project as it executes, not just at the beginning to get through a stage gate."
- Timothy Mather

A continuous model has four ingredients:

  • A live project risk register tied to specific activities or paths in the schedule.
  • Re-running the quantitative analysis whenever a material change lands.
  • Tracking emerging risks separately from realized ones.
  • AI or rule-based monitoring that flags near-critical paths trending toward critical.

See the Mastt guides on schedule risk analysis and active risk management for the methodology in detail.

The cumulative-change problem is real. A project with a thousand small change orders can still finish late. None of the changes directly affects the critical path, but float keeps eroding on previously safe paths. Continuous analysis is what catches that.

For example, consider a 24-month build with 50 active paths. A hundred small change orders, averaging two days each, get absorbed across non-critical activities through the first six months.

Each individual change looks insignificant.

By month seven, the longest near-critical path has gone from 14 days of float at baseline to 3 days. Nothing has obviously broken, but the project is now one weather delay or one bad week from missing its handover date. A snapshot Monte Carlo at the gate review would have shown a comfortable margin. Continuous monitoring shows the erosion in real time.

How Do You Recover a Delayed Construction Schedule?

When a construction project falls behind, the two recognized recovery techniques are fast tracking and crashing. Each has different cost, risk, and quality implications, and most real recoveries combine them with resequencing and scope reduction.

The four levers a recovery plan can pull:

  • Fast tracking: Run activities in parallel where the dependency allows. Lower cost than crashing, but raises rework risk.
  • Crashing: Add labor, equipment, or shift hours to compress duration on critical activities. Predictable benefit, but cost climbs quickly.
  • Resequencing: Re-route the critical path around delayed activities where the logic allows.
  • Scope reduction: Defer or remove activities from the current project phase, with stakeholder agreement.

The choice depends on cost tolerance, risk tolerance, and contract conditions. See the comparison in fast tracking vs crashing and the definition of project crashing.

The most important rule for recovery is to model it before committing. A recovery plan that gets the project back on date but blows the cost contingency is not a recovery. It is a different problem with a new name.

For example, consider a project four weeks behind on its critical path. Crashing structural work might recover three weeks at meaningful overtime cost. Fast-tracking MEP into the structural envelope might recover one more week at a smaller cost but with rework risk if the steel detailing changes.

The final week becomes a contractual extension request. Three levers, three cost profiles, and the modeling step is what shows which combination actually works for the owner.

How Is AI Changing Construction Project Scheduling?

AI is changing construction scheduling by removing the data-entry layer, enabling natural-language access to the schedule for non-experts, and running continuous trend analysis in the background. The agentic version of these capabilities is what changes the role of the scheduler.

The three highest-impact applications today are:

  • Natural-language query of the schedule: A project sponsor or CFO can ask which activities lost float this month without opening P6.
  • Agentic trend monitoring: A background agent watches near-critical paths for float erosion and flags activities trending toward critical.
  • Automated status capture: Daily reports, PDFs, and field logs feed updates into the schedule without manual transcription.
"The advent of AI within the world of scheduling is probably one of the biggest opportunities we have. The ability to build a data lake off a whole project and natural language query that project for answers is going to level the playing field for all the professionals who have questions."
- Timothy Mather

The scheduler's role does not disappear. It shifts. Less time on data entry and reconciliation, more time on judgment, logic, and the conversations that move the project forward. See the Mastt guides on AI in construction and AI agents in construction for the broader picture.

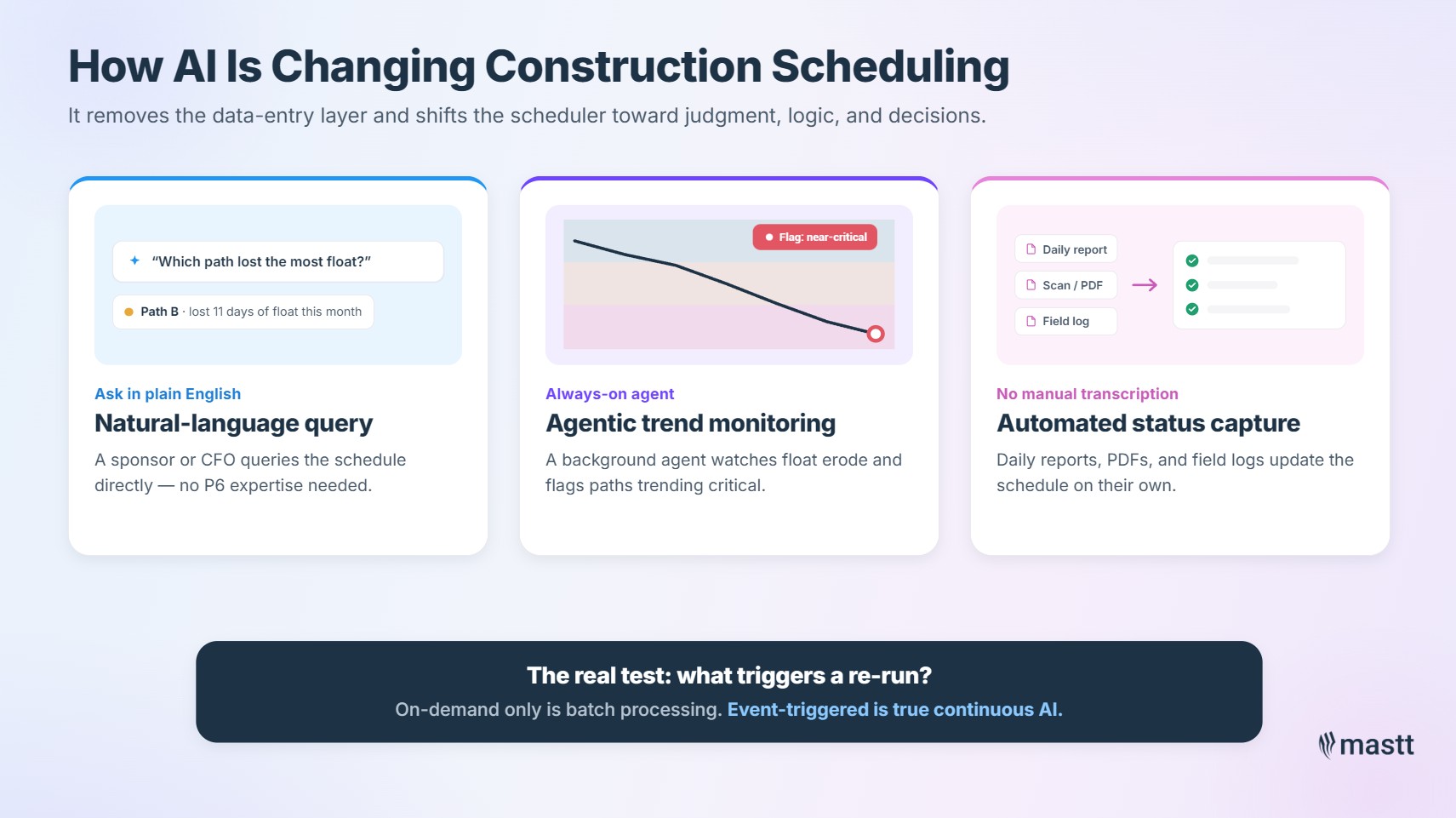

Three ways AI is changing construction scheduling: natural-language query, agentic trend monitoring, and automated status capture.
Three shifts moving the scheduler from data entry to judgment.

Beyond these three applications, 4D scheduling is becoming a useful visualization layer for owners reviewing complex builds. 4D scheduling integrates the schedule with the Building Information Modeling (BIM) model, so the schedule can be played back visually against the 3D design. Paired with agentic AI monitoring, 4D scheduling makes float erosion and resource clashes easier to spot.

When a vendor pitches AI for scheduling, a useful filter is to ask what triggers a re-run. If the answer is on demand only, the tool is faster batch processing dressed up as AI. True continuous analysis is event-triggered by material changes in the schedule or the risk register.

Where Does Construction Scheduling Connect to Project Cost?

Construction scheduling connects to project cost at every milestone, every change order, and every variance. That is why most construction projects integrate the schedule and the cost system at the work-package level. Time is money on a construction project, and tracking them in separate systems guarantees they will tell different stories.

The integration mechanics are straightforward. The WBS is shared between schedule and cost. Earned value links the two; PV, EV, and AC combine schedule progress with cost performance. Change orders update both systems together so they cannot move out of sync.

When the schedule and the cost data sit in one platform, the integration is automatic. When they sit in two, every reconciliation cycle creates risk that one of them is wrong. For owners running multiple projects at once, integrated cost-and-schedule reporting is what makes portfolio-level visibility feasible at all.

Best Practices for Construction Scheduling

Best practices in construction project scheduling come from owners and project controls leads. They know which decisions separate a schedule that drives delivery from one that just documents work.

Six practices that consistently separate reliable schedules from unreliable ones:

  1. Right-size detail to certainty: Use rolling wave planning for far-out work and bring detail forward as crews approach it.
  2. Baseline early and version-control updates: A clean baseline is the only stable reference point for performance measurement.
  3. Keep the master and look-ahead as views of the same data: Reconciliation churn disappears when both pull from one source.
  4. Run schedule risk continuously: Risk shifts with every change order and emerging condition.
  5. Integrate schedule and cost at the work-package level: Time and money tell consistent stories only when they share a WBS.
  6. Use earned value management metrics: SPI and CPI give status in two numbers, without percent-complete arguments.

Adopting all six at once on a live project is unrealistic. Start with the meeting habit, then build the tooling and risk processes around it. Most owners who get visible value from their construction schedules trace it back to that single shift in how the weekly review is run.

Common Construction Scheduling Mistakes

The most common construction project scheduling mistakes are observable in any weekly project review. Each is preventable, none is rare, and each has a specific fix that does not require new software.

Four common construction scheduling mistakes paired with the fix for each.
None of these are software failures. They're judgment failures.

Four failure patterns to spot and fix:

  • The schedule is built to defend a position: A defensive schedule wastes energy that should go into delivery. Fix it by making execution the explicit goal.
  • Float erosion on near-critical paths is ignored: A path with three days of float is one bad week from critical. Fix it by monitoring trend, not just zero-float activities.
  • Recovery is committed to before modeling: A recovery plan that fixes the date but blows the contingency is not a recovery. Fix it by modeling both cost and schedule impact first.
  • Hammock activities and fragnets are used to mislead: Reading a schedule update without recognizing these tools means missing what is really happening. Fix it by training the owner-side team to spot them.

Each one is visible in a weekly review. Spot the pattern by Wednesday afternoon and the team can usually fix it by the next review.

Key Takeaways

The points below are the ones owners and project managers act on first when they revisit their scheduling approach. They change how the schedule behaves, not just how it looks.

  • A construction schedule is useful when it drives field execution, not when it documents intent.
  • Right-size detail to certainty. Rolling wave for far-out work, denser detail as crews approach.
  • Put the contractor and the owner's representative on one shared platform.
  • Treat schedule risk as continuous, not as a stage-gate ritual.
  • Connect the schedule to the cost system at the work-package level.

Build a Construction Schedule That Drives Delivery

A useful construction schedule does one thing: it tells the project team what to do next and shows where the work is at risk. The methods are well established and the components are stable. The biggest gains today come from tightening the loop between schedule and field, running risk continuously, and putting both sides on one platform.

Start with the next update cycle. If the conversation in that meeting is about reconciling percent complete, the schedule is reporting. If it is about what the field is doing this week and what is trending toward critical, the schedule is steering.

Related Guides on Construction Scheduling

For deeper detail on connected topics in the cluster:

FAQs About Construction Projects Scheduling

Construction scheduling is important because every day of delay on a construction project costs money in extended general conditions, finance charges, and lost revenue. The schedule gives the owner control over those costs. It sequences work, identifies the critical path, and flags emerging risk before recovery is needed.
The most common method is the critical path method (CPM), which underpins almost every enterprise scheduling tool including Primavera P6 and Microsoft Project. Alternatives like the graphical path method (GPM), linear scheduling, PERT, and rolling wave planning have specific use cases, but CPM is the industry default.
A construction schedule should be updated at least weekly during execution, with the master schedule formally reconciled every two to four weeks. Faster cycles are better when the platform supports it. Slow cycles let the field and the schedule drift apart.
A master schedule covers the entire project at a higher level of detail and is used for executive reporting and milestone tracking. A look-ahead schedule covers the next two to four weeks at activity-by-activity detail and is used by the field. The two should be views of the same underlying data, not separate documents.
Time impact analysis (TIA) is a prospective method for evaluating how a delay event affects the project's completion date. It is performed by inserting a fragnet into the schedule and rerunning the critical path. The standard methodology is set out in AACE International's Recommended Practice 52R-06.
AI changes construction scheduling in three ways. It automates data entry and status capture, opens natural-language access to schedule data for non-P6 users, and runs continuous trend analysis in the background. The role of the human scheduler shifts toward judgment, logic, and decisions.
Jackson Row

Written by

Jackson Row

Jackson Row is the Growth & North American Market Lead at Mastt. With a background in risk modeling, cost forecasting, and integrated project delivery, he helps capital project owners work smarter and faster. Jackson’s work supports better tools, better data, and better outcomes across the construction industry.

LinkedIn Icon
Jackson Row

Contributions from

Timothy Mather

Tim Mather is a former CTO and COO of PMA Technologies, where he spent 23 years developing construction scheduling and risk analysis software. He co-developed NetPoint® and NetRisk™ and co-authored "Core Traits of a Reliable Schedule." At Mastt, he writes on construction scheduling, project controls, and AI in construction.

LinkedIn Icon

Related Articles on

Project Scheduling

See All

Supercharging Construction Project Management with AI Powered Tools
